Skip to content
Log in

Guru Punvaanii Eka Phase-3

30×40, 25×50 +4 more plots by Guru Punvaanii Properties Holding LLP · Guddanahalli, Bengaluru

Guddanahalli, BengaluruOpen on Google Maps (opens in a new tab)

  • Under construction
  • RERA registered
  • plotted

by Guru Punvaanii Properties Holding LLP

Price: Price on request

Get brochure, layout plan & price

Brochure, layout plan and price list for Guru Punvaanii Eka Phase-3

Developers share their brochure, layout plan and price list only on request. Tell us how to reach you and we’ll get them and send them to you, free.

Free for buyers. If you book through us, the developer pays us a commission. How we earn

Project summary

Guru Punvaanii Eka Phase-3 is a plotted development by Guru Punvaanii Properties Holding LLP in Guddanahalli, Bengaluru with 54 plots, registered with Karnataka RERA. The completion date on RERA is 31 Dec 2027.

Facts collected on 16 Oct 2026 from public records — each linked to its source. Free for buyers. If you book through us, the developer pays us a commission.

Guru Punvaanii Eka Phase-3 buyers’ group: join to ask for a group price

No one has joined yet. Be one of the first 10 buyers in this group — the founding members.

Join free. When enough buyers have joined, our agent partner asks Guru Punvaanii Properties Holding LLP for a group price — for example a lower price, an easier payment plan or waived charges. Nothing is promised: you see what the developer offers and book directly with the developer if you want to. Free for buyers. If you book through us, the developer pays us a commission.

  1. Gathering buyers
  2. Talking to the developer
  3. Group offer
  4. Group site visit
  5. Booking

0 buyers have joined · 0 committed

Committed buyers have confirmed their budget, plot size and timeline with us on a call; developers negotiate with them. Joining is free and never obliges you to buy.

Join the Guru Punvaanii Eka Phase-3 buyers’ groupHow group buying works

See it for yourself

Visit the site with our team, or get a call to clear your questions. Free, no obligation.

Key facts: plot sizes, approval, land and completion

Updated on 16 Oct 2026
Plot sizes (feet)
30×40, 25×50, 30×50, 35×50 +2 more
Plot area
920 – 2,189 sq ft
Total plots
54
Layout approved by
Anekal Planning Authority
Land
Not found in public records yet: land area
Land conversion orders
1
Completion (RERA)
Dec 2027
Development (RERA update)
12%

Plot sizes (RERA filing)

Size (feet)AreaPlots
30×401,200 sq ft6
25×501,250 sq ft1
30×501,500 sq ft18
35×501,750 sq ft2
30×601,800 sq ft3
40×502,000 sq ft3
Odd-sized (irregular)varies21

Sizes as filed with RERA, converted from metres to feet (9.14 m = 30 ft, 12.19 m = 40 ft). Ask the developer which plots are still unsold.

Land conversion orders (RERA filing)

Survey no.Converted forOrderBy
61/12ResidentialNo. 791738, 7 Nov 2025DC Office Bangalore

RERA does not cover each plot’s khata. Ask the developer for the khata and title documents and have a lawyer check them before paying an advance.

Guru Punvaanii Eka Phase-3 RERA number and registration details

RERA number
PRM/KA/RERA/1251/308/PR/030926/008906
Registered on
3 Sep 2026
Promised completion
31 Dec 2027
Extended to
No extension recorded
RERA status
Under construction
Plots booked
Not found in public records yet: plots booked
Price
Not found in public records yet: price
Project type
Plotted

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Summary in plain English

Guru Punvaanii Eka Phase-3 is a plotted layout by Guru Punvaanii Properties Holding LLP in Guddanahalli, Anekal, with 54 plots. The project is registered with RERA and is scheduled for completion on 31 December 2027.

Written by AI from the RERA record above on 17 Oct 2026. Every number in it was checked against that record; if anything differs, the record wins.

Open space, loans, escrow and other details

Open space
Not found in public records yet: open space
Water and power
Water source filed with RERA: BoreWell,Others
Plot loans: approved banks
Not found in public records yet: bank approvals
Payment plans
Not found in public records yet: payment plans
Maintenance
Not found in public records yet: maintenance
Car parking
Not found in public records yet: car parking charge
Escrow bank (RERA)
FEDERAL BANK OF INDIA, JAYANAGAR
Building plan (RERA)
Anekal Planning Authority · No. ADA/LAO/127/2025-26 · dated 9 Apr 2026
Project cost declared to RERA
₹14.47 Cr

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Amenities

Not found in public records yet: amenities

Guru Punvaanii Eka Phase-3 location and address

Address
Sy No.61/12, Guddanahalli Village, Kasaba Hobli, , Anekal Taluk, Bangalore Urban District. , Anekal , Bengaluru Urban, Karnataka - 562106
Village (RERA)
Guddanahalli
PIN code
562106
City
Bengaluru
State
Karnataka
Coordinates
12.68996, 77.72531

Distances to landmarks

Not found in public records yet: landmarks

About Guddanahalli

Not found in public records yet: locality facts

Commute times to tech parks and the airport

As on 5 Oct 2026
ToStraight linePeak-hour drive (estimate)
Electronic City Phase 1Map point on OpenStreetMap (opens in a new tab)18.93 kmapprox. 77 min
Outer Ring Road tech corridor (RMZ Ecospace, Bellandur)Map point on OpenStreetMap (opens in a new tab)26.43 kmapprox. 107 min
ITPL, Whitefield (main gate)Map point on OpenStreetMap (opens in a new tab)33.13 kmapprox. 134 min
KSR Bengaluru City railway station (Majestic)Map point on OpenStreetMap (opens in a new tab)36.22 kmapprox. 147 min
Manyata Tech ParkMap point on OpenStreetMap (opens in a new tab)41.44 kmapprox. 168 min
Kempegowda International AirportMap point on OpenStreetMap (opens in a new tab)56.84 kmapprox. 230 min
How we calculate

Straight line: from the project’s map point on RERA to the destination’s point on OpenStreetMap.

Peak-hour drive is a rough estimate, not a route: straight line × 1.35 for the road network, at 20 km/h. Real times vary a lot with the route and the hour.

Sources:Source (openstreetmap.org) (opens in a new tab)How we calculate this

Nearest metro station and railway

As on 5 Oct 2026
  • Delta Electronics Bommasandra (ಡೆಲ್ಟಾ ಎಲೆಕ್ಟ್ರಾನಿಕ್ಸ್ ಬೊಮ್ಮಸಂದ್ರ)Open now — nearest operating metro station14.94 km
  • Anekal Road (ಆನೇಕಲ್ ರಸ್ತೆ)Nearest railway station4.07 km

Straight-line distances from the RERA map point to the station points mapped on OpenStreetMap; status (open or under construction) as tagged there. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.

Sources:Source (openstreetmap.org) (opens in a new tab)

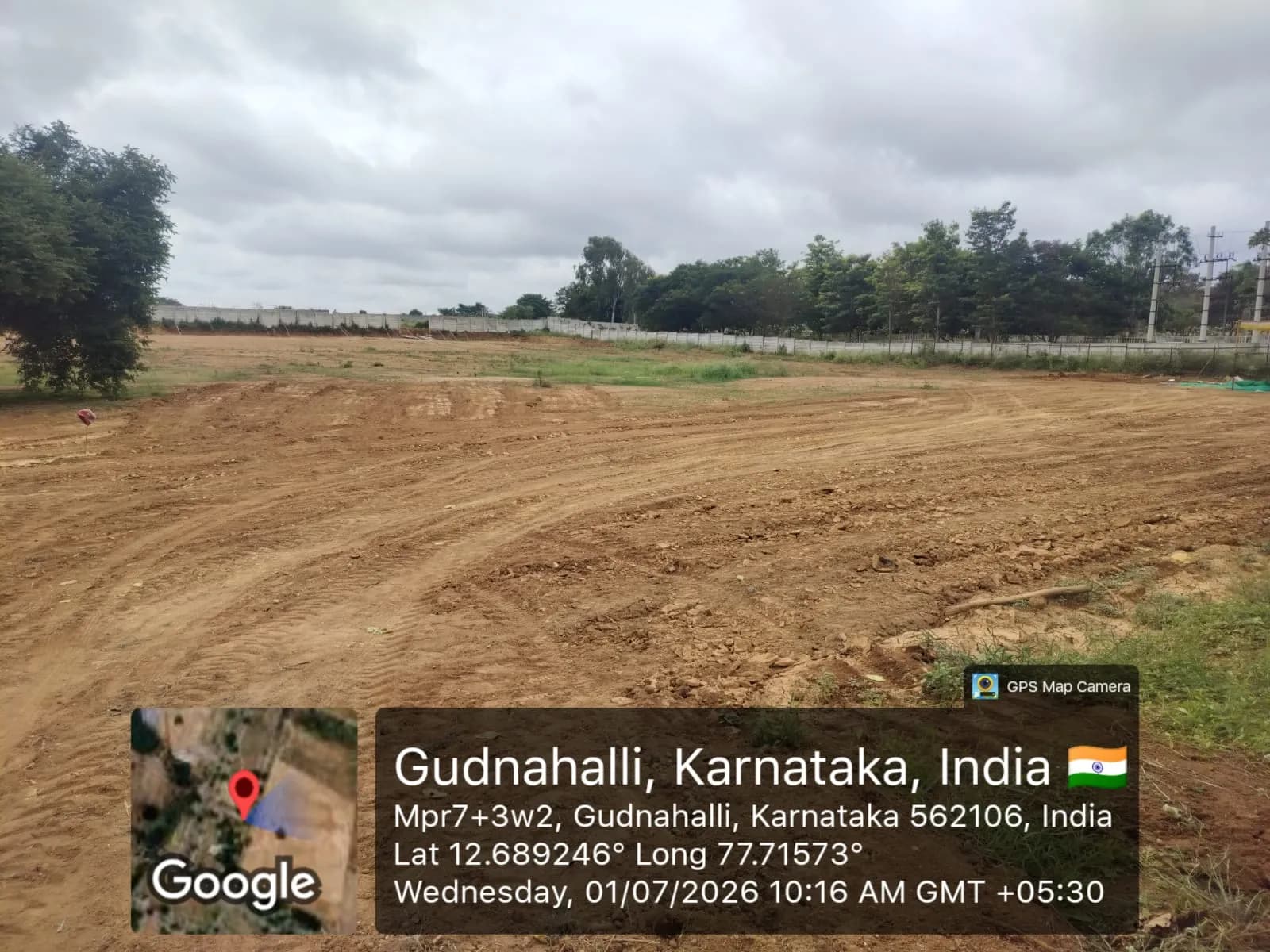

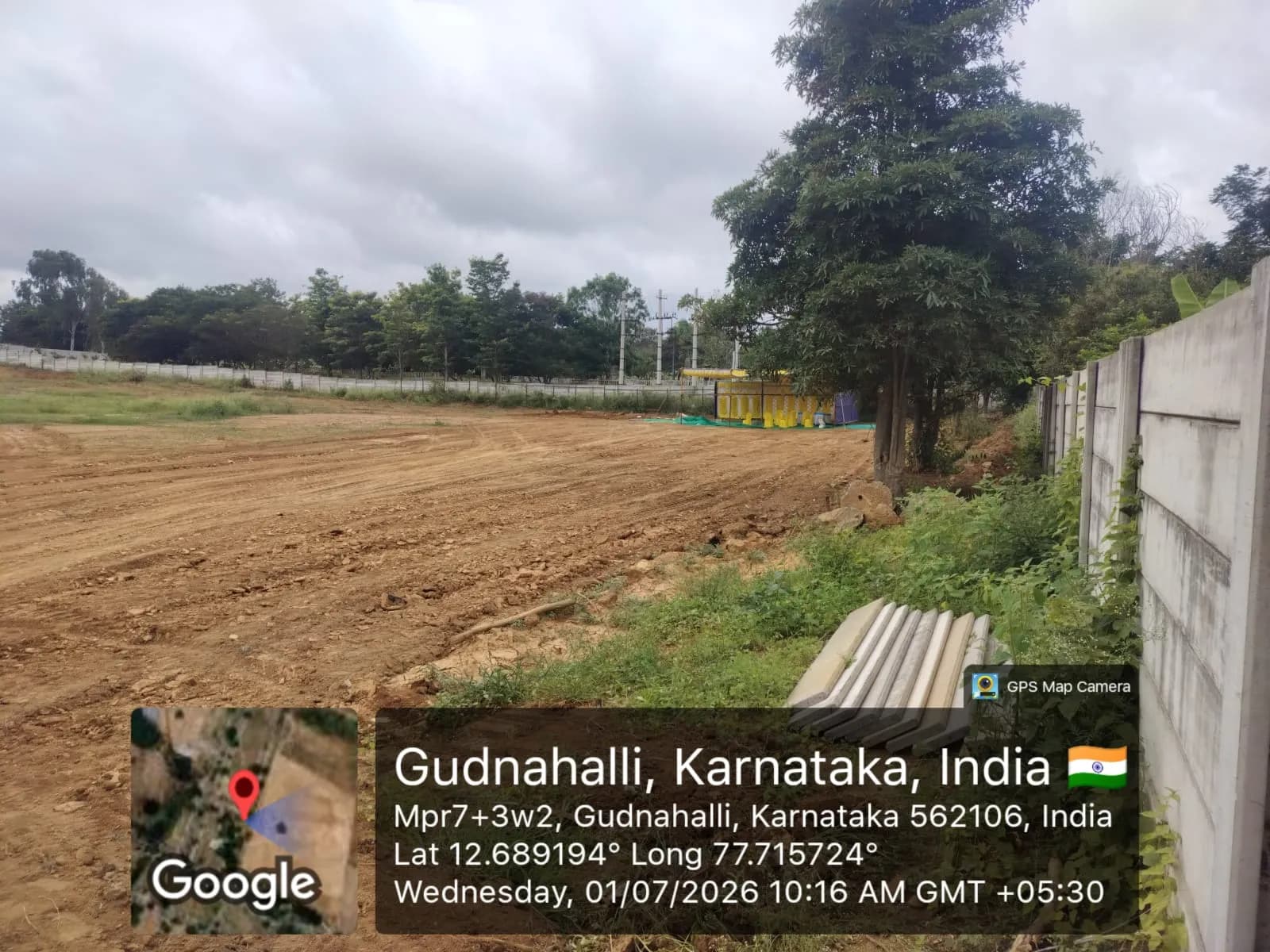

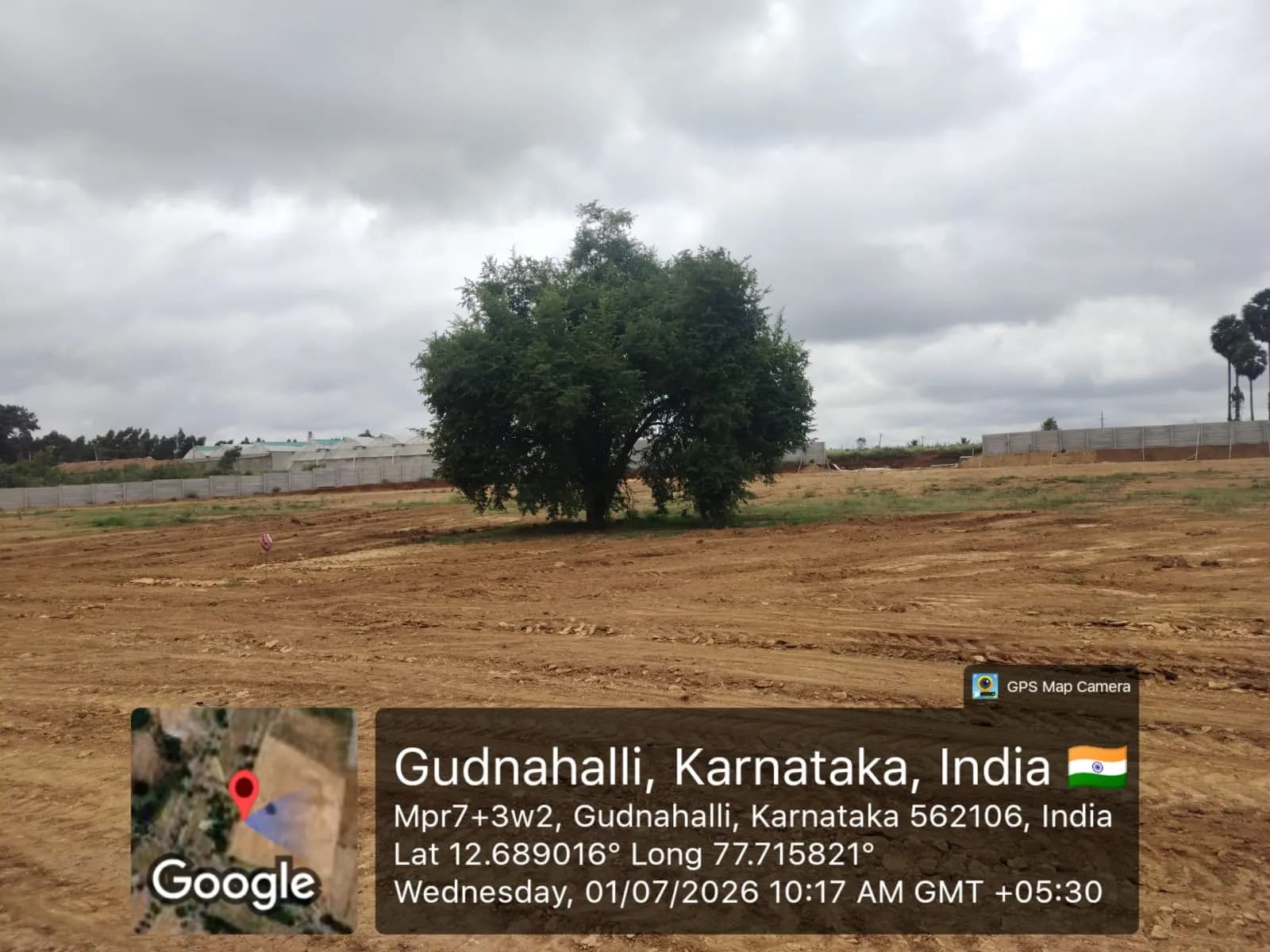

Satellite time-lapse of the site

Satellite photos load when you scroll to them.

Photos from Esri World Imagery Wayback, centred on the project’s map point; dates are the capture dates in Esri’s metadata. Loaded from Esri when you scroll here.

Sources:Source (livingatlas.arcgis.com) (opens in a new tab)

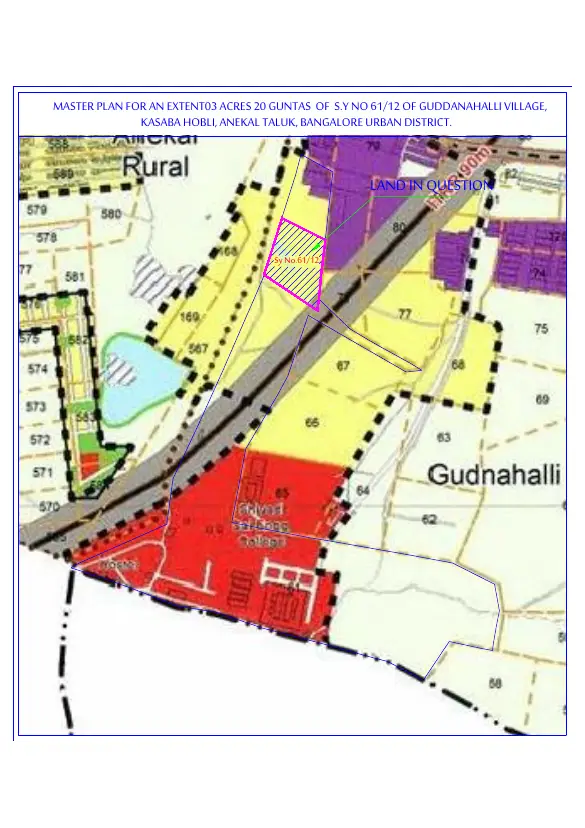

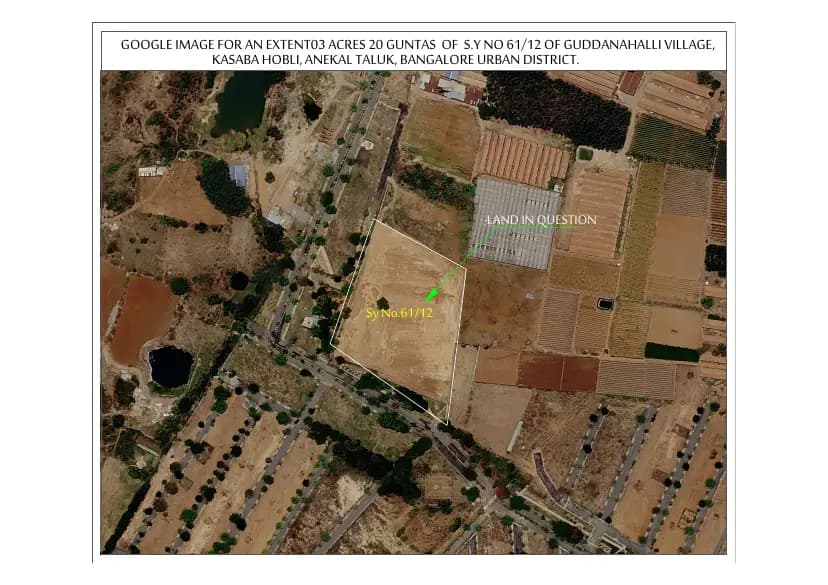

Guru Punvaanii Eka Phase-3 layout plan and plot types as filed

Documents the developer uploaded to Karnataka RERA, shown as filed. Tap a page to see it full size; the full PDF opens on the RERA website.

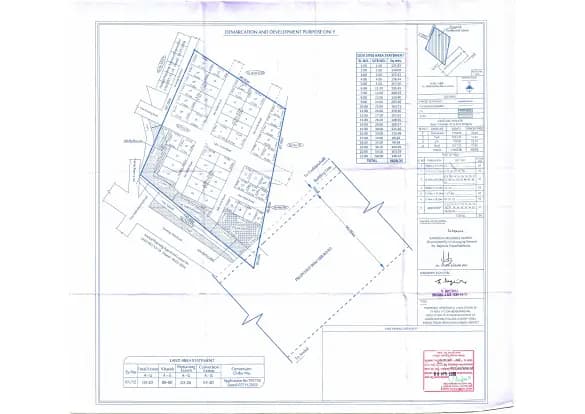

Approved layout plan3 files

Layout plan and brochure not published? The developer shares them only on request. We’ll get the brochure, layout plan and current price list for you, free.

Get brochure, layout plan & price

Brochure, layout plan and price list for Guru Punvaanii Eka Phase-3

Developers share their brochure, layout plan and price list only on request. Tell us how to reach you and we’ll get them and send them to you, free.

Free for buyers. If you book through us, the developer pays us a commission. How we earn

Plot type (as filed)AreaPlots
7.62m × 15.24m—1
9.14m × 12.19m—6
9.14m × 15.24m—18
9.14m × 18.29m—3
10.69m × 15.24m—2
12.19m × 15.24m—3
Odd-shaped plots—21

Plot types and counts as filed with Karnataka RERA.

We have not collected the layout plan drawing; the developer’s sales team can share it.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Guru Punvaanii Eka Phase-3 completion date and development status

  • Whole project (promoter’s RERA update)12%

    as on

Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-13.

Timeline

  1. 1 Jul 2026Project start date given to RERA
  2. 3 Sep 2026Registered with Karnataka RERA
  3. 31 Dec 2027Completion date given at registration

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Construction pace from RERA quarterly filings

As on 13 Oct 2026

At the average pace so far, construction would reach 100% around Jul 2028 — about 7 months after the completion date on RERA (31 Dec 2027).

0%25%50%75%100%20272028RERA date12%
  • Filed on RERA
  • Average pace since start
  • RERA completion date

Quarterly filings

QuarterFiled onDevelopedPlots booked
Q2 2026-27to 30 Sep 202613 Oct 202612%—
How we calculate

Average pace = % built ÷ months since the start date in the RERA record. Here: 12% ÷ 3 months (1 Jul 2026 to 30 Sep 2026) = 4% a month.

Estimated finish = latest filing date + (100 − % built) ÷ pace = 30 Sep 2026 + 88 ÷ 4 = 21.9 months → Jul 2028. This is an estimate, not a date from the builder or RERA.

A straight line is a simplification: the builder reports one overall %, which mixes excavation, structure and finishing, and work rarely moves at a constant speed. The % values are the promoter’s own figures filed with RERA, not checked by us. Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-13.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this

Approvals and documents checklist

ApprovalAuthoritySource
Layout planAnekal Planning Authority · No. ADA/LAO/127/2025-26 · dated 2026-04-09Source (rera.karnataka.gov.in) (opens in a new tab)
Land conversionDC Office Bangalore · No. 791738 · dated 2025-11-07Source (rera.karnataka.gov.in) (opens in a new tab)
Approved Layout Plan/Demarcation Planscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
NOC from ESCOMsscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
NOC for Waterscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)

Documents uploaded to RERA

As on 16 Oct 2026
  • Building or layout plan · Approved drawings from the planning authorityFiled on RERA ✓ — Anekal Planning Authority · No. ADA/LAO/127/2025-26 · dated 9 Apr 2026
  • Commencement certificate · Permission to start buildingNot on RERA yet
  • Environment clearance · SEIAA KarnatakaNot on RERA yet
  • Fire NOC · Karnataka Fire and Emergency ServicesNot on RERA yet
  • Pollution board consent · KSPCBNot on RERA yet
  • Water and sewerage · BWSSBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Electricity · BESCOMFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Height clearance · Airports Authority of IndiaNot on RERA yet
  • Occupancy certificate (OC) · Issued only when the building is finishedNot on RERA yet — expected at completion

From the documents the promoter uploaded to Karnataka RERA, collected 16 Oct 2026. “Filed” means a document is on RERA — we have not checked its contents or validity. Not every approval applies to every project (for example, smaller projects may not need an environment clearance). The project page on RERA lists each upload.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Guru Punvaanii Eka Phase-3 RERA complaints

No complaints listed on Karnataka RERA for this registration as on Source (rera.karnataka.gov.in) (opens in a new tab)

Court and consumer cases

Not found in public records yet: court cases

We list case numbers, courts and outcomes only — never names of private individuals.

About Guru Punvaanii Properties Holding LLP

Promoter type
Partnership Firm
Projects on this site
1
RERA complaints against promoter
0
Company number (CIN)
ACP-6003

From Karnataka RERA, as collected so far (16 Oct 2026). Complaints are those RERA lists against this promoter across all its projects.

Guru Punvaanii Properties Holding LLP’s RERA record

Guru Punvaanii Properties Holding LLP delivery record

As on 16 Oct 2026

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this

What’s changed since Apr 2026

As on 16 Oct 2026
  1. 13 Oct 2026Quarterly update filed for Q2 2026-27: 12% built Source (rera.karnataka.gov.in) (opens in a new tab)
  2. 3 Sep 2026Registered with Karnataka RERA (PRM/KA/RERA/1251/308/PR/030926/008906); completion date 31 Dec 2027 Source (rera.karnataka.gov.in) (opens in a new tab)
  3. 1 Jul 2026Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
  4. 9 Apr 2026Building plan approved by Anekal Planning Authority (No. ADA/LAO/127/2025-26) Source (rera.karnataka.gov.in) (opens in a new tab)

Newest first. No extension of the completion date is recorded on RERA. When the RERA crawl sees a new filing, complaint or extension, it is added here with its date.

Plot loan EMI calculator

No listed price found — enter one to try.

Example only — use your bank’s quote.

Monthly EMI
—
Down payment
—
Loan amount
—
Total interest
—

A calculation only, from the numbers you enter — not a loan offer.

Guru Punvaanii Eka Phase-3 FAQs

What plot sizes are available in Guru Punvaanii Eka Phase-3?

The layout has plots in sizes 30×50 (18 plots, 1,500 sq ft each), 30×40 (6 plots, 1,200 sq ft each), 30×60 (3 plots, 1,800 sq ft each), 40×50 (3 plots, 2,000 sq ft each), 35×50 (2 plots, 1,750 sq ft each), 25×50 (1 plot, 1,250 sq ft), and 21 odd-sized plots.

How many plots does Guru Punvaanii Eka Phase-3 have?

The project has 54 plots in total.

Which authority approved the layout for Guru Punvaanii Eka Phase-3?

The layout was approved by the Anekal Planning Authority.

What is the RERA registration number for Guru Punvaanii Eka Phase-3?

The project is registered as PRM/KA/RERA/1251/308/PR/030926/008906.

When will Guru Punvaanii Eka Phase-3 be completed?

The completion date on RERA is 31 December 2027.

How many plots are booked in Guru Punvaanii Eka Phase-3?

This information is not in the RERA record.

Are there any RERA complaints against Guru Punvaanii Eka Phase-3?

No complaints have been filed against this project.

Where is Guru Punvaanii Eka Phase-3 located?

The project is in Guddanahalli, Anekal taluk, Bengaluru Urban district, PIN code 562106.

What is the current development progress of Guru Punvaanii Eka Phase-3?

As of 30 September 2026, the layout development is 12 per cent complete.

What is the developer's RERA record?

Guru Punvaanii Properties Holding LLP has no complaints against it across all its projects on RERA record.

Written by AI from the RERA record above on 17 Oct 2026. Answers use only that record; check them against the source before you decide.

Questions about Guru Punvaanii Eka Phase-3

No questions published yet. Ask the first one: you get an instant answer from this page’s public record, and our team follows up on anything the record does not show.

Bought a plot from Guru Punvaanii Properties Holding LLP? Review the developer.

Reviews of Guru Punvaanii Properties Holding LLP by verified buyers

No verified reviews of Guru Punvaanii Properties Holding LLP yet. If you bought a plot from them, your review helps other buyers.

How reviews work: only buyers and owners can review; we confirm each purchase by phone before publishing, publish positive and negative reviews alike, never accept payment for reviews, and the developer may reply.

Similar projects within 5 km

ProjectDistancePlotsCompletion (RERA)DevelopedComplaintsPrice
Manyata MidlandsReddy Veeranna Constructions Pvt Ltd0.8 km485Dec 202786%1Not collected
Guru Punvaanii ErnikaGuru Punvaanii Infra LLP2.4 km220Dec 202748%0Not collected
MJ AnugrahamM J Infrastructure3.1 km171Dec 2028100%0Not collected
Nakshatra LayoutShashi Kumar V3.2 km33Dec 2027—0Not collected
Guru Punvaanii ExoticaG Sudha3.3 km174Dec 202599%0Not collected

Projects of the same kind within 5 km in a straight line of this project’s RERA map point, nearest first. % built is the promoter’s latest quarterly figure on RERA (shown for single-registration projects); prices are from the developer’s own website where we found one.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Sources and last checked dates

  1. Karnataka RERA — project register (search by the registration number) (opens in a new tab)

Collected on 16 Oct 2026 by AI research agents reading public pages. Facts are written in our own words. Not found yet: price; court cases; landmarks; specifications; news.

How to check on RERA: On rera.karnataka.gov.in/viewAllProjects, type the registration number in 'Registration No', press Search, then click the 'View Project Details' icon. Complaints open from the 'Complaints / Litigation' icon in the same row. Registration number: PRM/KA/RERA/1251/308/PR/030926/008906.

  • RERA record last checked: 16 Oct 2026
  • Last change in the record (registration, quarterly filing or complaint): 16 Oct 2026

How this page is made: software builds it from public records (Karnataka RERA filings, OpenStreetMap, the developer’s own website). AI is used only to read filings into fields and to write the plain-English summary and FAQ answers, which are checked against the record. Facts are checked automatically against the RERA filing. Methodology · How we earn · Report an error

More new projects nearby

  • Manyata Midlands: Site photo filed with Karnataka RERAGudna HalliUnder constructionRERA registeredBuyers’ group open

    Manyata Midlands

    by Reddy Veeranna Constructions

    Price: Price on requestGet brochure & price →

    • 30×40, 30×50, 40×60
    • 892 – 3,126 sq ft plots
    • Approved by Local Planning Authority
    • Dec 2027

    485 plots · 1 RERA complaint

    Be one of the first 10 buyers in this groupFounding members — it’s free

    Join group for Manyata Midlands
  • Chennena Agrahara© Esri, Maxar, Earthstar GeographicsReady to moveRERA registeredBuyers’ group open

    MJ Anugraham

    by M J Infrastructure

    Price: Price on requestGet brochure & price →

    • 30×40, 35×40
    • 9,367 – 21,958 sq ft plots
    • Approved by BMRDA
    • Dec 2028

    171 plots

    Be one of the first 10 buyers in this groupFounding members — it’s free

    Join group for MJ Anugraham
