KNS Unnati Phase V
20×30, 30×30 +6 more plots by KNS Propworth LLP · Sulikere, near Kengeri, Bengaluru
Sulikere, near Kengeri, BengaluruOpen on Google Maps (opens in a new tab)
- Under construction
- RERA registered
- plotted
Price: Price on request

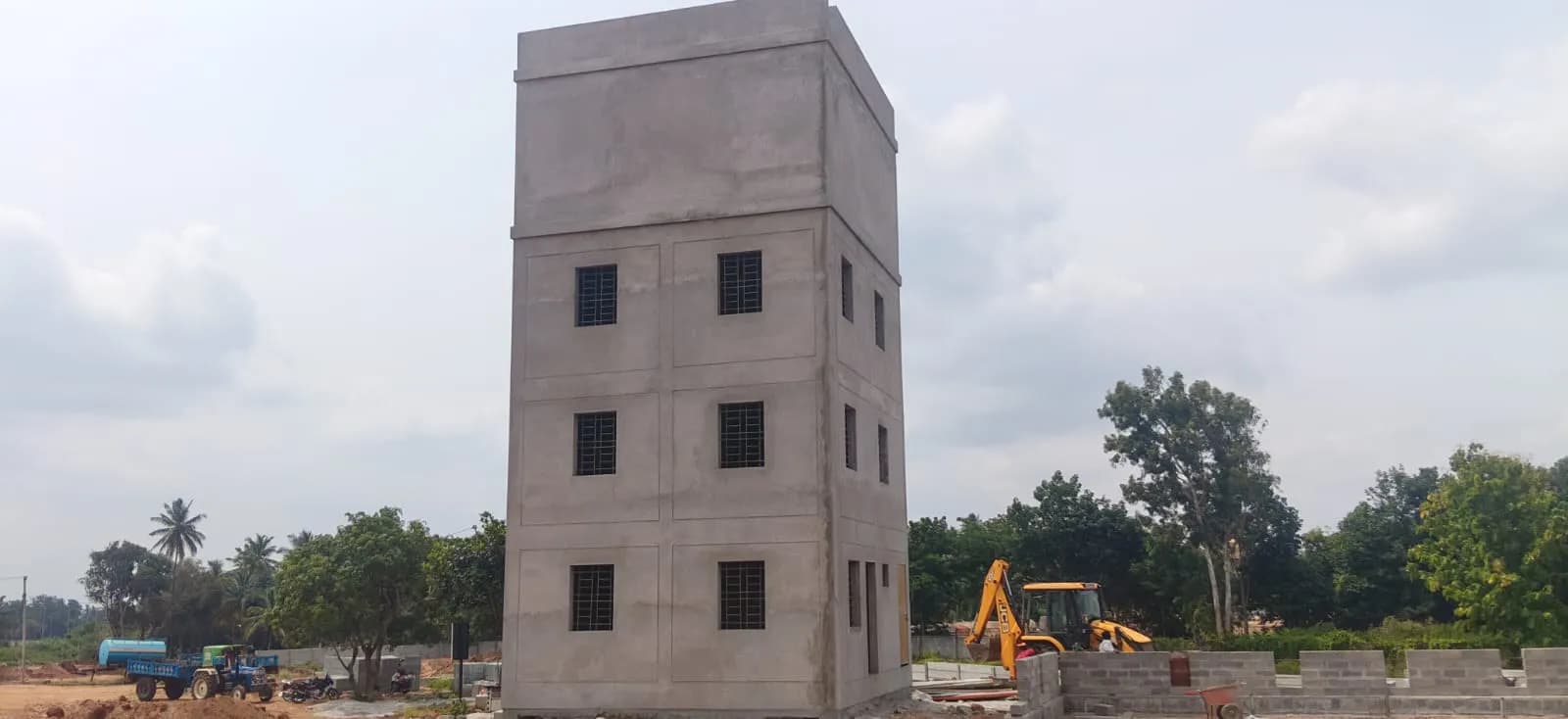

Site photo filed with Karnataka RERA Karnataka RERA filing · Source ↗ (opens in a new tab)
KNS Unnati Phase V at a glance
- Completion (RERA)Jul 2030Karnataka RERA
- Construction53% built · on pace for Nov 2027RERA filing to 30 Sep 2026; estimate from average pace
- RERA complaints (project)None listedKarnataka RERA · as on 16 Oct 2026
- Approvals filed3 of 9 on RERAKarnataka RERA uploads · 16 Oct 2026
- Nearest metroKengeri · 5.02 kmstraight line · OpenStreetMap, 5 Oct 2026
- Airport driveapprox. 162 min at peak39.95 km straight line · estimate
- Nearest lakeUnnamed lake · 400 mFrom the RERA map point · OpenStreetMap, 5 Oct 2026
Project summary
KNS Unnati Phase V is a plotted development by KNS Propworth LLP in Sulikere, Bengaluru with 169 plots, registered with Karnataka RERA. The completion date on RERA is 11 Jul 2030.
Facts collected on 16 Oct 2026 from public records — each linked to its source. Free for buyers. If you book through us, the developer pays us a commission.
KNS Unnati Phase V buyers’ group: join to ask for a group price
No one has joined yet. Be one of the first 10 buyers in this group — the founding members.
Join free. When enough buyers have joined, our agent partner asks KNS Propworth LLP for a group price — for example a lower price, an easier payment plan or waived charges. Nothing is promised: you see what the developer offers and book directly with the developer if you want to. Free for buyers. If you book through us, the developer pays us a commission.
- Gathering buyers
- Talking to the developer
- Group offer
- Group site visit
- Booking
0 buyers have joined · 0 committed
Committed buyers have confirmed their budget, plot size and timeline with us on a call; developers negotiate with them. Joining is free and never obliges you to buy.
Join the KNS Unnati Phase V buyers’ groupHow group buying works
See it for yourself
Visit the site with our team, or get a call to clear your questions. Free, no obligation.
Key facts: plot sizes, approval, land and completion
- Plot sizes (feet)
- 20×30, 30×30, 30×35, 30×40 +4 more
- Plot area
- 600 – 3,102 sq ft
- Total plots
- 169
- Layout approved by
- BDA
- Land
- Not found in public records yet: land area
- Land conversion orders
- 5
- Completion (RERA)
- Jul 2030
- Development (RERA update)
- 53%
Plot sizes (RERA filing)
| Size (feet) | Area | Plots |
|---|---|---|
| 20×30 | 600 sq ft | 2 |
| 30×30 | 900 sq ft | 10 |
| 30×35 | 1,050 sq ft | 10 |
| 30×40 | 1,200 sq ft | 23 |
| 30×45 | 1,350 sq ft | 24 |
| 30×50 | 1,500 sq ft | 24 |
| 40×40 | 1,600 sq ft | 2 |
| 40×60 | 2,400 sq ft | 5 |
| Odd-sized (irregular) | varies | 69 |
Sizes as filed with RERA, converted from metres to feet (9.14 m = 30 ft, 12.19 m = 40 ft). Ask the developer which plots are still unsold.
Approving authority as filed: BDA - Bangalore Development Authority.
Land conversion orders (RERA filing)
| Survey no. | Converted for | Order | By |
|---|---|---|---|
| 2/2 | Residential | No. 723789, 4 Dec 2024 | Deputy Comissioner, Bengaluru Urban District. |
| 2/3 | Residential | No. 744773, 14 Feb 2025 | Deputy Comissioner, Bengaluru Urban District. |
| 2/23 | Residential | No. 744774, 14 Feb 2025 | Deputy Comissioner, Bengaluru Urban District. |
| 3/17 | Residential | No. 708445, 4 Dec 2024 | Deputy Comissioner, Bengaluru Urban District. |
| 4/4 | Residential | No. ALN(S)SR(K):153/08-09, 30 Sep 2024 | Deputy Comissioner, Bengaluru Urban District. |
RERA does not cover each plot’s khata. Ask the developer for the khata and title documents and have a lawyer check them before paying an advance.
KNS Unnati Phase V RERA number and registration details
- RERA number
- PRM/KA/RERA/1251/310/PR/301025/008207
- Registered on
- 30 Oct 2025
- Promised completion
- 11 Jul 2030
- Extended to
- No extension recorded
- RERA status
- Under construction
- Plots booked
- Not found in public records yet: plots booked
- Price
- Not found in public records yet: price
- Project type
- Plotted
Summary in plain English
KNS Unnati Phase V is a plotted layout of 169 plots in Sulikere, Bengaluru South, developed by KNS Propworth LLP. The layout is approved by BDA with 5 land conversion orders and is registered on Karnataka RERA. The layout is scheduled for completion on 11 July 2030.
Written by AI from the RERA record above on 7 Oct 2026. Every number in it was checked against that record; if anything differs, the record wins.
Open space, loans, escrow and other details
- Open space
- Not found in public records yet: open space
- Water and power
- Water source filed with RERA: Local Authority
- Plot loans: approved banks
- Not found in public records yet: bank approvals
- Payment plans
- Not found in public records yet: payment plans
- Maintenance
- Not found in public records yet: maintenance
- Car parking
- Not found in public records yet: car parking charge
- Escrow bank (RERA)
- HDFC, RICHMOND ROAD
- Building plan (RERA)
- BDA - Bangalore Development Authority · No. No. BDA/TPM/PRL-176/2024-25/1150 2025-26 · dated 30 May 2025
- Project cost declared to RERA
- ₹11.12 Cr
Amenities
KNS Unnati Phase V location and address
- Address
- Sy.No.2/2, Sy No.2/3(P), Sy No.2/23, Sy No.3/17, Sy.No.4/4, , Sulikere Village, Kengeri Hobli, Bengaluru South Taluk & Bengaluru Urban District , Bengaluru South , Bengaluru Urban, Karnataka - 560060
- Village (RERA)
- Sulikere
- Locality
- Near Kengeri
- PIN code
- 560060
- City
- Bengaluru
- State
- Karnataka
- Coordinates
- 12.94298, 77.44745
Distances to landmarks
Not found in public records yet: landmarksAbout Sulikere
Not found in public records yet: locality factsCommute times to tech parks and the airport
| To | Straight line | Peak-hour drive (estimate) |
|---|---|---|
| KSR Bengaluru City railway station (Majestic)Map point on OpenStreetMap (opens in a new tab) | 13.8 km | approx. 56 min |
| Manyata Tech ParkMap point on OpenStreetMap (opens in a new tab) | 22.04 km | approx. 89 min |
| Outer Ring Road tech corridor (RMZ Ecospace, Bellandur)Map point on OpenStreetMap (opens in a new tab) | 25.43 km | approx. 103 min |
| Electronic City Phase 1Map point on OpenStreetMap (opens in a new tab) | 25.76 km | approx. 104 min |
| ITPL, Whitefield (main gate)Map point on OpenStreetMap (opens in a new tab) | 31.85 km | approx. 129 min |
| Kempegowda International AirportMap point on OpenStreetMap (opens in a new tab) | 39.95 km | approx. 162 min |
How we calculate
Straight line: from the project’s map point on RERA to the destination’s point on OpenStreetMap.
Peak-hour drive is a rough estimate, not a route: straight line × 1.35 for the road network, at 20 km/h. Real times vary a lot with the route and the hour.
Sources:Source (openstreetmap.org) (opens in a new tab)How we calculate this
Schools and hospitals nearby
Within 2 km
- 2Schools and colleges2 schools, 0 colleges, 0 kindergartens
- 1Hospitals and clinics1 hospitals, 0 clinics
Nearest schools and colleges
- AVIN International School · 0.59 km
- Ramasandra Government Higher Primary School · 1.75 km
Nearest hospitals and clinics
- Government Hospital SULIKERE · 0.51 km
Places as mapped on OpenStreetMap (amenity=school, college, kindergarten, university; hospital, clinic), counted within 2 km in a straight line of the RERA map point. Volunteers map these, so some places may be missing or closed. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Nearest metro station and railway
- Kengeri (ಕೆಂಗೇರಿ)Open now — nearest operating metro station5.02 km
- Kengeri (ಕೆಂಗೇರಿ)Nearest railway station4.84 km
Straight-line distances from the RERA map point to the station points mapped on OpenStreetMap; status (open or under construction) as tagged there. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Lake and lake-buffer check
The nearest mapped lake is Unnamed lake (mapped on OpenStreetMap), 400 m from the project’s RERA map point.
The site boundary is not published as a shape, so its nearest edge can be closer than this point. Whether any building sits inside a lake buffer can only be checked on the approved plan.
- Unnamed lake (mapped on OpenStreetMap) on OpenStreetMap (opens in a new tab) 400 m
- Sulikere/ Herekere Lake on OpenStreetMap (opens in a new tab) 1,126 m
- Hosakere Lake on OpenStreetMap (opens in a new tab) 1,179 m
The buffer rule
Bengaluru’s lake buffer rule has changed over time: the National Green Tribunal ordered a 75 m buffer in May 2016; the Supreme Court set that order aside on 5 March 2019, leaving the 30 m buffer of the Revised Master Plan 2015. Check the current rule and the approved plan before relying on either number.
- LiveLaw: SC sets aside NGT order enlarging buffer zones (2019) (livelaw.in) (opens in a new tab)
- Citizen Matters: Shrinking lake buffers (citizenmatters.in) (opens in a new tab)
Shortest distance from the RERA map point to the mapped water edge (OpenStreetMap water polygons tagged lake or reservoir, or named lake/kere/tank). Mapped shorelines can differ from the revenue-record boundary of a lake. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Sources:Source (openstreetmap.org) (opens in a new tab)Source (livelaw.in) (opens in a new tab)Source (citizenmatters.in) (opens in a new tab)How we calculate this
Satellite time-lapse of the site
Satellite photos load when you scroll to them.
Photos from Esri World Imagery Wayback, centred on the project’s map point; dates are the capture dates in Esri’s metadata. Loaded from Esri when you scroll here.
Sources:Source (livingatlas.arcgis.com) (opens in a new tab)
KNS Unnati Phase V layout plan and plot types as filed
Documents the developer uploaded to Karnataka RERA, shown as filed. Tap a page to see it full size; the full PDF opens on the RERA website.

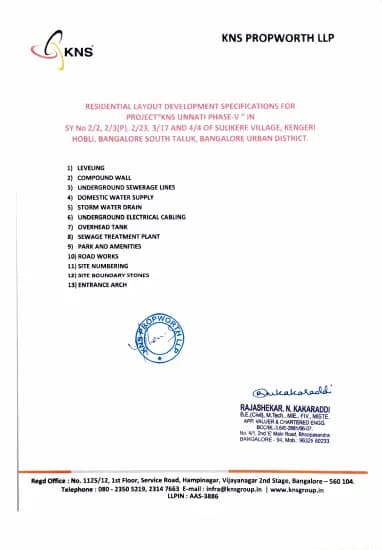

Brochure

BrochureFull PDF on RERA
Approved layout plan

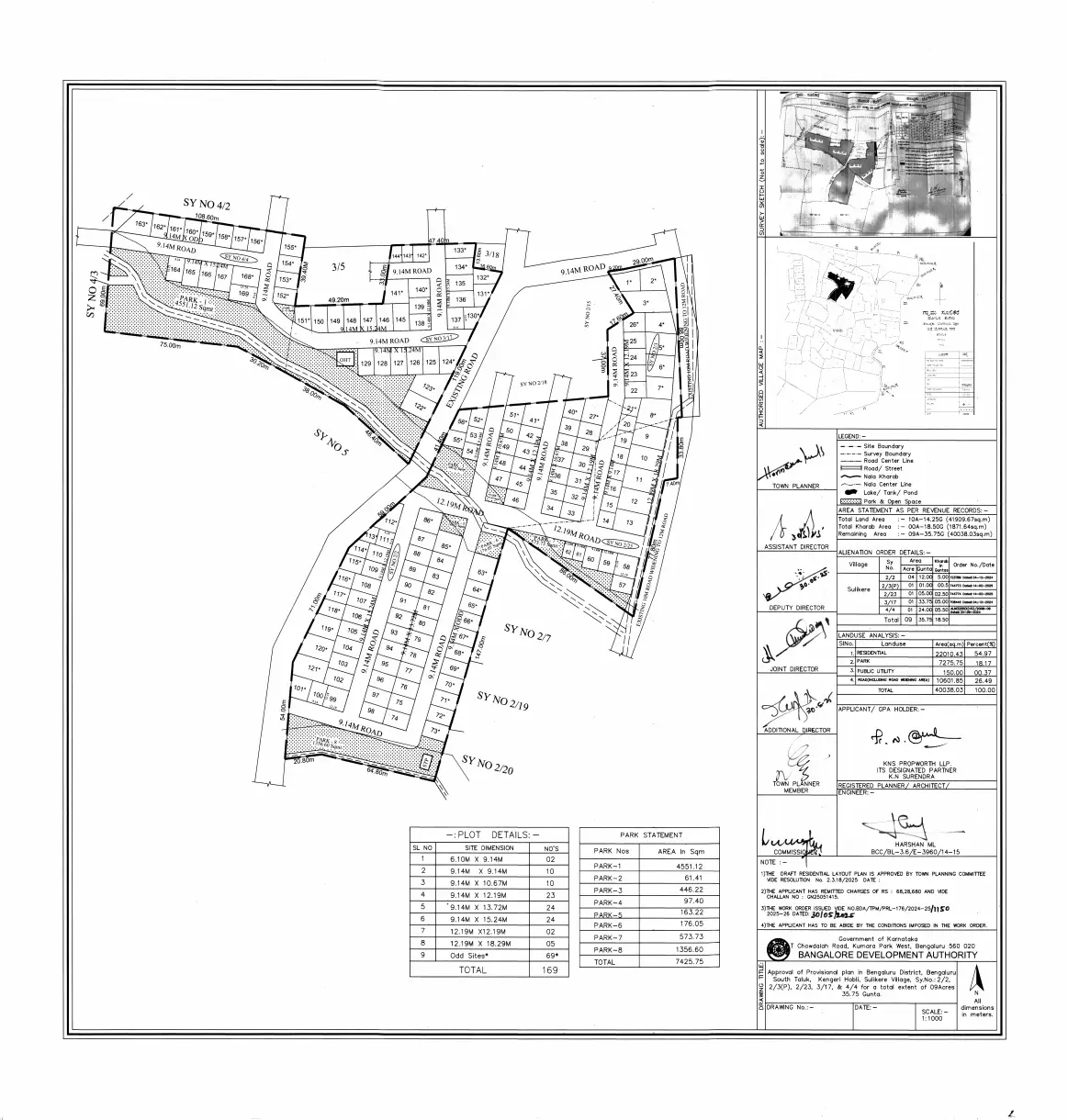

Approved Layout Plan/Demarcation PlanFull PDF on RERA
| Plot type (as filed) | Area | Plots |
|---|---|---|
| Plots (6.10 x 9.14 meter) | — | 2 |
| Plots (9.14 x 9.14 meter) | — | 10 |
| Plots (9.14 x 10.67 meter) | — | 10 |
| Plots (9.14 x 12.19 meter) | — | 23 |
| Plots (9.14 x 15.24 meter) | — | 24 |
| Plots (9.14 x13.72 meter) | — | 24 |
| Plots (12.19 x 12.19 meter) | — | 2 |
| Plots (12.19 x 18.29 meter) | — | 5 |
| Plots (odd) | — | 69 |
Plot types and counts as filed with Karnataka RERA.
We have not collected the layout plan drawing; the developer’s sales team can share it.
KNS Unnati Phase V completion date and development status
Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-15.
Timeline
- 7 Jul 2025Project start date given to RERA
- 30 Oct 2025Registered with Karnataka RERA
- 11 Jul 2030Completion date given at registration
Construction pace from RERA quarterly filings
At the average pace so far, construction would reach 100% around Nov 2027 — about 32 months before the completion date on RERA (11 Jul 2030).
At the pace between the 4 quarterly filings we have (0% → 53% in 9 months), it would be around May 2027 — about 37 months before the RERA date.
- Filed on RERA
- Average pace since start
- Pace between filings (and 0% assumed at the start date)
- RERA completion date
Quarterly filings
| Quarter | Filed on | Developed | Plots booked |
|---|---|---|---|
| Q2 2026-27to 30 Sep 2026 | 15 Oct 2026 | 53% | — |
| Q1 2026-27to 30 Jun 2026 | 11 Jul 2026 | 50% | — |
| Q4 2025-26to 31 Mar 2026 | 9 Apr 2026 | 30% | — |
| Q3 2025-26to 31 Dec 2025 | 8 Jan 2026 | 0% | — |
How we calculate
Average pace = % built ÷ months since the start date in the RERA record. Here: 53% ÷ 14.8 months (7 Jul 2025 to 30 Sep 2026) = 3.6% a month.
Estimated finish = latest filing date + (100 − % built) ÷ pace = 30 Sep 2026 + 47 ÷ 3.6 = 13.1 months → Nov 2027. This is an estimate, not a date from the builder or RERA.
Pace between filings = (53% − 0%) ÷ 9 months = 5.9% a month.
A straight line is a simplification: the builder reports one overall %, which mixes excavation, structure and finishing, and work rarely moves at a constant speed. The % values are the promoter’s own figures filed with RERA, not checked by us. Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-15.
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
Approvals and documents checklist
| Approval | Authority | Source |
|---|---|---|
| Layout plan | BDA - Bangalore Development Authority · No. No. BDA/TPM/PRL-176/2024-25/1150 2025-26 · dated 2025-05-30 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Land conversion (5 orders) | Deputy Comissioner, Bengaluru Urban District. · No. 723789 and 4 more · dated 2025-02-14 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Layout Plan/Demarcation Plan | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| NOC from ESCOMs | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| NOC for Water | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
Documents uploaded to RERA
- Building or layout plan · Approved drawings from the planning authorityFiled on RERA ✓ — BDA - Bangalore Development Authority · No. No. BDA/TPM/PRL-176/2024-25/1150 2025-26 · dated 30 May 2025
- Commencement certificate · Permission to start buildingNot on RERA yet
- Environment clearance · SEIAA KarnatakaNot on RERA yet
- Fire NOC · Karnataka Fire and Emergency ServicesNot on RERA yet
- Pollution board consent · KSPCBNot on RERA yet
- Water and sewerage · BWSSBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Electricity · BESCOMFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Height clearance · Airports Authority of IndiaNot on RERA yet
- Occupancy certificate (OC) · Issued only when the building is finishedNot on RERA yet — expected at completion
From the documents the promoter uploaded to Karnataka RERA, collected 16 Oct 2026. “Filed” means a document is on RERA — we have not checked its contents or validity. Not every approval applies to every project (for example, smaller projects may not need an environment clearance). The project page on RERA lists each upload.
KNS Unnati Phase V RERA complaints
No complaints listed on Karnataka RERA for this registration as on Source (rera.karnataka.gov.in) (opens in a new tab)
Court and consumer cases
We list case numbers, courts and outcomes only — never names of private individuals.
About KNS Propworth LLP
- Promoter type
- Partnership Firm
- Projects on this site
- 2
- RERA complaints against promoter
- 0
- Company number (CIN)
- AAS-3886
From Karnataka RERA, as collected so far (16 Oct 2026). Complaints are those RERA lists against this promoter across all its projects.
KNS Propworth LLP’s RERA recordKNS Propworth LLP delivery record
- 2Projects in Bengaluru on RERA4 approved registrations under KNS Propworth LLP in Bengaluru Urban and Rural. Source (rera.karnataka.gov.in) (opens in a new tab)
- 1,695Plots registeredAs stated in each registrations.
- 0RERA complaintsas on Source (rera.karnataka.gov.in) (opens in a new tab)
- 0Complaints per 1,000 plots0 complaints ÷ 1,695 plots in its 4 registrations on Karnataka RERA in Bengaluru.
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
What’s changed since May 2025
- 15 Oct 2026Quarterly update filed for Q2 2026-27: 53% built Source (rera.karnataka.gov.in) (opens in a new tab)
- 11 Jul 2026Quarterly update filed for Q1 2026-27: 50% built Source (rera.karnataka.gov.in) (opens in a new tab)
- 9 Apr 2026Quarterly update filed for Q4 2025-26: 30% built Source (rera.karnataka.gov.in) (opens in a new tab)
- 8 Jan 2026Quarterly update filed for Q3 2025-26: 0% built Source (rera.karnataka.gov.in) (opens in a new tab)
- 30 Oct 2025Registered with Karnataka RERA (PRM/KA/RERA/1251/310/PR/301025/008207); completion date 11 Jul 2030 Source (rera.karnataka.gov.in) (opens in a new tab)
- 7 Jul 2025Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
- 30 May 2025Building plan approved by BDA - Bangalore Development Authority (No. No. BDA/TPM/PRL-176/2024-25/1150 2025-26) Source (rera.karnataka.gov.in) (opens in a new tab)
Newest first. No extension of the completion date is recorded on RERA. When the RERA crawl sees a new filing, complaint or extension, it is added here with its date.
Plot loan EMI calculator
- Monthly EMI
- —
- Down payment
- —
- Loan amount
- —
- Total interest
- —
A calculation only, from the numbers you enter — not a loan offer.
KNS Unnati Phase V FAQs
How many plots are in KNS Unnati Phase V?
The layout has 169 plots in total.
What are the plot sizes available in KNS Unnati Phase V?
Plot sizes range from 20×30 ft (600 sq ft) to 40×60 ft (2,400 sq ft). The breakdown includes: 24 plots of 30×45 ft (1,350 sq ft), 24 plots of 30×50 ft (1,500 sq ft), 23 plots of 30×40 ft (1,200 sq ft), 10 plots of 30×30 ft (900 sq ft), 10 plots of 30×35 ft (1,050 sq ft), 5 plots of 40×60 ft (2,400 sq ft), 2 plots of 20×30 ft (600 sq ft), 2 plots of 40×40 ft (1,600 sq ft), and 69 plots of other sizes.
Which authority approved the layout for KNS Unnati Phase V?
The layout is approved by BDA (Bangalore Development Authority).
How many land conversion orders are there for KNS Unnati Phase V?
There are 5 land conversion orders for the layout.
What is the RERA registration number for KNS Unnati Phase V?
The RERA registration number is PRM/KA/RERA/1251/310/PR/301025/008207, registered on 30 October 2025.
When will KNS Unnati Phase V be completed?
The layout is scheduled for completion on 11 July 2030.
What is the current development status of KNS Unnati Phase V?
As of Q1 2026-27 (ended 30 June 2026), the layout development is 50 percent complete.
Are there any RERA complaints against KNS Unnati Phase V or the developer?
There are no RERA complaints on this project or against the developer.
Where is KNS Unnati Phase V located?
The layout is in Sulikere, Bengaluru South taluk, Bengaluru Urban district, PIN code 560060.
How many other projects does the developer have in the RERA records?
The developer, KNS Propworth LLP, has 2 projects in total in our Bengaluru RERA records.
Written by AI from the RERA record above on 7 Oct 2026. Answers use only that record; check them against the source before you decide.
Questions about KNS Unnati Phase V
No questions published yet. Ask the first one: you get an instant answer from this page’s public record, and our team follows up on anything the record does not show.
Bought a plot from KNS Propworth LLP? Review the developer.
Reviews of KNS Propworth LLP by verified buyers
No verified reviews of KNS Propworth LLP yet. If you bought a plot from them, your review helps other buyers.
How reviews work: only buyers and owners can review; we confirm each purchase by phone before publishing, publish positive and negative reviews alike, never accept payment for reviews, and the developer may reply.
Similar projects within 5 km
| Project | Distance | Plots | Completion (RERA) | Developed | Complaints | Price |
|---|---|---|---|---|---|---|
| DMR LegacyN Kariyappa | 0.6 km | 31 | Dec 2027 | — | 0 | Not collected |
| Nisarga LayoutRevanasiddaiah and Others | 0.8 km | 21 | Apr 2026 | 100% | 0 | Not collected |
| Abh SamrddhiB V Tarakeshwari | 1 km | 34 | Feb 2026 | — | 0 | Not collected |
| KNS AnantaKNS Propworth LLP | 1.6 km | 1,526 | Jul 2030 | — | 0 | Not collected |
| KNS SumedhaKNS Infrastructure Private Limited | 2.8 km | 117 | Feb 2030 | 100% | 0 | Not collected |
| MRCL Sylvan WoodMohan Kumar S R And Prabhu B H | 4.3 km | 118 | Jun 2026 | — | 0 | Not collected |
Projects of the same kind within 5 km in a straight line of this project’s RERA map point, nearest first. % built is the promoter’s latest quarterly figure on RERA (shown for single-registration projects); prices are from the developer’s own website where we found one.
Sources and last checked dates
Collected on 16 Oct 2026 by AI research agents reading public pages. Facts are written in our own words. Not found yet: price; court cases; landmarks; specifications; news.
How to check on RERA: On rera.karnataka.gov.in/viewAllProjects, type the registration number in 'Registration No', press Search, then click the 'View Project Details' icon. Complaints open from the 'Complaints / Litigation' icon in the same row. Registration number: PRM/KA/RERA/1251/310/PR/301025/008207.
- RERA record last checked: 16 Oct 2026
- Last change in the record (registration, quarterly filing or complaint): 16 Oct 2026
How this page is made: software builds it from public records (Karnataka RERA filings, OpenStreetMap, the developer’s own website). AI is used only to read filings into fields and to write the plain-English summary and FAQ answers, which are checked against the record. Facts are checked automatically against the RERA filing. Methodology · How we earn · Report an error
More new projects nearby
- Sulikere, near Kengeri© Esri, Maxar, Earthstar GeographicsReady to moveRERA registeredBuyers’ group open
Nisarga Layout
by Revanasiddaiah and Others
Price: Price on requestGet brochure & price →
- 30×30, 30×40, 30×55
- 656 – 3,969 sq ft plots
- Approved by BDA
- Apr 2026
21 plots
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Nisarga Layout
A Sulikere, near KengeriUnder constructionRERA registeredBuyers’ group openDMR Legacy
by N Kariyappa
Price: Price on requestGet brochure & price →
- 30×47, 30×50
- 730 – 1,950 sq ft plots
- Approved by BDA
- Dec 2027
31 plots
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for DMR Legacy
Kenchanapura, near KengeriUnder constructionRERA registeredBuyers’ group openAbh Samrddhi
by B V Tarakeshwari
Price: Price on requestGet brochure & price →
- 30×40
- 5,834 – 14,814 sq ft plots
- Approved by BDA
- Feb 2026
RERA not updated since promised Feb 2026 · 34 plots
