NTD Lavender
1 & 2 BHK apartments by Nature Trail Developers LLP · Yadavanahalli, Chandapura–Attibele, Bengaluru
Yadavanahalli, Chandapura–Attibele, Bengaluru
- Under construction
- RERA registered
- residential
by Nature Trail Developers LLP
Price: Price on request

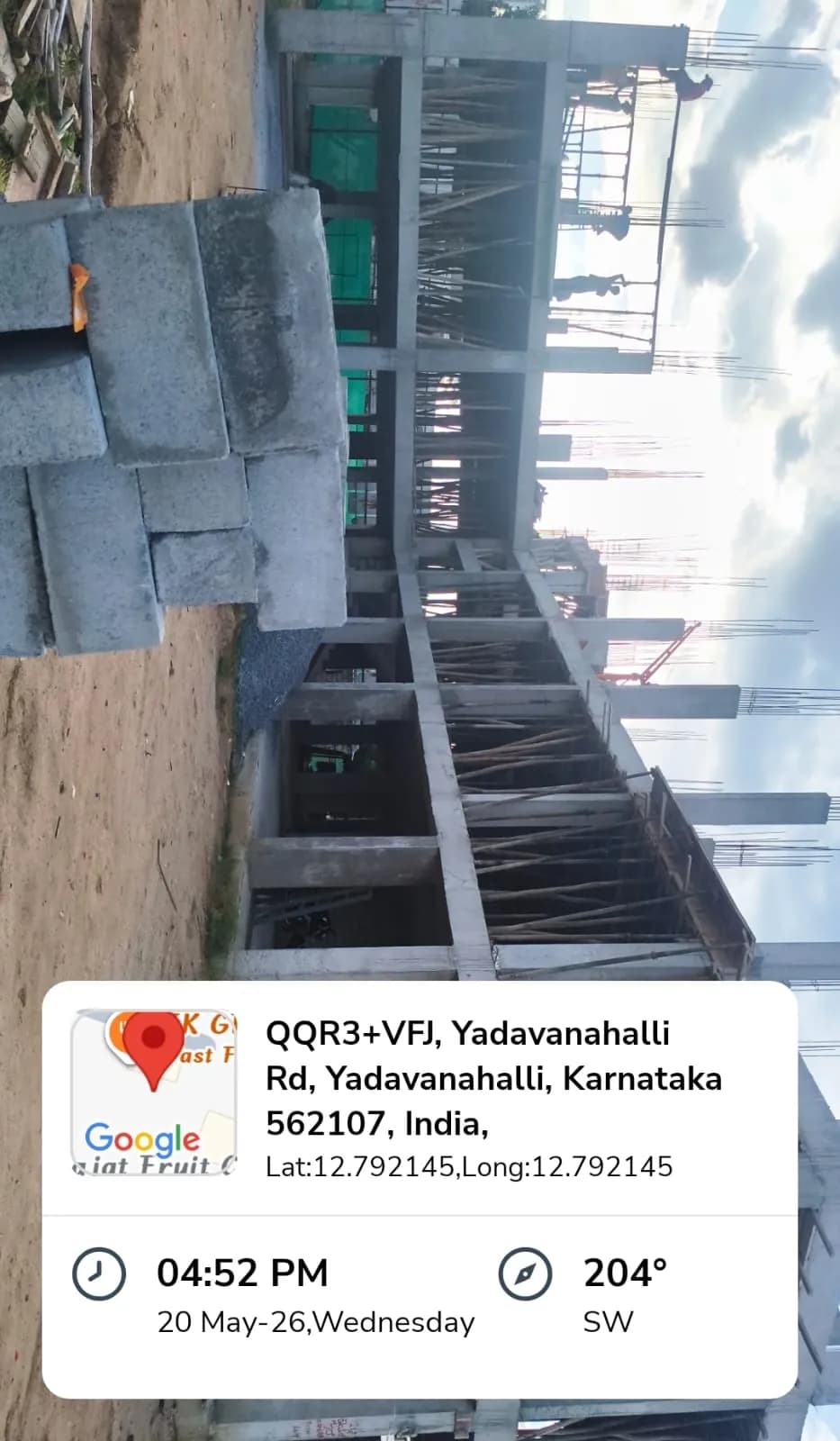

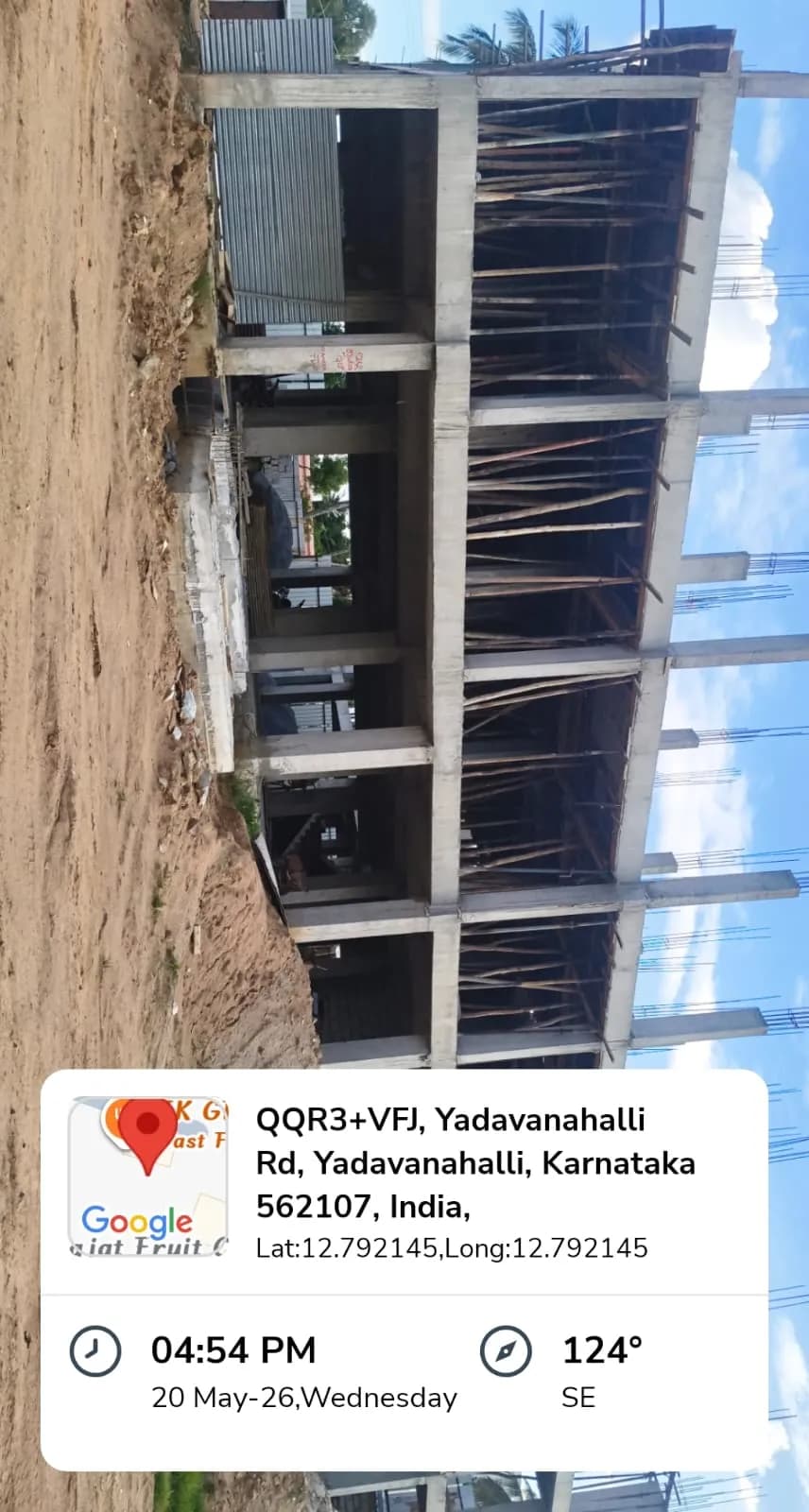

Site photo filed with Karnataka RERA Karnataka RERA filing · Source ↗ (opens in a new tab)
NTD Lavender at a glance
- Possession (RERA)Sep 2030Karnataka RERA
- Construction40% built · on pace for Aug 2028RERA filing to 30 Sep 2026; estimate from average pace
- Homes booked5 of 32 (16%)RERA update · as on 30 Sep 2026
- RERA complaints (project)None listedKarnataka RERA · as on 19 Oct 2026
- Approvals filed5 of 9 on RERAKarnataka RERA uploads · 19 Oct 2026
Project summary
NTD Lavender is a residential project by Nature Trail Developers LLP in Yadavanahalli, Bengaluru with 32 homes, registered with Karnataka RERA. The completion date on RERA is 30 Sep 2030.
Not in the RERA record we collected yet: map location. This page fills in as the record is collected.
Facts collected on 19 Oct 2026 from public records — each linked to its source. Free for buyers. If you book through us, the builder pays us a commission.
NTD Lavender buyers’ group: join to ask for a group price
No one has joined yet. Be one of the first 10 buyers in this group — the founding members.
Join free. When enough buyers have joined, our agent partner asks Nature Trail Developers LLP for a group price — for example a lower price, an easier payment plan or waived charges. Nothing is promised: you see what the builder offers and book directly with the builder if you want to. Free for buyers. If you book through us, the builder pays us a commission.
- Gathering buyers
- Talking to the builder
- Group offer
- Group site visit
- Booking
0 buyers have joined · 0 committed
Committed buyers have confirmed their budget, home type and timeline with us on a call; builders negotiate with them. Joining is free and never obliges you to buy.
Join the NTD Lavender buyers’ groupHow group buying works
See it for yourself
Visit the site with our team, or get a call to clear your questions. Free, no obligation.
Key facts: home types, towers, land and possession
- Home types
- 1 BHK, 2 BHK
- Carpet area
- 320 – 754 sq ft
- Towers
- 1
- Floors
- 3
- Total homes
- 32
- Land
- 0.4 acres
- Possession (RERA)
- Sep 2030
- Built (RERA update)
- 40%
NTD Lavender RERA number and registration details
- RERA number
- PRM/KA/RERA/1251/308/PR/090626/008713
- Registered on
- 9 Jun 2026
- Promised completion
- 30 Sep 2030
- Extended to
- No extension recorded
- RERA status
- New launch
- Homes booked
- 5 of 32 as on
- Price
- Not found in public records yet: price
- Project type
- Residential
Towers and blocks (RERA filing)
| Tower | Floors | Basements | Homes |
|---|---|---|---|
| NTD Lavender | 3 | 1 | 32 |
A dash (—) means the filing did not state that value.
Summary in plain English
NTD Lavender is a residential project by Nature Trail Developers LLP in Yadavanahalli, Anekal, with 32 homes in 1 tower of 3 floors. The project is registered with Karnataka RERA and is scheduled for completion on 30 September 2030.
Written by AI from the RERA record above on 19 Oct 2026. Every number in it was checked against that record; if anything differs, the record wins.
Open space, home loans, escrow and other details
- Open space
- 61.7% of land
- Water and power
- Water source filed with RERA: Others
- Home loans: approved banks
- Not found in public records yet: bank approvals
- Payment plans
- Not found in public records yet: payment plans
- Maintenance
- Not found in public records yet: maintenance
- Car parking
- Not found in public records yet: car parking charge
- Escrow bank (RERA)
- ICICI Bank, SARJAPURA
- Building plan (RERA)
- Anekal Planning Authority · No. AUDA/1059/2024-25 · dated 20 Jun 2025
- Project cost declared to RERA
- ₹7.77 Cr
Open area as a share of the land, from the areas filed with RERA (includes driveways and landscaped areas).
Amenities
- Electricity
- CCTV Surveillance
- Power Backup
- Water and Sanitation
Amenities and internal works as filed by the promoter with Karnataka RERA; we have not visited the site.
NTD Lavender location and address
- Address
- SY NO 4/16, KATHA NO 1993/4/16 PID NO 150200101500122710 , YADAVANAHALLI VILLAGE, ATTIBELE HOBLI, , Anekal , Bengaluru Urban, Karnataka - 562107
- Village (RERA)
- Yadavanahalli
- Locality
- Chandapura–AttibeleAlso known as Chandapura, Attibele
- PIN code
- 562107
- City
- Bengaluru
- State
- Karnataka
- Coordinates
- Not found in public records yet: coordinates
Distances to landmarks

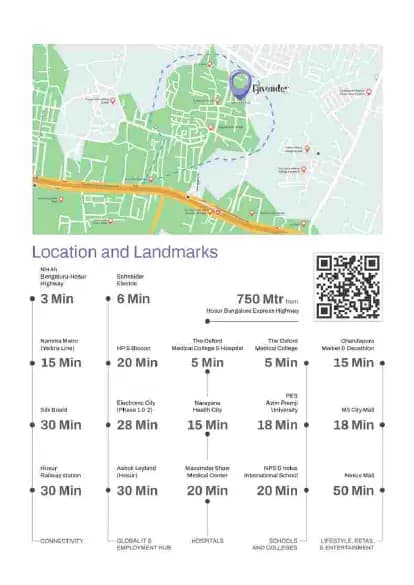

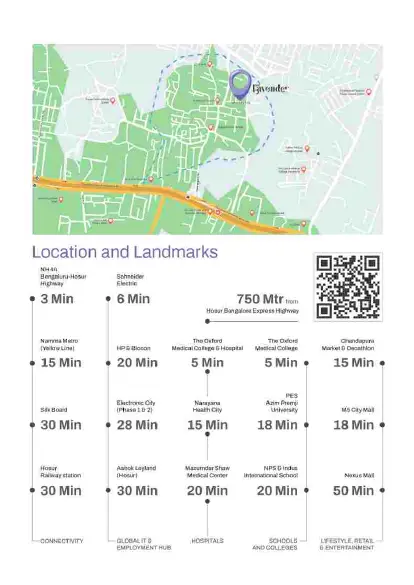

Not found in public records yet: landmarksAbout Chandapura–Attibele

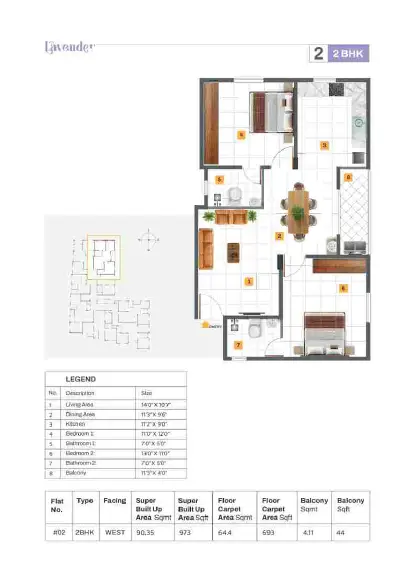

Not found in public records yet: locality factsNTD Lavender floor plans, brochure and elevations
Documents the builder uploaded to Karnataka RERA, shown as filed. Tap a page to see it full size; the full PDF opens on the RERA website.

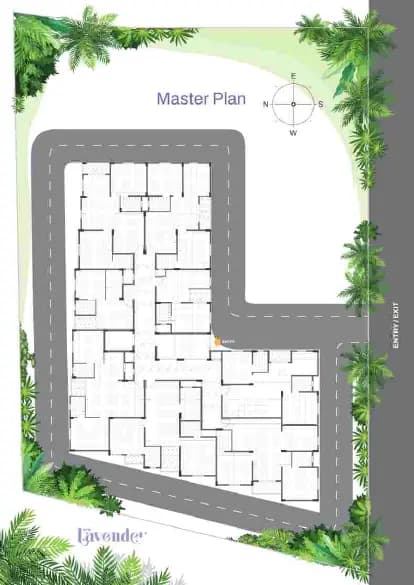

Brochure16 pages

BrochureFull PDF on RERA

Approved building plan3 pages

Approved Building PlanFull PDF on RERA
| Home type | Carpet area | Homes |
|---|---|---|
| 1 BHK | 320 – 326 sq ft | 8 |
| 2 BHK | 659 – 754 sq ft | 24 |

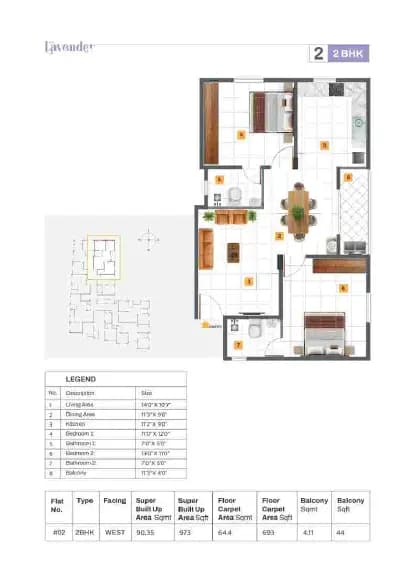

Home types, counts and carpet areas as filed with Karnataka RERA (carpet area, not super built-up).
We have not collected floor-plan drawings; the builder’s sales team can share them.
NTD Lavender possession date and construction status
Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-14.
Units sold and unsold, from RERA (Q2 2026-27)
| Type | Homes | Booked | Available |
|---|---|---|---|
| 1 BHK | 8 | 4 | 4 |
| 2 BHK | 24 | 1 | 23 |
As reported by the promoter in the quarterly update to RERA, not verified by us.
Timeline
- 20 Jun 2025Project start date given to RERA
- 9 Jun 2026Registered with Karnataka RERA
- 30 Sep 2030Completion date given at registration
Construction pace from RERA quarterly filings
At the average pace so far, construction would reach 100% around Aug 2028 — about 25 months before the completion date on RERA (30 Sep 2030).
At the pace between the 2 quarterly filings we have (2% → 40% in 3 months), it would be around Feb 2027 — about 43 months before the RERA date.
- Filed on RERA
- Average pace since start
- Pace between filings (and 0% assumed at the start date)
- RERA completion date
Quarterly filings
| Quarter | Filed on | Built | Homes booked |
|---|---|---|---|
| Q2 2026-27to 30 Sep 2026 | 14 Oct 2026 | 40% | 5 of 32 |
| Q1 2026-27to 30 Jun 2026 | 14 Jul 2026 | 2% | 0 of 32 |
How we calculate
Average pace = % built ÷ months since the start date in the RERA record. Here: 40% ÷ 15.3 months (20 Jun 2025 to 30 Sep 2026) = 2.6% a month.
Estimated finish = latest filing date + (100 − % built) ÷ pace = 30 Sep 2026 + 60 ÷ 2.6 = 23 months → Aug 2028. This is an estimate, not a date from the builder or RERA.
Pace between filings = (40% − 2%) ÷ 3 months = 12.6% a month.
A straight line is a simplification: the builder reports one overall %, which mixes excavation, structure and finishing, and work rarely moves at a constant speed. The % values are the promoter’s own figures filed with RERA, not checked by us. Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-14.
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
Approvals and documents checklist
| Approval | Authority | Source |
|---|---|---|
| Building plan | Anekal Planning Authority · No. AUDA/1059/2024-25 · dated 2025-06-20 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Commencement Certificate | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Building Plan | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| ESCOM/Electricity | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KWSSB/Water | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KSPCB | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
Documents uploaded to RERA
- Building or layout plan · Approved drawings from the planning authorityFiled on RERA ✓ — Anekal Planning Authority · No. AUDA/1059/2024-25 · dated 20 Jun 2025
- Commencement certificate · Permission to start buildingFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Environment clearance · SEIAA KarnatakaNot on RERA yet
- Fire NOC · Karnataka Fire and Emergency ServicesNot on RERA yet
- Pollution board consent · KSPCBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Water and sewerage · BWSSBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Electricity · BESCOMFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Height clearance · Airports Authority of IndiaNot on RERA yet
- Occupancy certificate (OC) · Issued only when the building is finishedNot on RERA yet — expected at completion
From the documents the promoter uploaded to Karnataka RERA, collected 19 Oct 2026. “Filed” means a document is on RERA — we have not checked its contents or validity. Not every approval applies to every project (for example, smaller projects may not need an environment clearance). The project page on RERA lists each upload.
NTD Lavender RERA complaints
No complaints listed on Karnataka RERA for this registration as on Source (rera.karnataka.gov.in) (opens in a new tab)
Court and consumer cases
We list case numbers, courts and outcomes only — never names of private individuals.
About Nature Trail Developers LLP
- Promoter type
- Partnership Firm
- Projects on this site
- 1
- RERA complaints against promoter
- 0
- Company number (CIN)
- AAZ-6008
From Karnataka RERA, as collected so far (19 Oct 2026). Complaints are those RERA lists against this promoter across all its projects.
Nature Trail Developers LLP’s RERA recordNature Trail Developers LLP delivery record
- 1Projects in Bengaluru on RERA1 approved registration under Nature Trail Developers LLP in Bengaluru Urban and Rural. Source (rera.karnataka.gov.in) (opens in a new tab)
- 32Homes registeredAs stated in each registrations.
- 0RERA complaintsas on Source (rera.karnataka.gov.in) (opens in a new tab)
- 0Complaints per 1,000 homes0 complaints ÷ 32 homes in its 1 registration on Karnataka RERA in Bengaluru.
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
What’s changed since Jun 2025
- 14 Oct 2026Quarterly update filed for Q2 2026-27: 40% built, 5 of 32 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 14 Jul 2026Quarterly update filed for Q1 2026-27: 2% built, 0 of 32 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 9 Jun 2026Registered with Karnataka RERA (PRM/KA/RERA/1251/308/PR/090626/008713); completion date 30 Sep 2030 Source (rera.karnataka.gov.in) (opens in a new tab)
- 20 Jun 2025Building plan approved by Anekal Planning Authority (No. AUDA/1059/2024-25) Source (rera.karnataka.gov.in) (opens in a new tab)
- 20 Jun 2025Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
Newest first. No extension of the completion date is recorded on RERA. When the RERA crawl sees a new filing, complaint or extension, it is added here with its date.
Home loan EMI calculator
- Monthly EMI
- —
- Down payment
- —
- Loan amount
- —
- Total interest
- —
A calculation only, from the numbers you enter — not a loan offer.
All-in cost: GST, registration and other charges
The calculator loads when you scroll to it.
Assumptions
- Base price: the builder’s price is not published in a form we could collect — enter it from the cost sheet.
- GST 5% on the base price and charges — the usual rate for an under-construction home that is not “affordable housing” (1%).
- Stamp duty about 5.6% and registration 2% — the Karnataka rule (registration was raised from 1% to 2% on 31 Aug 2025). Calculated on the agreement value.
- Car parking, other charges and the maintenance deposit are not in the public record we collect; enter them from the builder’s cost sheet.
- Loan on the agreement value (banks usually lend up to 75–90%); EMI is the standard reducing-balance formula. Example rate only — use your bank’s quote.
NTD Lavender FAQs
What is the RERA registration number for NTD Lavender?
The RERA registration number is PRM/KA/RERA/1251/308/PR/090626/008713, registered on 9 June 2026.
How many homes are in NTD Lavender and what types?
There are 32 homes: 8 units of 1 BHK (carpet area 320 to 326 sq ft) and 24 units of 2 BHK (carpet area 659 to 754 sq ft).
What is the completion date for NTD Lavender?
The project completion date is 30 September 2030.
Where is NTD Lavender located?
NTD Lavender is in Yadavanahalli, Anekal taluk, Bengaluru Urban district, PIN code 562107.
What is the construction progress of NTD Lavender?
As of Q2 2026-27 (ended 30 September 2026), construction is 40% complete.
How many homes are booked in NTD Lavender?
As of Q2 2026-27, 5 homes are booked out of 32.
Are there any RERA complaints against NTD Lavender or the builder?
There are no RERA complaints on this project or against the builder Nature Trail Developers LLP.
Who is the builder of NTD Lavender?
The builder is Nature Trail Developers LLP, a Partnership Firm with only this one project on record with Karnataka RERA.
What is the land area of NTD Lavender?
The land area is 1,619 sq m.
Which bank holds the escrow for NTD Lavender?
ICICI Bank holds the escrow for the project.
Written by AI from the RERA record above on 19 Oct 2026. Answers use only that record; check them against the source before you decide.
Questions about NTD Lavender
No questions published yet. Ask the first one: you get an instant answer from this page’s public record, and our team follows up on anything the record does not show.
Bought a home from Nature Trail Developers LLP? Review the builder.
Reviews of Nature Trail Developers LLP by verified buyers
No verified reviews of Nature Trail Developers LLP yet. If you bought a home from them, your review helps other buyers.
How reviews work: only buyers and owners can review; we confirm each purchase by phone before publishing, publish positive and negative reviews alike, never accept payment for reviews, and the builder may reply.
Sources and last checked dates
Collected on 19 Oct 2026 by AI research agents reading public pages. Facts are written in our own words. Not found yet: price; court cases; landmarks; specifications; news.
How to check on RERA: On rera.karnataka.gov.in/viewAllProjects, type the registration number in 'Registration No', press Search, then click the 'View Project Details' icon. Complaints open from the 'Complaints / Litigation' icon in the same row. Registration number: PRM/KA/RERA/1251/308/PR/090626/008713.
- RERA record last checked: 19 Oct 2026
- Last change in the record (registration, quarterly filing or complaint): 19 Oct 2026
How this page is made: software builds it from public records (Karnataka RERA filings, OpenStreetMap, the builder’s own website). AI is used only to read filings into fields and to write the plain-English summary and FAQ answers, which are checked against the record. Facts are checked automatically against the RERA filing. Methodology · How we earn · Report an error
More new projects in Chandapura–Attibele
Marasur, Chandapura–AttibeleUnder constructionRERA registeredBuyers’ group openLegacy
by Global Edifice Infra
Price: Price on requestGet brochure & price →
- 2 BHK, 3 BHK
- 679 – 1,033 sq ft
- May 2028
56 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Legacy
Manchenahalli, Chandapura–AttibeleUnder constructionRERA registeredBuyers’ group openShriram 107southeast - Phase 3
by Shriprop Living Space
Price: Price on requestGet brochure & price →
- 2 BHK, 3 BHK
- 463 – 635 sq ft
- Jan 2027
1,055 homes · 3 RERA complaints
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Shriram 107southeast - Phase 3
Madiwala, Chandapura–AttibeleReady to moveRERA registeredBuyers’ group openDS Max Sukruth
by DS Max Realty
Price: Price on requestGet brochure & price →
- 2 BHK, 3 BHK
- 552 – 879 sq ft
- Feb 2026
304 homes · 1 RERA complaint
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for DS Max Sukruth
