Shriram Serenity
2 & 3 BHK apartments by Shriram Properties Limited · Addeviswanathapura, Doddaballapur Road, Bengaluru
Addeviswanathapura, Doddaballapur Road, BengaluruOpen on Google Maps (opens in a new tab)
- Under construction
- RERA registered
- residential
Price: Price on request

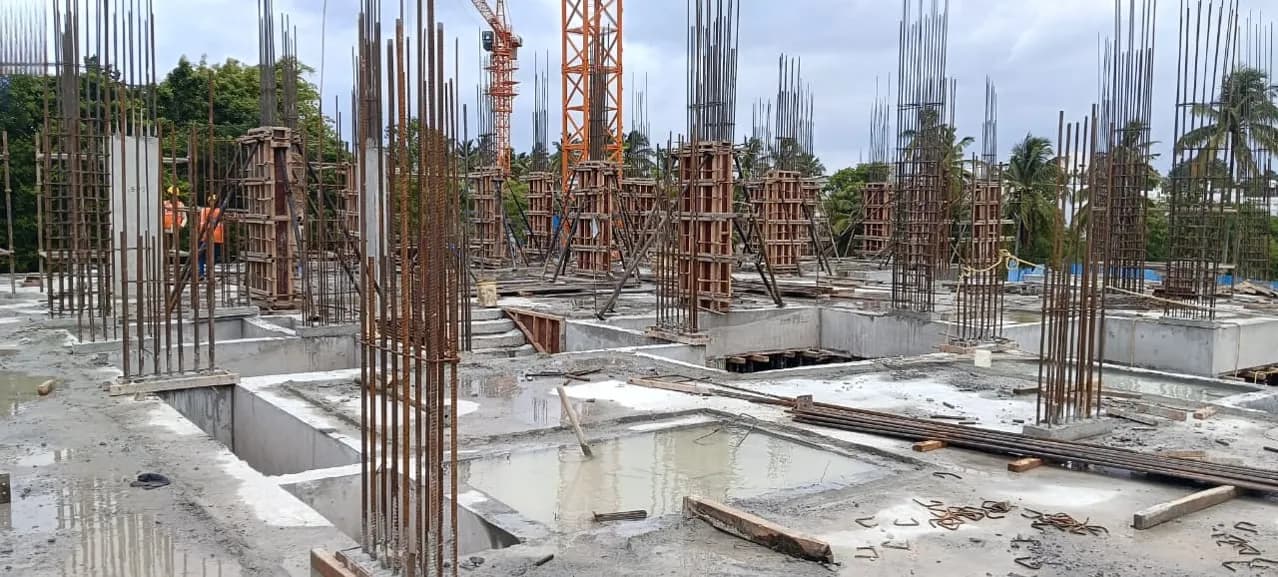

Site photo filed with Karnataka RERA Karnataka RERA filing · Source ↗ (opens in a new tab)
Shriram Serenity at a glance
- Possession (RERA)Jul 2029Karnataka RERA
- Construction25% built · on pace for Jun 2033 47 mo after RERA dateRERA filing to 30 Sep 2026; estimate from average pace
- Homes booked270 of 270 (100%)RERA update · as on 30 Sep 2026
- RERA complaints (project)1 complaintKarnataka RERA · as on 21 Oct 2026
- Approvals filed8 of 9 on RERAKarnataka RERA uploads · 21 Oct 2026
- Nearest metroBagalur Cross · 9.11 km (under construction)Open now: Nagasandra, 15.23 km · straight line · OpenStreetMap, 5 Oct 2026
- Airport driveapprox. 69 min at peak17.01 km straight line · estimate
- Nearest lakeUnnamed lake · 874 mFrom the RERA map point · OpenStreetMap, 5 Oct 2026
Project summary
Shriram Serenity is a residential project by Shriram Properties Limited in Addeviswanathapura, Bengaluru with 270 homes, registered with Karnataka RERA. The completion date on RERA is 5 Jul 2029.
Facts collected on 21 Oct 2026 from public records — each linked to its source. Free for buyers. If you book through us, the builder pays us a commission.
Shriram Serenity buyers’ group: join to ask for a group price
No one has joined yet. Be one of the first 10 buyers in this group — the founding members.
Join free. When enough buyers have joined, our agent partner asks Shriram Properties Limited for a group price — for example a lower price, an easier payment plan or waived charges. Nothing is promised: you see what the builder offers and book directly with the builder if you want to. Free for buyers. If you book through us, the builder pays us a commission.
- Gathering buyers
- Talking to the builder
- Group offer
- Group site visit
- Booking
0 buyers have joined · 0 committed
Committed buyers have confirmed their budget, home type and timeline with us on a call; builders negotiate with them. Joining is free and never obliges you to buy.
Join the Shriram Serenity buyers’ groupHow group buying works
See it for yourself
Visit the site with our team, or get a call to clear your questions. Free, no obligation.
Key facts: home types, towers, land and possession
- Home types
- 2 BHK, 3 BHK
- Carpet area
- 692 – 1,117 sq ft
- Towers
- 3
- Floors
- 12
- Total homes
- 270
- Land
- 3.84 acres
- Possession (RERA)
- Jul 2029
- Built (RERA update)
- 25%
Shriram Serenity RERA number and registration details
- RERA number
- PRM/KA/RERA/1251/309/PR/170924/007026
- Registered on
- 17 Sep 2024
- Promised completion
- 5 Jul 2029
- Extended to
- No extension recorded
- RERA status
- New launch
- Homes booked
- 270 of 270 as on
- Price
- Not found in public records yet: price
- Project type
- Residential
Towers and blocks (RERA filing)
| Tower | Floors | Basements | Homes |
|---|---|---|---|
| A | 11 | 2 | 96 |
| B | 12 | 2 | 78 |
| C | 12 | 2 | 96 |
A dash (—) means the filing did not state that value.
Summary in plain English
Shriram Serenity is a residential project by Shriram Properties Limited in Addeviswanathapura, Bengaluru North. The project has 270 homes across 3 towers with up to 12 floors. Construction is 25% complete as of 30 September 2026, with completion expected on 5 July 2029.
Written by AI from the RERA record above on 21 Oct 2026. Every number in it was checked against that record; if anything differs, the record wins.
Open space, home loans, escrow and other details
- Open space
- 80.9% of land
- Water and power
- Water source filed with RERA: BWSSB,Local Authority
- Home loans: approved banks
- Not found in public records yet: bank approvals
- Payment plans
- Not found in public records yet: payment plans
- Maintenance
- Not found in public records yet: maintenance
- Car parking
- Not found in public records yet: car parking charge
- Escrow bank (RERA)
- State Bank of Mauritius Ltd., DICKENSON ROAD,
- Building plan (RERA)
- Nelamangala Planning Authority · No. DPA/TP/CC/278/2022-23 · dated 27 Nov 2023
- Project cost declared to RERA
- ₹147 Cr
Open area as a share of the land, from the areas filed with RERA (includes driveways and landscaped areas).
Amenities
- Electricity
- Club House
- Swimming Pool
- Parks
- Power Backup
Amenities and internal works as filed by the promoter with Karnataka RERA; we have not visited the site.
Shriram Serenity location and address
- Address
- SY.NO 74/8, 74/10, 74/12, 74/13 & 74/15 ADDEVISWANATHAPURA VILLAGE, HESARAGHATTA HOBLI , YELAHANKA TALUK BANGALORE URBAN , Bengaluru North , Bengaluru Urban, Karnataka - 560064
- Village (RERA)
- Addeviswanathapura
- Locality
- Doddaballapur RoadAlso known as Doddaballapura Road, Doddaballapur Main Road
- PIN code
- 560064
- City
- Bengaluru
- State
- Karnataka
- Coordinates
- 13.17628, 77.54929
Distances to landmarks
Not found in public records yet: landmarksAbout Doddaballapur Road
Not found in public records yet: locality factsCommute times to tech parks and the airport
| To | Straight line | Peak-hour drive (estimate) |
|---|---|---|
| Manyata Tech ParkMap point on OpenStreetMap (opens in a new tab) | 16.17 km | approx. 65 min |
| Kempegowda International AirportMap point on OpenStreetMap (opens in a new tab) | 17.01 km | approx. 69 min |
| KSR Bengaluru City railway station (Majestic)Map point on OpenStreetMap (opens in a new tab) | 22.14 km | approx. 90 min |
| ITPL, Whitefield (main gate)Map point on OpenStreetMap (opens in a new tab) | 29.27 km | approx. 119 min |
| Outer Ring Road tech corridor (RMZ Ecospace, Bellandur)Map point on OpenStreetMap (opens in a new tab) | 31.51 km | approx. 128 min |
| Electronic City Phase 1Map point on OpenStreetMap (opens in a new tab) | 38.42 km | approx. 156 min |
How we calculate
Straight line: from the project’s map point on RERA to the destination’s point on OpenStreetMap.
Peak-hour drive is a rough estimate, not a route: straight line × 1.35 for the road network, at 20 km/h. Real times vary a lot with the route and the hour.
Sources:Source (openstreetmap.org) (opens in a new tab)How we calculate this
Schools and hospitals nearby
Within 2 km
- 6Schools and colleges1 schools, 5 colleges, 0 kindergartens
- 4Hospitals and clinics3 hospitals, 1 clinics
Nearest schools and colleges
- Presidency University Hostel · 1.03 km
- SVITgrounnd · 1.35 km
- Sri Vidya Institute of Technology · 1.36 km
Nearest hospitals and clinics
- Raksha health care · 1.14 km
- Rajankunte Hospital · 1.64 km
- Govt hospital,Rajanukunte · 1.66 km
Places as mapped on OpenStreetMap (amenity=school, college, kindergarten, university; hospital, clinic), counted within 2 km in a straight line of the RERA map point. Volunteers map these, so some places may be missing or closed. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Nearest metro station and railway
- Bagalur Cross (ಬಾಗಲೂರು ಕ್ರಾಸ್)Blue Line metro, under construction9.11 km
- Yelahanka (ಯಲಹಂಕ)Blue Line metro, under construction9.94 km
- Doddajala (ದೊಡ್ಡಜಾಲ)Blue Line metro, under construction10.41 km
- Nagasandra (ನಾಗಸಂದ್ರ)Open now — nearest operating metro station15.23 km
- Rajanukunte Nearest railway station1.77 km
Straight-line distances from the RERA map point to the station points mapped on OpenStreetMap; status (open or under construction) as tagged there. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Lake and lake-buffer check
The nearest mapped lake is Unnamed lake (mapped on OpenStreetMap), 874 m from the project’s RERA map point.
The site boundary is not published as a shape, so its nearest edge can be closer than this point. Whether any building sits inside a lake buffer can only be checked on the approved plan.
- Unnamed lake (mapped on OpenStreetMap) on OpenStreetMap (opens in a new tab) 874 m
- Adde Vishwanathapura Lake on OpenStreetMap (opens in a new tab) 937 m
- Unnamed lake (mapped on OpenStreetMap) on OpenStreetMap (opens in a new tab) 1,177 m
The buffer rule
Bengaluru’s lake buffer rule has changed over time: the National Green Tribunal ordered a 75 m buffer in May 2016; the Supreme Court set that order aside on 5 March 2019, leaving the 30 m buffer of the Revised Master Plan 2015. Check the current rule and the approved plan before relying on either number.
- LiveLaw: SC sets aside NGT order enlarging buffer zones (2019) (livelaw.in) (opens in a new tab)
- Citizen Matters: Shrinking lake buffers (citizenmatters.in) (opens in a new tab)
Shortest distance from the RERA map point to the mapped water edge (OpenStreetMap water polygons tagged lake or reservoir, or named lake/kere/tank). Mapped shorelines can differ from the revenue-record boundary of a lake. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Sources:Source (openstreetmap.org) (opens in a new tab)Source (livelaw.in) (opens in a new tab)Source (citizenmatters.in) (opens in a new tab)How we calculate this
Satellite time-lapse of the site
Satellite photos load when you scroll to them.
Photos from Esri World Imagery Wayback, centred on the project’s map point; dates are the capture dates in Esri’s metadata. Loaded from Esri when you scroll here.
Sources:Source (livingatlas.arcgis.com) (opens in a new tab)
Shriram Serenity floor plans, brochure and elevations
Documents the builder uploaded to Karnataka RERA, shown as filed. Tap a page to see it full size; the full PDF opens on the RERA website.

Brochure3 pages

BrochureFull PDF on RERA

Approved layout plan2 files

Approved Layout PlanFull PDF on RERA
Existing Layout PlanFull PDF on RERA
| Home type | Carpet area | Homes |
|---|---|---|
| 2 BHK | 692 – 818 sq ft | 110 |
| 3 BHK | 856 – 1,117 sq ft | 160 |
| Apartments- 2 BHK - type1 | 692 sq ft | 13 |
| Apartments- 2 BHK - type2 | 694 sq ft | 12 |
| Apartments- 2 BHK - type3 | 703 sq ft | 12 |
| Apartments- 2 BHK - type4 | 706 sq ft | 12 |
| Apartments- 2 BHK - type5 | 786 sq ft | 1 |
| Apartments- 2 BHK - type6 | 790 sq ft | 12 |
| Apartments- 2 BHK - type7 | 791 sq ft | 12 |
| Apartments- 2 BHK - type8 | 797 sq ft | 12 |
| Apartments- 2 BHK - type9 | 813 sq ft | 12 |
| Apartments- 2 BHK - type10 | 818 sq ft | 12 |
| Apartments- 3 BHK - type1 | 856 sq ft | 12 |
| Apartments- 3 BHK - type2 | 875 sq ft | 12 |
| Apartments- 3 BHK - type3 | 876 sq ft | 13 |
| Apartments- 3 BHK - type4 | 880 sq ft | 12 |
| Apartments- 3 BHK - type5 | 1,015 sq ft | 12 |
| Apartments- 3 BHK - type6 | 1,026 sq ft | 12 |
| Apartments- 3 BHK - type7 | 1,027 sq ft | 12 |
| Apartments- 3 BHK - type8 | 1,032 sq ft | 13 |
| Apartments- 3 BHK - type9 | 1,034 sq ft | 13 |
| Apartments- 3 BHK - type10 | 1,039 sq ft | 12 |
| Apartments- 3 BHK - type11 | 1,103 sq ft | 12 |
| Apartments- 3 BHK - type12 | 1,114 sq ft | 13 |
| Apartments- 3 BHK - type13 | 1,117 sq ft | 12 |
Home types, counts and carpet areas as filed with Karnataka RERA (carpet area, not super built-up).
We have not collected floor-plan drawings; the builder’s sales team can share them.
Shriram Serenity possession date and construction status
Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-12.
By tower (Q2 2026-27)
Units sold and unsold, from RERA (Q2 2026-27)
| Type | Homes | Booked | Available |
|---|---|---|---|
| 2 BHK | 110 | 110 | 0 |
| 3 BHK | 160 | 160 | 0 |
As reported by the promoter in the quarterly update to RERA, not verified by us.
Timeline
- 5 Jul 2024Project start date given to RERA
- 17 Sep 2024Registered with Karnataka RERA
- 5 Jul 2029Completion date given at registration
Construction pace from RERA quarterly filings
At the average pace so far, construction would reach 100% around Jun 2033 — about 47 months after the completion date on RERA (5 Jul 2029).
At the pace between the 4 quarterly filings we have (12% → 25% in 9 months), it would be around Jan 2031 — about 19 months after the RERA date.
- Filed on RERA
- Average pace since start
- Pace between filings (and 0% assumed at the start date)
- RERA completion date
Quarterly filings
| Quarter | Filed on | Built | Homes booked |
|---|---|---|---|
| Q2 2026-27to 30 Sep 2026 | 12 Oct 2026 | 25% | 270 of 270 |
| Q1 2026-27to 30 Jun 2026 | 9 Jul 2026 | 20% | 270 of 270 |
| Q4 2025-26to 31 Mar 2026 | 13 Apr 2026 | 15% | 196 of 270 |
| Q3 2025-26to 31 Dec 2025 | 3 Feb 2026 | 12% | 150 of 270 |
How we calculate
Average pace = % built ÷ months since the start date in the RERA record. Here: 25% ÷ 26.8 months (5 Jul 2024 to 30 Sep 2026) = 0.9% a month.
Estimated finish = latest filing date + (100 − % built) ÷ pace = 30 Sep 2026 + 75 ÷ 0.9 = 80.5 months → Jun 2033. This is an estimate, not a date from the builder or RERA.
Pace between filings = (25% − 12%) ÷ 9 months = 1.4% a month.
A straight line is a simplification: the builder reports one overall %, which mixes excavation, structure and finishing, and work rarely moves at a constant speed. The % values are the promoter’s own figures filed with RERA, not checked by us. Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-12.
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
Approvals and documents checklist
20 rows: approvals. Scroll inside the table to see them all.
| Approval | Authority | Source |
|---|---|---|
| Building plan | Nelamangala Planning Authority · No. DPA/TP/CC/278/2022-23 · dated 2023-11-27 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Land conversion (2 orders) | District office,Bangalore · No. ALN(NA)(HA) SR 17 2011-12 and 1 more · dated 2016-03-10 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Commencement Certificate | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Electricity Permission Letter | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Water Permission Letter | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Layout Plan | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Building/Plotting Plan | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Section Of Building/Infrastructure Plan of Plotting | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Change of Land Use | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| District Magistrate | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Conversion Certificate under section 95 of the KLR Act 1964 | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| ESCOM/Electricity | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KWSSB/Water | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approval/NOC under section 109 of KLR Act 1961 | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approval/NOC under section 14 of the KTCP Act | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Fire Force Department | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Airport Authority of India | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KSPCB | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| SEIAA | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| NOC in case of building proposals abutting to neighbouring properties | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
Documents uploaded to RERA
- Building or layout plan · Approved drawings from the planning authorityFiled on RERA ✓ — Nelamangala Planning Authority · No. DPA/TP/CC/278/2022-23 · dated 27 Nov 2023
- Commencement certificate · Permission to start buildingFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Environment clearance · SEIAA KarnatakaFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Fire NOC · Karnataka Fire and Emergency ServicesFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Pollution board consent · KSPCBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Water and sewerage · BWSSBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Electricity · BESCOMFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Height clearance · Airports Authority of IndiaFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Occupancy certificate (OC) · Issued only when the building is finishedNot on RERA yet — expected at completion
From the documents the promoter uploaded to Karnataka RERA, collected 21 Oct 2026. “Filed” means a document is on RERA — we have not checked its contents or validity. Not every approval applies to every project (for example, smaller projects may not need an environment clearance). The project page on RERA lists each upload.
Shriram Serenity RERA complaints and orders
1 complaint as on Source (rera.karnataka.gov.in) (opens in a new tab)
| Complaint ref | Filed | Subject | Status | Source |
|---|---|---|---|---|
| 00176/2025 | 23 Jan 2025 | Refund of Booking Amount | Disposed | Source (rera.karnataka.gov.in) (opens in a new tab) |
Court and consumer cases
We list case numbers, courts and outcomes only — never names of private individuals.
About Shriram Properties Limited
- Promoter type
- Company
- Projects on this site
- 4
- RERA complaints against promoter
- 123
- Company number (CIN)
- U72200TN2000PLC044560
From Karnataka RERA, as collected so far (21 Oct 2026). Complaints are those RERA lists against this promoter across all its projects.
Shriram Properties Limited’s RERA recordShriram Properties Limited delivery record
- 4Projects in Bengaluru on RERA4 approved registrations under Shriram Properties Limited in Bengaluru Urban and Rural. Source (rera.karnataka.gov.in) (opens in a new tab)
- 1,092Homes registeredAs stated in each registrations.
- 123RERA complaints13 open, 110 disposed. as on Source (rera.karnataka.gov.in) (opens in a new tab)
- 112.6Complaints per 1,000 homes123 complaints ÷ 1,092 homes in its 4 registrations on Karnataka RERA in Bengaluru.
What the complaints are about
123 complaint subjects as written on RERA, as on . Each subject is sorted into one group by keywords (first match wins: delay, refund, registration, quality, litigation, association); one complaint often raises several issues. Source (rera.karnataka.gov.in) (opens in a new tab)
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
What’s changed since Nov 2023
- 12 Oct 2026Quarterly update filed for Q2 2026-27: 25% built, 270 of 270 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 9 Jul 2026Quarterly update filed for Q1 2026-27: 20% built, 270 of 270 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 13 Apr 2026Quarterly update filed for Q4 2025-26: 15% built, 196 of 270 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 3 Feb 2026Quarterly update filed for Q3 2025-26: 12% built, 150 of 270 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 23 Jan 2025Complaint 00176/2025 filed with RERA: “Refund of Booking Amount” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 17 Sep 2024Registered with Karnataka RERA (PRM/KA/RERA/1251/309/PR/170924/007026); completion date 5 Jul 2029 Source (rera.karnataka.gov.in) (opens in a new tab)
- 5 Jul 2024Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
- 27 Nov 2023Building plan approved by Nelamangala Planning Authority (No. DPA/TP/CC/278/2022-23) Source (rera.karnataka.gov.in) (opens in a new tab)
Newest first. No extension of the completion date is recorded on RERA. When the RERA crawl sees a new filing, complaint or extension, it is added here with its date.
Home loan EMI calculator
- Monthly EMI
- —
- Down payment
- —
- Loan amount
- —
- Total interest
- —
A calculation only, from the numbers you enter — not a loan offer.
All-in cost: GST, registration and other charges
The calculator loads when you scroll to it.
Assumptions
- Base price: the builder’s price is not published in a form we could collect — enter it from the cost sheet.
- GST 5% on the base price and charges — the usual rate for an under-construction home that is not “affordable housing” (1%).
- Stamp duty about 5.6% and registration 2% — the Karnataka rule (registration was raised from 1% to 2% on 31 Aug 2025). Calculated on the agreement value.
- Car parking, other charges and the maintenance deposit are not in the public record we collect; enter them from the builder’s cost sheet.
- Loan on the agreement value (banks usually lend up to 75–90%); EMI is the standard reducing-balance formula. Example rate only — use your bank’s quote.
Shriram Serenity FAQs
What types of homes are in Shriram Serenity?
The project has 2 BHK and 3 BHK apartments. 2 BHK homes have carpet areas from 692 to 818 sq ft, and 3 BHK homes have carpet areas from 856 to 1,117 sq ft.
How many homes are in Shriram Serenity?
The project has 270 homes total: 110 homes are 2 BHK and 160 homes are 3 BHK.
When will Shriram Serenity be completed?
The completion date on RERA is 5 July 2029.
What is the RERA registration number for Shriram Serenity?
The RERA registration number is PRM/KA/RERA/1251/309/PR/170924/007026, registered on 17 September 2024.
Where is Shriram Serenity located?
Shriram Serenity is in Addeviswanathapura, Bengaluru North taluk, PIN code 560064.
How many towers does Shriram Serenity have?
The project has 3 towers, each with up to 12 floors.
What is the construction progress of Shriram Serenity?
As of 30 September 2026, construction is 25% complete.
How many homes are booked in Shriram Serenity?
As of 30 September 2026, all 270 homes are booked.
Are there any RERA complaints on Shriram Serenity?
There is 1 RERA complaint filed on this project registration.
What is the builder's record with RERA?
Shriram Properties Limited has 123 RERA complaints across all projects and 8 projects registered with RERA in Bengaluru on this record.
Written by AI from the RERA record above on 21 Oct 2026. Answers use only that record; check them against the source before you decide.
Questions about Shriram Serenity
No questions published yet. Ask the first one: you get an instant answer from this page’s public record, and our team follows up on anything the record does not show.
Bought a home from Shriram Properties Limited? Review the builder.
Reviews of Shriram Properties Limited by verified buyers
No verified reviews of Shriram Properties Limited yet. If you bought a home from them, your review helps other buyers.
How reviews work: only buyers and owners can review; we confirm each purchase by phone before publishing, publish positive and negative reviews alike, never accept payment for reviews, and the builder may reply.
Similar projects within 5 km
| Project | Distance | Homes | Possession (RERA) | Built | Complaints | Price |
|---|---|---|---|---|---|---|
| Sattva LuminaSattva Resi Private Limited | 0.5 km | 1,553 | Nov 2029 | 30% | 1 | Not collected |
| Hoysala VemanaHoysala Lifespace LLP | 0.6 km | 82 | Jun 2031 | 4% | 0 | Not collected |
| PM GardenPrayuktha Properties LLP | 0.8 km | 75 | Dec 2030 | 25% | 0 | Not collected |
| Atmos TropicalwoodsAtmos Constructions Private Limited | 0.8 km | 150 | Sep 2027 | 5% | 0 | Not collected |
| Aranya OneManasoubhagya Ventures LLP | 0.9 km | 175 | Jul 2029 | 11% | 0 | Not collected |
| Assetz Miru & MiyoApg Green Homes Private Limited | 2.5 km | 350 | Mar 2031 | 45% | 0 | Not collected |
Projects of the same kind within 5 km in a straight line of this project’s RERA map point, nearest first. % built is the promoter’s latest quarterly figure on RERA (shown for single-registration projects); prices are from the builder’s own website where we found one.
Sources and last checked dates
Collected on 21 Oct 2026 by AI research agents reading public pages. Facts are written in our own words. Not found yet: price; court cases; landmarks; specifications; news.
How to check on RERA: On rera.karnataka.gov.in/viewAllProjects, type the registration number in 'Registration No', press Search, then click the 'View Project Details' icon. Complaints open from the 'Complaints / Litigation' icon in the same row. Registration number: PRM/KA/RERA/1251/309/PR/170924/007026.
- RERA record last checked: 21 Oct 2026
- Last change in the record (registration, quarterly filing or complaint): 21 Oct 2026
How this page is made: software builds it from public records (Karnataka RERA filings, OpenStreetMap, the builder’s own website). AI is used only to read filings into fields and to write the plain-English summary and FAQ answers, which are checked against the record. Facts are checked automatically against the RERA filing. Methodology · How we earn · Report an error
More new projects in Doddaballapur Road
Rajanukunte, Doddaballapur RoadArtist’s impressionUnder constructionRERA registeredBuyers’ group openSattva Lumina
by Sattva Resi
Price: Price on requestGet brochure & price →
- Studio, 1 BHK, 2 BHK, 3 BHK
- 269 – 1,091 sq ft
- Nov 2029
1,553 homes · 1 RERA complaint
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Sattva Lumina
off Addevishvanathapura, Doddaballapur RoadUnder constructionRERA registeredBuyers’ group openHoysala Vemana
by Hoysala Lifespace
Price: Price on requestGet brochure & price →
- 2 BHK, 3 BHK
- 764 – 1,073 sq ft
- Jun 2031
82 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Hoysala Vemana
Addevishwanathapura, Doddaballapur RoadUnder constructionRERA registeredBuyers’ group openPM Garden
by Prayuktha Properties
Price: Price on requestGet brochure & price →
- 2 BHK, 3 BHK
- 757 – 987 sq ft
- Dec 2030
75 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for PM Garden
