Sierra Greens

1, 2 & 3 BHK apartments by Sierra Constructions · Bikkanahalli, Bengaluru

Bikkanahalli, BengaluruOpen on Google Maps (opens in a new tab)

  • Under construction
  • RERA registered
  • residential

by Sierra Constructions

Price: Price on request

Get brochure, floor plans & price

Brochure, floor plans and price list for Sierra Greens

Builders share their brochure, floor plans and price list only on request. Tell us how to reach you and we’ll get them and send them to you, free.

Free for buyers. If you book through us, the builder pays us a commission. How we earn

Project summary

Sierra Greens is a residential project by Sierra Constructions in Bikkanahalli, Bengaluru with 304 homes, registered with Karnataka RERA. The completion date on RERA is 31 Mar 2028.

Facts collected on 13 Oct 2026 from public records — each linked to its source. Free for buyers. If you book through us, the builder pays us a commission.

Sierra Greens buyers’ group: join to ask for a group price

No one has joined yet. Be one of the first 10 buyers in this group — the founding members.

Join free. When enough buyers have joined, our agent partner asks Sierra Constructions for a group price — for example a lower price, an easier payment plan or waived charges. Nothing is promised: you see what the builder offers and book directly with the builder if you want to. Free for buyers. If you book through us, the builder pays us a commission.

  1. Gathering buyers
  2. Talking to the builder
  3. Group offer
  4. Group site visit
  5. Booking

0 buyers have joined · 0 committed

Committed buyers have confirmed their budget, home type and timeline with us on a call; builders negotiate with them. Joining is free and never obliges you to buy.

Join the Sierra Greens buyers’ groupHow group buying works

See it for yourself

Visit the site with our team, or get a call to clear your questions. Free, no obligation.

Key facts: home types, towers, land and possession

Updated on 13 Oct 2026
Home types
1 BHK, 2 BHK, 3 BHK
Carpet area
530 – 1,130 sq ft
Towers
3
Floors
4
Total homes
304
Land
2.16 acres
Possession (extended)
Mar 2028
Built (RERA update)
92%

Sierra Greens RERA number and registration details

RERA number
PRM/KA/RERA/1251/308/PR/200526/003414
Registered on
26 May 2020
Promised completion
16 Dec 2022
Extended to
31 Mar 2028
RERA status
New launch
Homes booked
56 of 304 as on
Price
Not found in public records yet: price
Project type
Residential

Towers and blocks (RERA filing)

TowerFloorsBasementsHomes
Sierra Greens - Block 14056
Sierra Greens - Block 24048
Sierra Greens - Block 34048

A dash (—) means the filing did not state that value.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Summary in plain English

Sierra Greens is a residential project by Sierra Constructions in Bikkanahalli, Anekal, with 304 homes across 3 towers of up to 4 floors. The project's RERA completion date is 31 March 2028.

Written by AI from the RERA record above on 5 Oct 2026. Every number in it was checked against that record; if anything differs, the record wins.

Open space, home loans, escrow and other details

Open space
25% of land
Water and power
Not found in public records yet: water and power
Home loans: approved banks
Not found in public records yet: bank approvals
Payment plans
Not found in public records yet: payment plans
Maintenance
Not found in public records yet: maintenance
Car parking
Not found in public records yet: car parking charge
Escrow bank (RERA)
ICICI Bank, Domlur Branch
Project cost declared to RERA
₹32 Cr

Open area as a share of the land, from the areas filed with RERA (includes driveways and landscaped areas).

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Amenities

Not found in public records yet: amenities

Sierra Greens location and address

Address
Survey No.16/7 of Bikkanahalli Village, Sarjapura Hobli
Village (RERA)
Bikkanahalli
PIN code
560043
City
Bengaluru
State
Karnataka
Coordinates
12.84000, 77.77000

Distances to landmarks

Not found in public records yet: landmarks

About Bikkanahalli

Not found in public records yet: locality facts

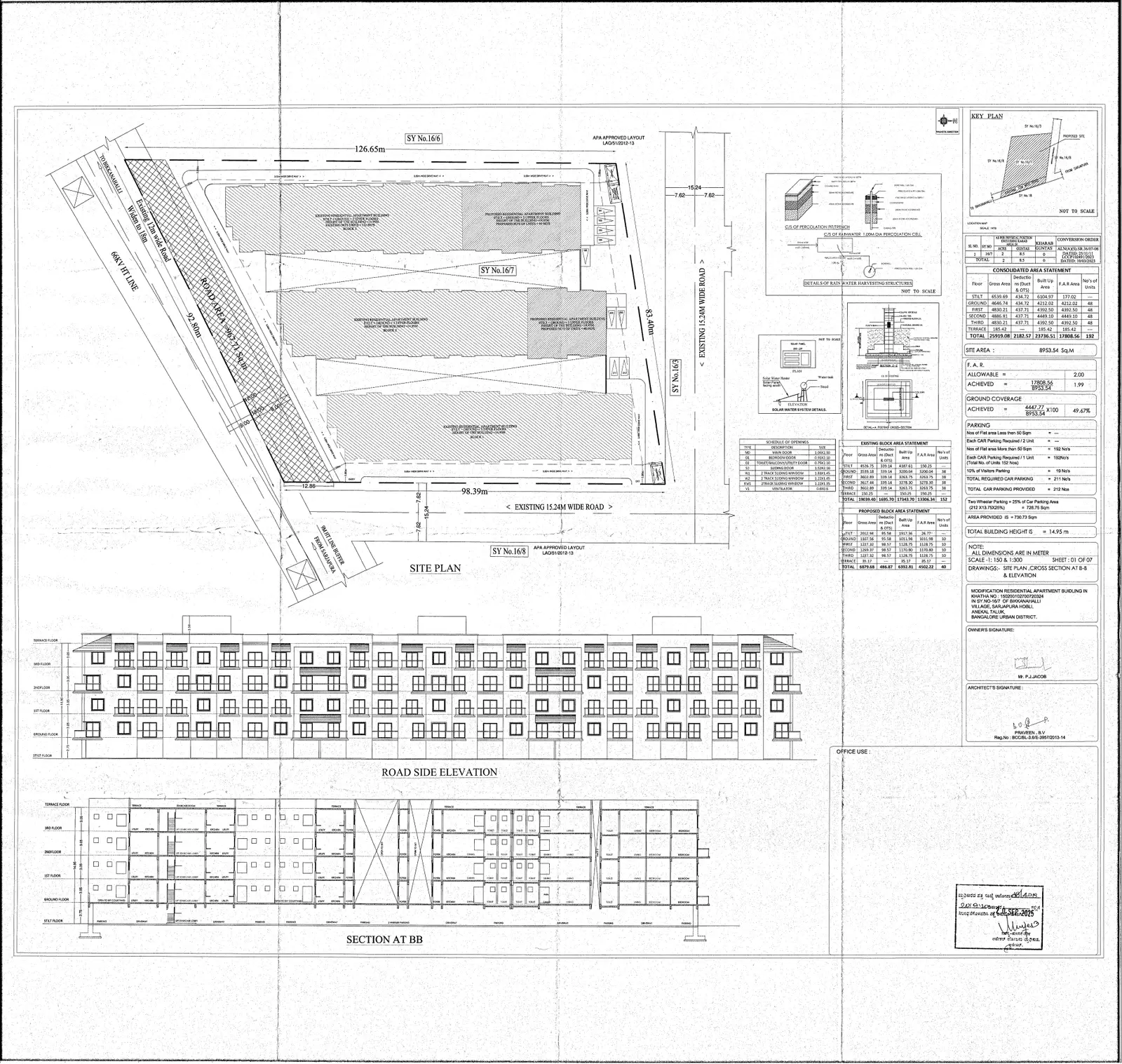

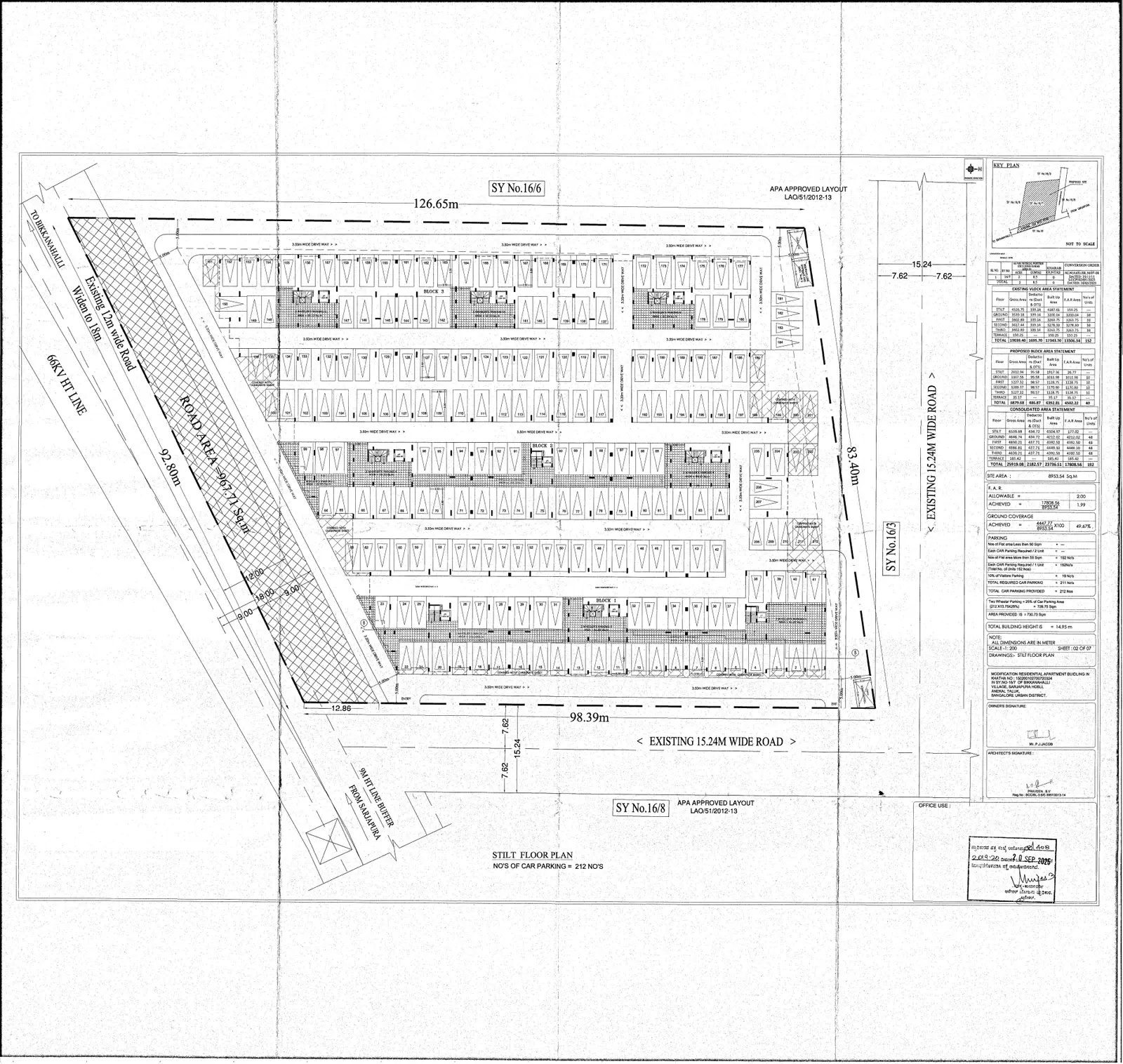

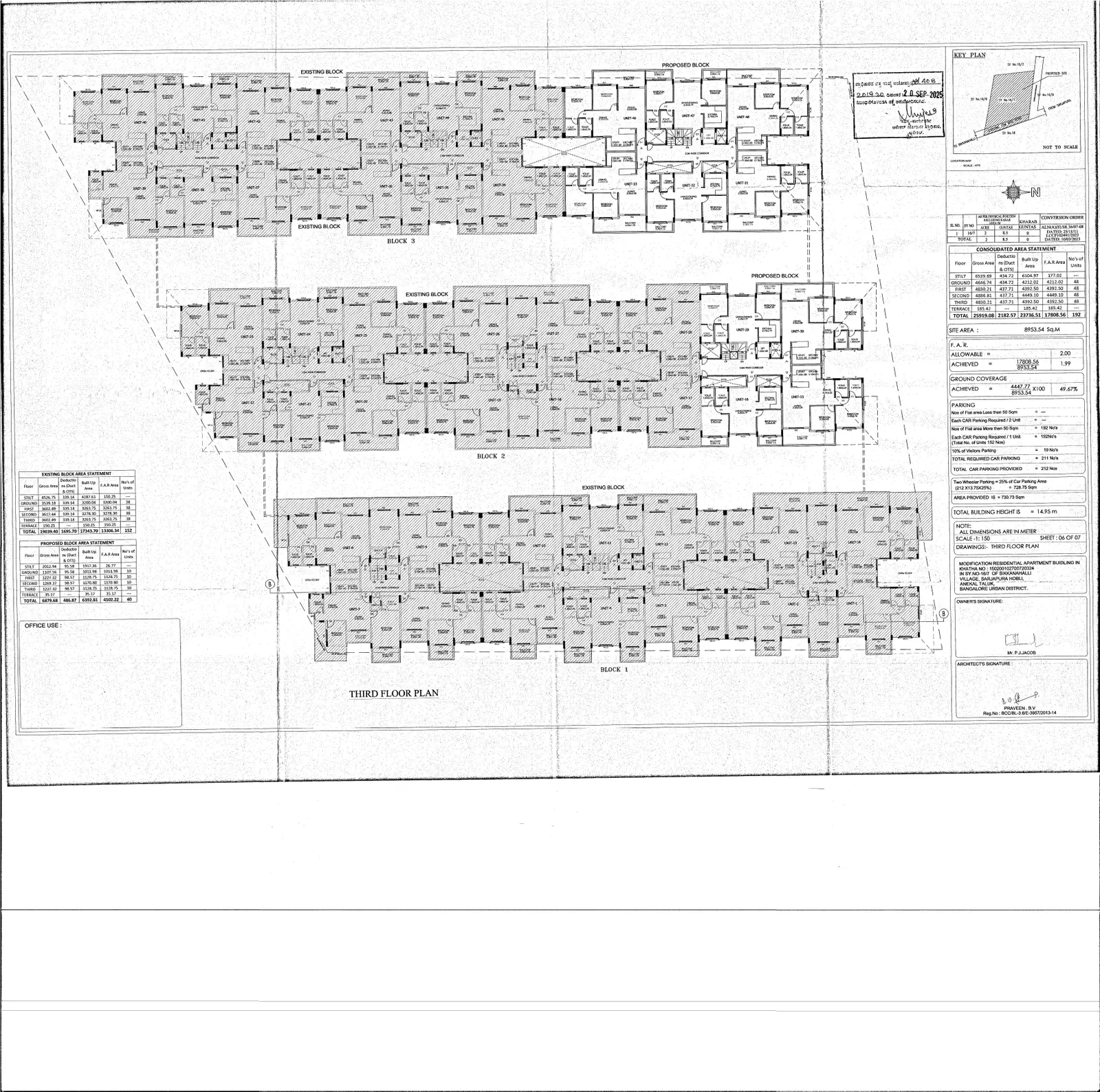

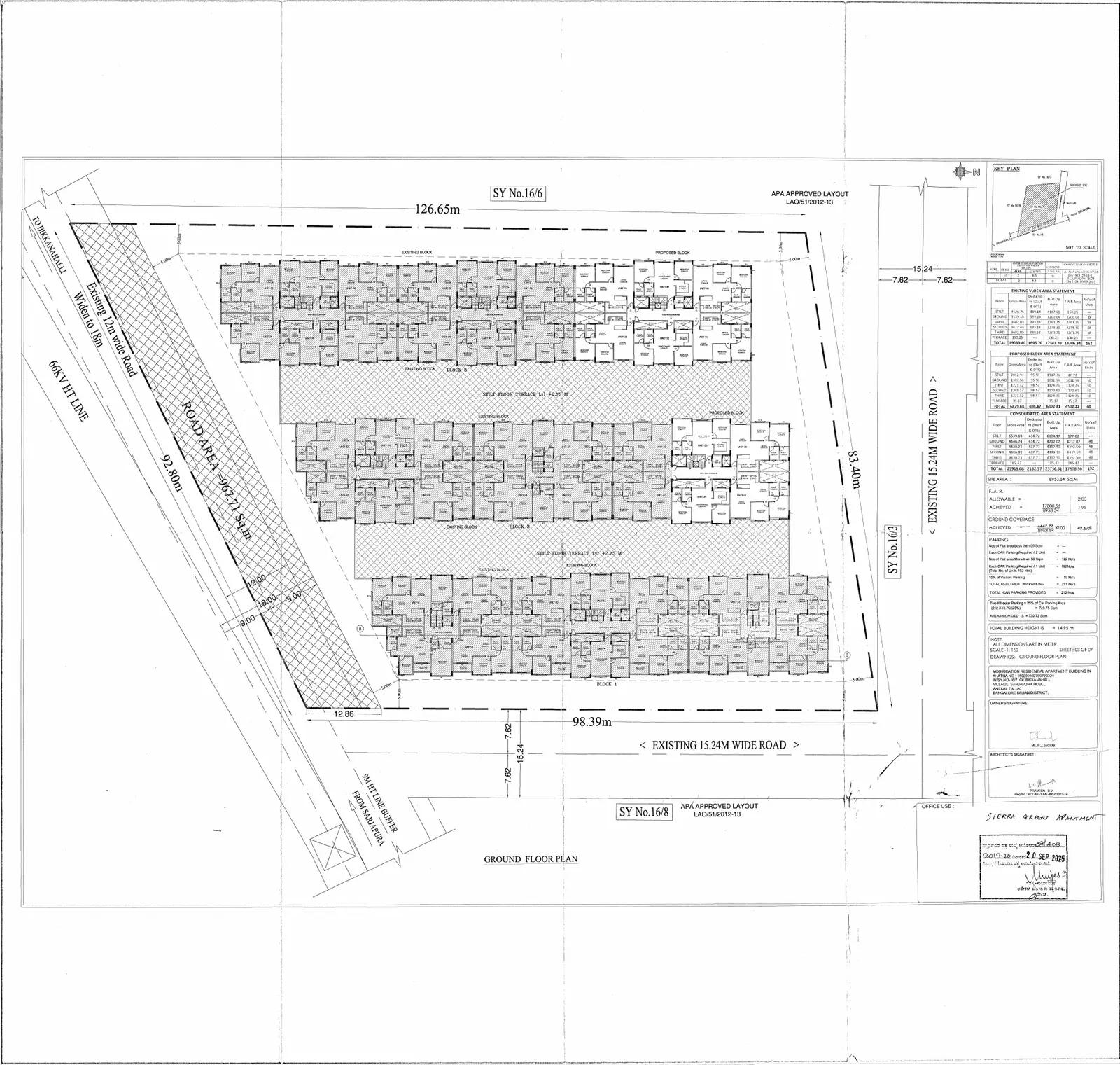

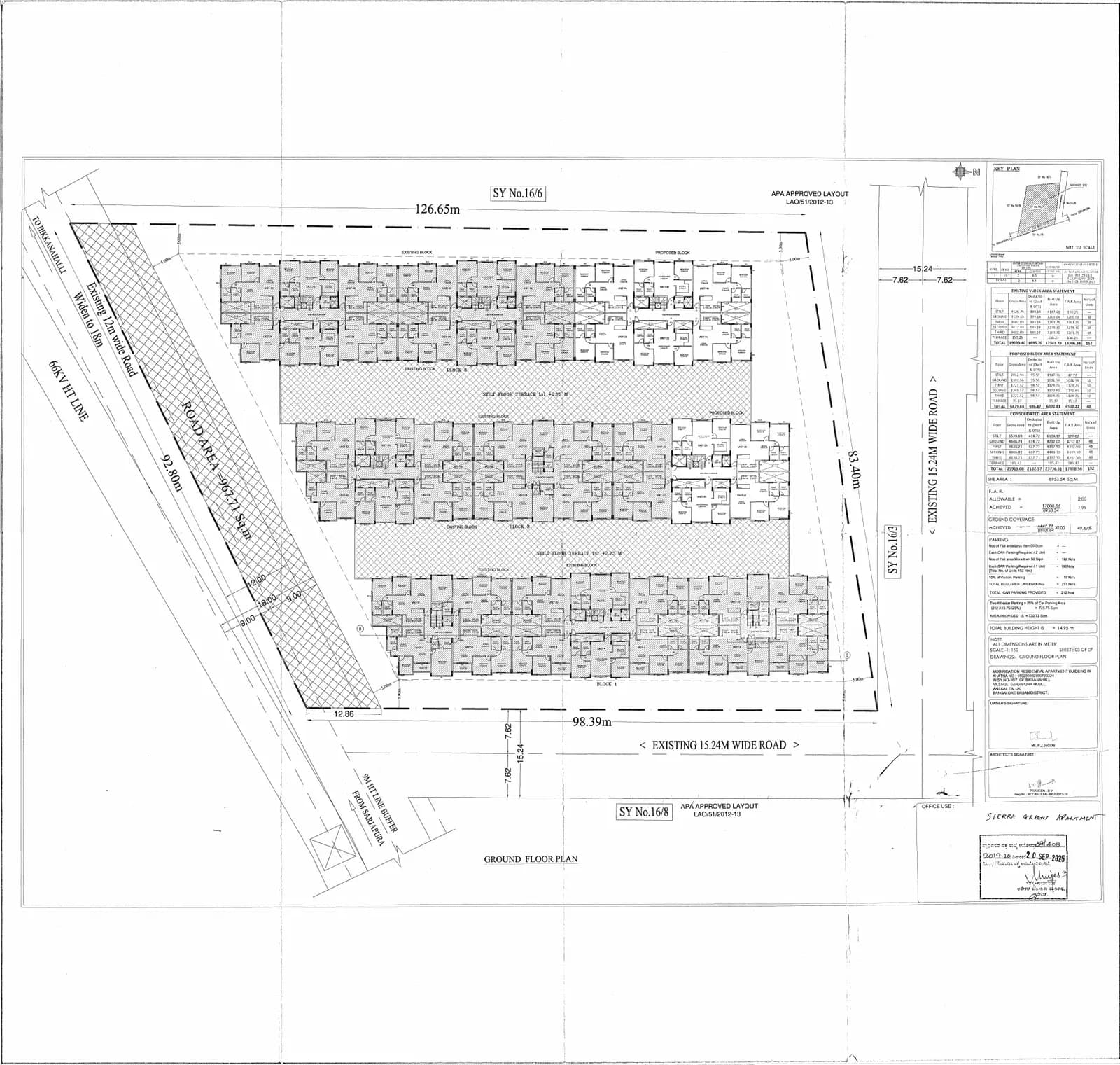

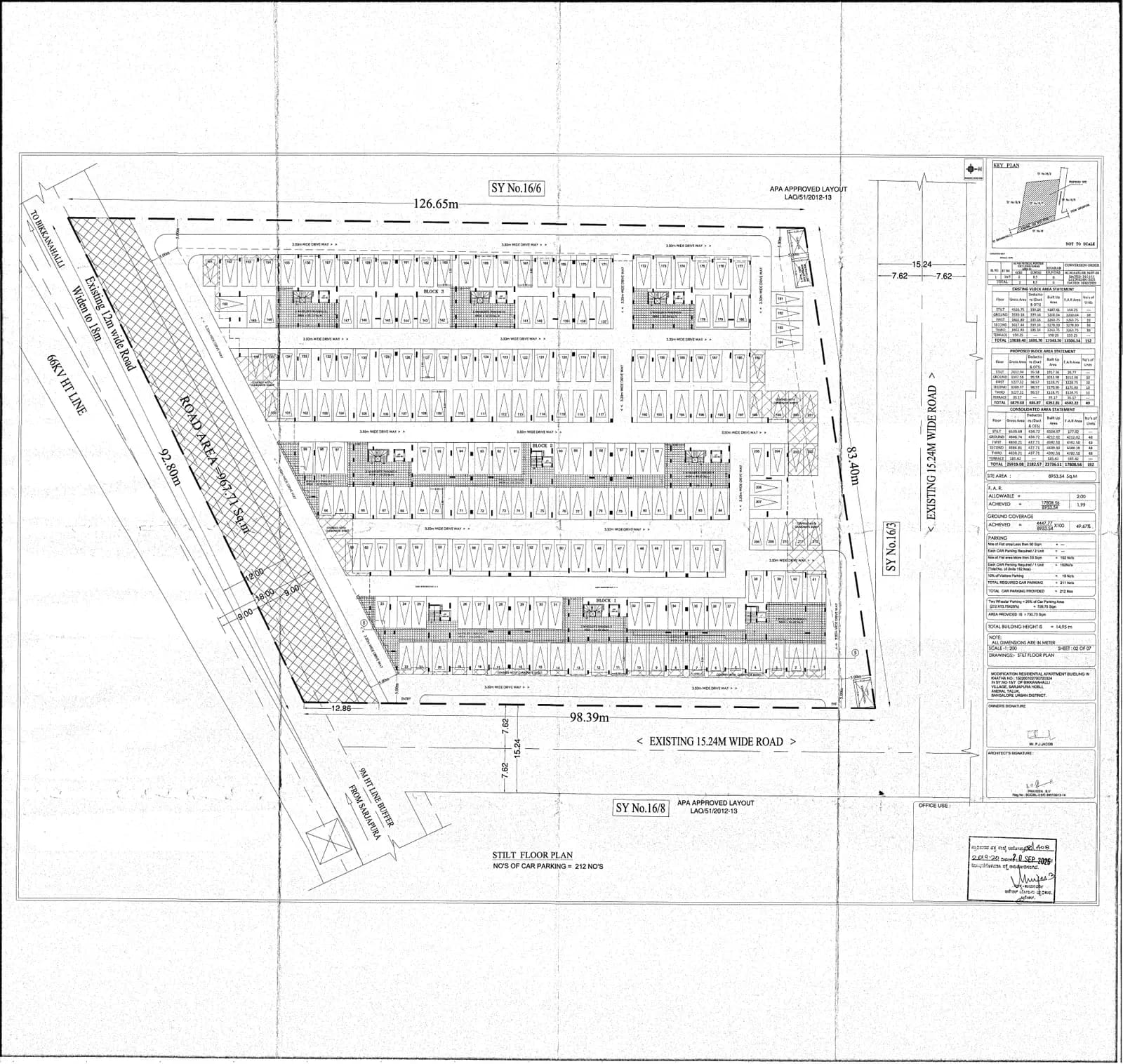

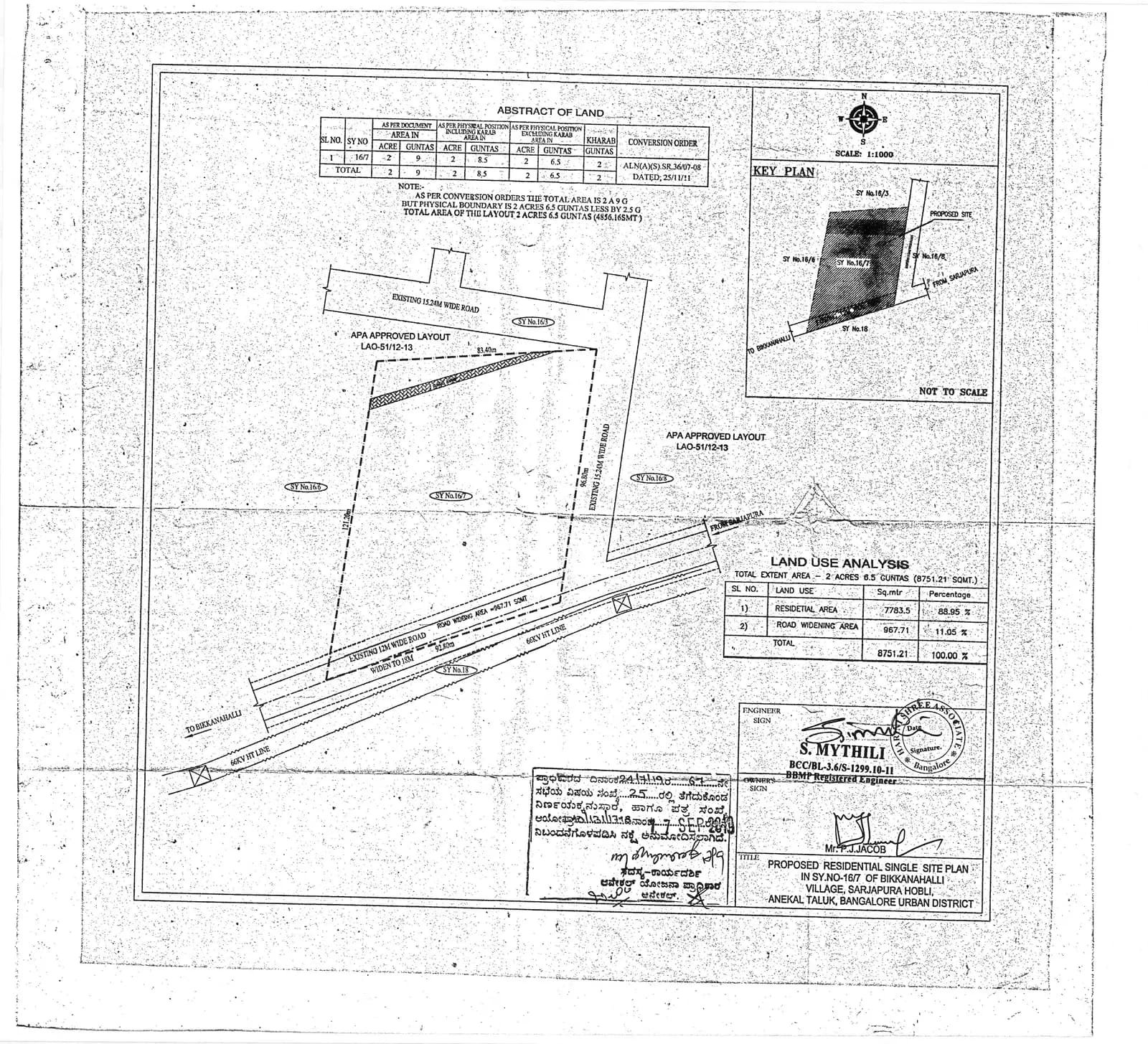

Sierra Greens floor plans, brochure and elevations

Documents the builder uploaded to Karnataka RERA, shown as filed. Tap a page to see it full size; the full PDF opens on the RERA website.

Floor plans10 files

Elevations2 files

Approved building plan

Home typeCarpet areaHomes
1 BHK530 sq ft8
2 BHK730 – 1,130 sq ft124
3 BHK1,040 – 1,130 sq ft20
Residential apartments942 sq ft152

Home types, counts and carpet areas as filed with Karnataka RERA (carpet area, not super built-up).

We have not collected floor-plan drawings; the builder’s sales team can share them.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

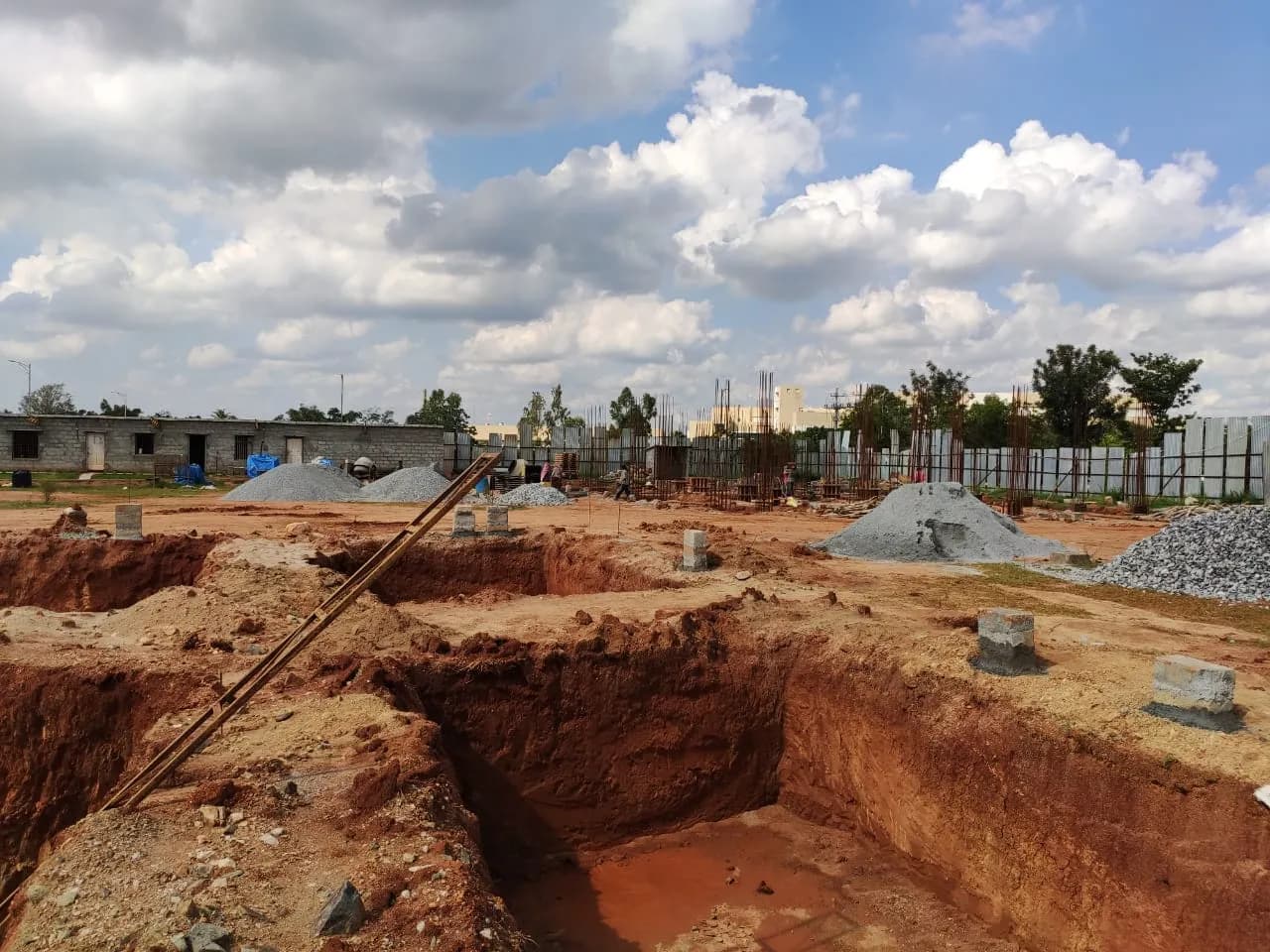

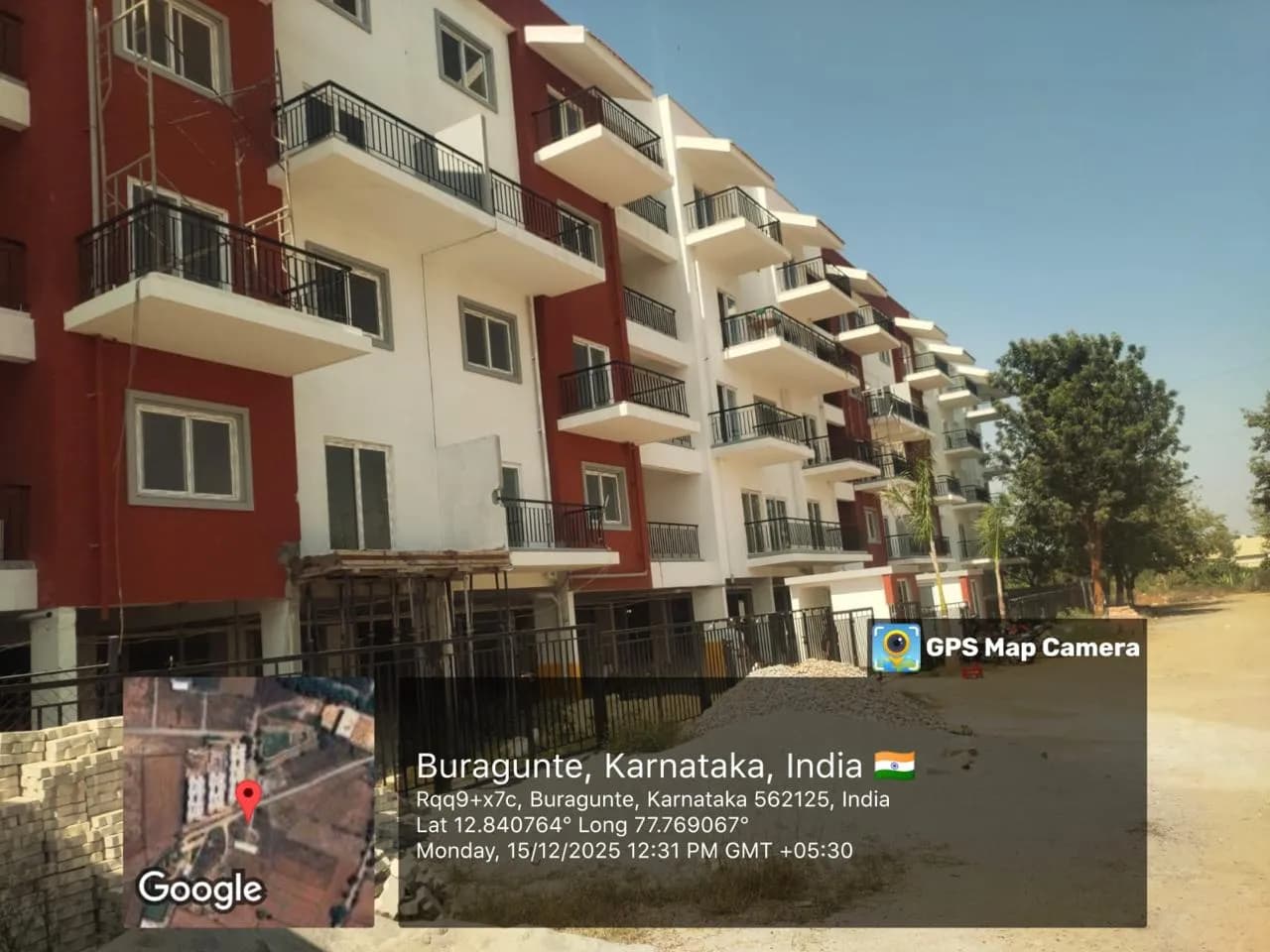

Sierra Greens possession date and construction status

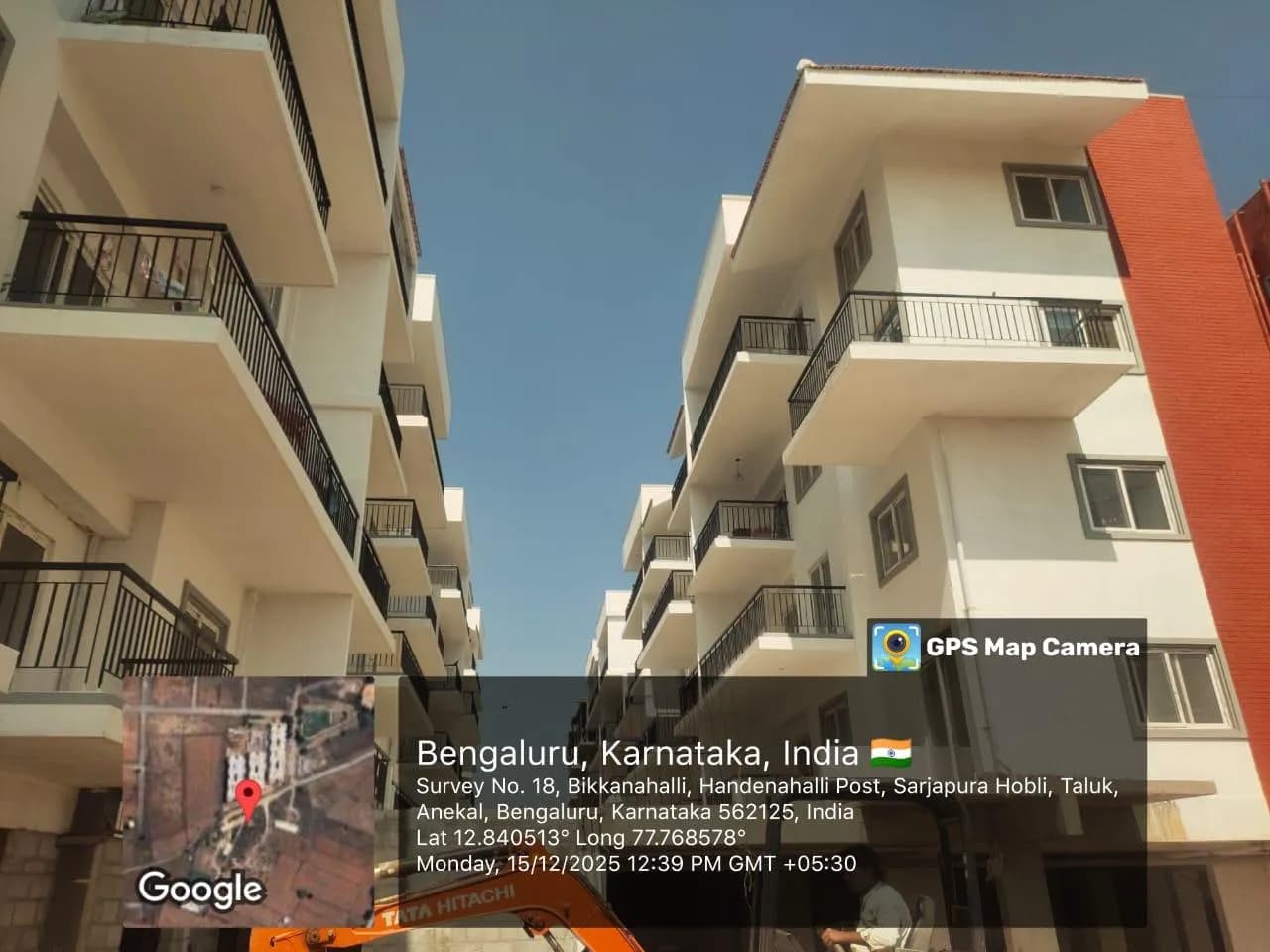

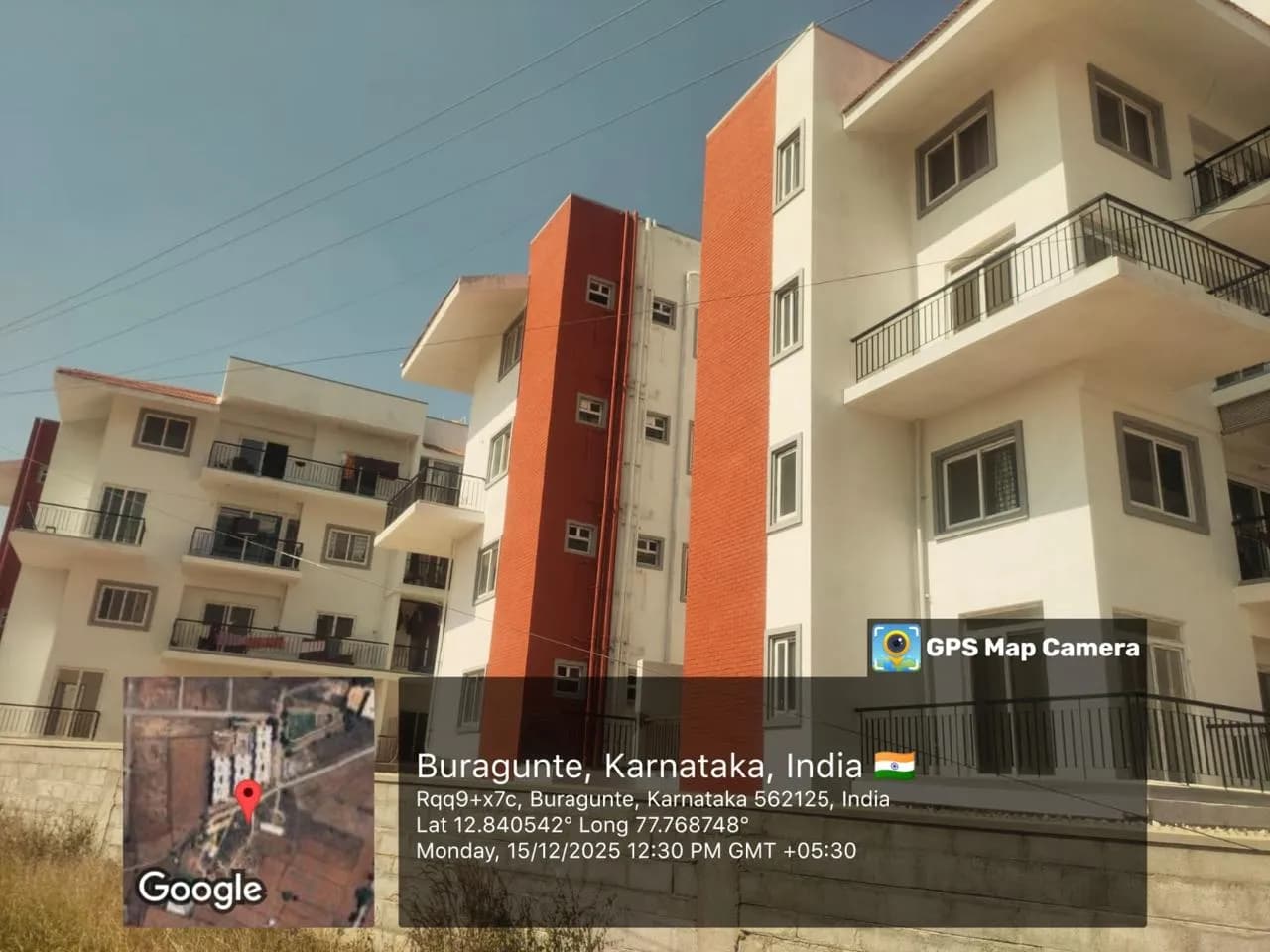

  • Whole project (promoter’s RERA update)92%

    as on · 56 of 304 homes booked

Promoter’s quarterly update to RERA for Q3 2025-26, submitted 2026-03-31.

By tower (Q3 2025-26)

  • Sierra Greens - Block 190%
  • Sierra Greens - Block 292%
  • Sierra Greens - Block 395%

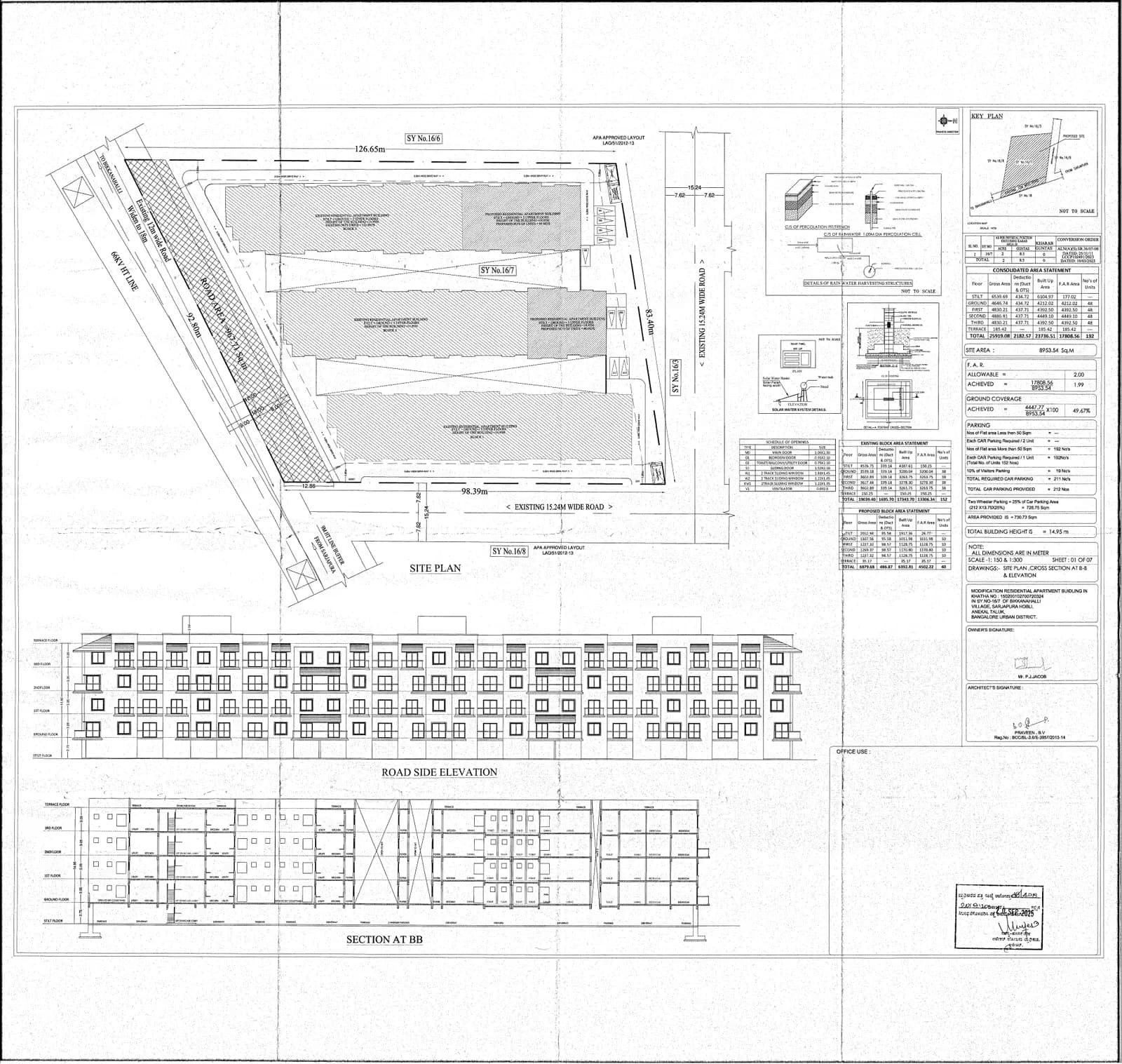

Units sold and unsold, from RERA (Q3 2025-26)

TypeHomesBookedAvailable
2 BHK1244282
3 BHK201010
1 BHK844

As reported by the promoter in the quarterly update to RERA, not verified by us.

Timeline

  1. 27 Feb 2020Project start date given to RERA
  2. 26 May 2020Registered with Karnataka RERA
  3. 16 Dec 2022Completion date given at registration
  4. 16 Sep 2023Covid Extension: completion date moved to this date
  5. 16 Sep 2024Section 6 Extension: completion date moved to this date
  6. 31 Mar 2028Further Extension: completion date moved to this date

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Construction pace from RERA quarterly filings

As on 31 Mar 2026

At the average pace so far, construction would reach 100% around Jul 2026 — about 21 months before the completion date on RERA (31 Mar 2028).

0%25%50%75%100%20212022202320242025202620272028RERA date92%
  • Filed on RERA
  • Average pace since start
  • RERA completion date

Quarterly filings

QuarterFiled onBuiltHomes booked
Q3 2025-26to 31 Dec 202531 Mar 202692%56 of 152
How we calculate

Average pace = % built ÷ months since the start date in the RERA record. Here: 92% ÷ 70.1 months (27 Feb 2020 to 31 Dec 2025) = 1.3% a month.

Estimated finish = latest filing date + (100 − % built) ÷ pace = 31 Dec 2025 + 8 ÷ 1.3 = 6.1 months → Jul 2026. This is an estimate, not a date from the builder or RERA.

A straight line is a simplification: the builder reports one overall %, which mixes excavation, structure and finishing, and work rarely moves at a constant speed. The % values are the promoter’s own figures filed with RERA, not checked by us. Promoter’s quarterly update to RERA for Q3 2025-26, submitted 2026-03-31.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this

Approvals and documents checklist

ApprovalAuthoritySource
Building planBMRDA - Bangalore Metropolitan Region Development AuthoritySource (rera.karnataka.gov.in) (opens in a new tab)

Documents uploaded to RERA

As on 13 Oct 2026
  • Building or layout plan · Approved drawings from the planning authorityFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Commencement certificate · Permission to start buildingNot on RERA yet
  • Environment clearance · SEIAA KarnatakaNot on RERA yet
  • Fire NOC · Karnataka Fire and Emergency ServicesNot on RERA yet
  • Pollution board consent · KSPCBNot on RERA yet
  • Water and sewerage · BWSSBNot on RERA yet
  • Electricity · BESCOMNot on RERA yet
  • Height clearance · Airports Authority of IndiaNot on RERA yet
  • Occupancy certificate (OC) · Issued only when the building is finishedNot on RERA yet — expected at completion

From the documents the promoter uploaded to Karnataka RERA, collected 13 Oct 2026. “Filed” means a document is on RERA — we have not checked its contents or validity. Not every approval applies to every project (for example, smaller projects may not need an environment clearance). The project page on RERA lists each upload.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Sierra Greens RERA complaints

No complaints listed on Karnataka RERA for this registration as on Source (rera.karnataka.gov.in) (opens in a new tab)

Court and consumer cases

Not found in public records yet: court cases

We list case numbers, courts and outcomes only — never names of private individuals.

About Sierra Constructions

Promoter type
Partnership Firm
Projects on this site
1
RERA complaints against promoter
0
Company number (CIN)
Not found in public records yet: CIN

From Karnataka RERA, as collected so far (13 Oct 2026). Complaints are those RERA lists against this promoter across all its projects.

Sierra Constructions’s RERA record

Sierra Constructions delivery record

As on 13 Oct 2026

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this

What’s changed since Feb 2020

As on 13 Oct 2026
  1. 31 Mar 2028Completion date extended to 31 Mar 2028 Source (rera.karnataka.gov.in) (opens in a new tab)
  2. 31 Mar 2026Quarterly update filed for Q3 2025-26: 92% built, 56 of 152 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  3. 26 May 2020Registered with Karnataka RERA (PRM/KA/RERA/1251/308/PR/200526/003414); completion date 16 Dec 2022 Source (rera.karnataka.gov.in) (opens in a new tab)
  4. 27 Feb 2020Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)

Newest first. When the RERA crawl sees a new filing, complaint or extension, it is added here with its date.

Home loan EMI calculator

No listed price found — enter one to try.

Example only — use your bank’s quote.

Monthly EMI
—
Down payment
—
Loan amount
—
Total interest
—

A calculation only, from the numbers you enter — not a loan offer.

All-in cost: GST, registration and other charges

The calculator loads when you scroll to it.

Assumptions
  • Base price: the builder’s price is not published in a form we could collect — enter it from the cost sheet.
  • GST 5% on the base price and charges — the usual rate for an under-construction home that is not “affordable housing” (1%).
  • Stamp duty about 5.6% and registration 2% — the Karnataka rule (registration was raised from 1% to 2% on 31 Aug 2025). Calculated on the agreement value.
  • Car parking, other charges and the maintenance deposit are not in the public record we collect; enter them from the builder’s cost sheet.
  • Loan on the agreement value (banks usually lend up to 75–90%); EMI is the standard reducing-balance formula. Example rate only — use your bank’s quote.

How we calculate this

Sierra Greens FAQs

What is the RERA registration number for Sierra Greens?

The RERA registration number is PRM/KA/RERA/1251/308/PR/200526/003414, registered on 26 May 2020.

When is Sierra Greens expected to be completed?

The completion date on RERA is 31 March 2028. The project has received extensions for Covid, Section 6, and further reasons.

What home types are available in Sierra Greens?

The project offers 1 BHK (530 sq ft carpet area), 2 BHK (730-1,130 sq ft), 3 BHK (1,040-1,130 sq ft), and residential apartments (942 sq ft).

How many homes are in Sierra Greens?

The project has a total of 304 homes.

How many homes have been booked in Sierra Greens?

As of the Q3 2025-26 update (ended 31 December 2025), 56 homes have been booked, with 152 homes in the booking table.

What is the construction progress of Sierra Greens?

As of Q3 2025-26, the project is 92 per cent complete.

Where is Sierra Greens located?

Sierra Greens is in Bikkanahalli, Anekal taluk, Bengaluru Urban district, PIN code 560043.

Are there any RERA complaints against Sierra Greens?

There are no RERA complaints on this project or against the builder.

What is the escrow bank for Sierra Greens?

The escrow bank for the project is ICICI Bank.

How many towers does Sierra Greens have?

Sierra Greens has 3 towers, each with up to 4 floors.

Written by AI from the RERA record above on 5 Oct 2026. Answers use only that record; check them against the source before you decide.

Questions about Sierra Greens

No questions published yet. Ask the first one: you get an instant answer from this page’s public record, and our team follows up on anything the record does not show.

Bought a home from Sierra Constructions? Review the builder.

Reviews of Sierra Constructions by verified buyers

No verified reviews of Sierra Constructions yet. If you bought a home from them, your review helps other buyers.

How reviews work: only buyers and owners can review; we confirm each purchase by phone before publishing, publish positive and negative reviews alike, never accept payment for reviews, and the builder may reply.

Similar projects within 5 km

ProjectDistanceHomesPossession (RERA)BuiltComplaintsPrice
Klassik ExoticaKlassik Enterprises Private Limited0.6 km117Mar 202785%0Not collected
Green BoulevardTwenty First Castle Developers LLP0.8 km336Mar 202788%0Not collected
Earthen AmbienceEvantha Sri Durga Constructions0.9 km52Dec 2026100%1Not collected
Jankal Stellar HeightsJankal Sankalpa Ventures1 km150Feb 203015%0Not collected
LS SakuraLiving Structures1.3 km132Dec 203060%0Not collected
RRL PalacioRRL Builders And Developers Private Limited1.5 km103Dec 2026100%0Not collected

Projects of the same kind within 5 km in a straight line of this project’s RERA map point, nearest first. % built is the promoter’s latest quarterly figure on RERA (shown for single-registration projects); prices are from the builder’s own website where we found one.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Sources and last checked dates

  1. Karnataka RERA — project register (search by the registration number) (opens in a new tab)

Collected on 13 Oct 2026 by AI research agents reading public pages. Facts are written in our own words. Not found yet: price; court cases; landmarks; specifications; news.

How to check on RERA: On rera.karnataka.gov.in/viewAllProjects, type the registration number in 'Registration No', press Search, then click the 'View Project Details' icon. Complaints open from the 'Complaints / Litigation' icon in the same row. Registration number: PRM/KA/RERA/1251/308/PR/200526/003414.

  • RERA record last checked: 13 Oct 2026
  • Last change in the record (registration, quarterly filing or complaint): 31 Mar 2026

How this page is made: software builds it from public records (Karnataka RERA filings, OpenStreetMap, the builder’s own website). AI is used only to read filings into fields and to write the plain-English summary and FAQ answers, which are checked against the record. Facts are checked automatically against the RERA filing. Methodology · How we earn · Report an error
