Skav Madhura
2 & 3 BHK mixed-use project by Teamview Developers LLP · Vajarahalli, Kanakapura Road, Bengaluru
Vajarahalli, Kanakapura Road, BengaluruOpen on Google Maps (opens in a new tab)
- Under construction
- RERA registered
- mixed
Price: Price on request

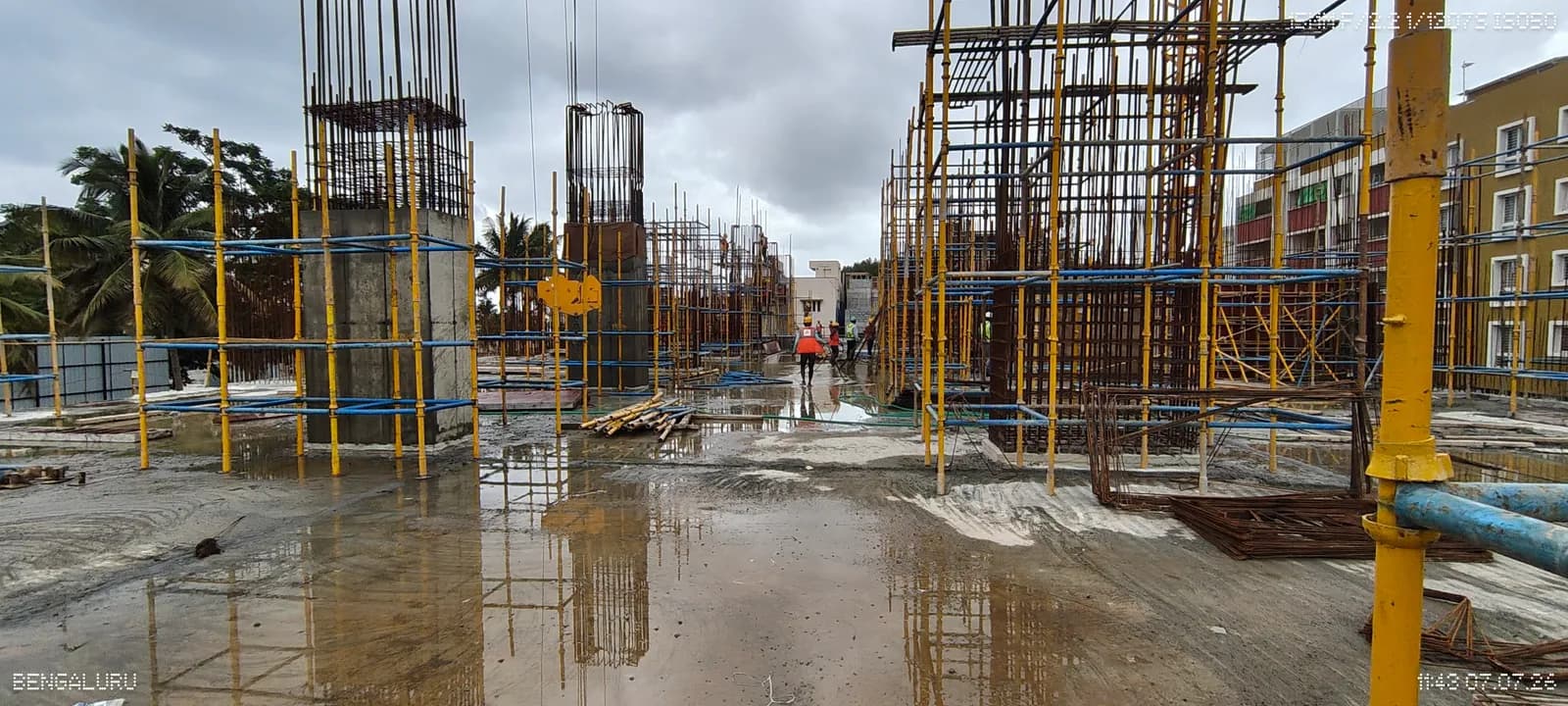

Site photo filed with Karnataka RERA Karnataka RERA filing · Source ↗ (opens in a new tab)
Skav Madhura at a glance
- Possession (RERA)Feb 2031Karnataka RERA
- Construction10% built · on pace for Dec 2040 118 mo after RERA dateRERA filing to 30 Sep 2026; estimate from average pace
- Homes booked27 of 111 (24%)RERA update · as on 30 Sep 2026
- RERA complaints (project)None listedKarnataka RERA · as on 16 Oct 2026
- Approvals filed8 of 9 on RERAKarnataka RERA uploads · 16 Oct 2026
- Nearest metroThalaghattapura · 0.22 kmstraight line · OpenStreetMap, 5 Oct 2026
- Airport driveapprox. 164 min at peak40.58 km straight line · estimate
- Nearest lakeBaiyannakunte Lake · 695 mFrom the RERA map point · OpenStreetMap, 5 Oct 2026
Project summary
Skav Madhura is a mixed-use project by Teamview Developers LLP in Vajarahalli, Bengaluru with 111 homes, registered with Karnataka RERA. The completion date on RERA is 28 Feb 2031.
Facts collected on 16 Oct 2026 from public records — each linked to its source. Free for buyers. If you book through us, the builder pays us a commission.
Skav Madhura buyers’ group: join to ask for a group price
No one has joined yet. Be one of the first 10 buyers in this group — the founding members.
Join free. When enough buyers have joined, our agent partner asks Teamview Developers LLP for a group price — for example a lower price, an easier payment plan or waived charges. Nothing is promised: you see what the builder offers and book directly with the builder if you want to. Free for buyers. If you book through us, the builder pays us a commission.
- Gathering buyers
- Talking to the builder
- Group offer
- Group site visit
- Booking
0 buyers have joined · 0 committed
Committed buyers have confirmed their budget, home type and timeline with us on a call; builders negotiate with them. Joining is free and never obliges you to buy.
Join the Skav Madhura buyers’ groupHow group buying works
See it for yourself
Visit the site with our team, or get a call to clear your questions. Free, no obligation.
Key facts: home types, towers, land and possession
- Home types
- 2 BHK, 2.5 BHK, 3 BHK, 3.5 BHK
- Carpet area
- 756 – 14,714 sq ft
- Towers
- 1
- Floors
- 11
- Total homes
- 111
- Land
- 1.09 acres
- Possession (RERA)
- Feb 2031
- Built (RERA update)
- 10%
Skav Madhura RERA number and registration details
- RERA number
- PRM/KA/RERA/1251/310/PR/130625/007825
- Registered on
- 13 Jun 2025
- Promised completion
- 28 Feb 2031
- Extended to
- No extension recorded
- RERA status
- New launch
- Homes booked
- 27 of 111 as on
- Price
- Not found in public records yet: price
- Project type
- Mixed
Towers and blocks (RERA filing)
| Tower | Floors | Basements | Homes |
|---|---|---|---|
| SKAV MADHURA | 11 | 1 | 111 |
A dash (—) means the filing did not state that value.
Summary in plain English
Skav Madhura is a mixed-use project by Teamview Developers LLP in Vajarahalli, Bengaluru South, with 111 homes across 1 tower of 11 floors and 2 commercial units. The project is registered with Karnataka RERA as a New Project Launch and is scheduled for completion on 28 February 2031.
Written by AI from the RERA record above on 16 Oct 2026. Every number in it was checked against that record; if anything differs, the record wins.
Open space, home loans, escrow and other details
- Open space
- 71.8% of land
- Water and power
- Water source filed with RERA: BoreWell,BWSSB
- Home loans: approved banks
- Not found in public records yet: bank approvals
- Payment plans
- Not found in public records yet: payment plans
- Maintenance
- Not found in public records yet: maintenance
- Car parking
- Not found in public records yet: car parking charge
- Escrow bank (RERA)
- STATE BANK OF INDIA, SME BR Kumara Park Bengaluru
- Building plan (RERA)
- BBMP - Bruhat Bengaluru Mahanagara Palike · No. PRJ/2700/2024-25 · dated 14 Feb 2025
- Project cost declared to RERA
- ₹138 Cr
Open area as a share of the land, from the areas filed with RERA (includes driveways and landscaped areas).
Amenities
- Electricity
- Club House
- Swimming Pool
- Power Backup
- Water and Sanitation
- Organic Waste Converter
- Fire Pump Room
Amenities and internal works as filed by the promoter with Karnataka RERA; we have not visited the site.
Skav Madhura location and address
- Address
- PID No. 497/301/802/61/2/61/3, Ward No: 198, HAMMIGEPURA, KANAKAPURA MAIN ROAD , NEAR THALAGHATTAPURA METRO STATION, VAJARAHALLI VILLAGE, KENGERI HOBLI , Bengaluru South , Bengaluru Urban, Karnataka - 560062
- Village (RERA)
- Vajarahalli
- Locality
- Kanakapura RoadAlso known as Kanakapura Main Road
- PIN code
- 560062
- City
- Bengaluru
- State
- Karnataka
- Coordinates
- 12.87320, 77.53921
Distances to landmarks
Not found in public records yet: landmarksAbout Kanakapura Road
Not found in public records yet: locality factsCommute times to tech parks and the airport
| To | Straight line | Peak-hour drive (estimate) |
|---|---|---|
| KSR Bengaluru City railway station (Majestic)Map point on OpenStreetMap (opens in a new tab) | 12.13 km | approx. 49 min |
| Electronic City Phase 1Map point on OpenStreetMap (opens in a new tab) | 13.88 km | approx. 56 min |
| Outer Ring Road tech corridor (RMZ Ecospace, Bellandur)Map point on OpenStreetMap (opens in a new tab) | 16.39 km | approx. 66 min |
| Manyata Tech ParkMap point on OpenStreetMap (opens in a new tab) | 21.33 km | approx. 86 min |
| ITPL, Whitefield (main gate)Map point on OpenStreetMap (opens in a new tab) | 25 km | approx. 101 min |
| Kempegowda International AirportMap point on OpenStreetMap (opens in a new tab) | 40.58 km | approx. 164 min |
How we calculate
Straight line: from the project’s map point on RERA to the destination’s point on OpenStreetMap.
Peak-hour drive is a rough estimate, not a route: straight line × 1.35 for the road network, at 20 km/h. Real times vary a lot with the route and the hour.
Sources:Source (openstreetmap.org) (opens in a new tab)How we calculate this
Schools and hospitals nearby
Within 2 km
- 15Schools and colleges12 schools, 3 colleges, 0 kindergartens
- 9Hospitals and clinics4 hospitals, 5 clinics
Nearest schools and colleges
- Chethana Public School · 0.46 km
- Deeksha · 0.71 km
- KS Institute of Technology · 0.89 km
Nearest hospitals and clinics
- Apollo Clinic · 0.15 km
- GS Family Clinic · 0.46 km
- Zymus Hospitals · 0.86 km
Places as mapped on OpenStreetMap (amenity=school, college, kindergarten, university; hospital, clinic), counted within 2 km in a straight line of the RERA map point. Volunteers map these, so some places may be missing or closed. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Nearest metro station and railway
- Thalaghattapura (ತಲಘಟ್ಟಪುರ)Open now — nearest operating metro station0.22 km
- Jnanabharati (ಜ್ಞಾನಭಾರತಿ)Nearest railway station7.53 km
Straight-line distances from the RERA map point to the station points mapped on OpenStreetMap; status (open or under construction) as tagged there. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Lake and lake-buffer check
The nearest mapped lake is Baiyannakunte Lake, 695 m from the project’s RERA map point.
The site boundary is not published as a shape, so its nearest edge can be closer than this point. Whether any building sits inside a lake buffer can only be checked on the approved plan.
- Baiyannakunte Lake on OpenStreetMap (opens in a new tab) 695 m
- Gubbalala Kere on OpenStreetMap (opens in a new tab) (ಗುಬ್ಬಲಾಲ ಕೆರೆ)776 m
- Thalaghattapura Lake on OpenStreetMap (opens in a new tab) (ತಲಘಟ್ಟಪುರ ಕೆರೆ)953 m
The buffer rule
Bengaluru’s lake buffer rule has changed over time: the National Green Tribunal ordered a 75 m buffer in May 2016; the Supreme Court set that order aside on 5 March 2019, leaving the 30 m buffer of the Revised Master Plan 2015. Check the current rule and the approved plan before relying on either number.
- LiveLaw: SC sets aside NGT order enlarging buffer zones (2019) (livelaw.in) (opens in a new tab)
- Citizen Matters: Shrinking lake buffers (citizenmatters.in) (opens in a new tab)
Shortest distance from the RERA map point to the mapped water edge (OpenStreetMap water polygons tagged lake or reservoir, or named lake/kere/tank). Mapped shorelines can differ from the revenue-record boundary of a lake. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Sources:Source (openstreetmap.org) (opens in a new tab)Source (livelaw.in) (opens in a new tab)Source (citizenmatters.in) (opens in a new tab)How we calculate this
Satellite time-lapse of the site
Satellite photos load when you scroll to them.
Photos from Esri World Imagery Wayback, centred on the project’s map point; dates are the capture dates in Esri’s metadata. Loaded from Esri when you scroll here.
Sources:Source (livingatlas.arcgis.com) (opens in a new tab)
Skav Madhura home types and carpet areas
Documents the builder uploaded to Karnataka RERA, shown as filed. Tap a page to see it full size; the full PDF opens on the RERA website.

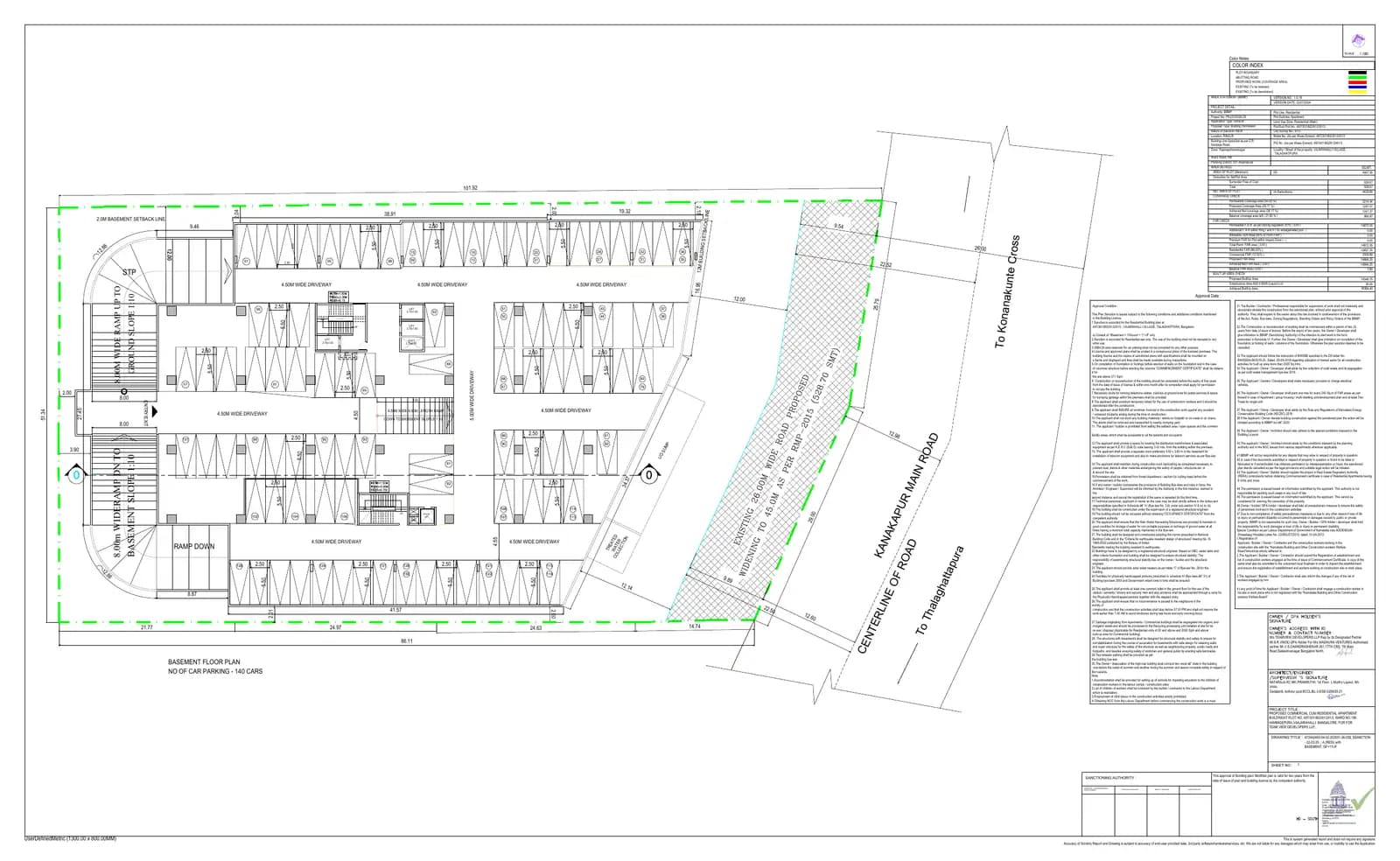

Approved building plan3 files

Approved Building PlanFull PDF on RERA
Approved Building Plan PRJ_2700_24-25Filed 1 Apr 2025 · Full PDF on RERA
Approved Building Plan PRJ_2700_24-25Filed 7 May 2025 · Full PDF on RERA

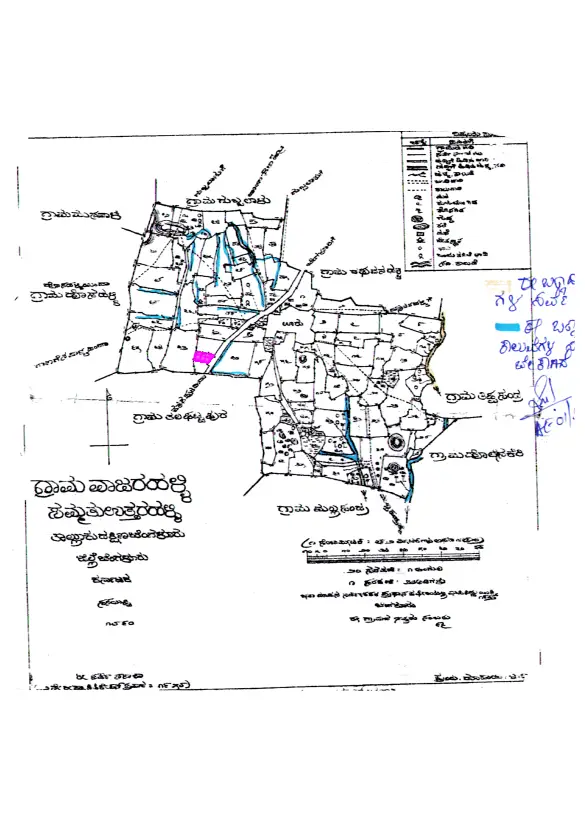

Approved layout plan2 files

Village Map DemarcationFiled 1 Apr 2025 · Full PDF on RERA
Village Map DemarcationFiled 7 May 2025 · Full PDF on RERA
Floor plans and brochure not published? The builder shares them only on request. We’ll get the brochure, floor plans and current price list for you, free.
Get brochure, floor plans & price| Home type | Carpet area | Homes |
|---|---|---|
| 2 BHK | 756 – 860 sq ft | 43 |
| 2.5 BHK | 905 – 1,468 sq ft | 35 |
| 3 BHK | 1,055 – 1,945 sq ft | 20 |
| 3.5 BHK | 1,214 – 1,778 sq ft | 11 |
| Commercial | 14,714 sq ft | 2 |
| Commercial units | 14,714 sq ft | 2 |
| Residential apartment | 983 sq ft | 109 |
Home types, counts and carpet areas as filed with Karnataka RERA (carpet area, not super built-up).
We have not collected floor-plan drawings; the builder’s sales team can share them.

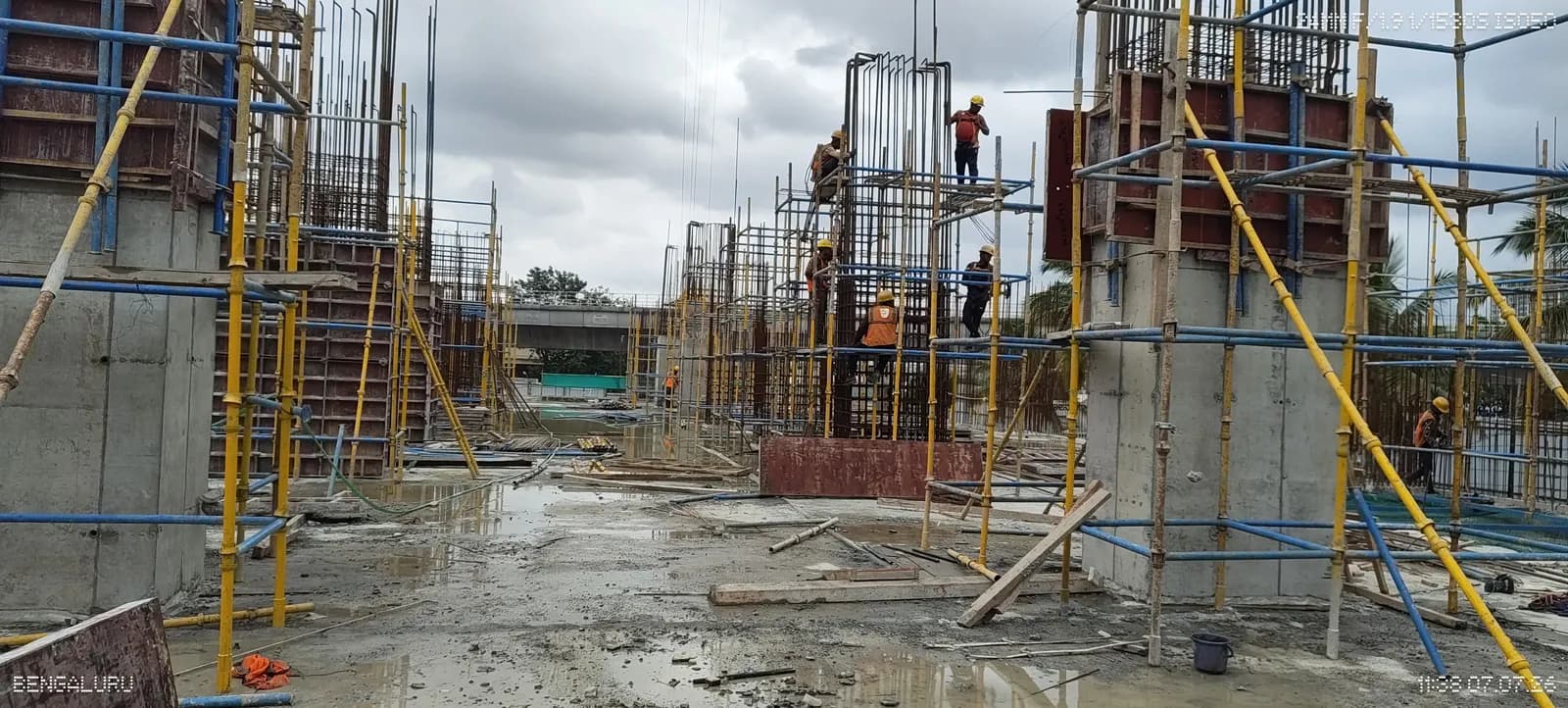

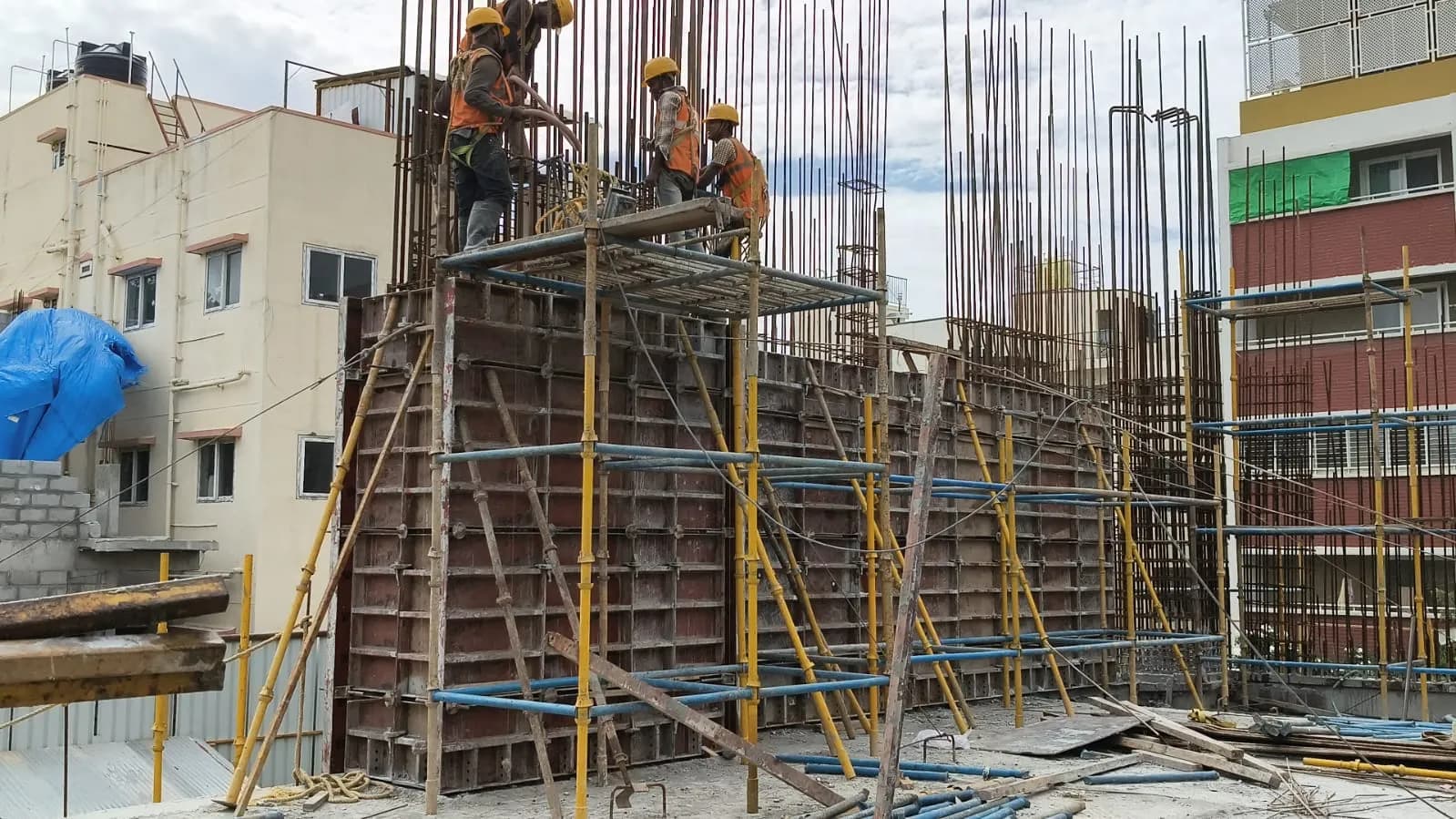

Skav Madhura possession date and construction status
Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-15.
Units sold and unsold, from RERA (Q2 2026-27)
| Type | Homes | Booked | Available |
|---|---|---|---|
| 2 BHK | 43 | 9 | 34 |
| 2.5 BHK | 35 | 10 | 25 |
| 3 BHK | 20 | 5 | 15 |
| 3.5 BHK | 11 | 3 | 8 |
| COMMERCIAL | 2 | 0 | 2 |
As reported by the promoter in the quarterly update to RERA, not verified by us.
Timeline
- 1 Mar 2025Project start date given to RERA
- 13 Jun 2025Registered with Karnataka RERA
- 28 Feb 2031Completion date given at registration
Construction pace from RERA quarterly filings
At the average pace so far, construction would reach 100% around Dec 2040 — about 118 months after the completion date on RERA (28 Feb 2031).
At the pace between the 4 quarterly filings we have (3% → 10% in 9 months), it would be around May 2036 — about 62 months after the RERA date.
- Filed on RERA
- Average pace since start
- Pace between filings (and 0% assumed at the start date)
- RERA completion date
Quarterly filings
| Quarter | Filed on | Built | Homes booked |
|---|---|---|---|
| Q2 2026-27to 30 Sep 2026 | 15 Oct 2026 | 10% | 27 of 111 |
| Q1 2026-27to 30 Jun 2026 | 8 Jul 2026 | 8% | 24 of 111 |
| Q4 2025-26to 31 Mar 2026 | 15 May 2026 | 5% | 20 of 111 |
| Q3 2025-26to 31 Dec 2025 | 22 Jan 2026 | 3% | 14 of 111 |
How we calculate
Average pace = % built ÷ months since the start date in the RERA record. Here: 10% ÷ 19 months (1 Mar 2025 to 30 Sep 2026) = 0.5% a month.
Estimated finish = latest filing date + (100 − % built) ÷ pace = 30 Sep 2026 + 90 ÷ 0.5 = 170.9 months → Dec 2040. This is an estimate, not a date from the builder or RERA.
Pace between filings = (10% − 3%) ÷ 9 months = 0.8% a month.
A straight line is a simplification: the builder reports one overall %, which mixes excavation, structure and finishing, and work rarely moves at a constant speed. The % values are the promoter’s own figures filed with RERA, not checked by us. Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-15.
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
Approvals and documents checklist
| Approval | Authority | Source |
|---|---|---|
| Building plan | BBMP - Bruhat Bengaluru Mahanagara Palike · No. PRJ/2700/2024-25 · dated 2025-02-14 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Land conversion (2 orders) | Deputy Commissioner, Bengaluru District · No. ALN(SU)(K)SR/22/2019-20 and 1 more · dated 2019-11-06 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Commencement Certificate | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Building Plan | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| ESCOM/Electricity | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KWSSB/Water | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KSPCB | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| SEIAA | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Fire Force Department | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Airport Authority of India | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
Documents uploaded to RERA
- Building or layout plan · Approved drawings from the planning authorityFiled on RERA ✓ — BBMP - Bruhat Bengaluru Mahanagara Palike · No. PRJ/2700/2024-25 · dated 14 Feb 2025
- Commencement certificate · Permission to start buildingFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Environment clearance · SEIAA KarnatakaFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Fire NOC · Karnataka Fire and Emergency ServicesFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Pollution board consent · KSPCBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Water and sewerage · BWSSBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Electricity · BESCOMFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Height clearance · Airports Authority of IndiaFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Occupancy certificate (OC) · Issued only when the building is finishedNot on RERA yet — expected at completion
From the documents the promoter uploaded to Karnataka RERA, collected 16 Oct 2026. “Filed” means a document is on RERA — we have not checked its contents or validity. Not every approval applies to every project (for example, smaller projects may not need an environment clearance). The project page on RERA lists each upload.
Skav Madhura RERA complaints
No complaints listed on Karnataka RERA for this registration as on Source (rera.karnataka.gov.in) (opens in a new tab)
Court and consumer cases
We list case numbers, courts and outcomes only — never names of private individuals.
About Teamview Developers LLP
- Promoter type
- Partnership Firm
- Projects on this site
- 1
- RERA complaints against promoter
- 0
- Company number (CIN)
- AAD-1514
From Karnataka RERA, as collected so far (16 Oct 2026). Complaints are those RERA lists against this promoter across all its projects.
Teamview Developers LLP’s RERA recordTeamview Developers LLP delivery record
- 1Projects in Bengaluru on RERA1 approved registration under Teamview Developers LLP in Bengaluru Urban and Rural. Source (rera.karnataka.gov.in) (opens in a new tab)
- 111Homes registeredAs stated in each registrations.
- 0RERA complaintsas on Source (rera.karnataka.gov.in) (opens in a new tab)
- 0Complaints per 1,000 homes0 complaints ÷ 111 homes in its 1 registration on Karnataka RERA in Bengaluru.
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
What’s changed since Feb 2025
- 15 Oct 2026Quarterly update filed for Q2 2026-27: 10% built, 27 of 111 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 8 Jul 2026Quarterly update filed for Q1 2026-27: 8% built, 24 of 111 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 15 May 2026Quarterly update filed for Q4 2025-26: 5% built, 20 of 111 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 22 Jan 2026Quarterly update filed for Q3 2025-26: 3% built, 14 of 111 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 13 Jun 2025Registered with Karnataka RERA (PRM/KA/RERA/1251/310/PR/130625/007825); completion date 28 Feb 2031 Source (rera.karnataka.gov.in) (opens in a new tab)
- 1 Mar 2025Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
- 14 Feb 2025Building plan approved by BBMP - Bruhat Bengaluru Mahanagara Palike (No. PRJ/2700/2024-25) Source (rera.karnataka.gov.in) (opens in a new tab)
Newest first. No extension of the completion date is recorded on RERA. When the RERA crawl sees a new filing, complaint or extension, it is added here with its date.
Home loan EMI calculator
- Monthly EMI
- —
- Down payment
- —
- Loan amount
- —
- Total interest
- —
A calculation only, from the numbers you enter — not a loan offer.
All-in cost: GST, registration and other charges
The calculator loads when you scroll to it.
Assumptions
- Base price: the builder’s price is not published in a form we could collect — enter it from the cost sheet.
- GST 5% on the base price and charges — the usual rate for an under-construction home that is not “affordable housing” (1%).
- Stamp duty about 5.6% and registration 2% — the Karnataka rule (registration was raised from 1% to 2% on 31 Aug 2025). Calculated on the agreement value.
- Car parking, other charges and the maintenance deposit are not in the public record we collect; enter them from the builder’s cost sheet.
- Loan on the agreement value (banks usually lend up to 75–90%); EMI is the standard reducing-balance formula. Example rate only — use your bank’s quote.
Skav Madhura FAQs
What is Skav Madhura?
Skav Madhura is a mixed-use residential and commercial project by Teamview Developers LLP located in Vajarahalli, Bengaluru South, PIN 560062.
How many homes are in Skav Madhura?
The project has 111 homes: 35 two-point-five BHK, 43 two BHK, 20 three BHK, and 11 three-point-five BHK apartments, plus 2 commercial units.
What are the carpet areas in Skav Madhura?
Carpet areas range from 756 sq ft (2 BHK) to 1,945 sq ft (3 BHK), with 2.5 BHK units from 905 to 1,468 sq ft and 3.5 BHK units from 1,214 to 1,778 sq ft. Commercial units are 14,714 sq ft each.
When will Skav Madhura be completed?
The project is scheduled for completion on 28 February 2031, as per the RERA registration.
What is the RERA registration number for Skav Madhura?
The RERA registration number is PRM/KA/RERA/1251/310/PR/130625/007825, registered on 13 June 2025.
How much of Skav Madhura is built?
As of the quarter ending 30 September 2026, construction is 10 percent complete.
How many homes are booked in Skav Madhura?
As of the quarter ending 30 September 2026, 27 homes have been booked out of 111 homes in the project.
Are there any RERA complaints on Skav Madhura?
There are no RERA complaints on this project.
What other projects does Teamview Developers LLP have?
Teamview Developers LLP has 2 projects in the Karnataka RERA Bengaluru records, including Skav Madhura.
Are there any complaints against Teamview Developers LLP?
There are no RERA complaints against Teamview Developers LLP across any of their projects on record.
Written by AI from the RERA record above on 16 Oct 2026. Answers use only that record; check them against the source before you decide.
Questions about Skav Madhura
No questions published yet. Ask the first one: you get an instant answer from this page’s public record, and our team follows up on anything the record does not show.
Bought a home from Teamview Developers LLP? Review the builder.
Reviews of Teamview Developers LLP by verified buyers
No verified reviews of Teamview Developers LLP yet. If you bought a home from them, your review helps other buyers.
How reviews work: only buyers and owners can review; we confirm each purchase by phone before publishing, publish positive and negative reviews alike, never accept payment for reviews, and the builder may reply.
Similar projects within 5 km
| Project | Distance | Homes | Possession (RERA) | Built | Complaints | Price |
|---|---|---|---|---|---|---|
| Shivaganga Sai RakshaShivaganga Built Tech | 1.4 km | 130 | Mar 2026 | 87% | 0 | Not collected |
| Platinum LandmarkSai Properties | 3.8 km | 103 | Dec 2027 | 38% | 0 | Not collected |
| Mamtha Paradisemamtha dream works private limited | 4.5 km | 73 | Jun 2028 | 68% | 0 | Not collected |
Projects of the same kind within 5 km in a straight line of this project’s RERA map point, nearest first. % built is the promoter’s latest quarterly figure on RERA (shown for single-registration projects); prices are from the builder’s own website where we found one.
Sources and last checked dates
Collected on 16 Oct 2026 by AI research agents reading public pages. Facts are written in our own words. Not found yet: price; court cases; landmarks; specifications; news.
How to check on RERA: On rera.karnataka.gov.in/viewAllProjects, type the registration number in 'Registration No', press Search, then click the 'View Project Details' icon. Complaints open from the 'Complaints / Litigation' icon in the same row. Registration number: PRM/KA/RERA/1251/310/PR/130625/007825.
- RERA record last checked: 16 Oct 2026
- Last change in the record (registration, quarterly filing or complaint): 16 Oct 2026
How this page is made: software builds it from public records (Karnataka RERA filings, OpenStreetMap, the builder’s own website). AI is used only to read filings into fields and to write the plain-English summary and FAQ answers, which are checked against the record. Facts are checked automatically against the RERA filing. Methodology · How we earn · Report an error
More new projects in Kanakapura Road
Raghuvanahalli, Kanakapura RoadUnder constructionRERA registeredBuyers’ group openShivaganga Sai Raksha
by Shivaganga Built Tech
Price: Price on requestGet brochure & price →
- 2 BHK, 3 BHK
- 561 – 5,166 sq ft
- Mar 2026
RERA not updated since promised Mar 2026 · 130 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Shivaganga Sai Raksha
Kebathahalli, near Bannerghatta RoadUnder constructionRERA registeredBuyers’ group openPlatinum Landmark
by Sai Properties
Price: Price on requestGet brochure & price →
- 2 BHK, 3 BHK, 4 BHK
- 696 – 5,065 sq ft
- Dec 2027
103 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Platinum Landmark
Arehalli, UttarahalliUnder constructionRERA registeredBuyers’ group openMamtha Paradise
by mamtha dream works
Price: Price on requestGet brochure & price →
- 2 BHK, 3 BHK
- 693 – 3,920 sq ft
- Jun 2028
73 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Mamtha Paradise
