Trifecta Vanto
1, 2 & 3 BHK apartments by Trifecta Projects Private Limited · near Kodathi–Carmelaram, Bengaluru
Near Kodathi–Carmelaram, BengaluruOpen on Google Maps (opens in a new tab)
- Under construction
- RERA registered
- residential
by Trifecta Projects Private Limited
Price: Price on request

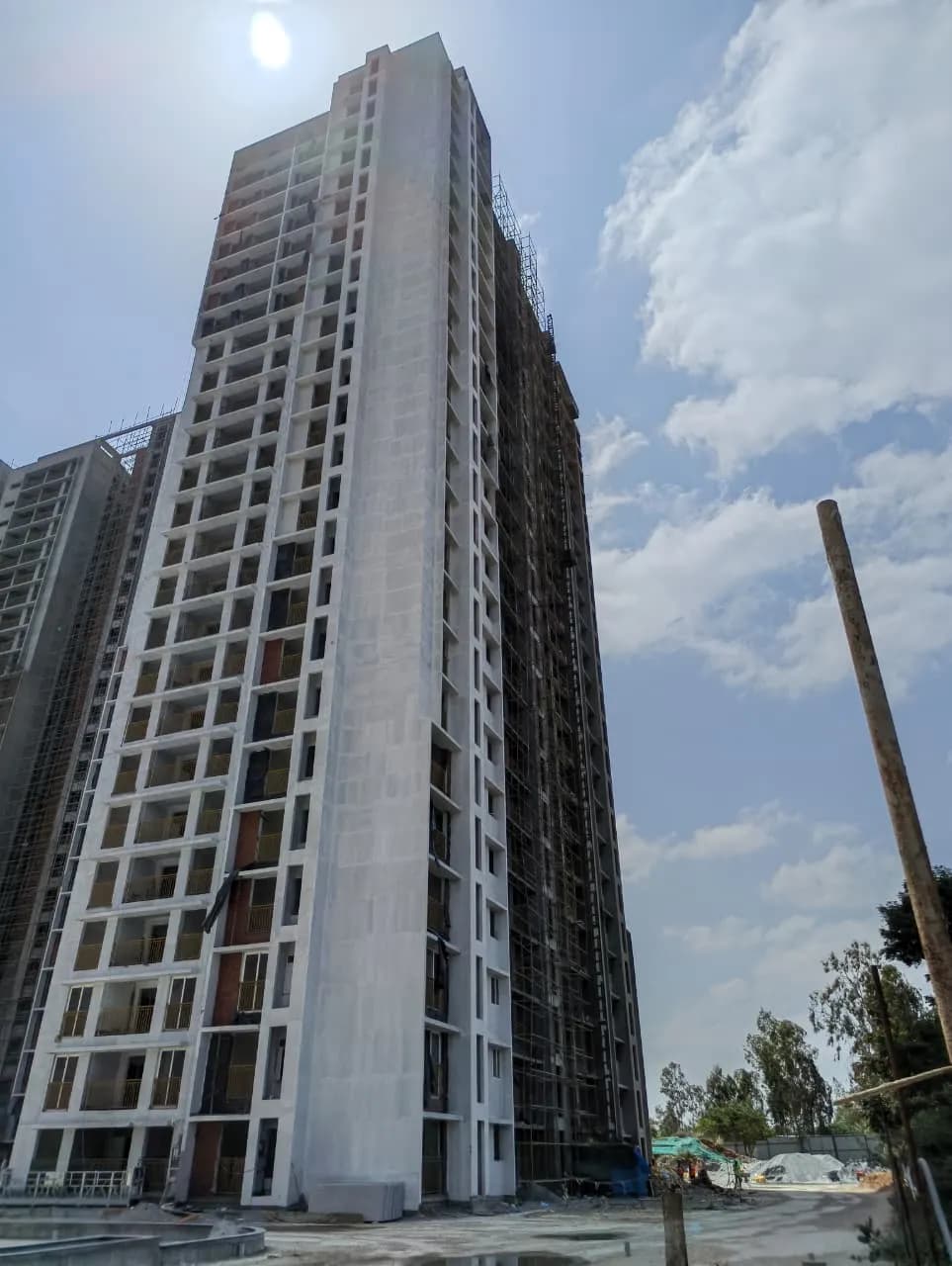

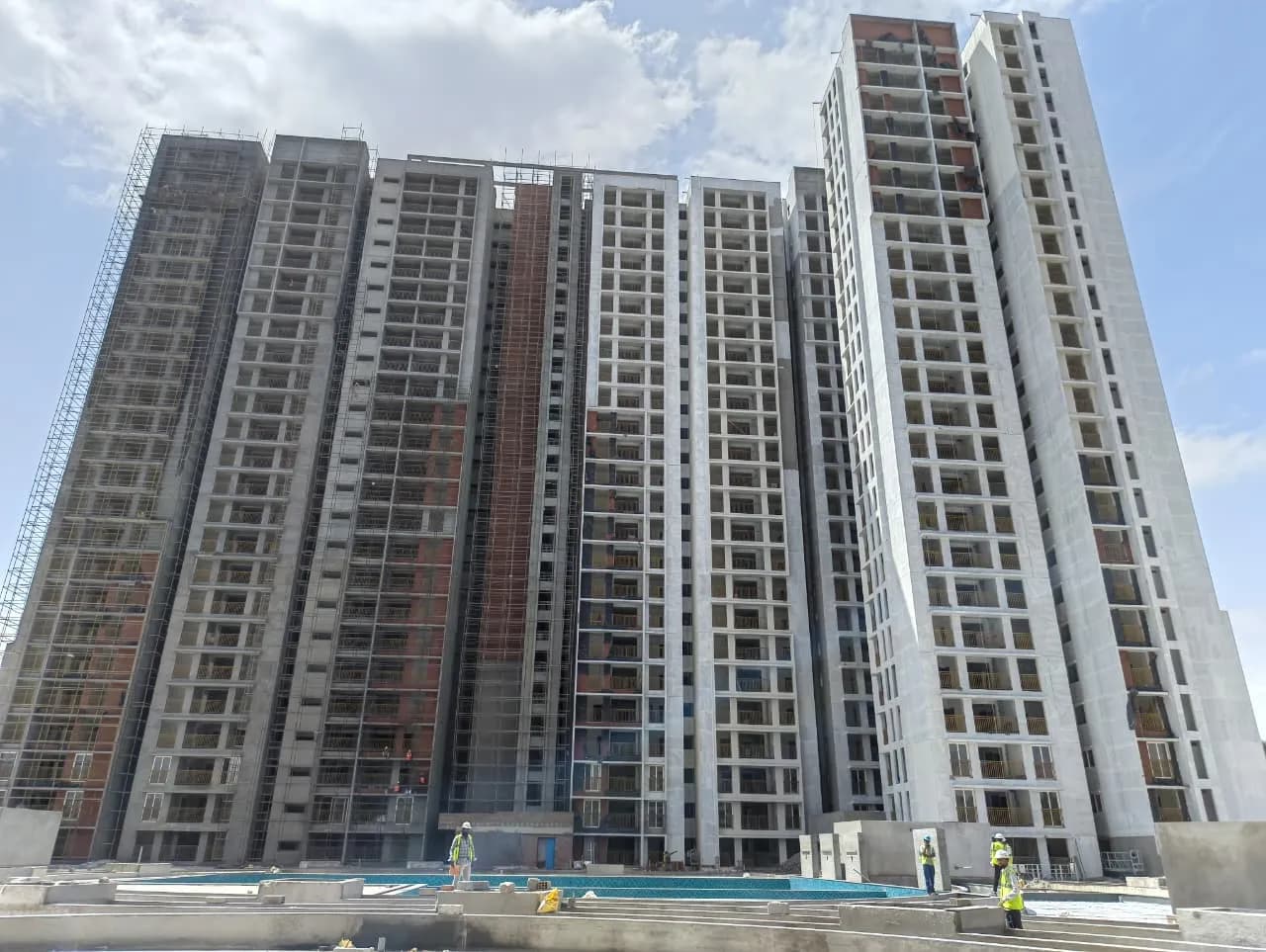

Site photo filed with Karnataka RERA Karnataka RERA filing · Source ↗ (opens in a new tab)
Trifecta Vanto at a glance
- Possession (RERA)Mar 2028Karnataka RERA
- Construction92% built · on pace for Dec 2026RERA filing to 30 Sep 2026 (Phase-1); estimate from average pace
- RERA complaints (project)None listedKarnataka RERA · as on 21 Oct 2026
- Approvals filed5 of 9 on RERAKarnataka RERA uploads · 21 Oct 2026
- Nearest metroInfosys Foundation Konappana Agrahara · 6.12 kmstraight line · OpenStreetMap, 5 Oct 2026
- Airport driveapprox. 144 min at peak35.6 km straight line · estimate
- Nearest lakeKodathi Kere · 996 mFrom the RERA map point · OpenStreetMap, 5 Oct 2026
Project summary
Trifecta Vanto is a residential project by Trifecta Projects Private Limited in Bengaluru with 1,027 homes, registered with Karnataka RERA. The completion date on RERA is 31 Mar 2028. It is registered in 2 phases.
Not in the RERA record we collected yet: locality. This page fills in as the record is collected.
Facts collected on 21 Oct 2026 from public records — each linked to its source. Free for buyers. If you book through us, the builder pays us a commission.
Trifecta Vanto buyers’ group: join to ask for a group price
No one has joined yet. Be one of the first 10 buyers in this group — the founding members.
Join free. When enough buyers have joined, our agent partner asks Trifecta Projects Private Limited for a group price — for example a lower price, an easier payment plan or waived charges. Nothing is promised: you see what the builder offers and book directly with the builder if you want to. Free for buyers. If you book through us, the builder pays us a commission.
- Gathering buyers
- Talking to the builder
- Group offer
- Group site visit
- Booking
0 buyers have joined · 0 committed
Committed buyers have confirmed their budget, home type and timeline with us on a call; builders negotiate with them. Joining is free and never obliges you to buy.
Join the Trifecta Vanto buyers’ groupHow group buying works
See it for yourself
Visit the site with our team, or get a call to clear your questions. Free, no obligation.
Key facts: home types, towers, land and possession
- Home types
- 1 BHK, 2 BHK, 2.5 BHK, 3 BHK
- Carpet area
- 440 – 1,195 sq ft
- Towers
- 3
- Floors
- 24
- Total homes
- 1,027
- Land
- 12.06 acres
- Possession (RERA)
- Mar 2028
- Built (RERA update)
- Not found in public records yet: construction progress
Trifecta Vanto RERA number and registration details
- RERA number
- PRM/KA/RERA/1251/446/PR/190424/006813
- Registered on
- 19 Apr 2024
- Promised completion
- 31 Mar 2028
- Extended to
- No extension recorded
- RERA status
- New launch
- Homes booked
- Not found in public records yet: homes booked
- Price
- Not found in public records yet: price
- Project type
- Residential
2 RERA registrations (one per phase) are shown together on this page; dates above are the latest across phases.
Phases and RERA numbers
| Phase | RERA number | Promised completion | Homes | Status | Source |
|---|---|---|---|---|---|
| Phase-1 | PRM/KA/RERA/1251/446/PR/190424/006813 | 31 Aug 2027 | 825 | New launch | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Phase-2 | PRM/KA/RERA/1251/310/PR/250625/007871 | 31 Mar 2028 | 202 | Under construction | Source (rera.karnataka.gov.in) (opens in a new tab) |
Towers and blocks (RERA filing)
| Tower | Phase | Floors | Basements | Homes |
|---|---|---|---|---|
| A | Phase-1 | 24 | 1 | 450 |
| B | Phase-1 | 24 | 1 | 375 |
| Tower C | Phase-2 | 24 | 1 | 202 |
A dash (—) means the filing did not state that value.
Summary in plain English
Trifecta Vanto is a residential project by Trifecta Projects Private Limited in Bengaluru East with 1,027 homes across 2 phases and 3 towers. Phase-1 has 825 homes completing on 31 August 2027, and Phase-2 has 202 homes completing on 31 March 2028.
Written by AI from the RERA record above on 21 Oct 2026. Every number in it was checked against that record; if anything differs, the record wins.
Open space, home loans, escrow and other details
- Open space
- Not found in public records yet: open space
- Water and power
- Water source filed with RERA: BWSSB
- Home loans: approved banks
- Not found in public records yet: bank approvals
- Payment plans
- Not found in public records yet: payment plans
- Maintenance
- Not found in public records yet: maintenance
- Car parking
- Not found in public records yet: car parking charge
- Escrow bank (RERA) · Phase-1
- Axis Bank, Mahadevapura Branch``
- Escrow bank (RERA) · Phase-2
- HDFC, Mahadevapura Branch
Amenities
- Electricity
- CCTV Surveillance
- Club House
- Community Hall
- Outdoor Sports facility
- Indoor Sports facility
- Swimming Pool
- Gym
- Parks
- Power Backup
- Water and Sanitation
- Air Conditioning
Amenities and internal works as filed by the promoter with Karnataka RERA; we have not visited the site.
Trifecta Vanto location and address
- Address
- Sy. No. 37/2,37/3,37/4,37/5,37/6,37/7P,37/8,37/9,37/10,37/11,37/12,37/13,37/14,37/15,37/16,37/17,37/18,37/19,37/20,43/4B and 43/5 , Bangalore Urban, , Bengaluru East , Bengaluru Urban, Karnataka - 560035
- Village (RERA)
- Not found in public records yet: village
- Locality
- Near Kodathi–CarmelaramAlso known as Kodathi, Carmelaram
- PIN code
- 560035
- City
- Bengaluru
- State
- Karnataka
- Coordinates
- 12.88076, 77.71538
Distances to landmarks
Not found in public records yet: landmarksAbout the locality
Not found in public records yet: locality factsCommute times to tech parks and the airport
| To | Straight line | Peak-hour drive (estimate) |
|---|---|---|
| Outer Ring Road tech corridor (RMZ Ecospace, Bellandur)Map point on OpenStreetMap (opens in a new tab) | 6.04 km | approx. 24 min |
| Electronic City Phase 1Map point on OpenStreetMap (opens in a new tab) | 6.47 km | approx. 26 min |
| ITPL, Whitefield (main gate)Map point on OpenStreetMap (opens in a new tab) | 12.13 km | approx. 49 min |
| KSR Bengaluru City railway station (Majestic)Map point on OpenStreetMap (opens in a new tab) | 19.16 km | approx. 78 min |
| Manyata Tech ParkMap point on OpenStreetMap (opens in a new tab) | 21.3 km | approx. 86 min |
| Kempegowda International AirportMap point on OpenStreetMap (opens in a new tab) | 35.6 km | approx. 144 min |
How we calculate
Straight line: from the project’s map point on RERA to the destination’s point on OpenStreetMap.
Peak-hour drive is a rough estimate, not a route: straight line × 1.35 for the road network, at 20 km/h. Real times vary a lot with the route and the hour.
Sources:Source (openstreetmap.org) (opens in a new tab)How we calculate this
Schools and hospitals nearby
Within 2 km
- 10Schools and colleges8 schools, 2 colleges, 0 kindergartens
- 1Hospitals and clinics0 hospitals, 1 clinics
Nearest schools and colleges
- Harvest International School · 0.72 km
- JAAGA Bootcamp · 1.07 km
- Delhi Public School Bangalore East · 1.12 km
Nearest hospitals and clinics
- Kodathi Primary Health Centre · 1.79 km
Places as mapped on OpenStreetMap (amenity=school, college, kindergarten, university; hospital, clinic), counted within 2 km in a straight line of the RERA map point. Volunteers map these, so some places may be missing or closed. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Nearest metro station and railway
- Infosys Foundation Konappana Agrahara (ಇನ್ಫೋಸಿಸ್ ಫೌಂಡೇಶನ್ ಕೊನಪ್ಪನ ಅಗ್ರಹಾರ)Open now — nearest operating metro station6.12 km
- Huskuru (ಹುಸ್ಕೂರ್)Nearest railway station2.38 km
Straight-line distances from the RERA map point to the station points mapped on OpenStreetMap; status (open or under construction) as tagged there. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Lake and lake-buffer check
The nearest mapped lake is Kodathi Kere, 996 m from the project’s RERA map point.
The site boundary is not published as a shape, so its nearest edge can be closer than this point. Whether any building sits inside a lake buffer can only be checked on the approved plan.
- Kodathi Kere on OpenStreetMap (opens in a new tab) 996 m
- Sulakunte Lake on OpenStreetMap (opens in a new tab) 1,420 m
- Huskur Lake on OpenStreetMap (opens in a new tab) (ಹುಸ್ಕೂರು ಕೆರೆ)1,582 m
The buffer rule
Bengaluru’s lake buffer rule has changed over time: the National Green Tribunal ordered a 75 m buffer in May 2016; the Supreme Court set that order aside on 5 March 2019, leaving the 30 m buffer of the Revised Master Plan 2015. Check the current rule and the approved plan before relying on either number.
- LiveLaw: SC sets aside NGT order enlarging buffer zones (2019) (livelaw.in) (opens in a new tab)
- Citizen Matters: Shrinking lake buffers (citizenmatters.in) (opens in a new tab)
Shortest distance from the RERA map point to the mapped water edge (OpenStreetMap water polygons tagged lake or reservoir, or named lake/kere/tank). Mapped shorelines can differ from the revenue-record boundary of a lake. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Sources:Source (openstreetmap.org) (opens in a new tab)Source (livelaw.in) (opens in a new tab)Source (citizenmatters.in) (opens in a new tab)How we calculate this
Satellite time-lapse of the site
Satellite photos load when you scroll to them.
Photos from Esri World Imagery Wayback, centred on the project’s map point; dates are the capture dates in Esri’s metadata. Loaded from Esri when you scroll here.
Sources:Source (livingatlas.arcgis.com) (opens in a new tab)
Trifecta Vanto floor plans, brochure and elevations
Documents the builder uploaded to Karnataka RERA, shown as filed. Tap a page to see it full size; the full PDF opens on the RERA website.
Floor plans6 files

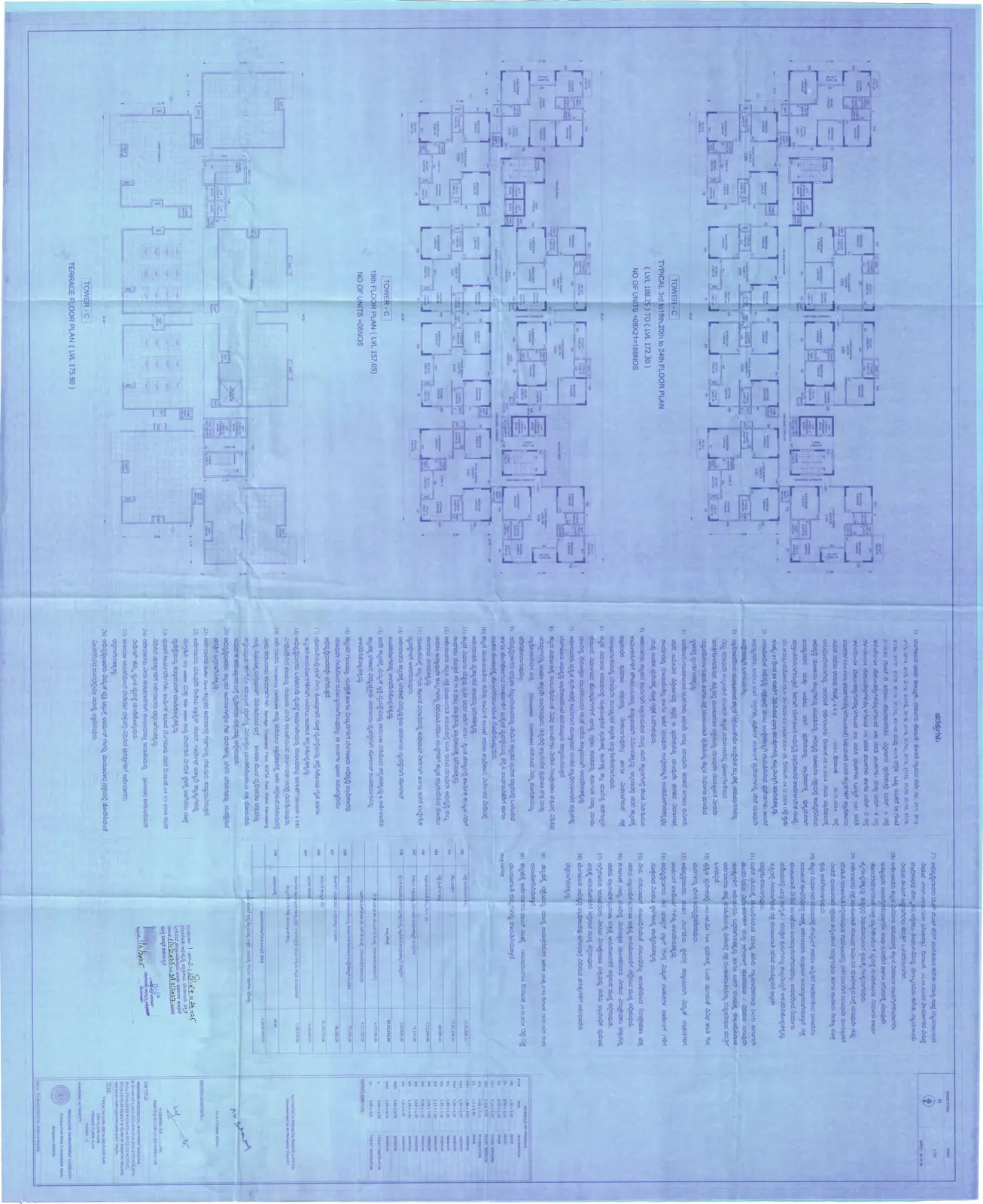

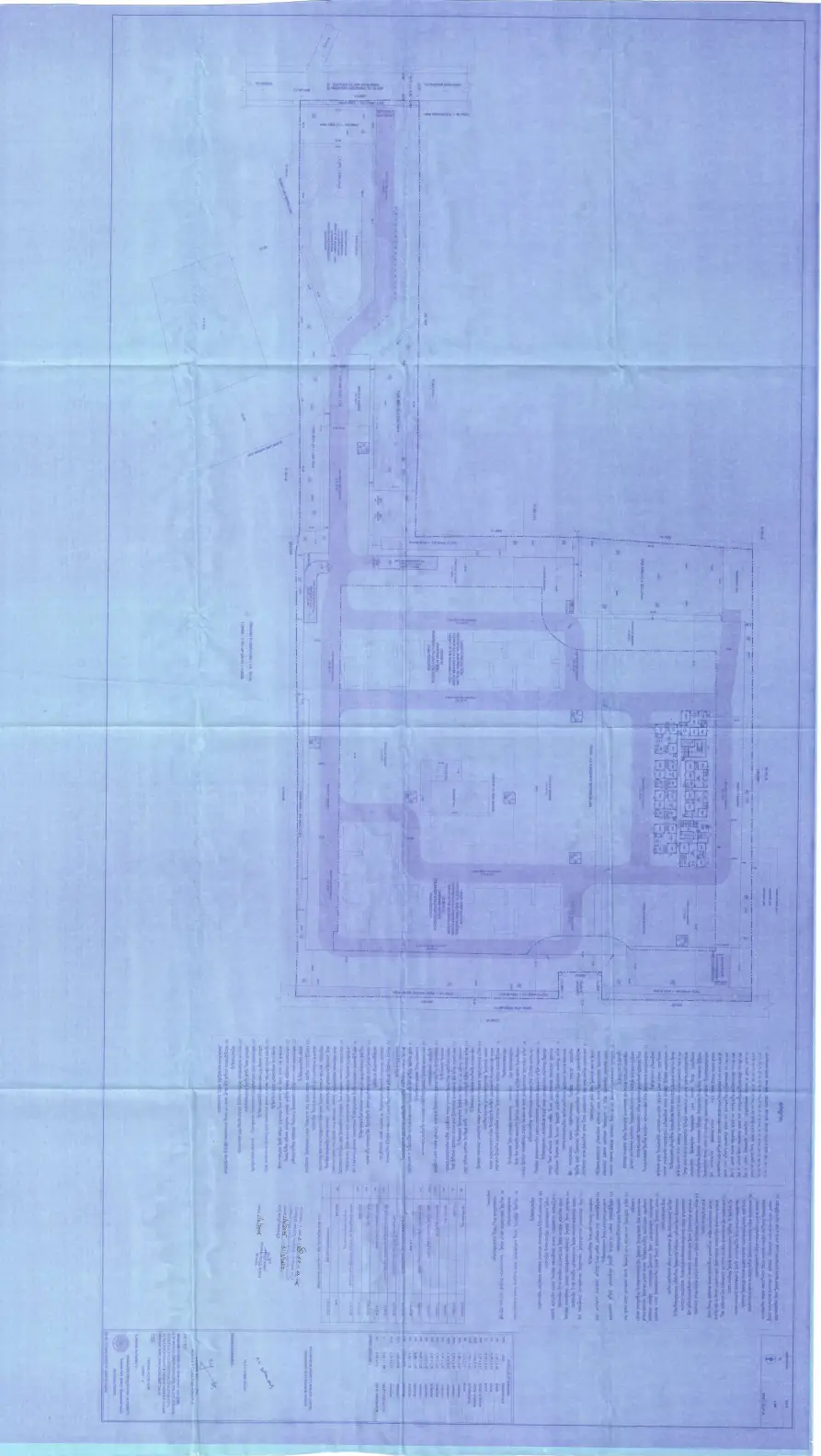

Phase-1: 6 Plan 3 to 18 & 20 to 24 Typical Floor.pdfFull PDF on RERA

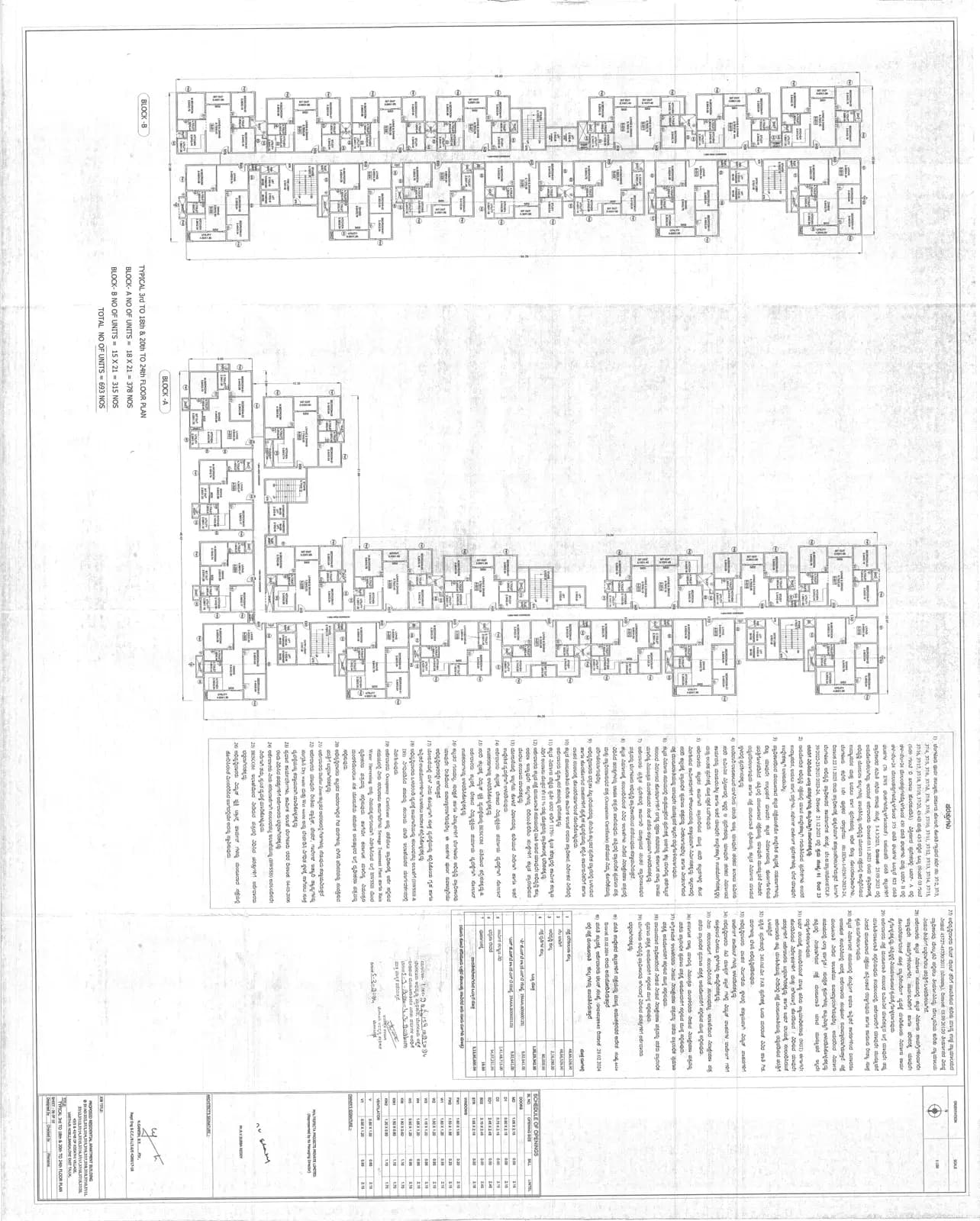

Phase-1: Plan 3 to 18 & 20 to 24 Typical FloorFiled 4 Apr 2024 · Full PDF on RERA

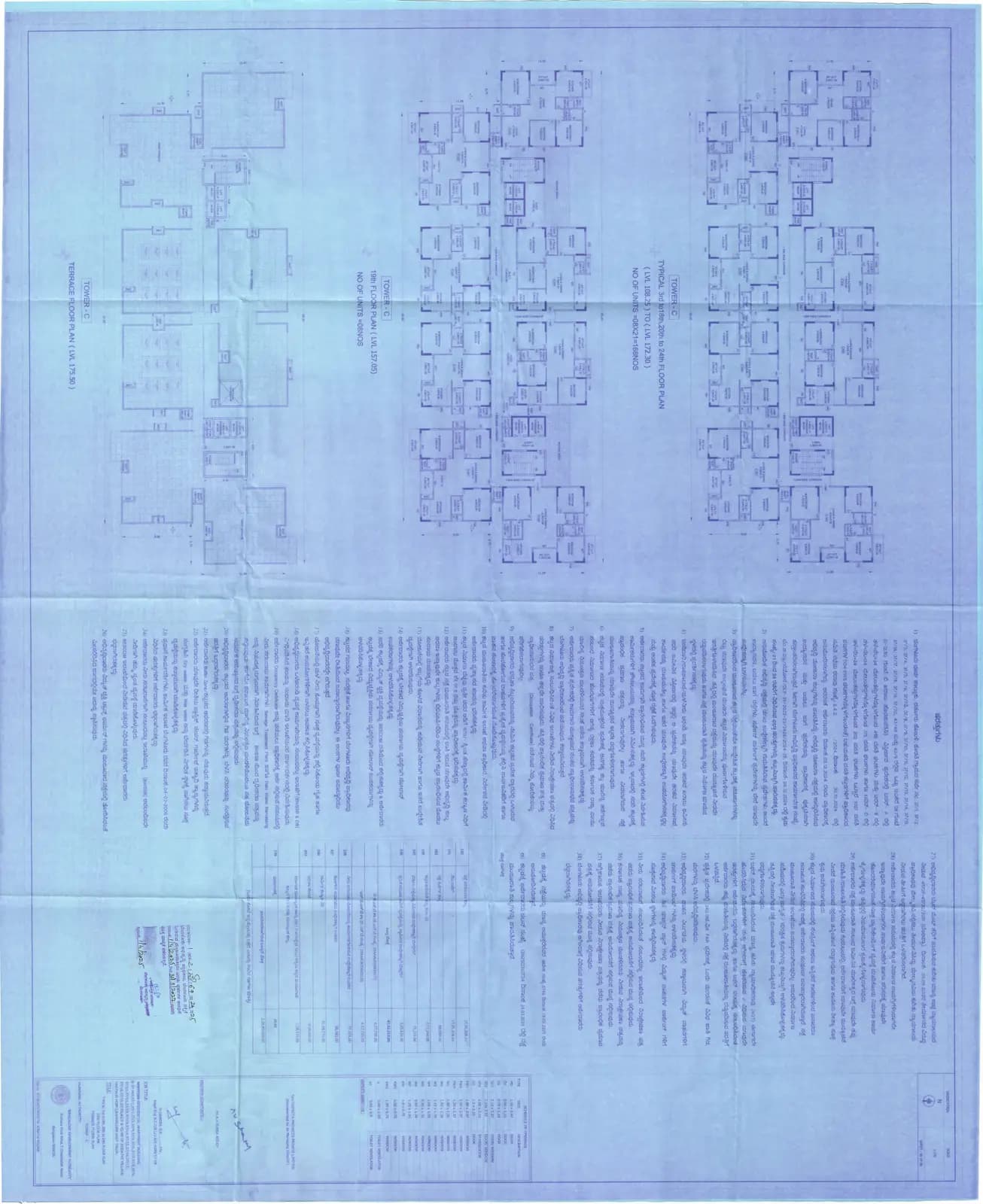

Phase-2: Plan Typical Floor Plan 3rd to 18th 19th Floor Terrace Floor Plan Topwer C_compressedFiled 29 May 2025 · Full PDF on RERA

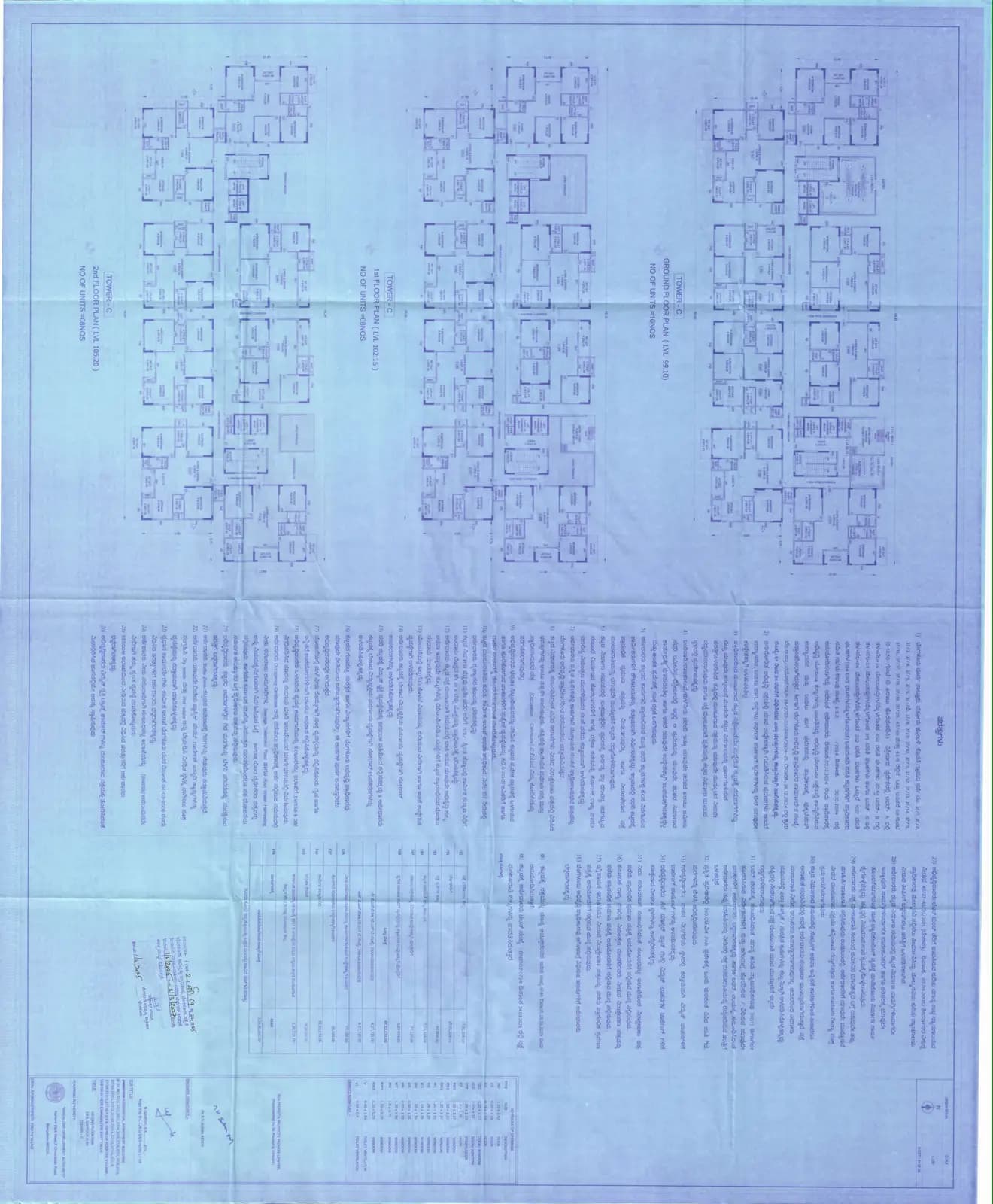

Phase-2: Plan Groun 1st 2nd Floor Plan Tower C_compressedFiled 29 May 2025 · Full PDF on RERA
Phase-2: Plan Ground Floor Plan Tower C_compressedFiled 29 May 2025 · Full PDF on RERA
Phase-2: Plan Basement floor Plan Tower A B C_compressedFiled 29 May 2025 · Full PDF on RERA
Elevations

Phase-1: 10 Plan Block A Elevation.pdfFull PDF on RERA
Approved building plan2 files

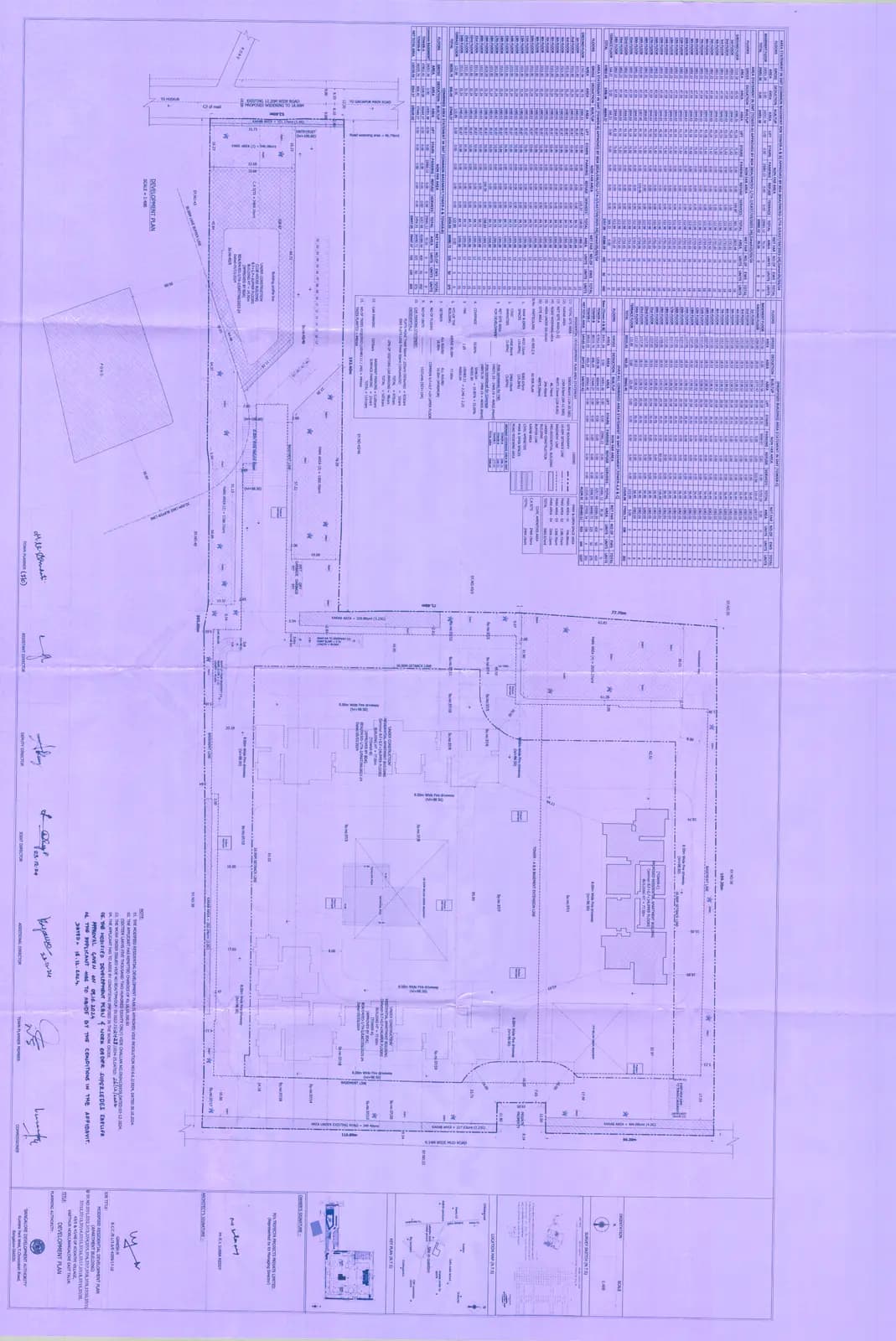

Phase-2: Approved Building PlanFull PDF on RERA

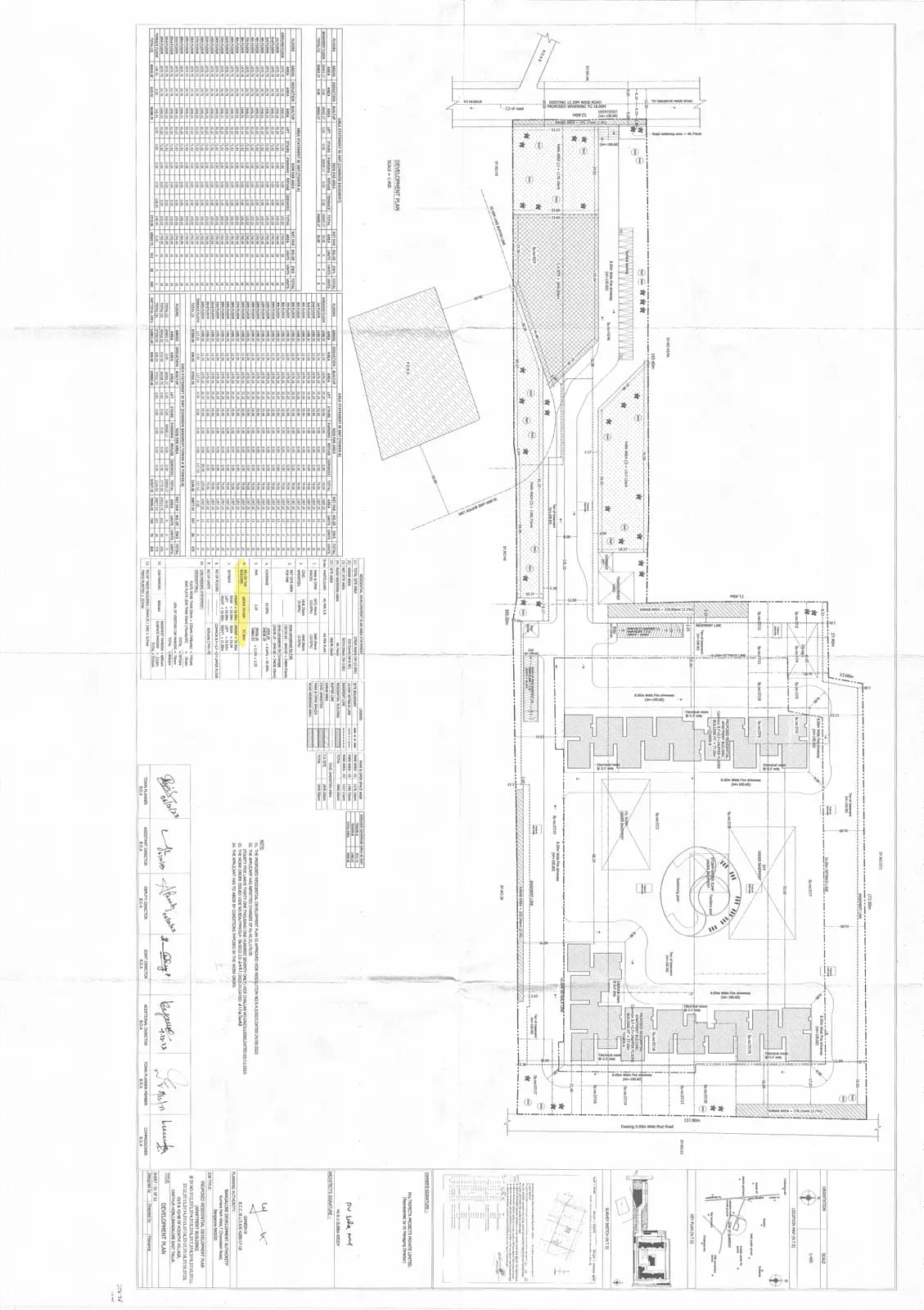

Phase-1: Approved PlanFiled 4 Apr 2024 · Full PDF on RERA
Approved layout plan2 files

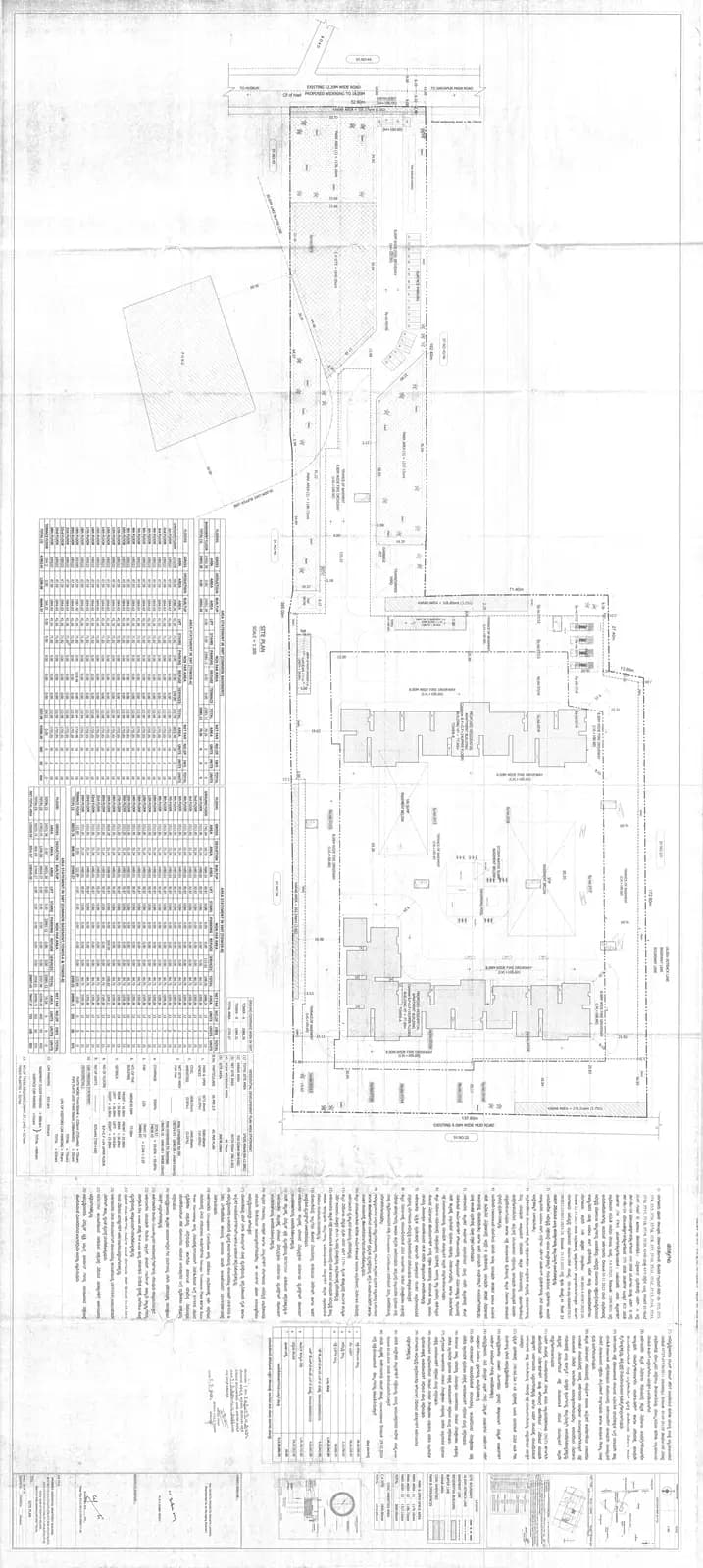

Phase-1: Approved Layout PlanFull PDF on RERA
Phase-1: Existing Layout PlanFull PDF on RERA
| Home type | Carpet area | Homes |
|---|---|---|
| 1 BHK | 440 – 614 sq ft | 104 |
| 2 BHK | 699 – 705 sq ft | 150 |
| 2 BHK + study | 746 – 786 sq ft | 151 |
| 2.5 BHK | 786 sq ft | 49 |
| 3 BHK | 867 – 1,195 sq ft | 548 |
| 3 BHK(3t) | 962 sq ft | 25 |
Home types, counts and carpet areas as filed with Karnataka RERA (carpet area, not super built-up).
We have not collected floor-plan drawings; the builder’s sales team can share them.

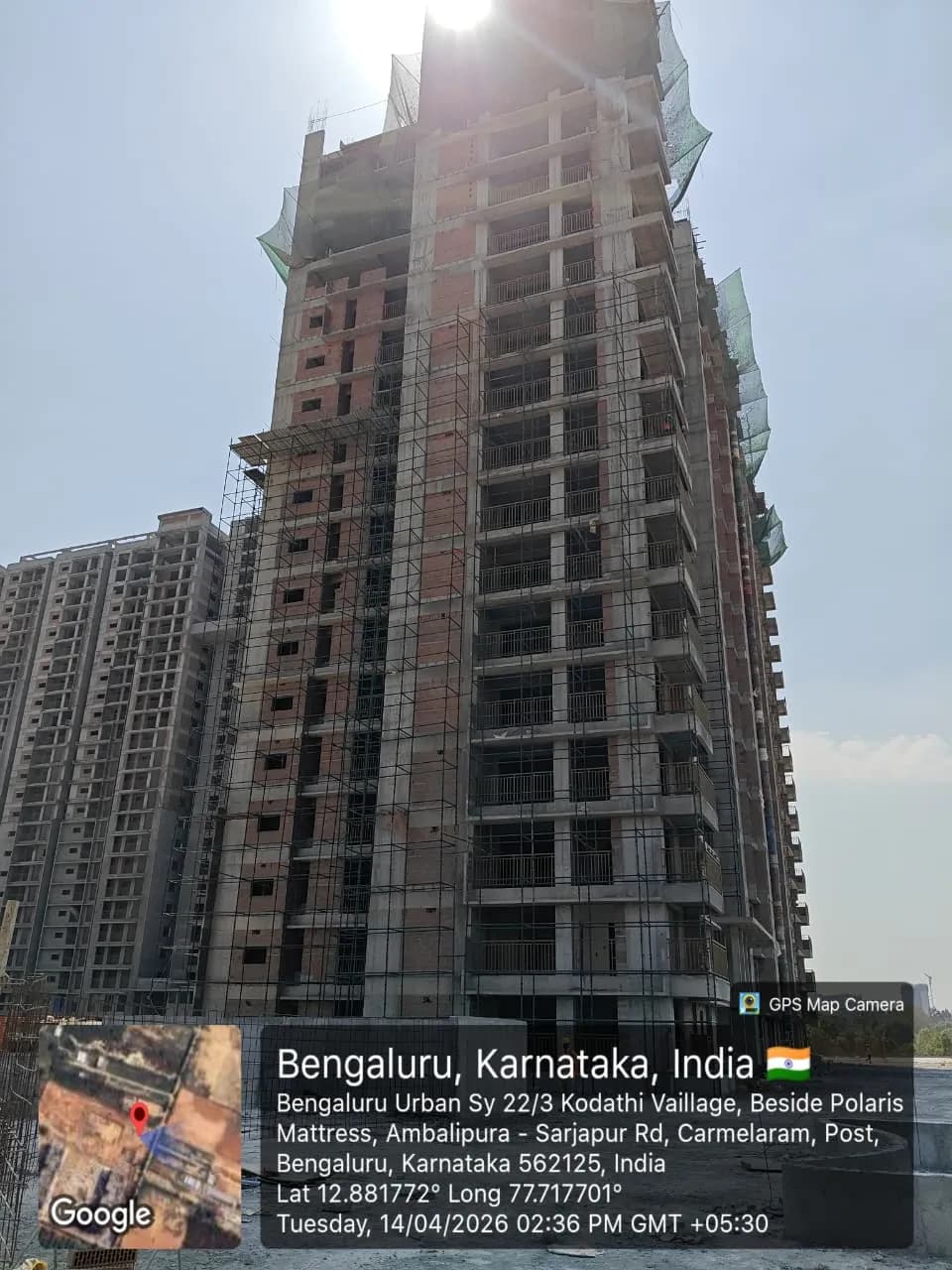

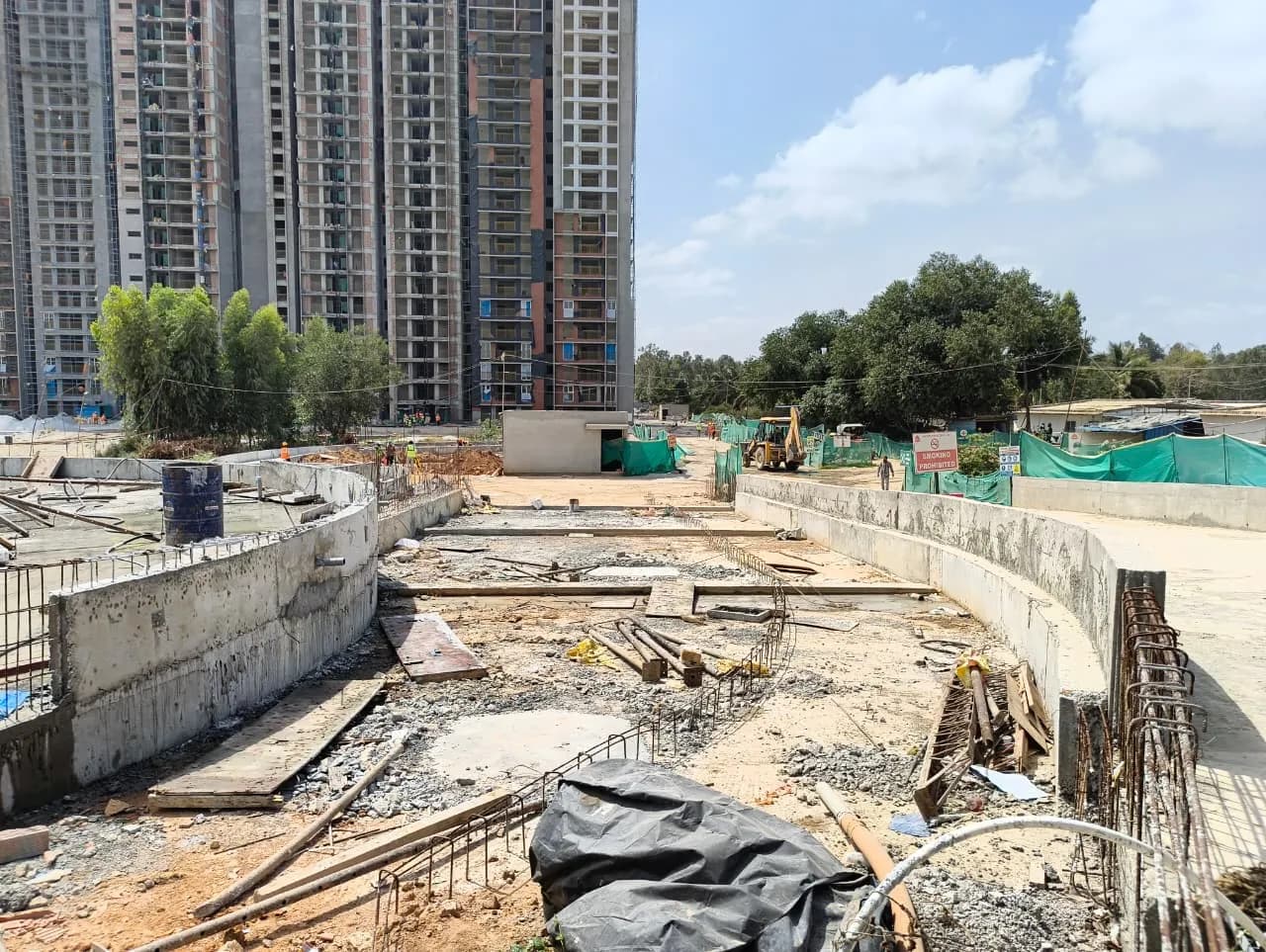

Trifecta Vanto possession date and construction status
Timeline
- 1 Mar 2024Phase-1: Project start date given to RERA
- 19 Apr 2024Phase-1: Registered with Karnataka RERA
- 1 Apr 2025Phase-2: Project start date given to RERA
- 25 Jun 2025Phase-2: Registered with Karnataka RERA
- 31 Aug 2027Phase-1: Completion date given at registration
- 31 Mar 2028Phase-2: Completion date given at registration
Construction pace from RERA quarterly filings (Phase-1)
At the average pace so far, construction would reach 100% around Dec 2026 — about 8 months before the completion date on RERA (31 Aug 2027).
At the pace between the 4 quarterly filings we have (70% → 92% in 9 months), it would be around Jan 2027 — about 8 months before the RERA date.
This project has 2 RERA registrations; the chart uses Phase-1, the one with the most quarterly filings.
- Filed on RERA
- Average pace since start
- Pace between filings (and 0% assumed at the start date)
- RERA completion date
Quarterly filings
| Quarter | Filed on | Built | Homes booked |
|---|---|---|---|
| Q2 2026-27to 30 Sep 2026 | 15 Oct 2026 | 92% | 463 of 825 |
| Q1 2026-27to 30 Jun 2026 | 15 Jul 2026 | 87% | 411 of 825 |
| Q4 2025-26to 31 Mar 2026 | 15 Apr 2026 | 80% | 363 of 825 |
| Q3 2025-26to 31 Dec 2025 | 13 Jan 2026 | 70% | 312 of 825 |
How we calculate
Average pace = % built ÷ months since the start date in the RERA record. Here: 92% ÷ 31 months (1 Mar 2024 to 30 Sep 2026) = 3% a month.
Estimated finish = latest filing date + (100 − % built) ÷ pace = 30 Sep 2026 + 8 ÷ 3 = 2.7 months → Dec 2026. This is an estimate, not a date from the builder or RERA.
Pace between filings = (92% − 70%) ÷ 9 months = 2.5% a month.
A straight line is a simplification: the builder reports one overall %, which mixes excavation, structure and finishing, and work rarely moves at a constant speed. The % values are the promoter’s own figures filed with RERA, not checked by us.
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
Approvals and documents checklist
17 rows: approvals. Scroll inside the table to see them all.
| Approval | Authority | Source |
|---|---|---|

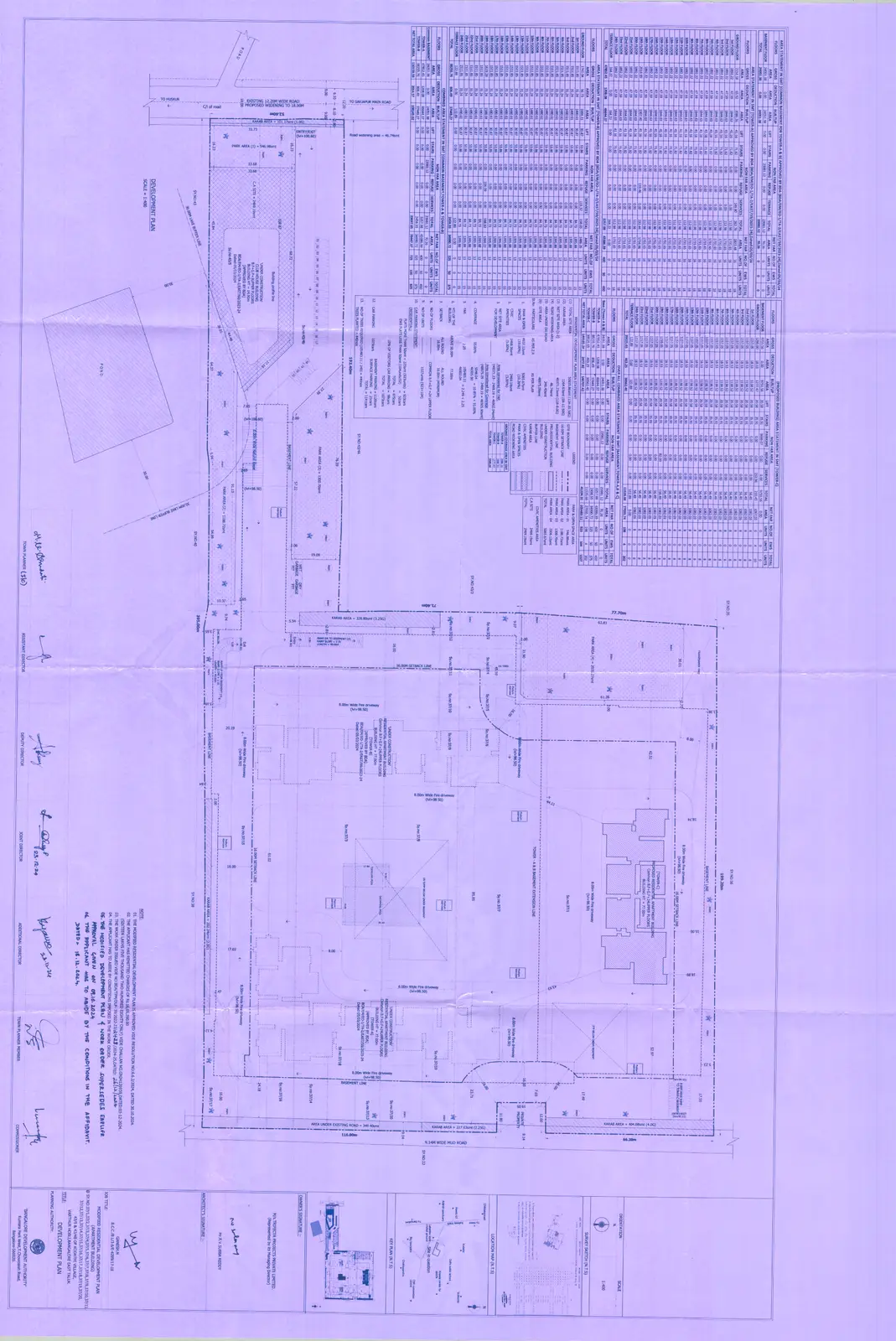

| Building plan (Phase-1) | BDA - Bangalore Development Authority · No. BDA/EM/EO-1/TA-2/E/59 & 60/2023-24 · dated 2024-03-05 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Land conversion (2 orders) (Phase-1) | DC · No. ALN(V2P)SR142/22-23 and 1 more · dated 2025-01-24 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Electricity Permission Letter (Phase-1) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Water Permission Letter (Phase-1) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Layout Plan (Phase-1) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Building/Plotting Plan (Phase-1) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| ESCOM/Electricity (Phase-1) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KWSSB/Water (Phase-1) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KSPCB (Phase-1) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| SEIAA (Phase-1) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Building plan (Phase-2) | BDA - Bangalore Development Authority · No. BDA/EM/EO-1/TA-2/E/69/2024-25 · dated 2025-04-01 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Land conversion (20 orders) (Phase-2) | DC · No. 706173 and 19 more · dated 2024-10-23 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Commencement Certificate (Phase-2) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Building Plan (Phase-2) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| SEIAA (Phase-2) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Fire Force Department (Phase-2) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Airport Authority of India (Phase-2) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
Documents uploaded to RERA (Phase-1)
- Building or layout plan · Approved drawings from the planning authorityFiled on RERA ✓ — BDA - Bangalore Development Authority · No. BDA/EM/EO-1/TA-2/E/59 & 60/2023-24 · dated 5 Mar 2024
- Commencement certificate · Permission to start buildingNot on RERA yet
- Environment clearance · SEIAA KarnatakaFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Fire NOC · Karnataka Fire and Emergency ServicesNot on RERA yet
- Pollution board consent · KSPCBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Water and sewerage · BWSSBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Electricity · BESCOMFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Height clearance · Airports Authority of IndiaNot on RERA yet
- Occupancy certificate (OC) · Issued only when the building is finishedNot on RERA yet — expected at completion
From the documents the promoter uploaded to Karnataka RERA, collected 21 Oct 2026. “Filed” means a document is on RERA — we have not checked its contents or validity. Not every approval applies to every project (for example, smaller projects may not need an environment clearance). Each phase is registered separately; this list is for the phase named above. The project page on RERA lists each upload.
Trifecta Vanto RERA complaints
No complaints listed on Karnataka RERA for these registrations as on Source (rera.karnataka.gov.in) (opens in a new tab)
Court and consumer cases
We list case numbers, courts and outcomes only — never names of private individuals.
About Trifecta Projects Private Limited
- Promoter type
- Company
- Projects on this site
- 5
- RERA complaints against promoter
- 2
- Company number (CIN)
- U45200KA2012PTC062831
From Karnataka RERA, as collected so far (21 Oct 2026). Complaints are those RERA lists against this promoter across all its projects.
Trifecta Projects Private Limited’s RERA recordTrifecta Projects Private Limited delivery record
- 5Projects in Bengaluru on RERA6 approved registrations under Trifecta Projects Private Limited in Bengaluru Urban and Rural. Source (rera.karnataka.gov.in) (opens in a new tab)
- 1,866Homes and plots registeredAs stated in each registrations.
- 2RERA complaints2 open, 0 disposed. as on Source (rera.karnataka.gov.in) (opens in a new tab)
- 1.1Complaints per 1,000 homes and plots2 complaints ÷ 1,866 homes and plots in its 6 registrations on Karnataka RERA in Bengaluru.
- 2Completion filed on RERARegistrations where the promoter applied to RERA for completion; 2 with an occupancy certificate on RERA.
- 2 of 2Filed by the date given at registrationMedian gap 0 months (on-time ones count as 0). The completion application can come after handover, so this is an upper bound on lateness.
What the complaints are about
2 complaint subjects as written on RERA, as on . Each subject is sorted into one group by keywords (first match wins: delay, refund, registration, quality, litigation, association); one complaint often raises several issues. Source (rera.karnataka.gov.in) (opens in a new tab)
Completion filed on RERA
| Project | Date at registration | Completion filed | Gap |
|---|---|---|---|
| Trifecta Verdeen Resplandor Row House Phase-3OC on RERA | 30 Sep 2026 | 29 Sep 2026 | By the date |
| Trifecta RettoOC on RERA | 26 Mar 2026 | 23 Dec 2025 | By the date |
Measured against the completion date given at registration; many projects had RERA extensions (including the COVID-period extension), shown under the date.
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
What’s changed since Mar 2024
- 15 Oct 2026Phase-1: Quarterly update filed for Q2 2026-27: 92% built, 463 of 825 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 15 Oct 2026Phase-2: Quarterly update filed for Q2 2026-27: 65% built, 105 of 202 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 15 Jul 2026Phase-1: Quarterly update filed for Q1 2026-27: 87% built, 411 of 825 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 15 Jul 2026Phase-2: Quarterly update filed for Q1 2026-27: 50% built, 70 of 202 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 15 Apr 2026Phase-1: Quarterly update filed for Q4 2025-26: 80% built, 363 of 825 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 15 Apr 2026Phase-2: Quarterly update filed for Q4 2025-26: 40% built, 47 of 202 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 13 Jan 2026Phase-1: Quarterly update filed for Q3 2025-26: 70% built, 312 of 825 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 13 Jan 2026Phase-2: Quarterly update filed for Q3 2025-26: 30% built, 36 of 202 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 25 Jun 2025Phase-2: Registered with Karnataka RERA (PRM/KA/RERA/1251/310/PR/250625/007871); completion date 31 Mar 2028 Source (rera.karnataka.gov.in) (opens in a new tab)
- 1 Apr 2025Phase-2: Building plan approved by BDA - Bangalore Development Authority (No. BDA/EM/EO-1/TA-2/E/69/2024-25) Source (rera.karnataka.gov.in) (opens in a new tab)
- 1 Apr 2025Phase-2: Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
- 19 Apr 2024Phase-1: Registered with Karnataka RERA (PRM/KA/RERA/1251/446/PR/190424/006813); completion date 31 Aug 2027 Source (rera.karnataka.gov.in) (opens in a new tab)
- 5 Mar 2024Phase-1: Building plan approved by BDA - Bangalore Development Authority (No. BDA/EM/EO-1/TA-2/E/59 & 60/2023-24) Source (rera.karnataka.gov.in) (opens in a new tab)
- 1 Mar 2024Phase-1: Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
Newest first. No extension of the completion date is recorded on RERA. When the RERA crawl sees a new filing, complaint or extension, it is added here with its date.
Home loan EMI calculator
- Monthly EMI
- —
- Down payment
- —
- Loan amount
- —
- Total interest
- —
A calculation only, from the numbers you enter — not a loan offer.
All-in cost: GST, registration and other charges
The calculator loads when you scroll to it.
Assumptions
- Base price: the builder’s price is not published in a form we could collect — enter it from the cost sheet.
- GST 5% on the base price and charges — the usual rate for an under-construction home that is not “affordable housing” (1%).
- Stamp duty about 5.6% and registration 2% — the Karnataka rule (registration was raised from 1% to 2% on 31 Aug 2025). Calculated on the agreement value.
- Car parking, other charges and the maintenance deposit are not in the public record we collect; enter them from the builder’s cost sheet.
- Loan on the agreement value (banks usually lend up to 75–90%); EMI is the standard reducing-balance formula. Example rate only — use your bank’s quote.
Trifecta Vanto FAQs
When will Trifecta Vanto be completed?
Phase-1 completion date on RERA is 31 August 2027, and Phase-2 completion date is 31 March 2028.
What is the RERA registration number for Trifecta Vanto?
Phase-1 registration number is PRM/KA/RERA/1251/446/PR/190424/006813 (registered 19 April 2024), and Phase-2 registration number is PRM/KA/RERA/1251/310/PR/250625/007871 (registered 25 June 2025).
What home types are available in Trifecta Vanto Phase-1?
Phase-1 offers 1 BHK (440 sq ft), 2 BHK (699-705 sq ft), 2 BHK + STUDY (746-786 sq ft), 2.5 BHK (786 sq ft), 3 BHK (867-925 sq ft), and 3 BHK (3T) (962 sq ft).
What home types are available in Trifecta Vanto Phase-2?
Phase-2 offers 3 BHK (1,033-1,195 sq ft) and 1 BHK (495-614 sq ft).
How many homes are in Trifecta Vanto?
Phase-1 has 825 homes and Phase-2 has 202 homes, totalling 1,027 homes.
What is the construction progress of Trifecta Vanto?
As of Q2 2026-27 (30 September 2026), Phase-1 is 92% complete with 463 homes booked out of 825, and Phase-2 is 65% complete with 105 homes booked out of 202.
Where is Trifecta Vanto located?
Trifecta Vanto is located in Bengaluru East taluk, Bengaluru Urban district, PIN code 560035.
Are there any RERA complaints against Trifecta Vanto?
No complaints have been filed on RERA for this project.
How many other projects does Trifecta Projects have on RERA record?
Trifecta Projects Private Limited has 8 projects recorded on RERA for Bengaluru.
How many complaints has the builder received across all projects?
The builder has 2 complaints across all projects on RERA record.
Written by AI from the RERA record above on 21 Oct 2026. Answers use only that record; check them against the source before you decide.
Questions about Trifecta Vanto
No questions published yet. Ask the first one: you get an instant answer from this page’s public record, and our team follows up on anything the record does not show.
Bought a home from Trifecta Projects Private Limited? Review the builder.
Reviews of Trifecta Projects Private Limited by verified buyers
No verified reviews of Trifecta Projects Private Limited yet. If you bought a home from them, your review helps other buyers.
How reviews work: only buyers and owners can review; we confirm each purchase by phone before publishing, publish positive and negative reviews alike, never accept payment for reviews, and the builder may reply.
Similar projects within 5 km
| Project | Distance | Homes | Possession (RERA) | Built | Complaints | Price |
|---|---|---|---|---|---|---|
| Courtyard Of LifeNavanaami Projects Private Limited | 0.6 km | 148 | Jun 2029 | 68% | 0 | Not collected |
| Assetz Trees & TandemInfraedge Management Services Pvt Ltd | 0.7 km | 402 | May 2030 | — | 0 | Not collected |
| Trifecta RettoTrifecta Projects Private Limited | 0.8 km | 188 | Mar 2026 | — | 0 | Not collected |
| PSR PlatinumM/s PSR BUILDERS AND DEVELOPERS | 1 km | 117 | Dec 2029 | 0% | 0 | Not collected |
| Mana Dale South -1Mana Projects Pvt Ltd | 1.1 km | 257 | Nov 2029 | 47% | 2 | Not collected |
| PSR VanasreeM/s PSR BUILDERS AND DEVELOPERS | 1.3 km | 392 | Dec 2027 | — | 0 | Not collected |
Projects of the same kind within 5 km in a straight line of this project’s RERA map point, nearest first. % built is the promoter’s latest quarterly figure on RERA (shown for single-registration projects); prices are from the builder’s own website where we found one.
Sources and last checked dates
Collected on 21 Oct 2026 by AI research agents reading public pages. Facts are written in our own words. Not found yet: price; court cases; landmarks; specifications; news.
How to check on RERA: On rera.karnataka.gov.in/viewAllProjects, type the registration number in 'Registration No', press Search, then click the 'View Project Details' icon. Complaints open from the 'Complaints / Litigation' icon in the same row. Registration numbers: PRM/KA/RERA/1251/446/PR/190424/006813, PRM/KA/RERA/1251/310/PR/250625/007871.
- RERA record last checked: 21 Oct 2026
- Last change in the record (registration, quarterly filing or complaint): 21 Oct 2026
How this page is made: software builds it from public records (Karnataka RERA filings, OpenStreetMap, the builder’s own website). AI is used only to read filings into fields and to write the plain-English summary and FAQ answers, which are checked against the record. Facts are checked automatically against the RERA filing. Methodology · How we earn · Report an error
More new projects nearby
Kodathi–CarmelaramUnder constructionRERA registeredBuyers’ group openCourtyard Of Life
by Navanaami
Price: Price on requestGet brochure & price →
- 3 BHK
- 858 – 2,558 sq ft
- Jun 2029
148 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Courtyard Of Life
Avalahalli, Doddaballapur RoadUnder constructionRERA registeredBuyers’ group openAssetz Trees & Tandem
by Infraedge Management Services
Price: Price on requestGet brochure & price →
- Studio, 2 BHK, 3 BHK
- 209 – 1,427 sq ft
- May 2030
2 phases on RERA · 402 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Assetz Trees & Tandem
Kodathi Halli, Kodathi–CarmelaramReady to moveRERA registeredBuyers’ group openTrifecta Retto
by Trifecta
Price: Price on requestGet brochure & price →
- 2 BHK, 3 BHK
- 710 – 861 sq ft
- Mar 2026
188 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Trifecta Retto
