Project summary

Adarsh Premia - Phase 1 is a residential project by Adarsh Developers in Bengaluru with 301 homes, registered with Karnataka RERA. The completion date on RERA is 31 Mar 2027.

Not in the RERA record we collected yet: locality, map location. This page fills in as the record is collected.

Facts collected on 15 Oct 2026 from public records — each linked to its source. Free for buyers. If you book through us, the builder pays us a commission.

Adarsh Premia - Phase 1 buyers’ group: join to ask for a group price

No one has joined yet. Be one of the first 10 buyers in this group — the founding members.

Join free. When enough buyers have joined, our agent partner asks Adarsh Developers for a group price — for example a lower price, an easier payment plan or waived charges. Nothing is promised: you see what the builder offers and book directly with the builder if you want to. Free for buyers. If you book through us, the builder pays us a commission.

  1. Gathering buyers
  2. Talking to the builder
  3. Group offer
  4. Group site visit
  5. Booking

0 buyers have joined · 0 committed

Committed buyers have confirmed their budget, home type and timeline with us on a call; builders negotiate with them. Joining is free and never obliges you to buy.

Join the Adarsh Premia - Phase 1 buyers’ groupHow group buying works

See it for yourself

Visit the site with our team, or get a call to clear your questions. Free, no obligation.

Key facts: home types, towers, land and possession

Updated on 15 Oct 2026
Home types
3 BHK, 4 BHK
Carpet area
1,377 – 2,483 sq ft
Towers
4
Floors
23
Total homes
301
Land
3.93 acres
Possession (extended)
Mar 2027
Built (RERA update)
95%

Adarsh Premia - Phase 1 RERA number and registration details

RERA number
PRM/KA/RERA/1251/310/PR/170915/000155
Registered on
15 Sep 2017
Promised completion
30 Jun 2020
Extended to
31 Mar 2027
RERA status
Under construction
Homes booked
182 of 301 as on
Price
Not found in public records yet: price
Project type
Residential

Towers and blocks (RERA filing)

TowerFloorsBasementsHomes
A23246
B23292
C23296
D23296

A dash (—) means the filing did not state that value.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Summary in plain English

Adarsh Premia - Phase 1 is a residential project by Adarsh Developers in Bengaluru South with 301 homes across 4 towers. The project was registered with Karnataka RERA on 15 September 2017 and has a completion date of 31 March 2027.

Written by AI from the RERA record above on 15 Oct 2026. Every number in it was checked against that record; if anything differs, the record wins.

Open space, home loans, escrow and other details

Open space
76.3% of land
Water and power
Not found in public records yet: water and power
Home loans: approved banks
Not found in public records yet: bank approvals
Payment plans
Not found in public records yet: payment plans
Maintenance
Not found in public records yet: maintenance
Car parking
Not found in public records yet: car parking charge
Escrow bank (RERA)
LAKSHMI VILAS BANK, Bengaluru Main
Project cost declared to RERA
₹311 Cr

Open area as a share of the land, from the areas filed with RERA (includes driveways and landscaped areas).

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Amenities

Not found in public records yet: amenities

Adarsh Premia - Phase 1 location and address

Address
Ward No.55, Municiple No.3(Old No 52/1A, 56/2,57 & 53,), No 3, Kadirenahalli, Outer ring road, Banashankari,
Village (RERA)
Not found in public records yet: village
Locality
Banashankari
City
Bengaluru
State
Karnataka
Coordinates
Not found in public records yet: coordinates

Distances to landmarks

Not found in public records yet: landmarks

About Banashankari

Not found in public records yet: locality facts

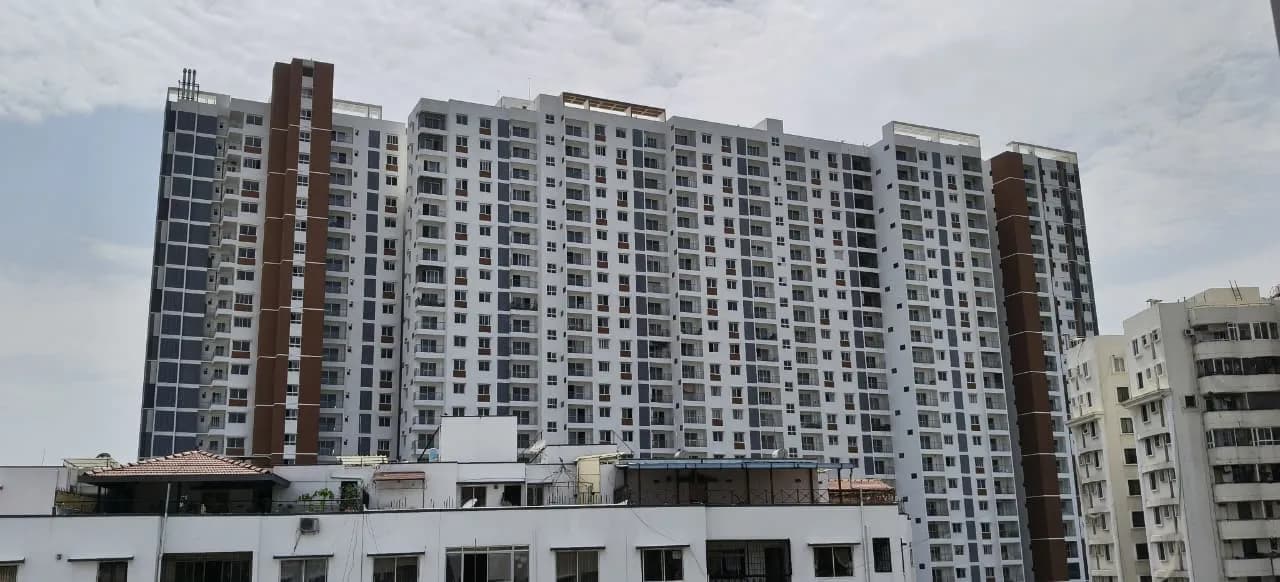

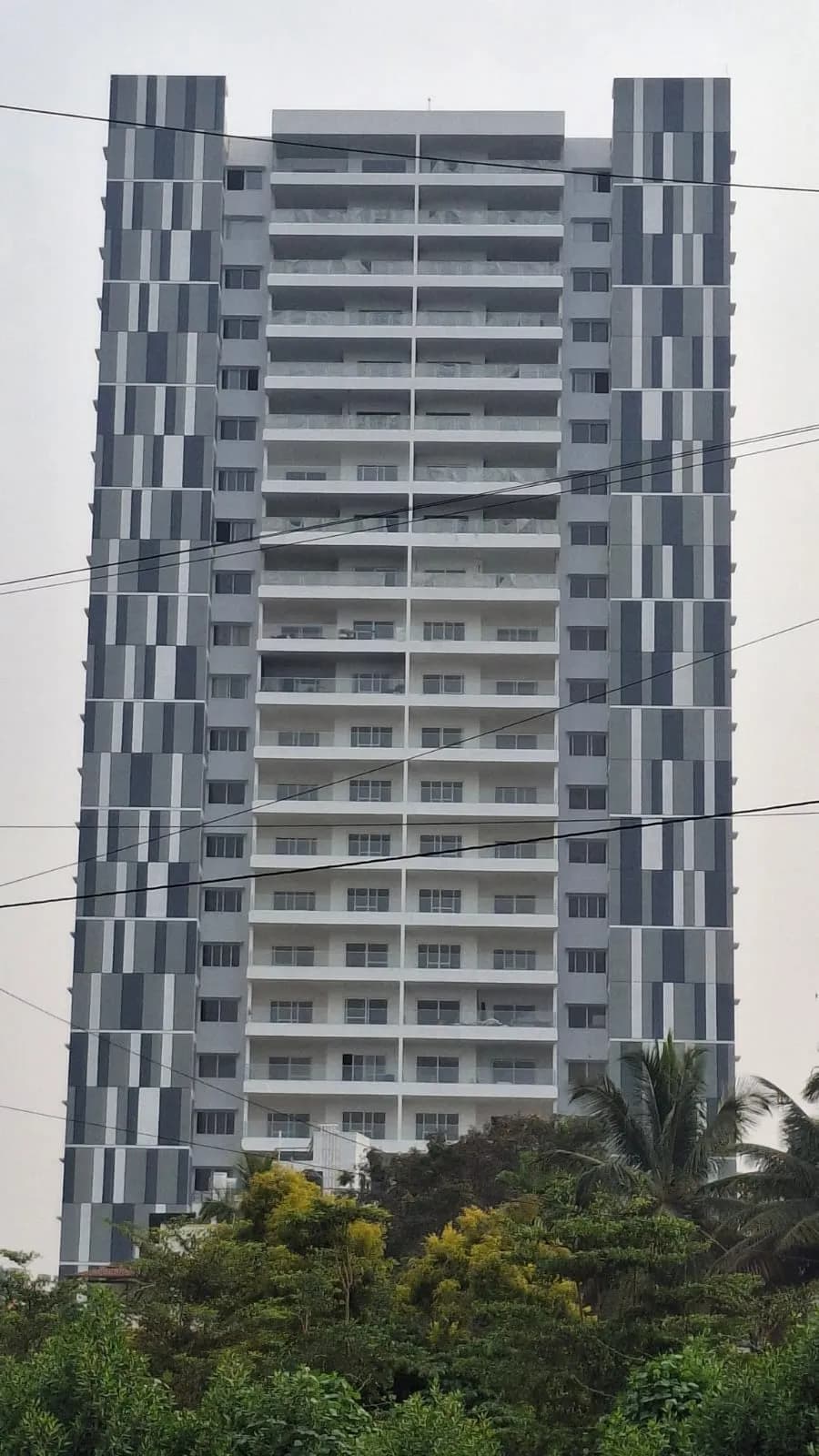

Adarsh Premia - Phase 1 home types and carpet areas

Documents the builder uploaded to Karnataka RERA, shown as filed. Tap a page to see it full size; the full PDF opens on the RERA website.

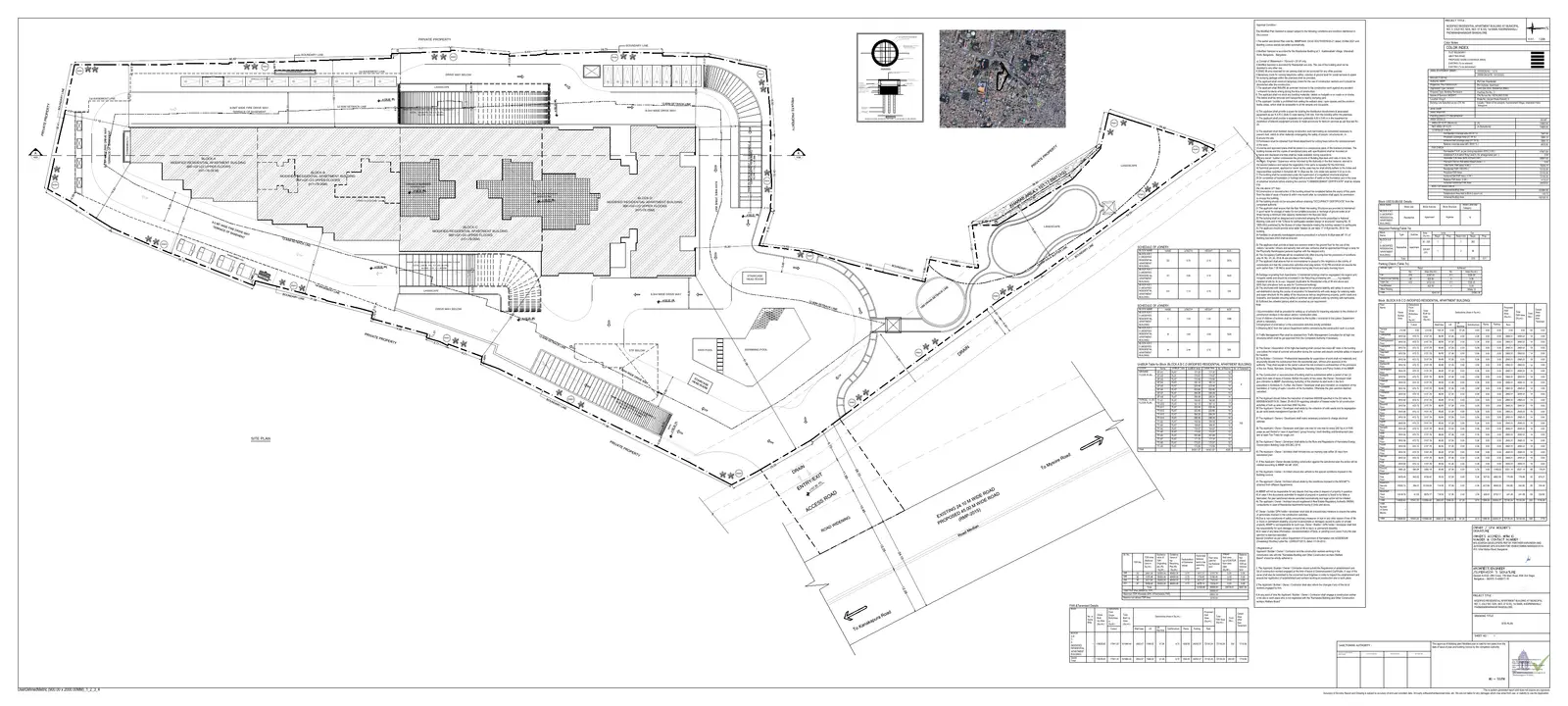

Approved building plan2 files

Floor plans and brochure not published? The builder shares them only on request. We’ll get the brochure, floor plans and current price list for you, free.

Get brochure, floor plans & price

Brochure, floor plans and price list for Adarsh Premia - Phase 1

Builders share their brochure, floor plans and price list only on request. Tell us how to reach you and we’ll get them and send them to you, free.

Free for buyers. If you book through us, the builder pays us a commission. How we earn

Home typeCarpet areaHomes
3 BHK1,377 – 1,648 sq ft59
3 BHK with servant room1,539 sq ft96
4 BHK2,010 – 2,483 sq ft96
4 BHK with servent room2,250 sq ft50

Home types, counts and carpet areas as filed with Karnataka RERA (carpet area, not super built-up).

We have not collected floor-plan drawings; the builder’s sales team can share them.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

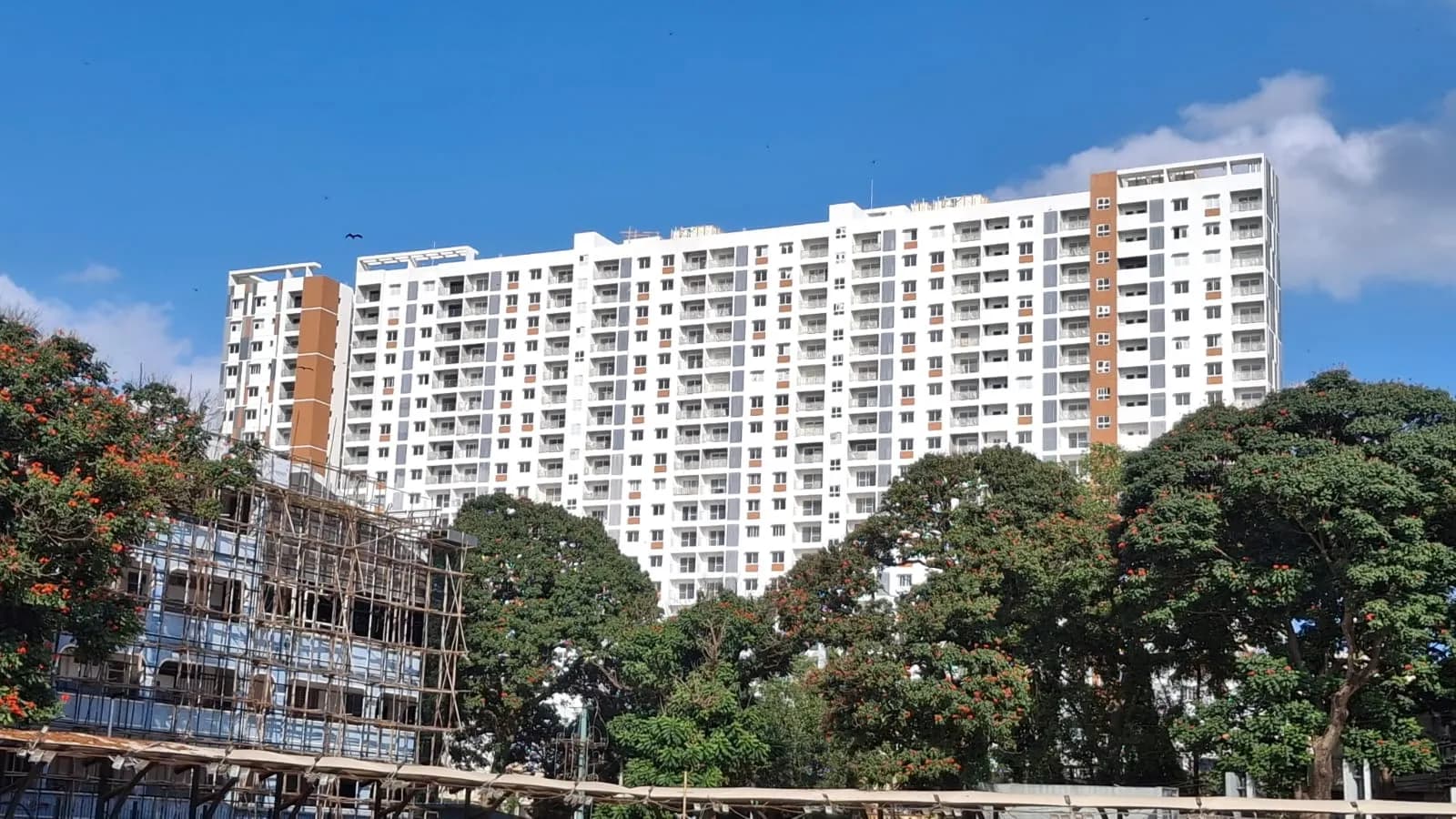

Adarsh Premia - Phase 1 possession date and construction status

  • Whole project (promoter’s RERA update)95%

    as on · 182 of 301 homes booked

Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-15.

By tower (Q2 2026-27)

  • A95%
  • B95%
  • C95%
  • D84%

Units sold and unsold, from RERA (Q2 2026-27)

TypeHomesBookedAvailable
3 BHK234119115
4 BHK966333

As reported by the promoter in the quarterly update to RERA, not verified by us.

Timeline

  1. 15 Nov 2013Project start date given to RERA
  2. 15 Sep 2017Registered with Karnataka RERA
  3. 30 Jun 2020Completion date given at registration
  4. 30 Dec 2021Section 6 Extension: completion date moved to this date
  5. 31 Mar 2027Further Extension: completion date moved to this date

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Construction pace from RERA quarterly filings

As on 15 Oct 2026

At the average pace so far, construction would reach 100% around Jun 2027 — about 2 months after the completion date on RERA (31 Mar 2027).

At the pace between the 4 quarterly filings we have (79% → 95% in 9 months), it would be around Dec 2026 — about 3 months before the RERA date.

0%25%50%75%100%2014201620182020202220242026RERA date79%81%84%95%
  • Filed on RERA
  • Average pace since start
  • Pace between filings (and 0% assumed at the start date)
  • RERA completion date

Quarterly filings

QuarterFiled onBuiltHomes booked
Q2 2026-27to 30 Sep 202615 Oct 202695%182 of 330
Q1 2026-27to 30 Jun 202615 Jul 202684%171 of 330
Q4 2025-26to 31 Mar 202615 Apr 202681%171 of 330
Q3 2025-26to 31 Dec 20258 Apr 202679%167 of 330
How we calculate

Average pace = % built ÷ months since the start date in the RERA record. Here: 95% ÷ 154.5 months (15 Nov 2013 to 30 Sep 2026) = 0.6% a month.

Estimated finish = latest filing date + (100 − % built) ÷ pace = 30 Sep 2026 + 5 ÷ 0.6 = 8.1 months → Jun 2027. This is an estimate, not a date from the builder or RERA.

Pace between filings = (95% − 79%) ÷ 9 months = 1.8% a month.

A straight line is a simplification: the builder reports one overall %, which mixes excavation, structure and finishing, and work rarely moves at a constant speed. The % values are the promoter’s own figures filed with RERA, not checked by us. Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-15.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this

Approvals and documents checklist

ApprovalAuthoritySource
Building planBBMP - Bruhat Bengaluru Mahanagara PalikeSource (rera.karnataka.gov.in) (opens in a new tab)

Documents uploaded to RERA

As on 15 Oct 2026
  • Building or layout plan · Approved drawings from the planning authorityFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Commencement certificate · Permission to start buildingNot on RERA yet
  • Environment clearance · SEIAA KarnatakaNot on RERA yet
  • Fire NOC · Karnataka Fire and Emergency ServicesNot on RERA yet
  • Pollution board consent · KSPCBNot on RERA yet
  • Water and sewerage · BWSSBNot on RERA yet
  • Electricity · BESCOMNot on RERA yet
  • Height clearance · Airports Authority of IndiaNot on RERA yet
  • Occupancy certificate (OC) · Issued only when the building is finishedNot on RERA yet — expected at completion

From the documents the promoter uploaded to Karnataka RERA, collected 15 Oct 2026. “Filed” means a document is on RERA — we have not checked its contents or validity. Not every approval applies to every project (for example, smaller projects may not need an environment clearance). The project page on RERA lists each upload.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Adarsh Premia - Phase 1 RERA complaints and orders

9 complaints as on Source (rera.karnataka.gov.in) (opens in a new tab)

Complaint refFiledSubjectStatusSource
01032/202620 Aug 2026Interest on delay period, execution of sale deed and handover of possession of the flat.Under enquirySource (rera.karnataka.gov.in) (opens in a new tab)
00794/202530 May 2025For specific performance of Sale Agreement dt. 25-05-2022 by directing Respondents to execute a sale deed in complainant's favor and pay compensation for the delay of possession and othersPosted for ordersSource (rera.karnataka.gov.in) (opens in a new tab)
00687/202529 Apr 2025Refund of advance amount paid Rupees Five Lakhs Only.DisposedSource (rera.karnataka.gov.in) (opens in a new tab)
00093/202420 Jan 2024Delay in handing over possessionDisposedSource (rera.karnataka.gov.in) (opens in a new tab)
01733/202320 Nov 2023Compensation not given for not handing over of flat with in the date specified in the agreement to sellDisposedSource (rera.karnataka.gov.in) (opens in a new tab)
CMP/210302/00077162 Mar 2021Significant delay in construction of the apartmentDisposedSource (rera.karnataka.gov.in) (opens in a new tab)
CMP/191205/00048915 Dec 2019Failure to handover Flat No. B-701, 7th Floor, B-Block, Adarsh Premia within scheduled time and refund amounts paid with interest and compensationDisposed aoSource (rera.karnataka.gov.in) (opens in a new tab)
CMP/190912/000411812 Sep 2019Payment of interest and compensation on amounts paidDisposed aoSource (rera.karnataka.gov.in) (opens in a new tab)
CMP/190212/000207712 Feb 2019Refund of money and compensation and delay in delivery dateDisposed aoSource (rera.karnataka.gov.in) (opens in a new tab)

Court and consumer cases

Not found in public records yet: court cases

We list case numbers, courts and outcomes only — never names of private individuals.

About Adarsh Developers

Promoter type
Partnership Firm
Projects on this site
5
RERA complaints against promoter
24
Company number (CIN)
Not found in public records yet: CIN

From Karnataka RERA, as collected so far (15 Oct 2026). Complaints are those RERA lists against this promoter across all its projects.

Adarsh Developers’s RERA record

Adarsh Developers delivery record

As on 22 Oct 2026

What the complaints are about

  • Delay in possession or delay interest22
  • Refund of booking or other money1
  • Other1

24 complaint subjects as written on RERA, as on . Each subject is sorted into one group by keywords (first match wins: delay, refund, registration, quality, litigation, association); one complaint often raises several issues. Source (rera.karnataka.gov.in) (opens in a new tab)

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this

What’s changed since Nov 2013

As on 15 Oct 2026
  1. 31 Mar 2027Completion date extended to 31 Mar 2027 Source (rera.karnataka.gov.in) (opens in a new tab)
  2. 15 Oct 2026Quarterly update filed for Q2 2026-27: 95% built, 182 of 330 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  3. 20 Aug 2026Complaint 01032/2026 filed with RERA: “Interest on delay period, execution of sale deed and handover of possession of the flat.” — now under enquiry Source (rera.karnataka.gov.in) (opens in a new tab)
  4. 15 Jul 2026Quarterly update filed for Q1 2026-27: 84% built, 171 of 330 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  5. 15 Apr 2026Quarterly update filed for Q4 2025-26: 81% built, 171 of 330 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  6. 8 Apr 2026Quarterly update filed for Q3 2025-26: 79% built, 167 of 330 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  7. 30 May 2025Complaint 00794/2025 filed with RERA: “For specific performance of Sale Agreement dt. 25-05-2022 by directing Respondents to execute a sale deed in complainant's favor and pay compensation for the delay of possession and others” — now posted for orders Source (rera.karnataka.gov.in) (opens in a new tab)
  8. 29 Apr 2025Complaint 00687/2025 filed with RERA: “Refund of advance amount paid Rupees Five Lakhs Only.” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
  9. 20 Jan 2024Complaint 00093/2024 filed with RERA: “Delay in handing over possession” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
  10. 20 Nov 2023Complaint 01733/2023 filed with RERA: “Compensation not given for not handing over of flat with in the date specified in the agreement to sell” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
  11. 2 Mar 2021Complaint CMP/210302/0007716 filed with RERA: “Significant delay in construction of the apartment” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
  12. 5 Dec 2019Complaint CMP/191205/0004891 filed with RERA: “Failure to handover Flat No. B-701, 7th Floor, B-Block, Adarsh Premia within scheduled time and refund amounts paid with interest and compensation” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
  13. 12 Sep 2019Complaint CMP/190912/0004118 filed with RERA: “Payment of interest and compensation on amounts paid” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
  14. 12 Feb 2019Complaint CMP/190212/0002077 filed with RERA: “Refund of money and compensation and delay in delivery date” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
  15. 15 Sep 2017Registered with Karnataka RERA (PRM/KA/RERA/1251/310/PR/170915/000155); completion date 30 Jun 2020 Source (rera.karnataka.gov.in) (opens in a new tab)
  16. 15 Nov 2013Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)

Newest first. When the RERA crawl sees a new filing, complaint or extension, it is added here with its date.

Home loan EMI calculator

No listed price found — enter one to try.

Example only — use your bank’s quote.

Monthly EMI
—
Down payment
—
Loan amount
—
Total interest
—

A calculation only, from the numbers you enter — not a loan offer.

All-in cost: GST, registration and other charges

The calculator loads when you scroll to it.

Assumptions
  • Base price: the builder’s price is not published in a form we could collect — enter it from the cost sheet.
  • GST 5% on the base price and charges — the usual rate for an under-construction home that is not “affordable housing” (1%).
  • Stamp duty about 5.6% and registration 2% — the Karnataka rule (registration was raised from 1% to 2% on 31 Aug 2025). Calculated on the agreement value.
  • Car parking, other charges and the maintenance deposit are not in the public record we collect; enter them from the builder’s cost sheet.
  • Loan on the agreement value (banks usually lend up to 75–90%); EMI is the standard reducing-balance formula. Example rate only — use your bank’s quote.

How we calculate this

Adarsh Premia - Phase 1 FAQs

What is the RERA registration number for Adarsh Premia - Phase 1?

The RERA registration number is PRM/KA/RERA/1251/310/PR/170915/000155, registered on 15 September 2017.

When is Adarsh Premia - Phase 1 scheduled to be completed?

The completion date on RERA is 31 March 2027. The project has had extensions approved: a Covid Extension, a Section 6 Extension (with completion date 30 December 2021), and a Further Extension (with completion date 31 March 2027).

How many homes are in Adarsh Premia - Phase 1?

The project has 301 homes across 4 towers, with a maximum of 23 floors.

What home types are available in Adarsh Premia - Phase 1?

The project offers four home types: 4 BHK with Servant Room (50 homes, 2,250 carpet sq ft), 3 BHK (59 homes, 1,377 to 1,648 carpet sq ft), 3 BHK with Servant Room (96 homes, 1,539 carpet sq ft), and 4 BHK (96 homes, 2,010 to 2,483 carpet sq ft).

What is the carpet area range for homes in Adarsh Premia - Phase 1?

Carpet areas range from 1,377 to 2,483 carpet sq ft, depending on the home type.

How many homes are booked in Adarsh Premia - Phase 1?

As of Q2 2026-27 (quarter ended 30 September 2026), 182 homes are booked out of 330 homes in the booking table.

What is the construction progress of Adarsh Premia - Phase 1?

As of Q2 2026-27, the project is 95% complete.

Where is Adarsh Premia - Phase 1 located?

The project is in Bengaluru South, PIN code 560001.

How many RERA complaints are there against Adarsh Premia - Phase 1?

There are 9 complaints filed with RERA on this project.

How many other projects does Adarsh Developers have in the RERA records?

Adarsh Developers has 9 projects in the Bengaluru RERA records and 24 complaints filed against the builder across all projects.

Written by AI from the RERA record above on 15 Oct 2026. Answers use only that record; check them against the source before you decide.

Questions about Adarsh Premia - Phase 1

No questions published yet. Ask the first one: you get an instant answer from this page’s public record, and our team follows up on anything the record does not show.

Bought a home from Adarsh Developers? Review the builder.

Reviews of Adarsh Developers by verified buyers

No verified reviews of Adarsh Developers yet. If you bought a home from them, your review helps other buyers.

How reviews work: only buyers and owners can review; we confirm each purchase by phone before publishing, publish positive and negative reviews alike, never accept payment for reviews, and the builder may reply.

Sources and last checked dates

  1. Karnataka RERA — project register (search by the registration number) (opens in a new tab)

Collected on 15 Oct 2026 by AI research agents reading public pages. Facts are written in our own words. Not found yet: price; court cases; landmarks; specifications; news.

How to check on RERA: On rera.karnataka.gov.in/viewAllProjects, type the registration number in 'Registration No', press Search, then click the 'View Project Details' icon. Complaints open from the 'Complaints / Litigation' icon in the same row. Registration number: PRM/KA/RERA/1251/310/PR/170915/000155.

  • RERA record last checked: 15 Oct 2026
  • Last change in the record (registration, quarterly filing or complaint): 15 Oct 2026

How this page is made: software builds it from public records (Karnataka RERA filings, OpenStreetMap, the builder’s own website). AI is used only to read filings into fields and to write the plain-English summary and FAQ answers, which are checked against the record. Facts are checked automatically against the RERA filing. Methodology · How we earn · Report an error

More new projects in Banashankari
