Ajmera Iris

2 & 3 BHK apartments by Ajmera Housing Corporation Bangalore · Chikkanagamangala, Electronic City Phase 2, Bengaluru

Chikkanagamangala, Electronic City Phase 2, BengaluruOpen on Google Maps (opens in a new tab)

  • Under construction
  • RERA registered
  • residential

by Ajmera Housing Corporation Bangalore

Price: Price on request

Get brochure, floor plans & price

Brochure, floor plans and price list for Ajmera Iris

Builders share their brochure, floor plans and price list only on request. Tell us how to reach you and we’ll get them and send them to you, free.

Free for buyers. If you book through us, the builder pays us a commission. How we earn

Project summary

Ajmera Iris is a residential project by Ajmera Housing Corporation Bangalore in Chikkanagamangala, Bengaluru with 215 homes, registered with Karnataka RERA. The completion date on RERA is 31 Dec 2026.

Facts collected on 21 Oct 2026 from public records — each linked to its source. Free for buyers. If you book through us, the builder pays us a commission.

Ajmera Iris buyers’ group: join to ask for a group price

No one has joined yet. Be one of the first 10 buyers in this group — the founding members.

Join free. When enough buyers have joined, our agent partner asks Ajmera Housing Corporation Bangalore for a group price — for example a lower price, an easier payment plan or waived charges. Nothing is promised: you see what the builder offers and book directly with the builder if you want to. Free for buyers. If you book through us, the builder pays us a commission.

  1. Gathering buyers
  2. Talking to the builder
  3. Group offer
  4. Group site visit
  5. Booking

0 buyers have joined · 0 committed

Committed buyers have confirmed their budget, home type and timeline with us on a call; builders negotiate with them. Joining is free and never obliges you to buy.

Join the Ajmera Iris buyers’ groupHow group buying works

See it for yourself

Visit the site with our team, or get a call to clear your questions. Free, no obligation.

Key facts: home types, towers, land and possession

Updated on 21 Oct 2026
Home types
2 BHK, 3 BHK
Carpet area
860 – 1,090 sq ft
Towers
11
Floors
5
Total homes
215
Land
4.31 acres
Possession (RERA)
Dec 2026
Built (RERA update)
80%

Ajmera Iris RERA number and registration details

RERA number
PRM/KA/RERA/1251/310/PR/281024/007184
Registered on
28 Oct 2024
Promised completion
31 Dec 2026
Extended to
No extension recorded
RERA status
New launch
Homes booked
134 of 215 as on
Price
Not found in public records yet: price
Project type
Residential

Towers and blocks (RERA filing)

11 rows: towers. Scroll inside the table to see them all.

TowerFloorsBasementsHomes
BLOCK-1(WING A)5120
BLOCK-1(WING B)5120
BLOCK-1(WING C)5120
BLOCK-1(WING D)5120
BLOCK-2(WING E)5115
BLOCK-2(WING F)5120
BLOCK-2(WING G)5120
BLOCK-3(WING H)5120
BLOCK-3(WING I)5120
BLOCK-3(WING J)5120
BLOCK3 (WING K)5120

A dash (—) means the filing did not state that value.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Summary in plain English

Ajmera Iris is a residential project by Ajmera Housing Corporation Bangalore in Chikkanagamangala, Bengaluru South. The project has 215 homes across 11 towers with a mix of 2 BHK and 3 BHK units. The RERA completion date is 31 December 2026.

Written by AI from the RERA record above on 21 Oct 2026. Every number in it was checked against that record; if anything differs, the record wins.

Open space, home loans, escrow and other details

Open space
62.4% of land
Water and power
Water source filed with RERA: Local Authority
Home loans: approved banks
Not found in public records yet: bank approvals
Payment plans
Not found in public records yet: payment plans
Maintenance
Not found in public records yet: maintenance
Car parking
Not found in public records yet: car parking charge
Escrow bank (RERA)
RATNAKAR BANK, Bangalore-Prestige Towers
Building plan (RERA)
BDA - Bangalore Development Authority · No. NM/AS/AA-1/TS-2/E/29/2024-2025 · dated 9 Oct 2024
Project cost declared to RERA
₹155 Cr

Open area as a share of the land, from the areas filed with RERA (includes driveways and landscaped areas).

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Amenities

  • Electricity
  • CCTV Surveillance
  • Club House
  • Community Hall
  • Outdoor Sports facility
  • Indoor Sports facility
  • Swimming Pool
  • Gym
  • Parks
  • Power Backup
  • Water and Sanitation

Amenities and internal works as filed by the promoter with Karnataka RERA; we have not visited the site.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Ajmera Iris location and address

Address
SY NO: 30/25,CHIKKANAGAMANGALA VILLAGE, SARJAPUR HOBLI, , ANEKAL TALUK, BANGLORE SOUTH , Bengaluru South , Bengaluru Urban, Karnataka - 560100
Village (RERA)
Chikkanagamangala
Locality
Electronic City Phase 2Also known as Electronics City Phase 2, E-City Phase 2
PIN code
560100
City
Bengaluru
State
Karnataka
Coordinates
12.84546, 77.68511

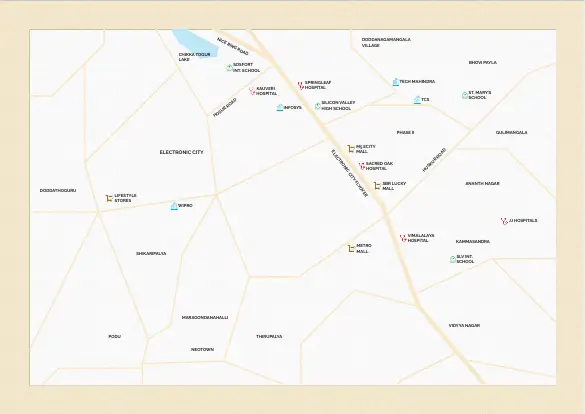

Distances to landmarks

Not found in public records yet: landmarks

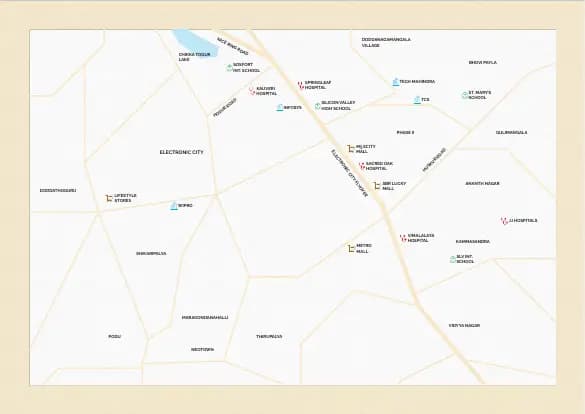

About Electronic City Phase 2

Not found in public records yet: locality facts

Commute times to tech parks and the airport

As on 5 Oct 2026
ToStraight linePeak-hour drive (estimate)
Electronic City Phase 1Map point on OpenStreetMap (opens in a new tab)2.23 kmapprox. 9 min
Outer Ring Road tech corridor (RMZ Ecospace, Bellandur)Map point on OpenStreetMap (opens in a new tab)8.71 kmapprox. 35 min
ITPL, Whitefield (main gate)Map point on OpenStreetMap (opens in a new tab)16.81 kmapprox. 68 min
KSR Bengaluru City railway station (Majestic)Map point on OpenStreetMap (opens in a new tab)19.36 kmapprox. 78 min
Manyata Tech ParkMap point on OpenStreetMap (opens in a new tab)23.62 kmapprox. 96 min
Kempegowda International AirportMap point on OpenStreetMap (opens in a new tab)39.56 kmapprox. 160 min
How we calculate

Straight line: from the project’s map point on RERA to the destination’s point on OpenStreetMap.

Peak-hour drive is a rough estimate, not a route: straight line × 1.35 for the road network, at 20 km/h. Real times vary a lot with the route and the hour.

Sources:Source (openstreetmap.org) (opens in a new tab)How we calculate this

Schools and hospitals nearby

As on 5 Oct 2026

Within 2 km

  • 23Schools and colleges13 schools, 9 colleges, 1 kindergartens
  • 10Hospitals and clinics5 hospitals, 5 clinics

Nearest schools and colleges

  • Florence Institutions · 0.6 km
  • Xavier Institute of Management and Entrepreneurship · 1.15 km
  • SFS Kannada Medium School · 1.31 km

Nearest hospitals and clinics

  • Poorvam Care & hearing solution · 1.04 km
  • Med ortho · 1.05 km
  • Sacred Oak · 1.08 km

Places as mapped on OpenStreetMap (amenity=school, college, kindergarten, university; hospital, clinic), counted within 2 km in a straight line of the RERA map point. Volunteers map these, so some places may be missing or closed. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.

Sources:Source (openstreetmap.org) (opens in a new tab)

Nearest metro station and railway

As on 5 Oct 2026
  • Huskur Road (ಹುಸ್ಕೂರು ರಸ್ತೆ)Open now — nearest operating metro station1.09 km
  • Huskuru (ಹುಸ್ಕೂರ್)Nearest railway station3.18 km

Straight-line distances from the RERA map point to the station points mapped on OpenStreetMap; status (open or under construction) as tagged there. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.

Sources:Source (openstreetmap.org) (opens in a new tab)

Lake and lake-buffer check

As on 5 Oct 2026

The nearest mapped lake is Unnamed lake (mapped on OpenStreetMap), 882 m from the project’s RERA map point.

The site boundary is not published as a shape, so its nearest edge can be closer than this point. Whether any building sits inside a lake buffer can only be checked on the approved plan.

The buffer rule

Bengaluru’s lake buffer rule has changed over time: the National Green Tribunal ordered a 75 m buffer in May 2016; the Supreme Court set that order aside on 5 March 2019, leaving the 30 m buffer of the Revised Master Plan 2015. Check the current rule and the approved plan before relying on either number.

Shortest distance from the RERA map point to the mapped water edge (OpenStreetMap water polygons tagged lake or reservoir, or named lake/kere/tank). Mapped shorelines can differ from the revenue-record boundary of a lake. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.

Sources:Source (openstreetmap.org) (opens in a new tab)Source (livelaw.in) (opens in a new tab)Source (citizenmatters.in) (opens in a new tab)How we calculate this

Satellite time-lapse of the site

Satellite photos load when you scroll to them.

Photos from Esri World Imagery Wayback, centred on the project’s map point; dates are the capture dates in Esri’s metadata. Loaded from Esri when you scroll here.

Sources:Source (livingatlas.arcgis.com) (opens in a new tab)

Ajmera Iris floor plans, brochure and elevations

Documents the builder uploaded to Karnataka RERA, shown as filed. Tap a page to see it full size; the full PDF opens on the RERA website.

Brochure12 pages

Approved layout plan2 files

Home typeCarpet areaHomes
2 BHK860 – 900 sq ft20
3 BHK860 – 1,090 sq ft195

Home types, counts and carpet areas as filed with Karnataka RERA (carpet area, not super built-up).

We have not collected floor-plan drawings; the builder’s sales team can share them.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Ajmera Iris possession date and construction status

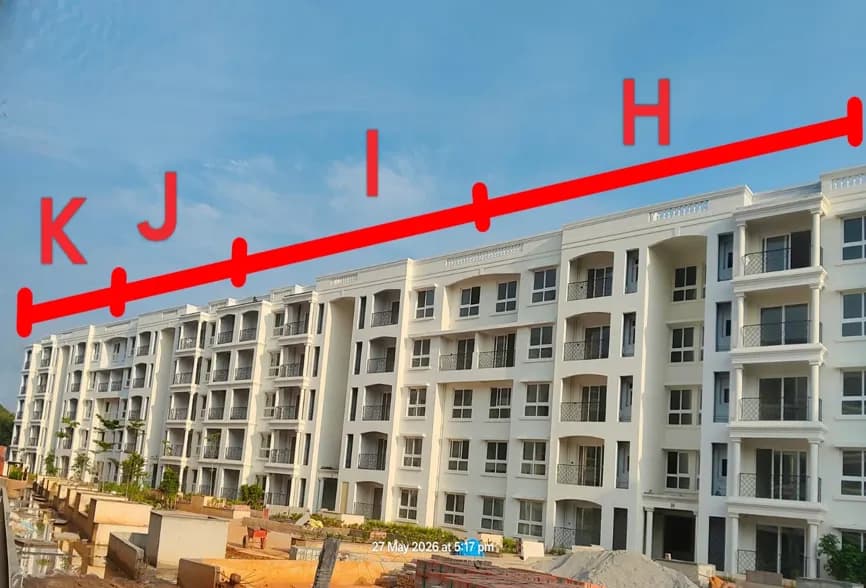

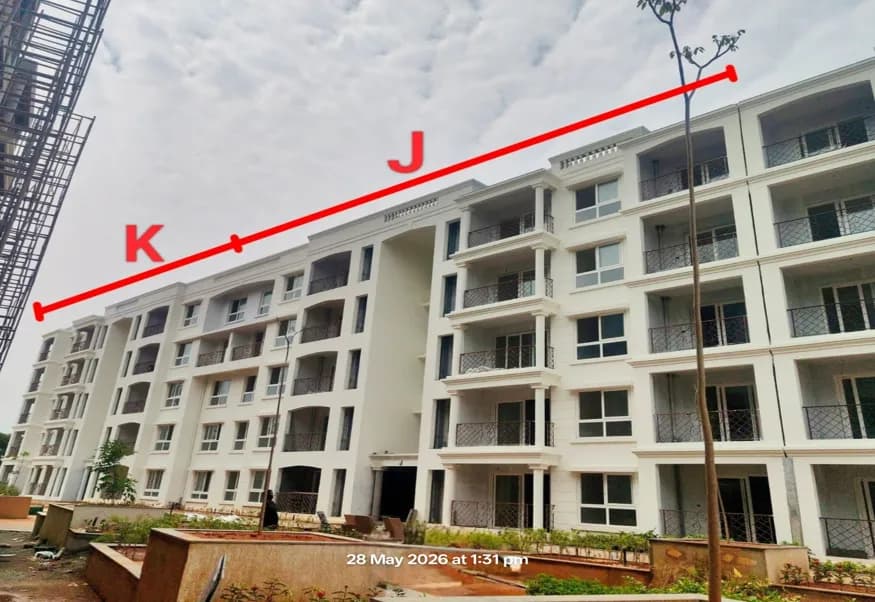

  • Whole project (promoter’s RERA update)80%

    as on · 134 of 215 homes booked

Promoter’s quarterly update to RERA for Q1 2026-27, submitted 2026-08-03.

By tower (Q1 2026-27)

  • BLOCK-1(WING A)80%
  • BLOCK-1(WING B)80%
  • BLOCK-1(WING C)80%
  • BLOCK-1(WING D)80%
  • BLOCK-2(WING E)80%
  • BLOCK-2(WING F)80%
  • BLOCK-2(WING G)80%
  • BLOCK-3(WING H)80%
  • BLOCK-3(WING I)80%
  • BLOCK-3(WING J)80%
  • BLOCK3 (WING K)80%

Units sold and unsold, from RERA (Q1 2026-27)

TypeHomesBookedAvailable
2 BHK18810
3 BHK19712671

As reported by the promoter in the quarterly update to RERA, not verified by us.

Timeline

  1. 9 Oct 2024Project start date given to RERA
  2. 28 Oct 2024Registered with Karnataka RERA
  3. 31 Dec 2026Completion date given at registration

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Construction pace from RERA quarterly filings

As on 3 Aug 2026

At the average pace so far, construction would reach 100% around Dec 2026 — about 1 month before the completion date on RERA (31 Dec 2026).

At the pace between the 3 quarterly filings we have (52% → 80% in 6 months), it would be around Nov 2026 — about 2 months before the RERA date.

0%25%50%75%100%202520262027RERA date52%70%80%
  • Filed on RERA
  • Average pace since start
  • Pace between filings (and 0% assumed at the start date)
  • RERA completion date

Quarterly filings

QuarterFiled onBuiltHomes booked
Q1 2026-27to 30 Jun 20263 Aug 202680%134 of 215
Q4 2025-26to 31 Mar 20267 May 202670%132 of 215
Q3 2025-26to 31 Dec 202526 Jan 202652%126 of 215
How we calculate

Average pace = % built ÷ months since the start date in the RERA record. Here: 80% ÷ 20.7 months (9 Oct 2024 to 30 Jun 2026) = 3.9% a month.

Estimated finish = latest filing date + (100 − % built) ÷ pace = 30 Jun 2026 + 20 ÷ 3.9 = 5.2 months → Dec 2026. This is an estimate, not a date from the builder or RERA.

Pace between filings = (80% − 52%) ÷ 5.9 months = 4.7% a month.

A straight line is a simplification: the builder reports one overall %, which mixes excavation, structure and finishing, and work rarely moves at a constant speed. The % values are the promoter’s own figures filed with RERA, not checked by us. Promoter’s quarterly update to RERA for Q1 2026-27, submitted 2026-08-03.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this

Approvals and documents checklist

16 rows: approvals. Scroll inside the table to see them all.

ApprovalAuthoritySource
Building planBDA - Bangalore Development Authority · No. NM/AS/AA-1/TS-2/E/29/2024-2025 · dated 2024-10-09Source (rera.karnataka.gov.in) (opens in a new tab)
Land conversionDISTRICT COLLECTOR · No. ANL(ASH)SR06/2011-12 · dated 2015-07-02Source (rera.karnataka.gov.in) (opens in a new tab)
Commencement Certificatescan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Electricity Permission Letterscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Water Permission Letterscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Approved Layout Planscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Approved Building/Plotting Planscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Approved Section Of Building/Infrastructure Plan of Plottingscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Change of Land Usescan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
District Magistratescan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Conversion Certificate under section 95 of the KLR Act 1964scan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
ESCOM/Electricityscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
KWSSB/Waterscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Airport Authority of Indiascan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
KSPCBscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
SEIAAscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)

Documents uploaded to RERA

As on 21 Oct 2026
  • Building or layout plan · Approved drawings from the planning authorityFiled on RERA ✓ — BDA - Bangalore Development Authority · No. NM/AS/AA-1/TS-2/E/29/2024-2025 · dated 9 Oct 2024
  • Commencement certificate · Permission to start buildingFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Environment clearance · SEIAA KarnatakaFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Fire NOC · Karnataka Fire and Emergency ServicesNot on RERA yet
  • Pollution board consent · KSPCBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Water and sewerage · BWSSBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Electricity · BESCOMFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Height clearance · Airports Authority of IndiaFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Occupancy certificate (OC) · Issued only when the building is finishedNot on RERA yet — expected at completion

From the documents the promoter uploaded to Karnataka RERA, collected 21 Oct 2026. “Filed” means a document is on RERA — we have not checked its contents or validity. Not every approval applies to every project (for example, smaller projects may not need an environment clearance). The project page on RERA lists each upload.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Ajmera Iris RERA complaints and orders

1 complaint as on Source (rera.karnataka.gov.in) (opens in a new tab)

Complaint refFiledSubjectStatusSource
00661/202522 Apr 2025Encrochment of propertyDisposedSource (rera.karnataka.gov.in) (opens in a new tab)

Court and consumer cases

Not found in public records yet: court cases

We list case numbers, courts and outcomes only — never names of private individuals.

About Ajmera Housing Corporation Bangalore

Promoter type
Partnership Firm
Projects on this site
2
RERA complaints against promoter
7
Company number (CIN)
Not found in public records yet: CIN

From Karnataka RERA, as collected so far (21 Oct 2026). Complaints are those RERA lists against this promoter across all its projects.

Ajmera Housing Corporation Bangalore’s RERA record

Ajmera Housing Corporation Bangalore delivery record

As on 21 Oct 2026

What the complaints are about

  • Delay in possession or delay interest4
  • Refund of booking or other money1
  • Other2

7 complaint subjects as written on RERA, as on . Each subject is sorted into one group by keywords (first match wins: delay, refund, registration, quality, litigation, association); one complaint often raises several issues. Source (rera.karnataka.gov.in) (opens in a new tab)

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this

What’s changed since Oct 2024

As on 21 Oct 2026
  1. 3 Aug 2026Quarterly update filed for Q1 2026-27: 80% built, 134 of 215 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  2. 7 May 2026Quarterly update filed for Q4 2025-26: 70% built, 132 of 215 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  3. 26 Jan 2026Quarterly update filed for Q3 2025-26: 52% built, 126 of 215 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  4. 22 Apr 2025Complaint 00661/2025 filed with RERA: “Encrochment of property” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
  5. 28 Oct 2024Registered with Karnataka RERA (PRM/KA/RERA/1251/310/PR/281024/007184); completion date 31 Dec 2026 Source (rera.karnataka.gov.in) (opens in a new tab)
  6. 9 Oct 2024Building plan approved by BDA - Bangalore Development Authority (No. NM/AS/AA-1/TS-2/E/29/2024-2025) Source (rera.karnataka.gov.in) (opens in a new tab)
  7. 9 Oct 2024Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)

Newest first. No extension of the completion date is recorded on RERA. When the RERA crawl sees a new filing, complaint or extension, it is added here with its date.

Home loan EMI calculator

No listed price found — enter one to try.

Example only — use your bank’s quote.

Monthly EMI
—
Down payment
—
Loan amount
—
Total interest
—

A calculation only, from the numbers you enter — not a loan offer.

All-in cost: GST, registration and other charges

The calculator loads when you scroll to it.

Assumptions
  • Base price: the builder’s price is not published in a form we could collect — enter it from the cost sheet.
  • GST 5% on the base price and charges — the usual rate for an under-construction home that is not “affordable housing” (1%).
  • Stamp duty about 5.6% and registration 2% — the Karnataka rule (registration was raised from 1% to 2% on 31 Aug 2025). Calculated on the agreement value.
  • Car parking, other charges and the maintenance deposit are not in the public record we collect; enter them from the builder’s cost sheet.
  • Loan on the agreement value (banks usually lend up to 75–90%); EMI is the standard reducing-balance formula. Example rate only — use your bank’s quote.

How we calculate this

Ajmera Iris FAQs

What is the RERA registration number for Ajmera Iris?

The RERA registration number is PRM/KA/RERA/1251/310/PR/281024/007184, registered on 28 October 2024.

How many homes are in Ajmera Iris and what types are available?

Ajmera Iris has 215 homes: 20 units of 2 BHK and 195 units of 3 BHK. The 2 BHK carpet area ranges from 860 to 900 sq ft, and the 3 BHK ranges from 860 to 1,090 sq ft.

What is the expected completion date for Ajmera Iris?

The RERA completion date is 31 December 2026.

What is the construction progress of Ajmera Iris?

As of Q1 2026-27 (quarter ended 30 June 2026), the project is 80% complete with 134 homes booked out of 215.

Where is Ajmera Iris located?

Ajmera Iris is in Chikkanagamangala, Bengaluru South taluk, Bengaluru Urban district, PIN code 560100.

How many towers and floors does Ajmera Iris have?

Ajmera Iris has 11 towers with a maximum of 5 floors.

How many RERA complaints are against Ajmera Iris?

There is 1 RERA complaint on this project.

How many RERA complaints has the builder Ajmera Housing Corporation Bangalore received across all projects?

Ajmera Housing Corporation Bangalore has 7 RERA complaints across all projects.

How many other projects does Ajmera Housing Corporation Bangalore have in the Bengaluru RERA record?

The builder has 5 projects total in the Bengaluru RERA records, including Ajmera Iris.

What is the escrow bank for Ajmera Iris?

The escrow bank is RATNAKAR BANK.

Written by AI from the RERA record above on 21 Oct 2026. Answers use only that record; check them against the source before you decide.

Questions about Ajmera Iris

No questions published yet. Ask the first one: you get an instant answer from this page’s public record, and our team follows up on anything the record does not show.

Bought a home from Ajmera Housing Corporation Bangalore? Review the builder.

Reviews of Ajmera Housing Corporation Bangalore by verified buyers

No verified reviews of Ajmera Housing Corporation Bangalore yet. If you bought a home from them, your review helps other buyers.

How reviews work: only buyers and owners can review; we confirm each purchase by phone before publishing, publish positive and negative reviews alike, never accept payment for reviews, and the builder may reply.

Similar projects within 5 km

ProjectDistanceHomesPossession (RERA)BuiltComplaintsPrice
Sai OrchidAkshaya Infra0.8 km159Jun 202783%1Not collected
Casagrand VivacityCasa Grande Garden City Builders Pvt Ltd1.1 km717Apr 202935%2Not collected
Orchid South ParkGoyal Hariyana Constructions1.1 km356Apr 20317%0Not collected
A B AnanthaAmaravathi Builders1.5 km32Jan 202784%0Not collected
Purva SilverskyPuravankara Limited1.5 km356Jul 20302%0from ₹2.55 Cr
VaradSatyam Builders & Developers1.7 km91Dec 202783%0Not collected

Projects of the same kind within 5 km in a straight line of this project’s RERA map point, nearest first. % built is the promoter’s latest quarterly figure on RERA (shown for single-registration projects); prices are from the builder’s own website where we found one.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Sources and last checked dates

  1. Karnataka RERA — project register (search by the registration number) (opens in a new tab)

Collected on 21 Oct 2026 by AI research agents reading public pages. Facts are written in our own words. Not found yet: price; court cases; landmarks; specifications; news.

How to check on RERA: On rera.karnataka.gov.in/viewAllProjects, type the registration number in 'Registration No', press Search, then click the 'View Project Details' icon. Complaints open from the 'Complaints / Litigation' icon in the same row. Registration number: PRM/KA/RERA/1251/310/PR/281024/007184.

  • RERA record last checked: 21 Oct 2026
  • Last change in the record (registration, quarterly filing or complaint): 3 Aug 2026

How this page is made: software builds it from public records (Karnataka RERA filings, OpenStreetMap, the builder’s own website). AI is used only to read filings into fields and to write the plain-English summary and FAQ answers, which are checked against the record. Facts are checked automatically against the RERA filing. Methodology · How we earn · Report an error

More new projects in Electronic City Phase 2

  • Casagrand Vivacity: Site photo filed with Karnataka RERAChikkanagamangala, near Electronic City Phase 2Under constructionRERA registeredBuyers’ group open

    Casagrand Vivacity

    by Casa Grande Garden City Builders

    Price: Price on requestGet brochure & price →

    • Studio, 1 BHK, 2 BHK, 3 BHK, +1 more
    • 402 – 2,342 sq ft
    • Apr 2029

    717 homes · 2 RERA complaints

    Be one of the first 10 buyers in this groupFounding members — it’s free

    Join group for Casagrand Vivacity
  • A B Anantha: Site photo filed with Karnataka RERAKammasandra, Electronic City Phase 2Under constructionRERA registeredBuyers’ group open

    A B Anantha

    by Amaravathi Builders

    Price: Price on requestGet brochure & price →

    • 2 BHK, 3 BHK
    • 695 – 1,075 sq ft
    • Jan 2027

    32 homes

    Be one of the first 10 buyers in this groupFounding members — it’s free

    Join group for A B Anantha
