Brigade Calista
1, 2 & 3 BHK apartments by Brigade Enterprises Ltd · Bommenahalli, Budigere Cross, Bengaluru
Bommenahalli, Budigere Cross, BengaluruOpen on Google Maps (opens in a new tab)
- Under construction
- RERA registered
- residential
Price: Price on request

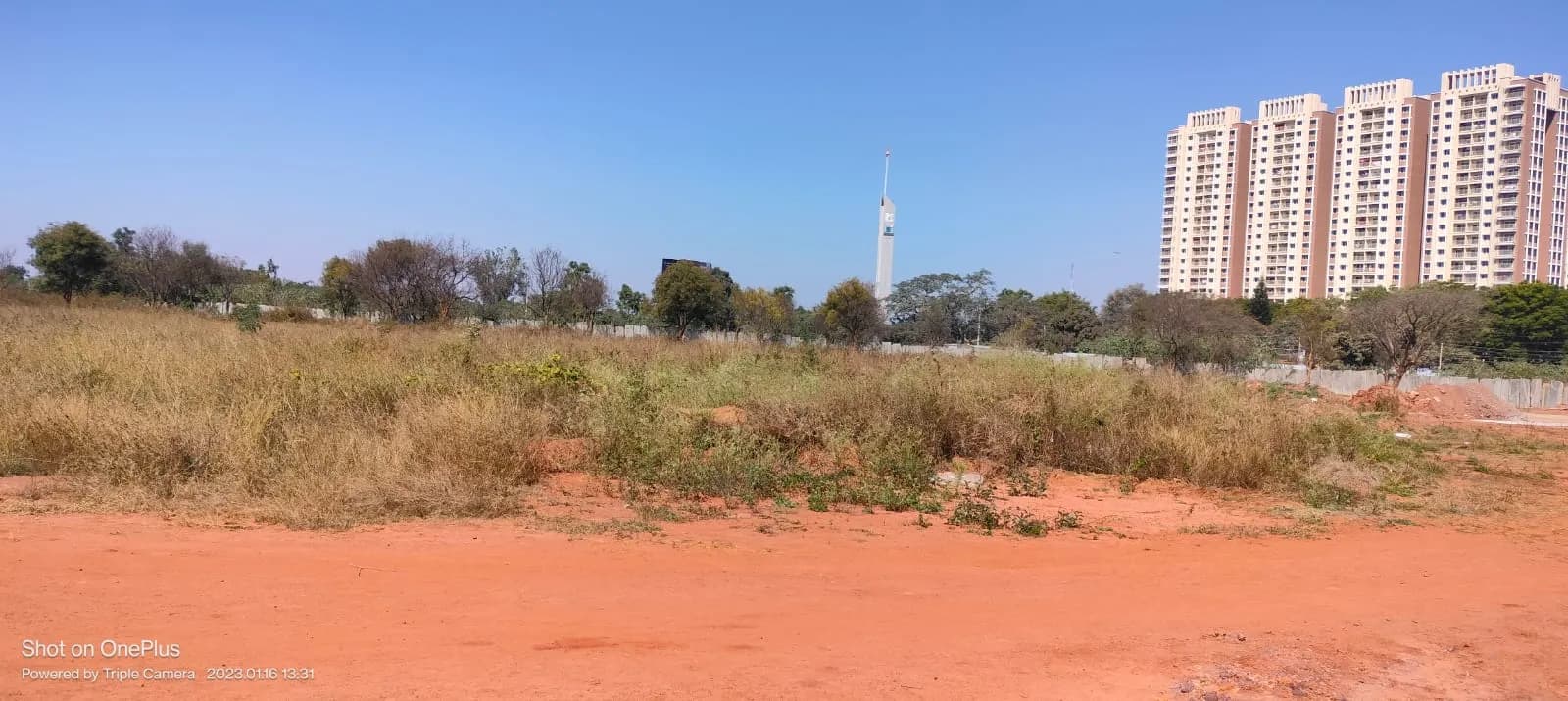

Site photo filed with Karnataka RERA Karnataka RERA filing · Source ↗ (opens in a new tab)
Brigade Calista at a glance
- Possession (RERA)Dec 2027Karnataka RERA
- Construction58% built · on pace for Nov 2028 11 mo after RERA dateRERA filing to 30 Sep 2026 (Phase 2); estimate from average pace
- RERA complaints (project)None listedKarnataka RERA · as on 22 Oct 2026
- Builder on-time record4 of 10 on time Mostly lateCompleted projects: OC date vs promised date
- Approvals filed8 of 9 on RERAKarnataka RERA uploads · 22 Oct 2026
- Nearest metroWhitefield (Kadugodi) · 7.75 kmstraight line · OpenStreetMap, 5 Oct 2026
- Airport driveapprox. 64 min at peak15.77 km straight line · estimate
- Nearest lakePrestige Tranquility Lake · 752 mFrom the RERA map point · OpenStreetMap, 5 Oct 2026
Project summary
Brigade Calista is a residential project by Brigade Enterprises Ltd in Bommenahalli, Bengaluru, registered with Karnataka RERA. The completion date on RERA is 31 Dec 2027. It is registered in 2 phases.
Not in the RERA record we collected yet: number of homes. This page fills in as the record is collected.
Facts collected on 22 Oct 2026 from public records — each linked to its source. Free for buyers. If you book through us, the builder pays us a commission.
Brigade Calista buyers’ group: join to ask for a group price
No one has joined yet. Be one of the first 10 buyers in this group — the founding members.
Join free. When enough buyers have joined, our agent partner asks Brigade Group for a group price — for example a lower price, an easier payment plan or waived charges. Nothing is promised: you see what the builder offers and book directly with the builder if you want to. Free for buyers. If you book through us, the builder pays us a commission.
- Gathering buyers
- Talking to the builder
- Group offer
- Group site visit
- Booking
0 buyers have joined · 0 committed
Committed buyers have confirmed their budget, home type and timeline with us on a call; builders negotiate with them. Joining is free and never obliges you to buy.
Join the Brigade Calista buyers’ groupHow group buying works
See it for yourself
Visit the site with our team, or get a call to clear your questions. Free, no obligation.
Key facts: home types, towers, land and possession
- Home types
- 1 BHK, 2 BHK, 3 BHK
- Carpet area
- 366 – 1,195 sq ft
- Towers
- 3
- Floors
- 18
- Total homes
- Not found in public records yet: total homes
- Land
- Not found in public records yet: land area
- Possession (RERA)
- Dec 2027
- Built (RERA update)
- Not found in public records yet: construction progress
Brigade Calista RERA number and registration details
- RERA number
- PRM/KA/RERA/1251/446/PR/030223/005683
- Registered on
- 3 Feb 2023
- Promised completion
- 31 Dec 2027
- Extended to
- No extension recorded
- RERA status
- New launch
- Homes booked
- Not found in public records yet: homes booked
- Price
- Not found in public records yet: price
- Project type
- Residential
2 RERA registrations (one per phase) are shown together on this page; dates above are the latest across phases.

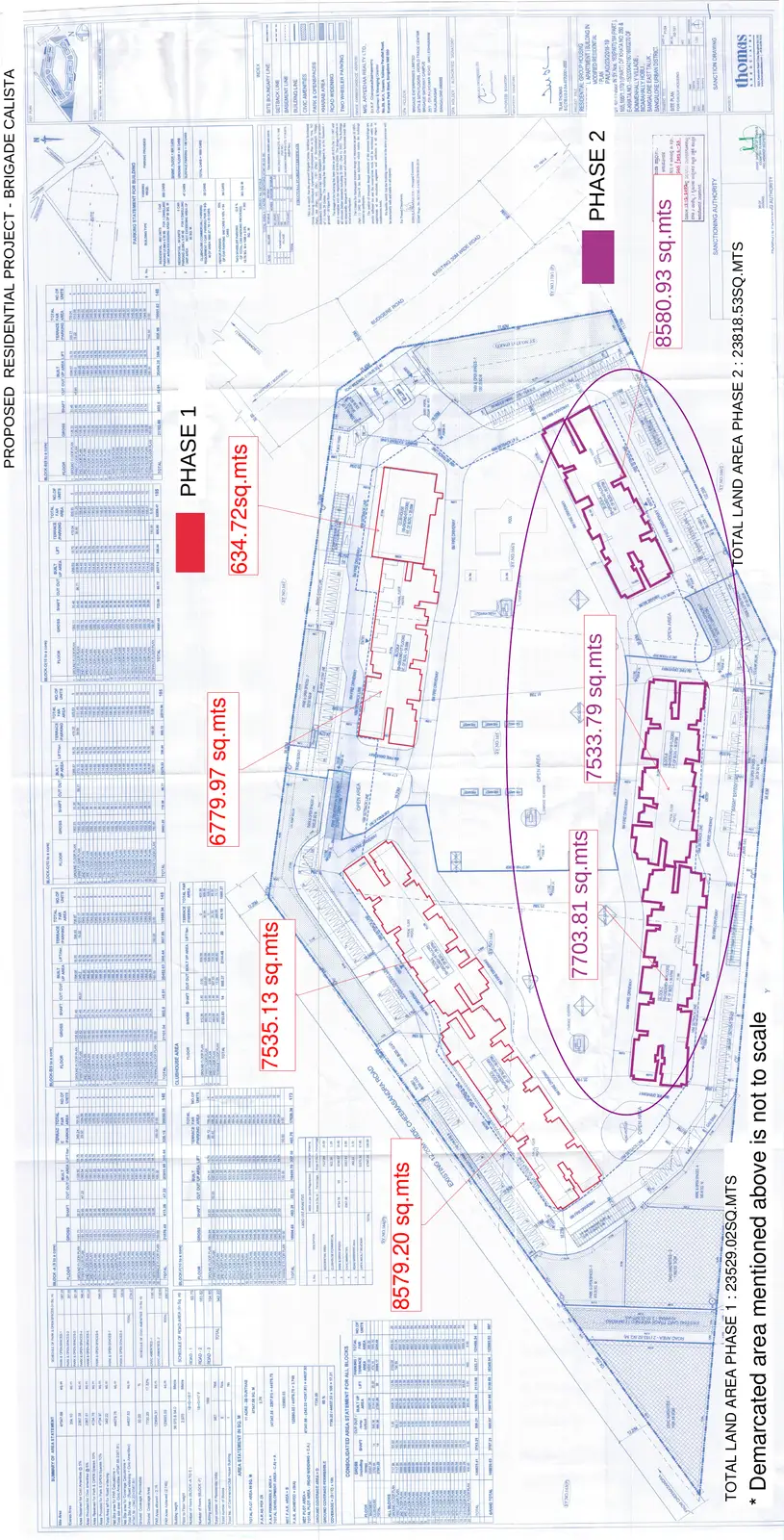

Phases and RERA numbers
| Phase | RERA number | Promised completion | Homes | Status | Source |
|---|---|---|---|---|---|
| Phase 1 | PRM/KA/RERA/1251/446/PR/030223/005683 | 30 Jun 2027 | — | Under construction | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Phase 2 | PRM/KA/RERA/1251/446/PR/220823/006195 | 31 Dec 2027 | 481 | New launch | Source (rera.karnataka.gov.in) (opens in a new tab) |
Towers and blocks (RERA filing)
| Tower | Phase | Floors | Basements | Homes |
|---|---|---|---|---|
| Tower A | Phase 2 | 18 | 1 | 148 |
| Tower B | Phase 2 | 18 | 1 | 148 |
| Tower C | Phase 2 | 18 | 1 | 185 |
A dash (—) means the filing did not state that value.
Summary in plain English
Brigade Calista is a residential project by Brigade Enterprises Ltd in Bengaluru East with 481 homes across 3 towers. The project has two phases, with Phase 1 set to complete on 30 June 2027 and Phase 2 on 31 December 2027. As of Q2 2026-27, construction is 58% complete.
Written by AI from the RERA record above on 22 Oct 2026. Every number in it was checked against that record; if anything differs, the record wins.
Open space, home loans, escrow and other details
- Open space
- Not found in public records yet: open space
- Water and power
- Water source filed with RERA: Others
- Home loans: approved banks
- Not found in public records yet: bank approvals
- Payment plans
- Not found in public records yet: payment plans
- Maintenance
- Not found in public records yet: maintenance
- Car parking
- Not found in public records yet: car parking charge
- Escrow bank (RERA) · Phase 1
- Not found in public records yet: escrow bank
- Escrow bank (RERA) · Phase 2
- KOTAK MAHINDRA BANK, Lavelle Road
Amenities
- Electricity
- Club House
- Swimming Pool
- Gym
Amenities and internal works as filed by the promoter with Karnataka RERA; we have not visited the site.
Brigade Calista location and address
- Address
- Sy No. 163(p), 165(p), 166/1 (p) & 170/1(p) , Bommenahalli Village, Bidarahalli Hobli, Hoskote Taluk (Now Bengaluru East Taluk) Bengaluru , Bengaluru East , Bengaluru Urban, Karnataka - 560049
- Village (RERA)
- Bommenahalli
- Locality
- Budigere CrossAlso known as Budigere
- PIN code
- 560049
- City
- Bengaluru
- State
- Karnataka
- Coordinates
- 13.06309, 77.73969
Distances to landmarks
Not found in public records yet: landmarksAbout Budigere Cross
Not found in public records yet: locality factsCommute times to tech parks and the airport
| To | Straight line | Peak-hour drive (estimate) |
|---|---|---|
| ITPL, Whitefield (main gate)Map point on OpenStreetMap (opens in a new tab) | 8.37 km | approx. 34 min |
| Manyata Tech ParkMap point on OpenStreetMap (opens in a new tab) | 12.98 km | approx. 53 min |
| Kempegowda International AirportMap point on OpenStreetMap (opens in a new tab) | 15.77 km | approx. 64 min |
| Outer Ring Road tech corridor (RMZ Ecospace, Bellandur)Map point on OpenStreetMap (opens in a new tab) | 16.68 km | approx. 68 min |
| KSR Bengaluru City railway station (Majestic)Map point on OpenStreetMap (opens in a new tab) | 20.61 km | approx. 83 min |
| Electronic City Phase 1Map point on OpenStreetMap (opens in a new tab) | 25.02 km | approx. 101 min |
How we calculate
Straight line: from the project’s map point on RERA to the destination’s point on OpenStreetMap.
Peak-hour drive is a rough estimate, not a route: straight line × 1.35 for the road network, at 20 km/h. Real times vary a lot with the route and the hour.
Sources:Source (openstreetmap.org) (opens in a new tab)How we calculate this
Schools and hospitals nearby
Within 2 km
- 5Schools and colleges4 schools, 1 colleges, 0 kindergartens
- 0Hospitals and clinics0 hospitals, 0 clinics
Nearest schools and colleges
- New Baldwin International Residential School · 1.18 km
- Swami Vivekananda College of Nursing · 1.83 km
Places as mapped on OpenStreetMap (amenity=school, college, kindergarten, university; hospital, clinic), counted within 2 km in a straight line of the RERA map point. Volunteers map these, so some places may be missing or closed. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Nearest metro station and railway
- Whitefield (Kadugodi) (ವೈಟ್ಫೀಲ್ಡ್ (ಕಾಡುಗೋಡಿ))Open now — nearest operating metro station7.75 km
- Hoodi Nearest railway station7.74 km
Straight-line distances from the RERA map point to the station points mapped on OpenStreetMap; status (open or under construction) as tagged there. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Lake and lake-buffer check
The nearest mapped lake is Prestige Tranquility Lake, 752 m from the project’s RERA map point.
The site boundary is not published as a shape, so its nearest edge can be closer than this point. Whether any building sits inside a lake buffer can only be checked on the approved plan.
- Prestige Tranquility Lake on OpenStreetMap (opens in a new tab) 752 m
- Bidarahalli Lake on OpenStreetMap (opens in a new tab) 1,458 m
- Manduru Lake on OpenStreetMap (opens in a new tab) 1,498 m
The buffer rule
Bengaluru’s lake buffer rule has changed over time: the National Green Tribunal ordered a 75 m buffer in May 2016; the Supreme Court set that order aside on 5 March 2019, leaving the 30 m buffer of the Revised Master Plan 2015. Check the current rule and the approved plan before relying on either number.
- LiveLaw: SC sets aside NGT order enlarging buffer zones (2019) (livelaw.in) (opens in a new tab)
- Citizen Matters: Shrinking lake buffers (citizenmatters.in) (opens in a new tab)
Shortest distance from the RERA map point to the mapped water edge (OpenStreetMap water polygons tagged lake or reservoir, or named lake/kere/tank). Mapped shorelines can differ from the revenue-record boundary of a lake. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Sources:Source (openstreetmap.org) (opens in a new tab)Source (livelaw.in) (opens in a new tab)Source (citizenmatters.in) (opens in a new tab)How we calculate this
Satellite time-lapse of the site
Satellite photos load when you scroll to them.
Photos from Esri World Imagery Wayback, centred on the project’s map point; dates are the capture dates in Esri’s metadata. Loaded from Esri when you scroll here.
Sources:Source (livingatlas.arcgis.com) (opens in a new tab)
Brigade Calista floor plans, brochure and elevations
Documents the builder uploaded to Karnataka RERA, shown as filed. Tap a page to see it full size; the full PDF opens on the RERA website.
Brochure4 pages

Phase 2: BrochureFull PDF on RERA

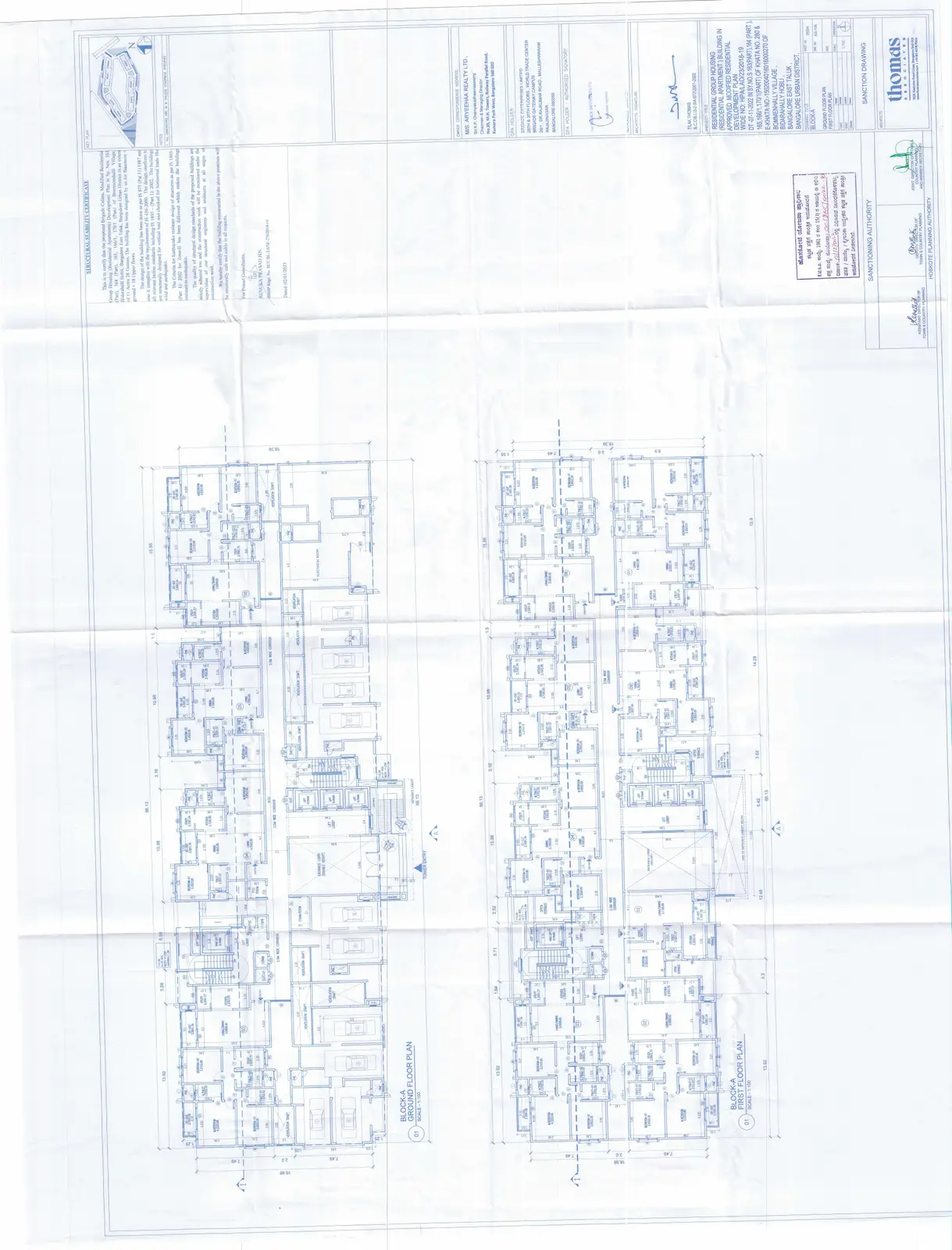

Floor plans7 pages

Phase 2: Existing Layout PlanFull PDF on RERA

Elevations2 pages

Phase 2: Brigade Calista - Block A, B, C - ElevationFiled 17 Aug 2023 · Full PDF on RERA
Approved layout plan3 files

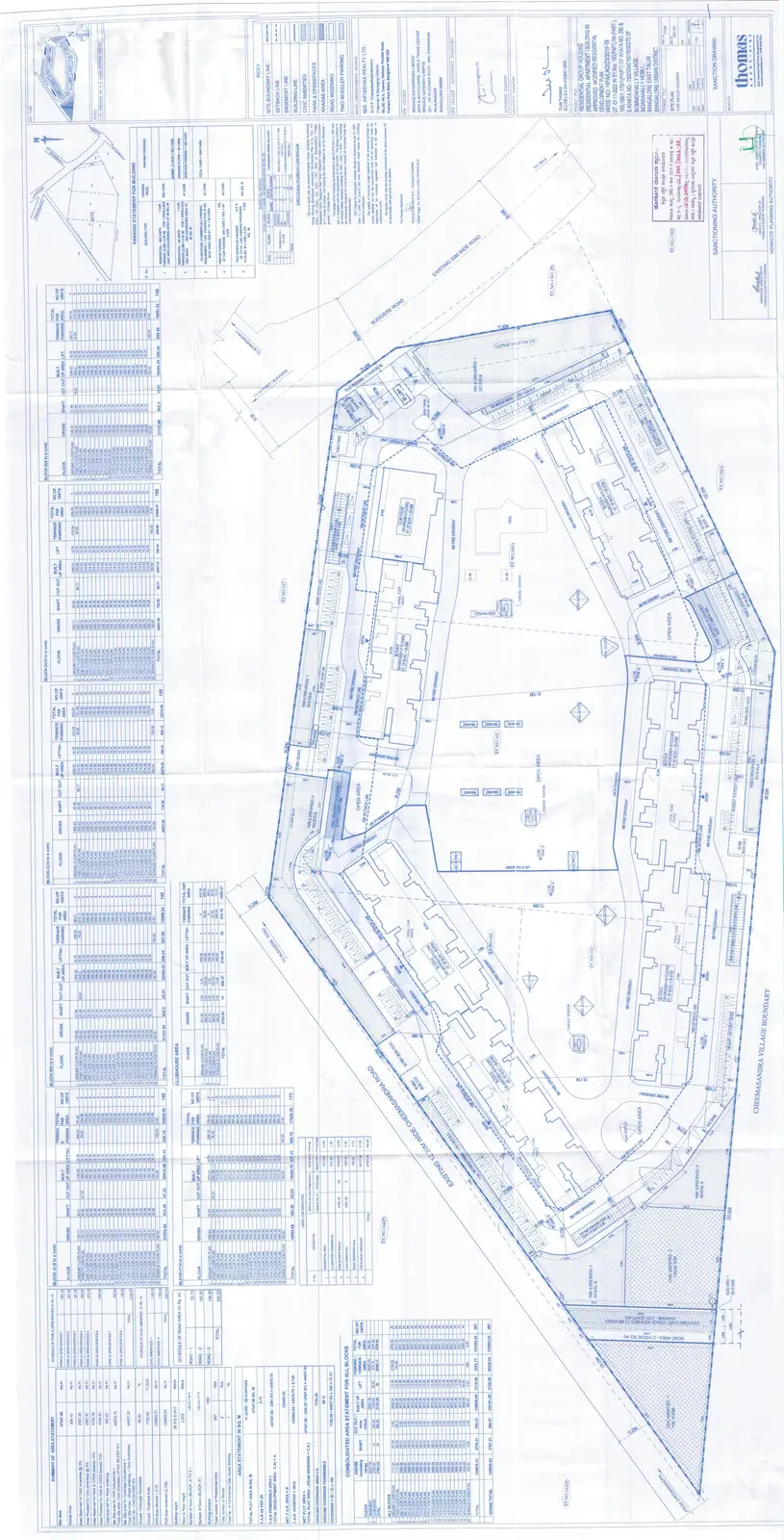

Phase 2: Approved Layout PlanFull PDF on RERA
Phase 2: Brigade Calista - Phase 2- Area Demarcation Blown up.pdfFull PDF on RERA
Phase 2: Village Map Demarcation Proposed Site.pdfFull PDF on RERA

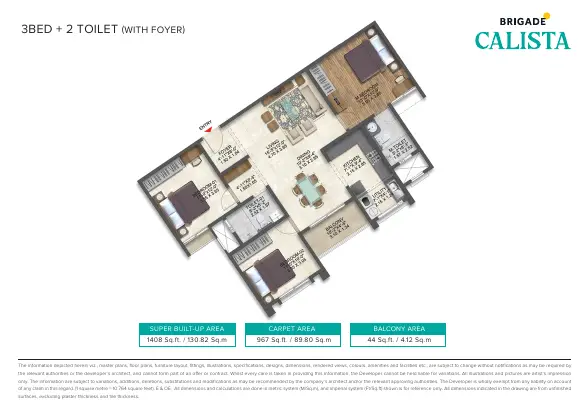

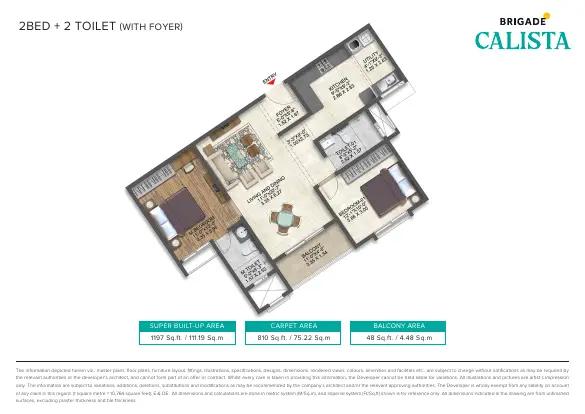

| Home type | Carpet area | Homes |
|---|---|---|
| 1 bedroom + 1 toilet | 366 – 549 sq ft | 3 |
| 1 bedroom + 1 toilet + study | 635 sq ft | 1 |
| 1 BHK | 366 – 635 sq ft | 4 |
| 2 bedroom + 2 toilet | 775 – 818 sq ft | 111 |
| 2 BHK | 775 – 818 sq ft | 111 |
| 3 bedroom + 2 toilet | 915 – 969 sq ft | 144 |
| 3 bedroom + 3 toilet | 1,033 – 1,109 sq ft | 110 |
| 3 bedroom + 3 toilet study | 1,152 – 1,195 sq ft | 112 |
| 3 BHK | 915 – 1,195 sq ft | 366 |
Home types, counts and carpet areas as filed with Karnataka RERA (carpet area, not super built-up).
We have not collected floor-plan drawings; the builder’s sales team can share them.
Brigade Calista possession date and construction status
Timeline
- 3 Feb 2023Phase 1: Registered with Karnataka RERA
- 22 Aug 2023Phase 2: Registered with Karnataka RERA
- 1 Oct 2023Phase 2: Project start date given to RERA
- 30 Jun 2027Phase 1: Completion date given at registration
- 31 Dec 2027Phase 2: Completion date given at registration
Construction pace from RERA quarterly filings (Phase 2)
At the average pace so far, construction would reach 100% around Nov 2028 — about 11 months after the completion date on RERA (31 Dec 2027).
At the pace between the 4 quarterly filings we have (33% → 58% in 9 months), it would be around Jan 2028 — the same month as the RERA date.
This project has 2 RERA registrations; the chart uses Phase 2, the one with the most quarterly filings.
- Filed on RERA
- Average pace since start
- Pace between filings (and 0% assumed at the start date)
- RERA completion date
Quarterly filings
| Quarter | Filed on | Built | Homes booked |
|---|---|---|---|
| Q2 2026-27to 30 Sep 2026 | 15 Oct 2026 | 58% | 481 of 481 |
| Q1 2026-27to 30 Jun 2026 | 14 Jul 2026 | 50% | 481 of 481 |
| Q4 2025-26to 31 Mar 2026 | 15 Apr 2026 | 42% | 481 of 481 |
| Q3 2025-26to 31 Dec 2025 | 14 Jan 2026 | 33% | 481 of 481 |
How we calculate
Average pace = % built ÷ months since the start date in the RERA record. Here: 58% ÷ 36 months (1 Oct 2023 to 30 Sep 2026) = 1.6% a month.
Estimated finish = latest filing date + (100 − % built) ÷ pace = 30 Sep 2026 + 42 ÷ 1.6 = 26 months → Nov 2028. This is an estimate, not a date from the builder or RERA.
Pace between filings = (58% − 33%) ÷ 9 months = 2.8% a month.
A straight line is a simplification: the builder reports one overall %, which mixes excavation, structure and finishing, and work rarely moves at a constant speed. The % values are the promoter’s own figures filed with RERA, not checked by us.
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
Approvals and documents checklist
16 rows: approvals. Scroll inside the table to see them all.
| Approval | Authority | Source |
|---|---|---|
| Building plan (Phase 2) | Local Planing Authority · No. HPA/CC/265/2022-23 · dated 2022-12-12 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Land conversion (Phase 2) | Special Deputy Commissioner · No. B.DIS.ALN.CR(S)17/92-93 · dated 1992-11-10 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Commencement Certificate (Phase 2) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Electricity Permission Letter (Phase 2) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Water Permission Letter (Phase 2) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Layout Plan (Phase 2) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Building/Plotting Plan (Phase 2) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Section Of Building/Infrastructure Plan of Plotting (Phase 2) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Change of Land Use (Phase 2) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Conversion Certificate under section 95 of the KLR Act 1964 (Phase 2) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| ESCOM/Electricity (Phase 2) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KWSSB/Water (Phase 2) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Fire Force Department (Phase 2) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Airport Authority of India (Phase 2) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KSPCB (Phase 2) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| SEIAA (Phase 2) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
Documents uploaded to RERA (Phase 2)
- Building or layout plan · Approved drawings from the planning authorityFiled on RERA ✓ — Local Planing Authority · No. HPA/CC/265/2022-23 · dated 12 Dec 2022
- Commencement certificate · Permission to start buildingFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Environment clearance · SEIAA KarnatakaFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Fire NOC · Karnataka Fire and Emergency ServicesFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Pollution board consent · KSPCBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Water and sewerage · BWSSBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Electricity · BESCOMFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Height clearance · Airports Authority of IndiaFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Occupancy certificate (OC) · Issued only when the building is finishedNot on RERA yet — expected at completion
From the documents the promoter uploaded to Karnataka RERA, collected 22 Oct 2026. “Filed” means a document is on RERA — we have not checked its contents or validity. Not every approval applies to every project (for example, smaller projects may not need an environment clearance). Each phase is registered separately; this list is for the phase named above. The project page on RERA lists each upload.
Brigade Calista RERA complaints
No complaints listed on Karnataka RERA for these registrations as on Source (rera.karnataka.gov.in) (opens in a new tab)
Court and consumer cases
We list case numbers, courts and outcomes only — never names of private individuals.
About Brigade Group
- Founded
- 1986
- Headquarters
- Bengaluru
- Bengaluru projects
- 16
- Delivered on time
- 4 of 10
- RERA complaints
- 44
- Court cases listed
- 3
Brigade Enterprises Limited (CIN L85110KA1995PLC019126) is a listed Bengaluru developer, founded in 1986 and based at the World Trade Center in Malleswaram-Rajajinagar. Karnataka RERA records show its older Bengaluru projects receiving occupancy certificates between 2018 and 2024, some before the original RERA date and several months to about 19 months after it (within extended deadlines). As of 4 October 2026, RERA lists 44 complaints across Brigade Enterprises Ltd projects.
Brigade Group’s full recordBrigade Group delivery record
- 28Projects in Bengaluru on RERA32 approved registrations under Brigade Enterprises Ltd in Bengaluru Urban and Rural. Source (rera.karnataka.gov.in) (opens in a new tab)
- 15,990Homes and plots registeredAs stated in 31 of the 32 registrations.
- 44RERA complaints5 open, 39 disposed. as on Source (rera.karnataka.gov.in) (opens in a new tab)
- 2.8Complaints per 1,000 homes and plots44 complaints ÷ 15,990 homes and plots in its 32 registrations on Karnataka RERA in Bengaluru.
- 5Completion filed on RERARegistrations where the promoter applied to RERA for completion; 2 with an occupancy certificate on RERA.
- 0 of 5Filed by the date given at registrationMedian gap 9.4 months (on-time ones count as 0). The completion application can come after handover, so this is an upper bound on lateness.
- 3Court cases listedFound in public court records; see the list on the builder’s page.
What the complaints are about
44 complaint subjects as written on RERA, as on . Each subject is sorted into one group by keywords (first match wins: delay, refund, registration, quality, litigation, association); one complaint often raises several issues. Source (rera.karnataka.gov.in) (opens in a new tab)
Completion filed on RERA
| Project | Date at registration | Completion filed | Gap |
|---|---|---|---|
| Brigade Northridge NeoOC on RERA | 31 Mar 2022extended to 30 Sep 2022 | 20 May 2026 | 50 months after |
| Brigade BricklaneOC on RERA | 31 Dec 2021extended to 31 Mar 2023 | 16 May 2026 | 53 months after |
| Brigade Oasis - Phase 1 | 30 Jun 2025extended to 30 Jun 2026 | 13 Apr 2026 | 9 months after |
| Brigade Oasis - Phase 2 | 30 Jun 2025extended to 30 Jun 2026 | 13 Apr 2026 | 9 months after |
| Brigade Oasis - Phase 3 | 30 Jun 2025extended to 30 Jun 2026 | 13 Apr 2026 | 9 months after |
Measured against the completion date given at registration; many projects had RERA extensions (including the COVID-period extension), shown under the date.
Handovers we checked by hand
| Project | Promised (at registration) | OC | Result | Source |
|---|---|---|---|---|
| Plumeria Phase 1 at Brigade Meadows | 31 Jul 2018 | 5 Jul 2018 | On time | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Brigade Lakefront - Crimson | 30 Jun 2019 | 28 Dec 2018 | On time | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Plumeria Lifestyle at Brigade Meadows | 30 Sep 2020 | 30 Mar 2020 | On time | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Brigade Woods | 31 Dec 2020 | 1 Feb 2022 | 13 months late | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Brigade Parkside North | 31 Mar 2021 | 15 Mar 2022 | 11 months late | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Brigade Parkside East | 31 Dec 2020 | 9 May 2022 | 16 months late | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Brigade Northridge Neo | 31 Mar 2022 | 13 May 2022 | 1 months late | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Brigade 7 Gardens | 31 Oct 2020 | 4 Jun 2022 | 19 months late | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Brigade Bricklane | 31 Dec 2021 | 10 Oct 2022 | 9 months late | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Brigade Gem | 31 Aug 2024 | 22 Jul 2024 | On time | Source (rera.karnataka.gov.in) (opens in a new tab) |
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)Source (indiankanoon.org) (opens in a new tab)Source (indiankanoon.org) (opens in a new tab)Source (livelaw.in) (opens in a new tab)How we calculate this
What’s changed since Dec 2022

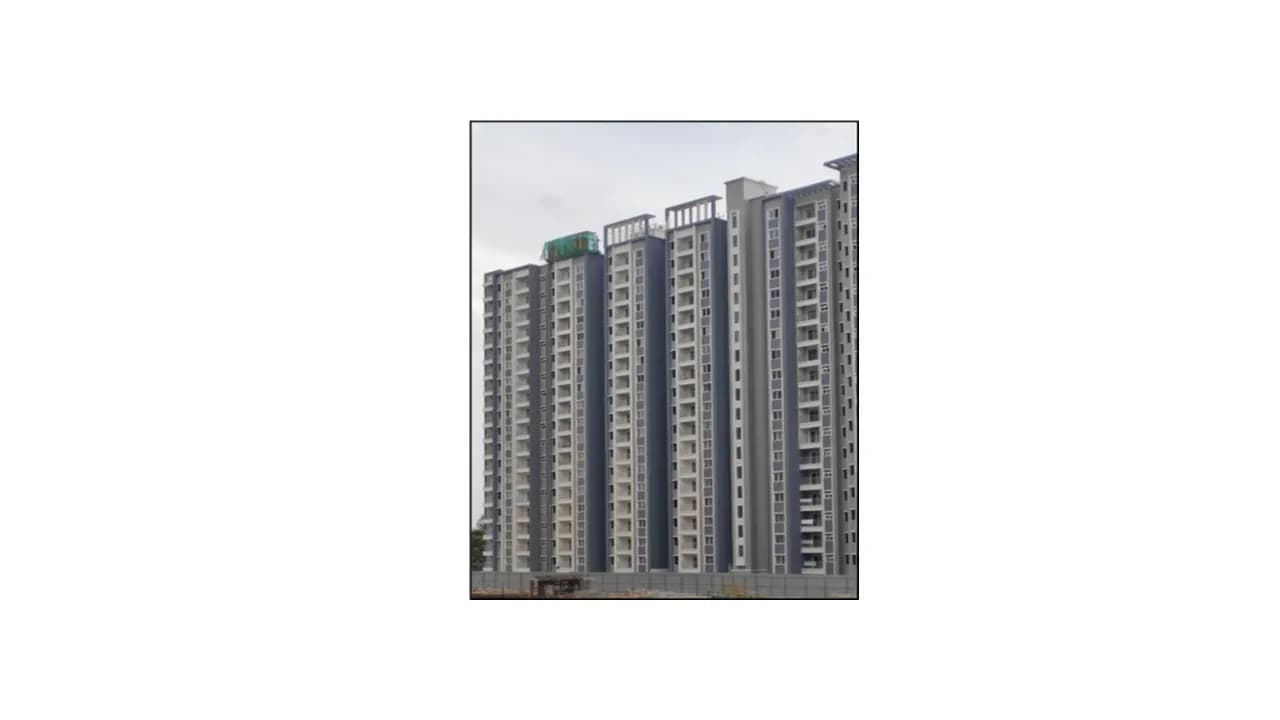

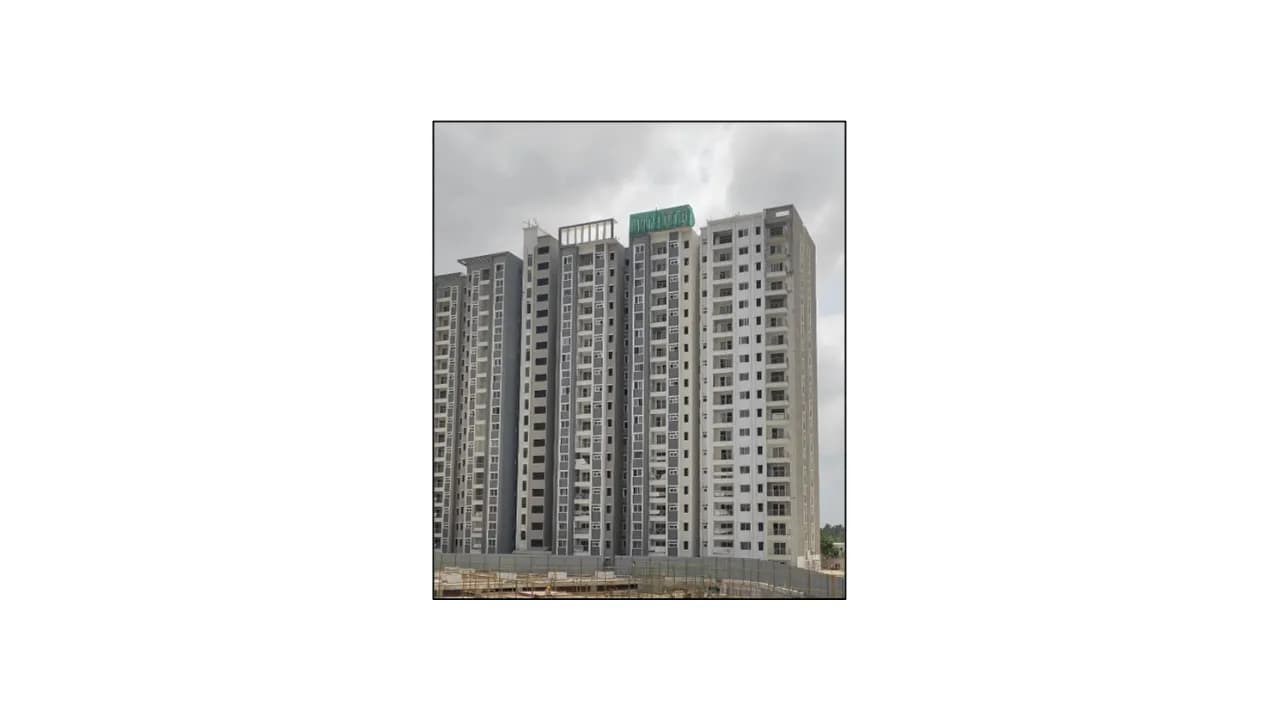

- 15 Oct 2026Phase 2: Quarterly update filed for Q2 2026-27: 58% built, 481 of 481 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 15 Jul 2026Phase 1: Quarterly update filed for Q1 2026-27: 77% built, 506 of 506 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 14 Jul 2026Phase 2: Quarterly update filed for Q1 2026-27: 50% built, 481 of 481 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 15 Apr 2026Phase 1: Quarterly update filed for Q4 2025-26: 76% built, 506 of 506 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 15 Apr 2026Phase 2: Quarterly update filed for Q4 2025-26: 42% built, 481 of 481 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 14 Jan 2026Phase 1: Quarterly update filed for Q3 2025-26: 70% built, 504 of 506 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 14 Jan 2026Phase 2: Quarterly update filed for Q3 2025-26: 33% built, 481 of 481 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 1 Oct 2023Phase 2: Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
- 22 Aug 2023Phase 2: Registered with Karnataka RERA (PRM/KA/RERA/1251/446/PR/220823/006195); completion date 31 Dec 2027 Source (rera.karnataka.gov.in) (opens in a new tab)
- 3 Feb 2023Phase 1: Registered with Karnataka RERA (PRM/KA/RERA/1251/446/PR/030223/005683); completion date 30 Jun 2027 Source (rera.karnataka.gov.in) (opens in a new tab)
- 12 Dec 2022Phase 2: Building plan approved by Local Planing Authority (No. HPA/CC/265/2022-23) Source (rera.karnataka.gov.in) (opens in a new tab)
Newest first. No extension of the completion date is recorded on RERA. When the RERA crawl sees a new filing, complaint or extension, it is added here with its date.
Home loan EMI calculator
- Monthly EMI
- —
- Down payment
- —
- Loan amount
- —
- Total interest
- —
A calculation only, from the numbers you enter — not a loan offer.
All-in cost: GST, registration and other charges
The calculator loads when you scroll to it.
Assumptions
- Base price: the builder’s price is not published in a form we could collect — enter it from the cost sheet.
- GST 5% on the base price and charges — the usual rate for an under-construction home that is not “affordable housing” (1%).
- Stamp duty about 5.6% and registration 2% — the Karnataka rule (registration was raised from 1% to 2% on 31 Aug 2025). Calculated on the agreement value.
- Car parking, other charges and the maintenance deposit are not in the public record we collect; enter them from the builder’s cost sheet.
- Loan on the agreement value (banks usually lend up to 75–90%); EMI is the standard reducing-balance formula. Example rate only — use your bank’s quote.
Brigade Calista FAQs
When will Brigade Calista be completed?
Phase 1 is scheduled for completion on 30 June 2027, and Phase 2 on 31 December 2027, according to the RERA record.
How many homes are in Brigade Calista?
Phase 2 has 481 homes across 3 towers, each up to 18 floors. The RERA record does not specify the home count for Phase 1.
What home types are available in Brigade Calista?
Phase 2 offers 1 BHK, 2 BHK and 3 BHK homes with carpet areas ranging from 366 sq ft to 1,195 sq ft.
What is the carpet area range for Brigade Calista homes?
Carpet areas range from 366 sq ft for 1 BHK homes to 1,195 sq ft for 3 BHK homes in Phase 2.
How many homes have been booked in Brigade Calista?
As of Q2 2026-27, all 481 homes in Phase 2 are in the booking table.
What is the construction progress at Brigade Calista?
As of Q2 2026-27, construction is 58% complete.
What are the RERA registration numbers for Brigade Calista?
Phase 1 is registered as PRM/KA/RERA/1251/446/PR/030223/005683 and Phase 2 as PRM/KA/RERA/1251/446/PR/220823/006195.
Are there any RERA complaints on Brigade Calista?
No RERA complaints have been filed on this project.
Where is Brigade Calista located?
The project is in Bengaluru East taluk, Bengaluru Urban district. The RERA record does not provide the locality name or PIN code.
What is Brigade Enterprises Ltd's record with RERA?
Brigade Enterprises Ltd has 44 RERA complaints across all its projects and 38 projects registered in the Bengaluru RERA records.
Written by AI from the RERA record above on 22 Oct 2026. Answers use only that record; check them against the source before you decide.
Questions about Brigade Calista
No questions published yet. Ask the first one: you get an instant answer from this page’s public record, and our team follows up on anything the record does not show.
Bought a home from Brigade Group? Review the builder.
Reviews of Brigade Group by verified buyers
No verified reviews of Brigade Group yet. If you bought a home from them, your review helps other buyers.
How reviews work: only buyers and owners can review; we confirm each purchase by phone before publishing, publish positive and negative reviews alike, never accept payment for reviews, and the builder may reply.
Similar projects within 5 km
| Project | Distance | Homes | Possession (RERA) | Built | Complaints | Price |
|---|---|---|---|---|---|---|
| Aadya HeightsWhitewinds Constructions Private Limited | 0.6 km | 98 | Dec 2025 | 100% | 0 | Not collected |
| NVT Under The Open SkyNVT Quality Lifestyle Estate LLP | 0.6 km | 74 | Mar 2029 | 92% | 0 | Not collected |
| Sattva BlissSattva Resi Private Limited | 0.7 km | 338 | Aug 2027 | 100% | 0 | Not collected |
| Chaithanya SANKHYAChaithanya Projects Private Limited | 0.8 km | 44 | Nov 2028 | 92% | 0 | Not collected |
| Sakura BlossomSakura Blossom | 1 km | 56 | Jul 2027 | — | 0 | Not collected |
| Urbanest Elite 35Urbanest Realty | 1.2 km | 35 | Dec 2026 | 100% | 0 | Not collected |
Projects of the same kind within 5 km in a straight line of this project’s RERA map point, nearest first. % built is the promoter’s latest quarterly figure on RERA (shown for single-registration projects); prices are from the builder’s own website where we found one.
Sources and last checked dates
Collected on 22 Oct 2026 by AI research agents reading public pages. Facts are written in our own words. Not found yet: price; court cases; landmarks; specifications; news.
How to check on RERA: On rera.karnataka.gov.in/viewAllProjects, type the registration number in 'Registration No', press Search, then click the 'View Project Details' icon. Complaints open from the 'Complaints / Litigation' icon in the same row. Registration numbers: PRM/KA/RERA/1251/446/PR/030223/005683, PRM/KA/RERA/1251/446/PR/220823/006195.
- RERA record last checked: 22 Oct 2026
- Last change in the record (registration, quarterly filing or complaint): 22 Oct 2026
How this page is made: software builds it from public records (Karnataka RERA filings, OpenStreetMap, the builder’s own website). AI is used only to read filings into fields and to write the plain-English summary and FAQ answers, which are checked against the record. Facts are checked automatically against the RERA filing. Methodology · How we earn · Report an error
More new projects in Budigere Cross
Bommenahalli, Budigere CrossUnder constructionRERA registeredBuyers’ group openAadya Heights
by Whitewinds Constructions
Price: Price on requestGet brochure & price →
- 2 BHK, 3 BHK
- 917 – 1,080 sq ft
- Dec 2025
RERA not updated since promised Dec 2025 · 98 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Aadya Heights
Nimbekalpura, Budigere CrossUnder constructionRERA registeredBuyers’ group openNVT Under The Open Sky
by NVT Quality Lifestyle Estate
Price: Price on requestGet brochure & price →
- 4 BHK, Plot
- 2,205 – 3,860 sq ft
- Mar 2029
74 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for NVT Under The Open Sky
Bommenahalli, Budigere CrossUnder constructionRERA registeredBuyers’ group openSattva Bliss
by Sattva Resi
Price: Price on requestGet brochure & price →
- 1 BHK, 2 BHK, 3 BHK
- 355 – 645 sq ft
- Aug 2027
338 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Sattva Bliss
