Brigade Eternia

1, 2, 3 & 4 BHK apartments by Brigade Group · Yelahanka, Bengaluru

Yelahanka, BengaluruOpen on Google Maps (opens in a new tab)

  • Under construction
  • RERA registered
  • apartments

by Brigade Group

Listed price: ₹1.06 Cr – ₹4.79 Cr

as on · Source (housiey.com) (opens in a new tab)

Get today’s price list

Latest price for Brigade Eternia

Builders change prices often and rarely publish them. Tell us how to reach you and we’ll send you the current price list.

Free for buyers. If you book through us, the builder pays us a commission. How we earn

Project summary

Brigade Eternia is a Brigade Enterprises apartment project in Yelahanka, North Bengaluru, registered with Karnataka RERA on 7 March 2025 (PRM/KA/RERA/1251/309/PR/070325/007559) with a promised completion date of 31 March 2030. It has 1,124 homes in 12 towers of 13 or 14 floors over two basements, mostly 3 BHK, on a site the builder puts at 14.65 acres. The builder reported 29% completion and 687 units booked for the April–June 2026 quarter, and the RERA record shows one complaint on this project, since disposed.

Facts collected on 18 Oct 2026 from public records — each linked to its source. Free for buyers. If you book through us, the builder pays us a commission.

Brigade Eternia buyers’ group: join to ask for a group price

No one has joined yet. Be one of the first 10 buyers in this group — the founding members.

Join free. When enough buyers have joined, our agent partner asks Brigade Group for a group price — for example a lower price, an easier payment plan or waived charges. Nothing is promised: you see what the builder offers and book directly with the builder if you want to. Free for buyers. If you book through us, the builder pays us a commission.

  1. Gathering buyers
  2. Talking to the builder
  3. Group offer
  4. Group site visit
  5. Booking

0 buyers have joined · 0 committed

Committed buyers have confirmed their budget, home type and timeline with us on a call; builders negotiate with them. Joining is free and never obliges you to buy.

Join the Brigade Eternia buyers’ groupHow group buying works

See it for yourself

Visit the site with our team, or get a call to clear your questions. Free, no obligation.

Key facts: home types, towers, land and possession

Updated on 18 Oct 2026
Home types
1 BHK, 2 BHK, 3 BHK, 4 BHK
Carpet area
441 – 1,884 sq ft
Towers
12
Floors
14
Total homes
1,124
Land
12.26 acres
Possession (RERA)
Mar 2030
Built (RERA update)
35%

Brigade Eternia RERA number and registration details

RERA number
PRM/KA/RERA/1251/309/PR/070325/007559
Registered on
7 Mar 2025
Promised completion
31 Mar 2030
Extended to
No extension recorded
RERA status
New launch
Homes booked
769 of 1,124 as on
Price
₹1.06 Cr – ₹4.79 Cr as on
Project type
Apartments

Towers and blocks (RERA filing)

12 rows: towers. Scroll inside the table to see them all.

TowerFloorsBasementsHomes
Tower A132126
Tower B132107
Tower C132117
Tower D132126
Tower E14290
Tower F14290
Tower G14290
Tower H14252
Tower I14256
Tower J14290
Tower K14290
Tower L14290

A dash (—) means the filing did not state that value.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Brigade Eternia price list

From the builder’s website, as on 4 Oct 2026
Home typeSizePrice₹ per sq ftSource
1 BHK—unknownFrom ₹1.13 Cronwards—Source (brigadegroup.com) (opens in a new tab)
2 BHK—unknownFrom ₹2.11 Cronwards—Source (brigadegroup.com) (opens in a new tab)
3 BHK444 – 1,883 sq ftcarpetOn requestonwards—Source (brigadegroup.com) (opens in a new tab)
4 BHK—unknownFrom ₹4.45 Cronwards—Source (brigadegroup.com) (opens in a new tab)

Government Charges, Other Charges and Taxes Applicable

As published by the builder on the date shown — not an offer, and not checked with the builder. Check whether the size is carpet or super built-up area before comparing.

Sources:Source (brigadegroup.com) (opens in a new tab)

Price per sq ft vs projects within 5 km

As on 4 Oct 2026

The builder’s published prices work out to about ₹21,500 – ₹27,700 per sq ft of carpet area.

Home typeBuilder priceCarpet area (RERA)₹ per sq ft carpet
1 BHKfrom ₹1.13 Crseen 4 Oct 2026441 – 517 sq ft₹21,900 – ₹25,600
2 BHKfrom ₹2.11 Crseen 4 Oct 2026763 – 980 sq ft₹21,500 – ₹27,700
4 BHKfrom ₹4.45 Crseen 4 Oct 20261,718 – 1,884 sq ft₹23,600 – ₹25,900

Worked out as the builder’s “from” price ÷ the largest and smallest carpet area RERA lists for that home type — we don’t know which unit the starting price is for. Builders usually say taxes and other charges are extra. Builder price list (brigadegroup.com) (opens in a new tab) RERA carpet areas (rera.karnataka.gov.in) (opens in a new tab)

Sources:Source (brigadegroup.com) (opens in a new tab)Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this

Price history

As on 4 Oct 2026

One snapshot so far: the builder’s “onwards” prices seen on 4 Oct 2026. Each new check of the builder’s website adds a dated point here, so rises and offers show up with their dates.

0₹2 Cr₹4 Cr₹6 CrOct 26NovDecJan 27FebMarAprMayJunJulAugSepLater checks will appear here1 BHK ₹1.13 Cr2 BHK ₹2.11 Cr4 BHK ₹4.45 Cr
Seen onWherePrices
4 Oct 2026Builder’s website Source (brigadegroup.com) (opens in a new tab)1 BHK from ₹1.13 Cr · 2 BHK from ₹2.11 Cr · 4 BHK from ₹4.45 Cr
4 Oct 2026housiey.com Source (housiey.com) (opens in a new tab)₹1.06 Cr – ₹4.79 Cr

Sources:Source (brigadegroup.com) (opens in a new tab)Source (housiey.com) (opens in a new tab)

Summary in plain English

Brigade Eternia is a residential project by Brigade Enterprises Ltd in Yelahanka, Bengaluru North. The project has 1,124 homes across 12 towers and is registered with Karnataka RERA with a completion date of 31 March 2030.

Written by AI from the RERA record above on 18 Oct 2026. Every number in it was checked against that record; if anything differs, the record wins.

Open space, home loans, escrow and other details

Open space
74.4% of land
Water and power
The RERA record names private tankers as the water source; it also shows a BWSSB water and sewerage NOC and a BESCOM electricity NOC as approved. Power backup details were not found.
Home loans: approved banks
State Bank of India, HDFC Bank, ICICI Bank, Axis Bank, Kotak Mahindra Bank, Bank of Baroda, Bank of India, Union Bank of India, Central Bank of India, Citibank
Payment plans
  • Construction-linked — Payments are due in slabs as construction progresses; the listing says home loans up to 90% are possible and the minimum down payment is about ₹11 lakh including taxes Source (housiey.com) (opens in a new tab)
Maintenance
Not found in public records yet: maintenance
Car parking
Not found in public records yet: car parking charge
Escrow bank (RERA)
KOTAK MAHINDRA BANK, Lavelle Road, Bangalore
Building plan (RERA)
BBMP - Bruhat Bengaluru Mahanagara Palike · No. BBMP/Addl.Dir/JDNORTH/0102/2024-25 · dated 4 Mar 2025
Project cost declared to RERA
₹1995 Cr
Monthly maintenance estimate, 3 BHK (listing shows ₹9,700–₹11,900; lower end)
₹9,700
Monthly maintenance estimate, 4.5 BHK (listing shows ₹16,300–₹17,600; lower end)
₹16,300
Minimum down payment including taxes (listing)
₹11 L

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)Source (housiey.com) (opens in a new tab)

Amenities

  • Clubhouse (about 35,000 sq ft)
  • Swimming pool
  • Gym
  • Badminton courts
  • Squash court
  • Table tennis
  • Indoor games
  • Multipurpose hall
  • Kids' play area
  • Central courtyard
  • Lakeside park
  • Landscaped gardens

As listed by the builder; we have not visited the site.

Sources:Source (brigadegroup.com) (opens in a new tab)

Specifications and materials

Building form12 towers: towers A to D have 13 floors, towers E to L have 14 floors, all over 2 basements and a ground floorSource (rera.karnataka.gov.in) (opens in a new tab)
Land and built-up area (RERA record)Total land area 49,622 sq m, of which 12,705 sq m is covered and 36,917 sq m is open; total built-up area 258,993 sq m; total carpet area 123,463 sq m; FAR sanctioned 3.23Source (rera.karnataka.gov.in) (opens in a new tab)
Parking (RERA record)1,512 parking spaces: 1,381 covered and 131 openSource (rera.karnataka.gov.in) (opens in a new tab)
Lifts and layoutListing site reports 4 lifts and 5 staircases per floor and about 9 flats per floorSource (housiey.com) (opens in a new tab)
FlooringVitrified tiles (as listed by a listing site)Source (housiey.com) (opens in a new tab)
KitchenGranite platform with stainless steel sink (as listed by a listing site)Source (housiey.com) (opens in a new tab)
SecurityCCTV cameras (as listed by a listing site)Source (housiey.com) (opens in a new tab)
RERA project accountThe project's designated (escrow) accounts under RERA are with Kotak Mahindra Bank, Lavelle Road branch, BengaluruSource (rera.karnataka.gov.in) (opens in a new tab)
Open area basisopenSpacePct (74.4) is computed as RERA 'total open area' 36,917 sq m divided by total land area 49,622 sq m; it counts all land not covered by buildings, including roads and drivewaysSource (rera.karnataka.gov.in) (opens in a new tab)

Brigade Eternia location and address

Address
Survey Nos. 152 (parts) and 153 (part), Yelahanka Village, Yelahanka Hobli, Bengaluru North Taluk, Bengaluru 560064; Doddaballapura Road (SH-9) on the north side, Allasandra Lake on the south side
Village (RERA)
Yelahanka
Locality
Yelahanka
PIN code
560064
City
Bengaluru
State
Karnataka
Coordinates
13.09634, 77.59290

Distances to landmarks

  • The Galleria Mall, YelahankaMall0.3 km
  • Chrysalis High School, Yelahanka New TownSchool0.3 km
  • Bagmane Sierra Business District (under construction)Work0.8 km
  • Yelahanka metro station (Blue Line, under construction)Metro1 km
  • Navachethana Hospital, Yelahanka New TownHospital1.3 km
  • Embassy Business HubWork1.8 km
  • CyteCare Hospital, Bellary RoadHospital3 km
  • Manyata Tech ParkWork6.2 km
  • Kempegowda International AirportAirport16.8 km

Straight-line distances (Straight-line (haversine) distance from the project coordinates in the Karnataka RERA record (13.0963417, 77.5928992) to landmark coordinates from OpenStreetMap Nominatim; the metro station uses the coordinates on its Wikipedia page. Road distances will be longer.), not by road — travel distance will be longer.

About Yelahanka

Commute times to tech parks and the airport

As on 5 Oct 2026
ToStraight linePeak-hour drive (estimate)
Manyata Tech ParkMap point on OpenStreetMap (opens in a new tab)6.1 kmapprox. 25 min
KSR Bengaluru City railway station (Majestic)Map point on OpenStreetMap (opens in a new tab)13.38 kmapprox. 54 min
Kempegowda International AirportMap point on OpenStreetMap (opens in a new tab)16.75 kmapprox. 68 min
ITPL, Whitefield (main gate)Map point on OpenStreetMap (opens in a new tab)19.81 kmapprox. 80 min
Outer Ring Road tech corridor (RMZ Ecospace, Bellandur)Map point on OpenStreetMap (opens in a new tab)21.45 kmapprox. 87 min
Electronic City Phase 1Map point on OpenStreetMap (opens in a new tab)28.52 kmapprox. 115 min
How we calculate

Straight line: from the project’s map point on RERA to the destination’s point on OpenStreetMap.

Peak-hour drive is a rough estimate, not a route: straight line × 1.35 for the road network, at 20 km/h. Real times vary a lot with the route and the hour.

Sources:Source (openstreetmap.org) (opens in a new tab)How we calculate this

Schools and hospitals nearby

As on 5 Oct 2026

Within 2 km

  • 38Schools and colleges22 schools, 12 colleges, 4 kindergartens
  • 68Hospitals and clinics35 hospitals, 33 clinics

Nearest schools and colleges

  • Government School · 0.1 km
  • Government PU College · 0.16 km
  • Poornaprajna High School · 0.17 km

Nearest hospitals and clinics

  • North City CT Scan · 0.23 km
  • Balaji Multispeciality Dental Clinic · 0.35 km
  • Malavya Nursing Home · 0.39 km

Places as mapped on OpenStreetMap (amenity=school, college, kindergarten, university; hospital, clinic), counted within 2 km in a straight line of the RERA map point. Volunteers map these, so some places may be missing or closed. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.

Sources:Source (openstreetmap.org) (opens in a new tab)

Nearest metro station and railway

As on 5 Oct 2026
  • Yelahanka (ಯಲಹಂಕ)Blue Line metro, under construction1 km
  • Jakkur Cross (ಜಕ್ಕೂರು ಅಡ್ಡ)Blue Line metro, under construction2.92 km
  • Bagalur Cross (ಬಾಗಲೂರು ಕ್ರಾಸ್)Blue Line metro, under construction3.15 km
  • Yeshwantpur (ಯಶವಂತಪುರ)Open now — nearest operating metro station9.37 km
  • Yelahanka Junction (ಯಲಹಂಕ ಜಂಕ್ಷನ್)Nearest railway station0.97 km

Straight-line distances from the RERA map point to the station points mapped on OpenStreetMap; status (open or under construction) as tagged there. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.

Lines under construction near here

  • 6 Aug 2026Namma Metro Blue Line, Phase 2B (KR Pura – Hebbal – Yelahanka – Kempegowda Airport, 38.44 km). Under construction; reported 72% complete overall, with the remaining work targeted for June 2027 and phased opening through 2027. Nearest: Yelahanka, about 1 km straight-line. — Business Today. News report quoting BMRCL; the airport line has slipped before. Read (businesstoday.in) (opens in a new tab)
  • 4 Oct 2026Bengaluru Suburban Rail, Kanaka line (Corridor 4: Heelalige – Yelahanka – Rajanukunte). Under construction; Yelahanka listed as an interchange station; planned opening June 2029. Nearest: Yelahanka Junction, about 0.97 km straight-line. — Wikipedia (citing K-RIDE and news reports). Secondary source; check K-RIDE for the official schedule. Read (en.wikipedia.org) (opens in a new tab)

Sources:Source (businesstoday.in) (opens in a new tab)Source (en.wikipedia.org) (opens in a new tab)Source (openstreetmap.org) (opens in a new tab)

Lake and lake-buffer check

As on 5 Oct 2026

The nearest mapped lake is Allalasandra Lake, 429 m from the project’s RERA map point.

The site boundary is not published as a shape, so its nearest edge can be closer than this point. Whether any building sits inside a lake buffer can only be checked on the approved plan.

The buffer rule

Bengaluru’s lake buffer rule has changed over time: the National Green Tribunal ordered a 75 m buffer in May 2016; the Supreme Court set that order aside on 5 March 2019, leaving the 30 m buffer of the Revised Master Plan 2015. Check the current rule and the approved plan before relying on either number.

Shortest distance from the RERA map point to the mapped water edge (OpenStreetMap water polygons tagged lake or reservoir, or named lake/kere/tank). Mapped shorelines can differ from the revenue-record boundary of a lake. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.

Sources:Source (openstreetmap.org) (opens in a new tab)Source (livelaw.in) (opens in a new tab)Source (citizenmatters.in) (opens in a new tab)How we calculate this

Satellite time-lapse of the site

Satellite photos load when you scroll to them.

Photos from Esri World Imagery Wayback, centred on the project’s map point; dates are the capture dates in Esri’s metadata. Loaded from Esri when you scroll here.

Sources:Source (livingatlas.arcgis.com) (opens in a new tab)

Brigade Eternia floor plans, brochure and elevations

Documents the builder uploaded to Karnataka RERA, shown as filed. Tap a page to see it full size; the full PDF opens on the RERA website.

Brochure4 pages

Floor plans12 files

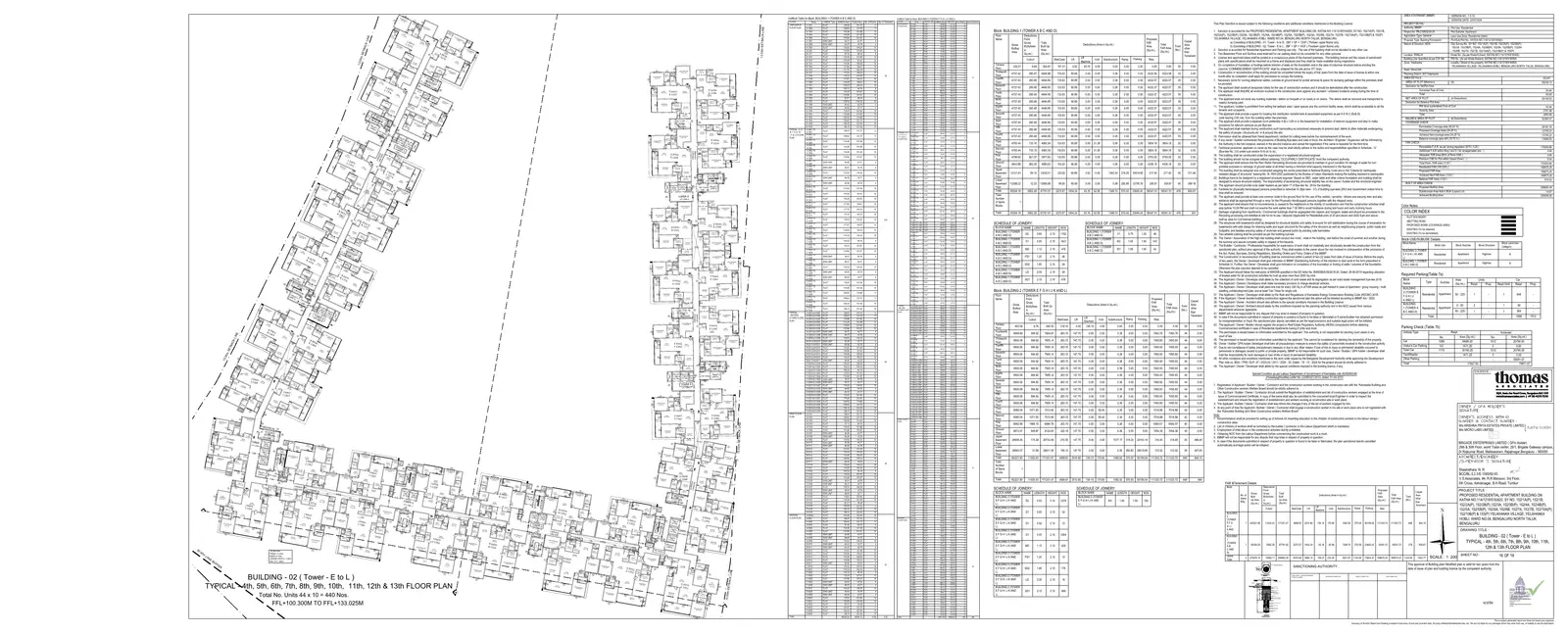

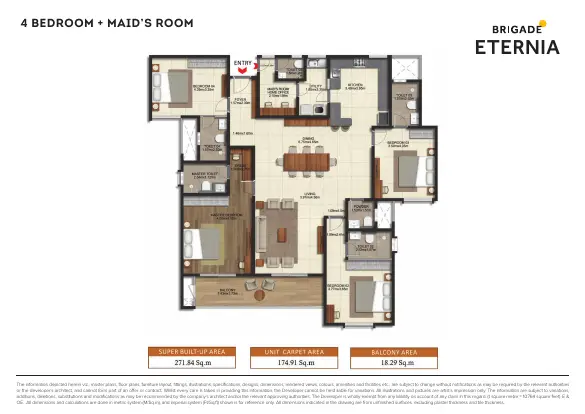

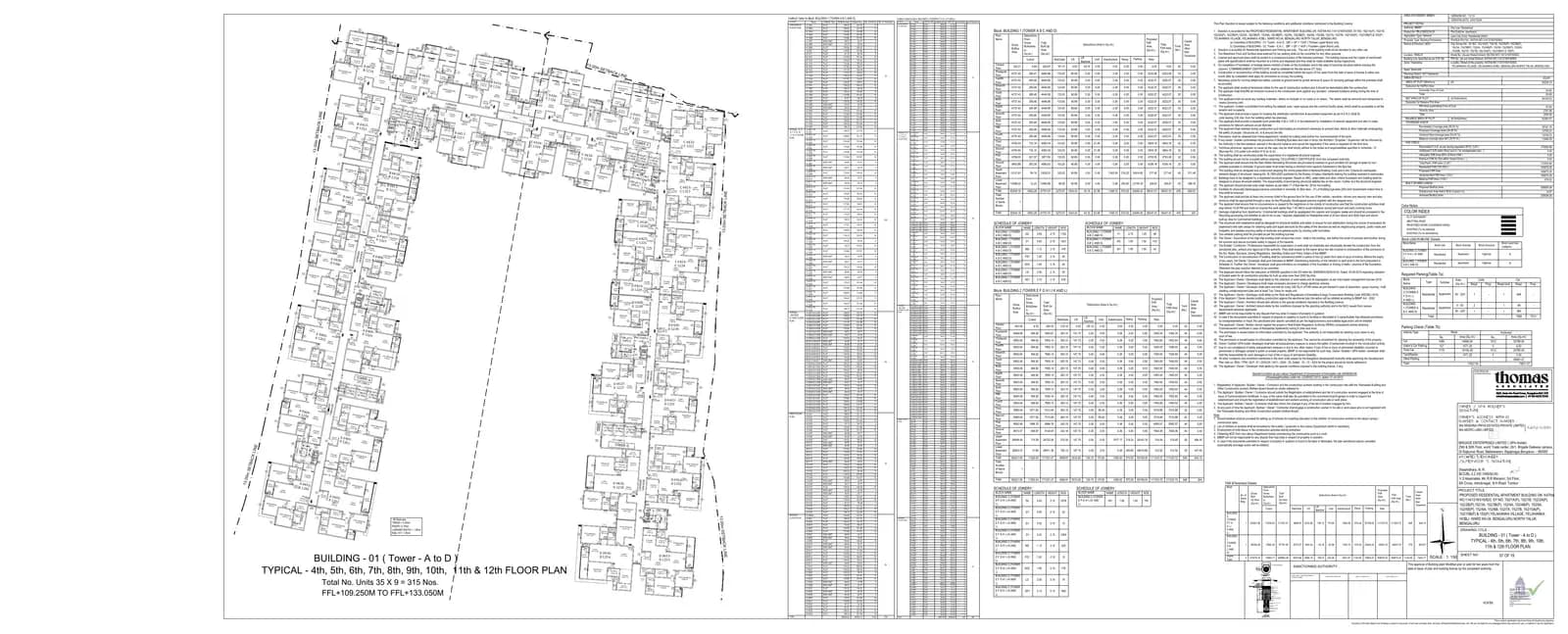

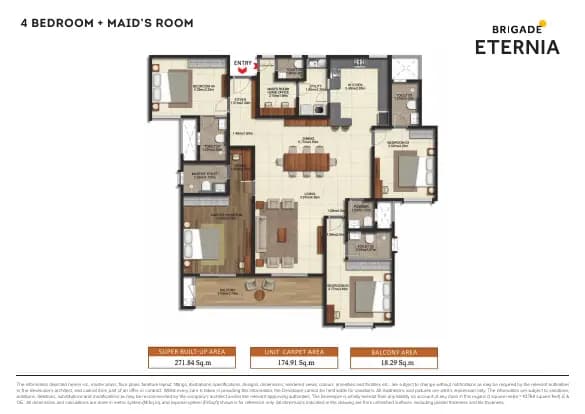

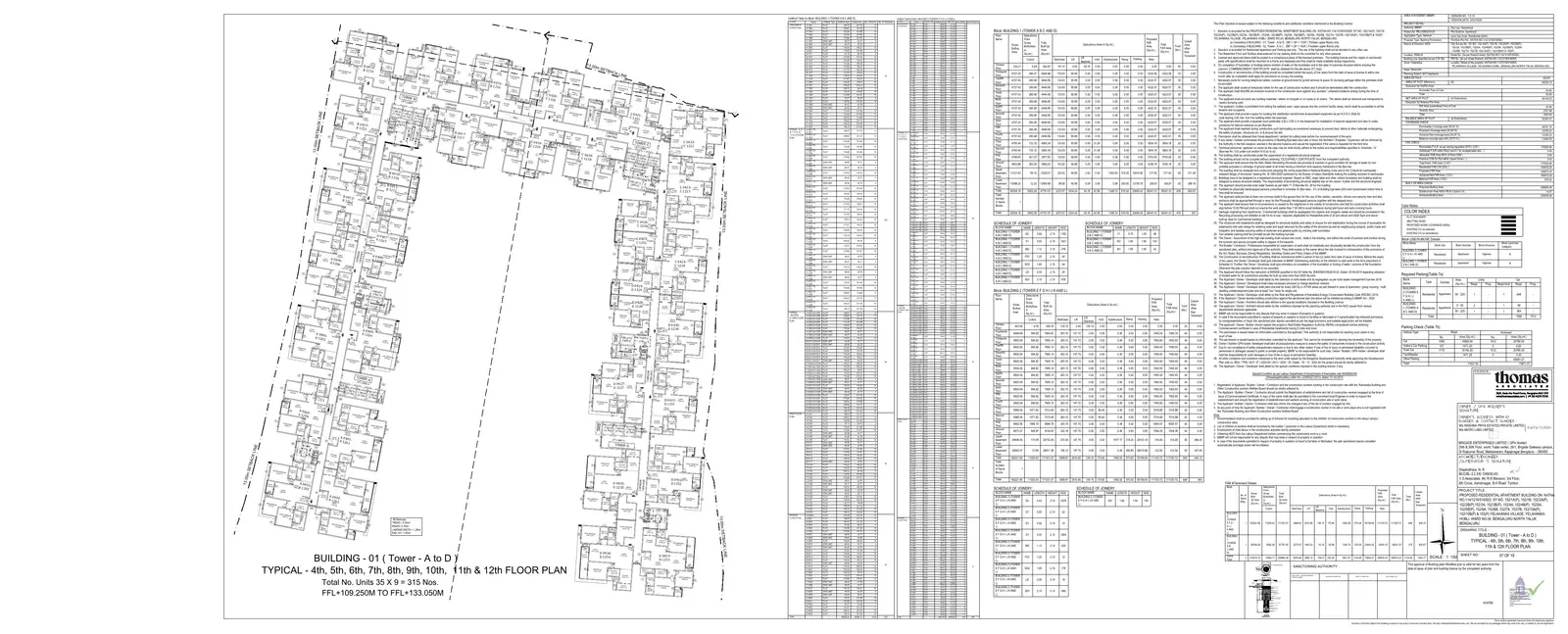

  • Brigade Eternia: Brigade Eternia - BUILDING - 01 (Tower - A to D) TYPICAL - 4th, 5th, 6th, 7th, 8th, 9th, 10th, 11th & 12th FLOOR PLAN.pdf (filed with Karnataka RERA)

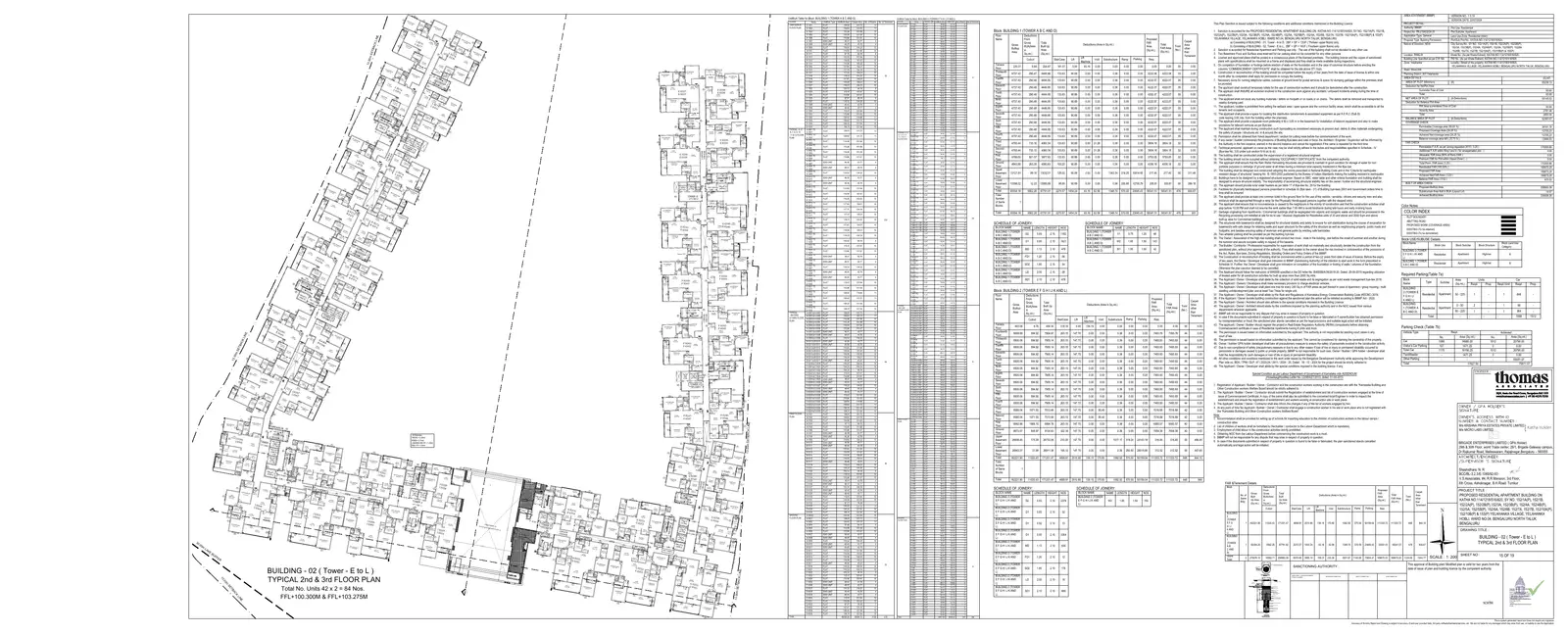

    Brigade Eternia - BUILDING - 01 (Tower - A to D) TYPICAL - 4th, 5th, 6th, 7th, 8th, 9th, 10th, 11th & 12th FLOOR PLAN.pdfFull PDF on RERA
  • Brigade Eternia: Brigade Eternia - BUILDING - 02 (Tower - E to L) TYPICAL 2nd & 3rd FLOOR PLAN.pdf (filed with Karnataka RERA)
    Brigade Eternia - BUILDING - 02 (Tower - E to L) TYPICAL 2nd & 3rd FLOOR PLAN.pdfFull PDF on RERA
  • Brigade Eternia: Brigade Eternia - BUILDING - 01 (Tower - A to D) FIRST FLOOR PLAN.pdf (filed with Karnataka RERA)

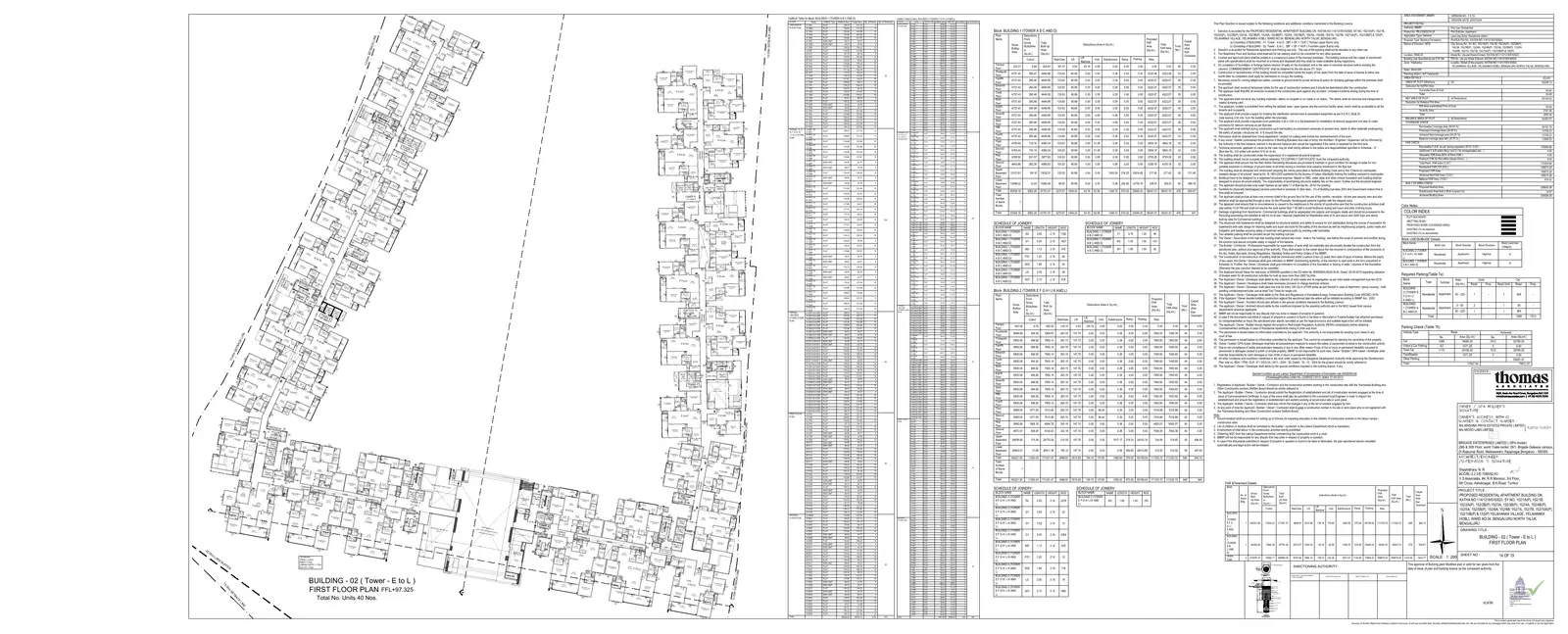

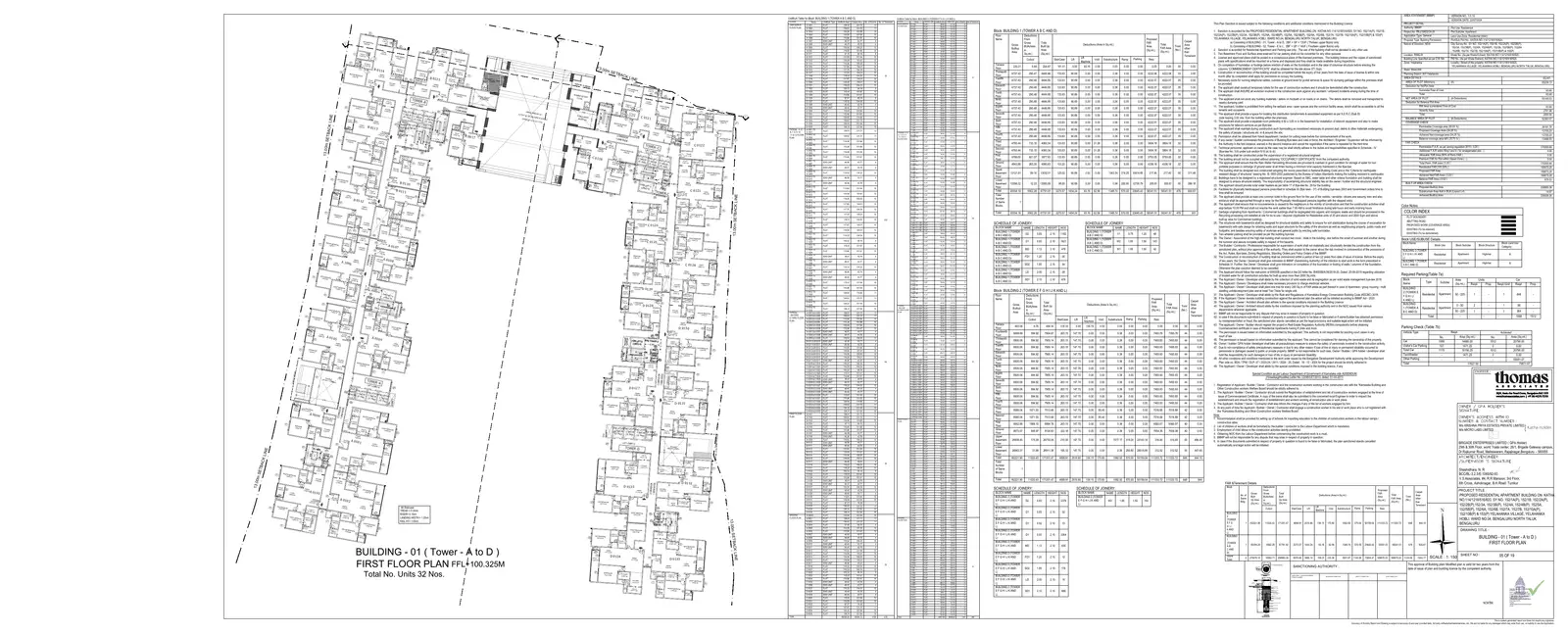

    Brigade Eternia - BUILDING - 01 (Tower - A to D) FIRST FLOOR PLAN.pdfFull PDF on RERA

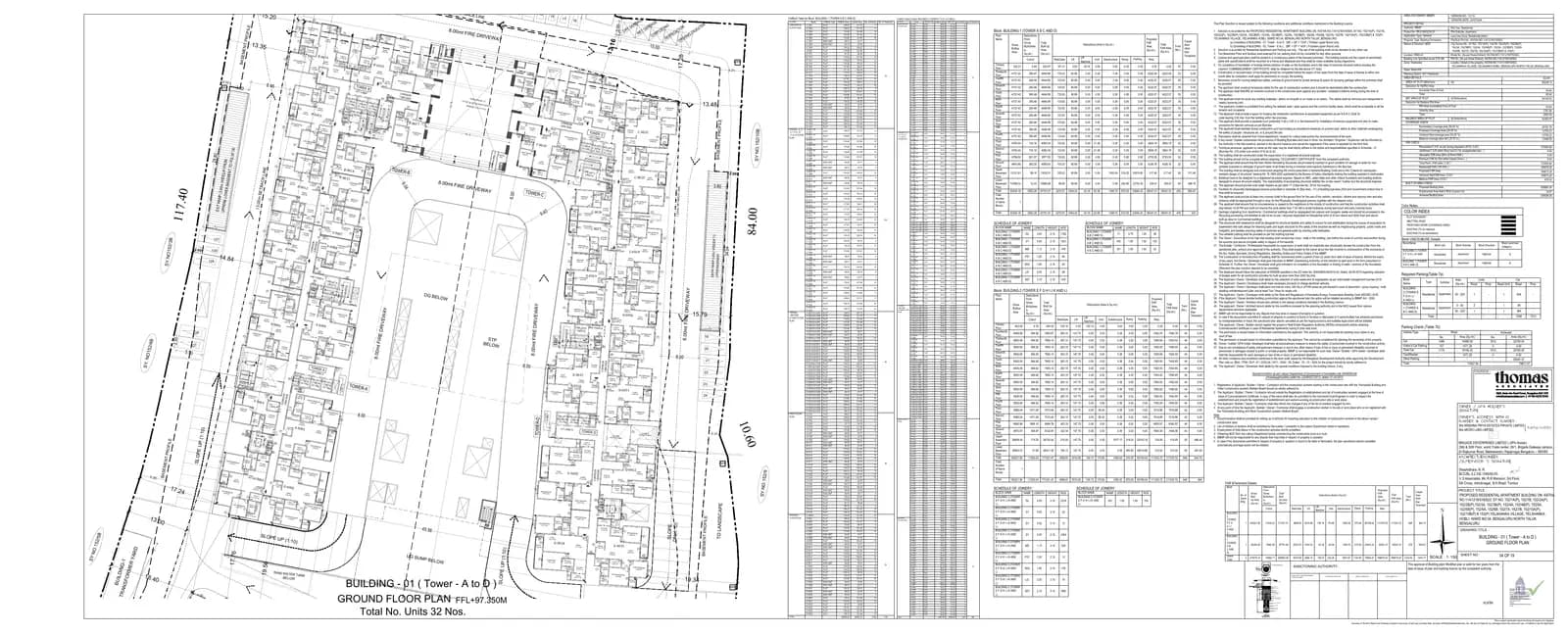

  • Brigade Eternia: Brigade Eternia - BUILDING - 01 (Tower - A to D) GROUND FLOOR PLAN.pdf (filed with Karnataka RERA)

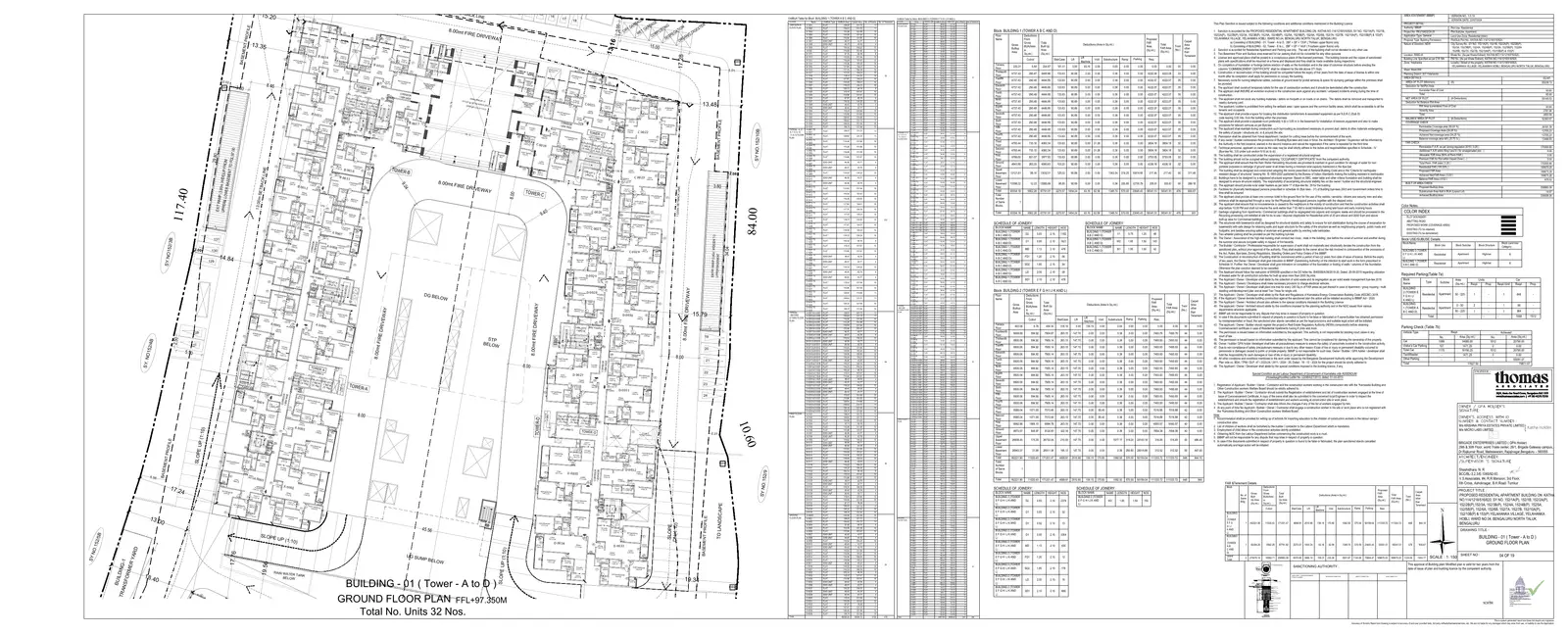

    Brigade Eternia - BUILDING - 01 (Tower - A to D) GROUND FLOOR PLAN.pdfFull PDF on RERA
  • Brigade Eternia: Brigade Eternia - BUILDING - 01 (Tower - A to D) THIRTEENTH FLOOR PLAN.pdf (filed with Karnataka RERA)

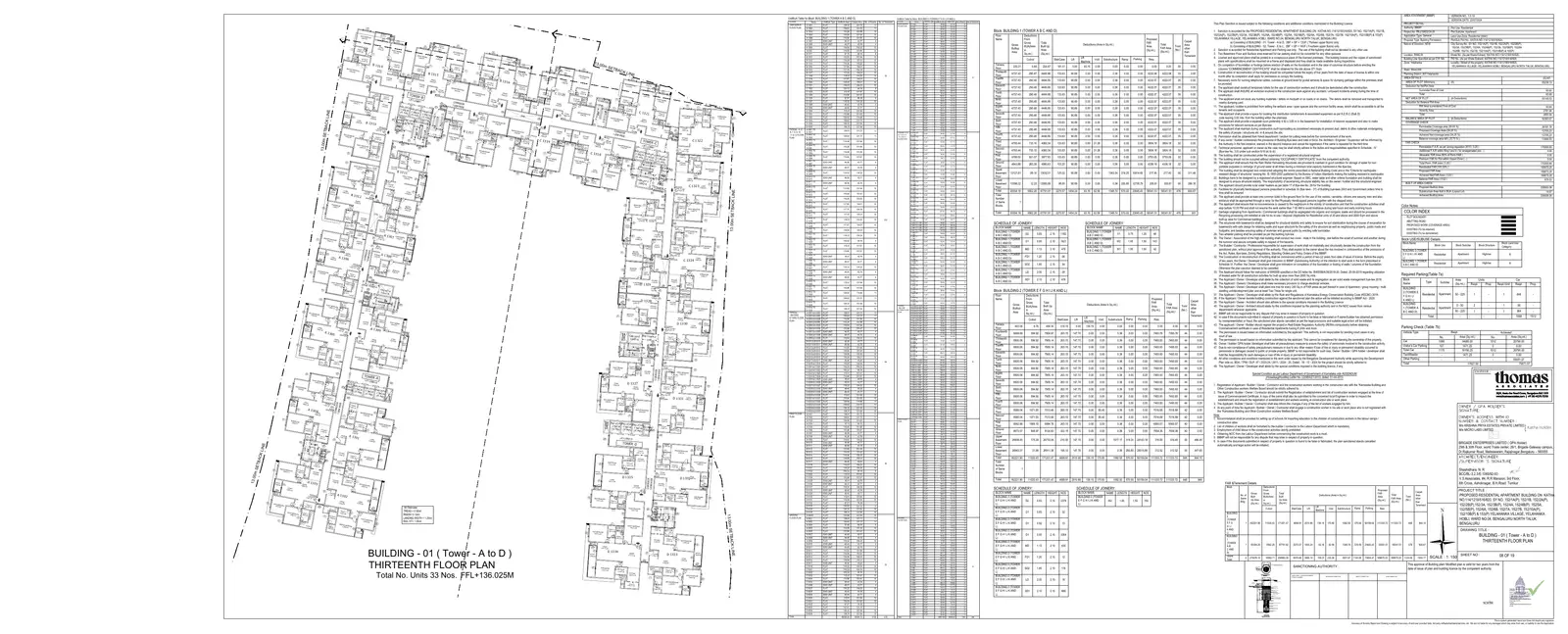

    Brigade Eternia - BUILDING - 01 (Tower - A to D) THIRTEENTH FLOOR PLAN.pdfFull PDF on RERA
  • Brigade Eternia: Brigade Eternia - BUILDING - 02 (Tower - E to L) 4th, 5th, 6th, 7th, 8th, 9th, 10th, 11th, 12th & 13th FLOOR PLAN.pdf (filed with Karnataka RERA)

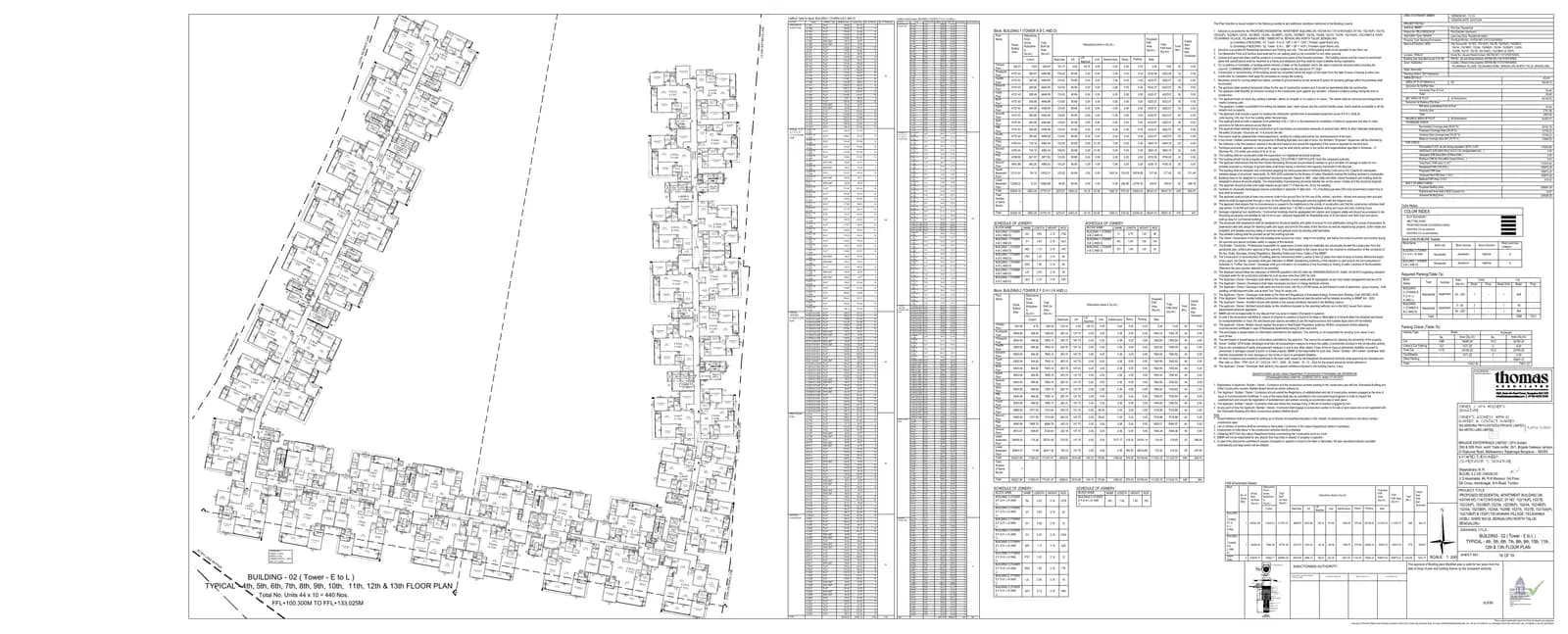

    Brigade Eternia - BUILDING - 02 (Tower - E to L) 4th, 5th, 6th, 7th, 8th, 9th, 10th, 11th, 12th & 13th FLOOR PLAN.pdfFull PDF on RERA

  • Brigade Eternia: Brigade Eternia - BUILDING - 02 (Tower - E to L) FIRST FLOOR PLAN.pdf (filed with Karnataka RERA)
    Brigade Eternia - BUILDING - 02 (Tower - E to L) FIRST FLOOR PLAN.pdfFull PDF on RERA
  • Brigade Eternia: Brigade Eternia - BUILDING - 02 (Tower - E to L) FOURTEENTH FLOOR PLAN.pdf (filed with Karnataka RERA)

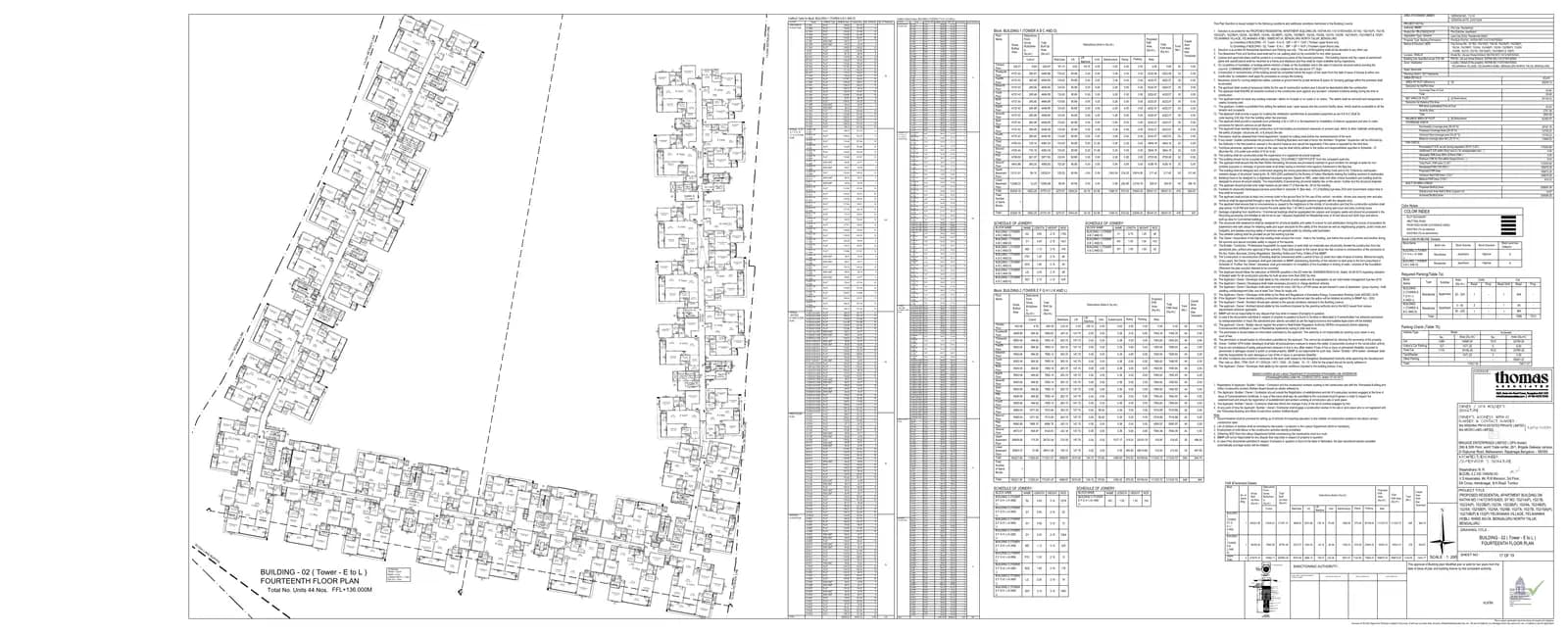

    Brigade Eternia - BUILDING - 02 (Tower - E to L) FOURTEENTH FLOOR PLAN.pdfFull PDF on RERA

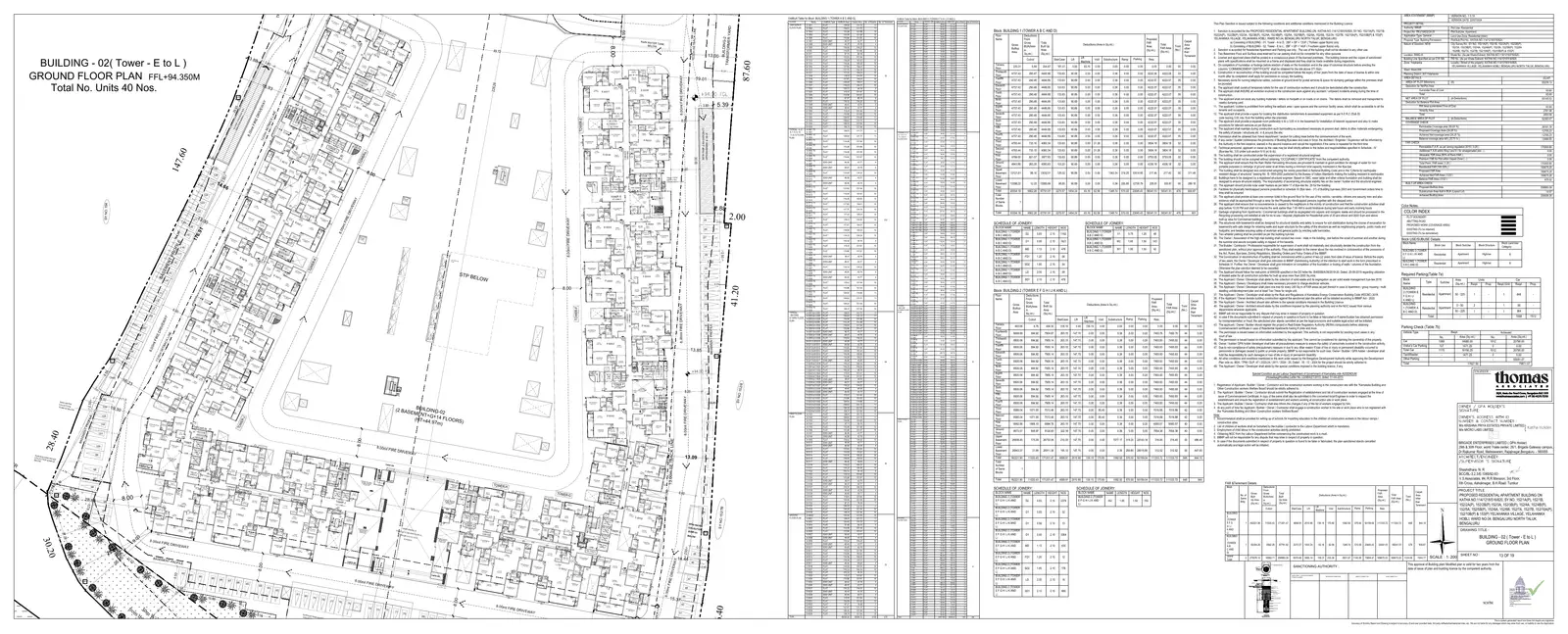

  • Brigade Eternia: Brigade Eternia - BUILDING - 02 (Tower - E to L) GROUND FLOOR PLAN.pdf (filed with Karnataka RERA)
    Brigade Eternia - BUILDING - 02 (Tower - E to L) GROUND FLOOR PLAN.pdfFull PDF on RERA
  • Brigade Eternia: Brigade Eternia - COMBINED GROUND FLOOR PLAN.pdf (filed with Karnataka RERA)

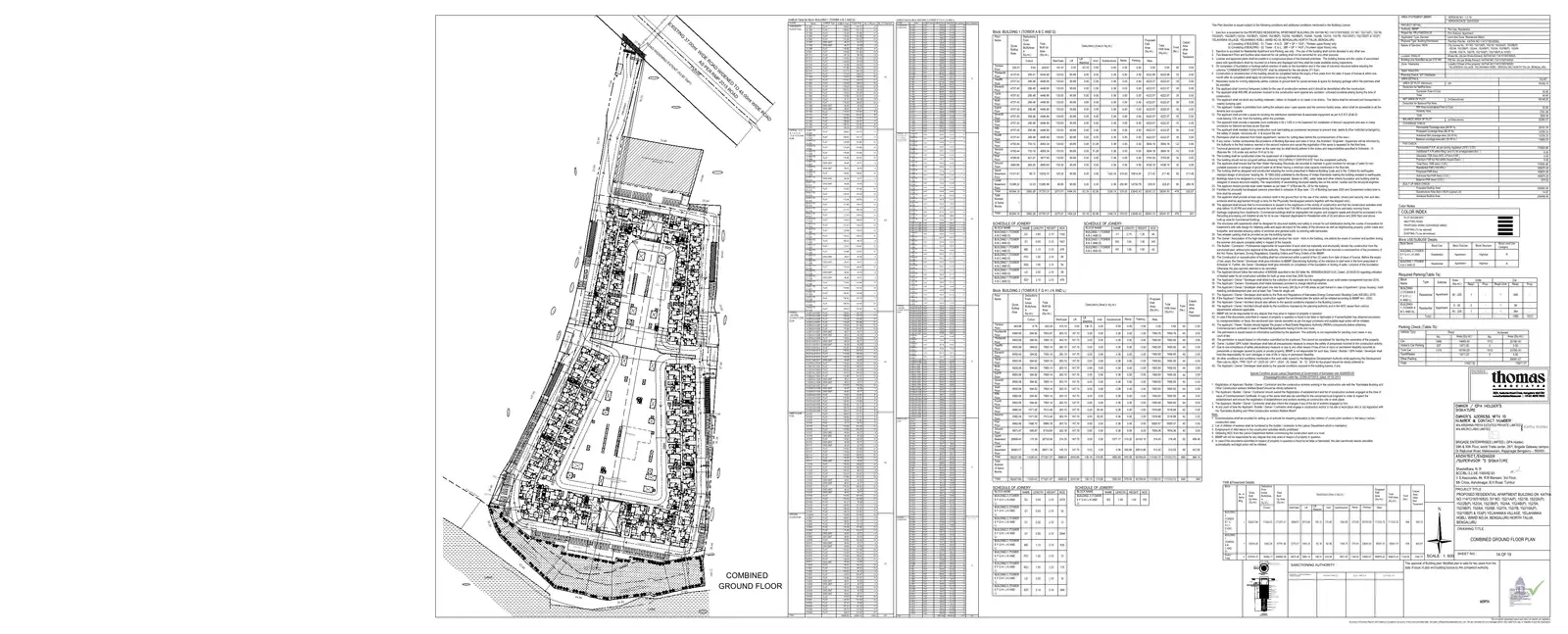

    Brigade Eternia - COMBINED GROUND FLOOR PLAN.pdfFull PDF on RERA
  • Brigade Eternia: First Floor Plan (filed with Karnataka RERA)
    First Floor PlanFull PDF on RERA
  • Brigade Eternia: Ground Floor Plan (filed with Karnataka RERA)
    Ground Floor PlanFull PDF on RERA

Approved building plan

Home typeCarpet areaHomes
1 BHK441 – 517 sq ft116
2 BHK763 – 980 sq ft16
3 BHK1,012 – 1,496 sq ft880
4 BHK1,718 – 1,884 sq ft112

Home types, counts and carpet areas as filed with Karnataka RERA (carpet area, not super built-up).

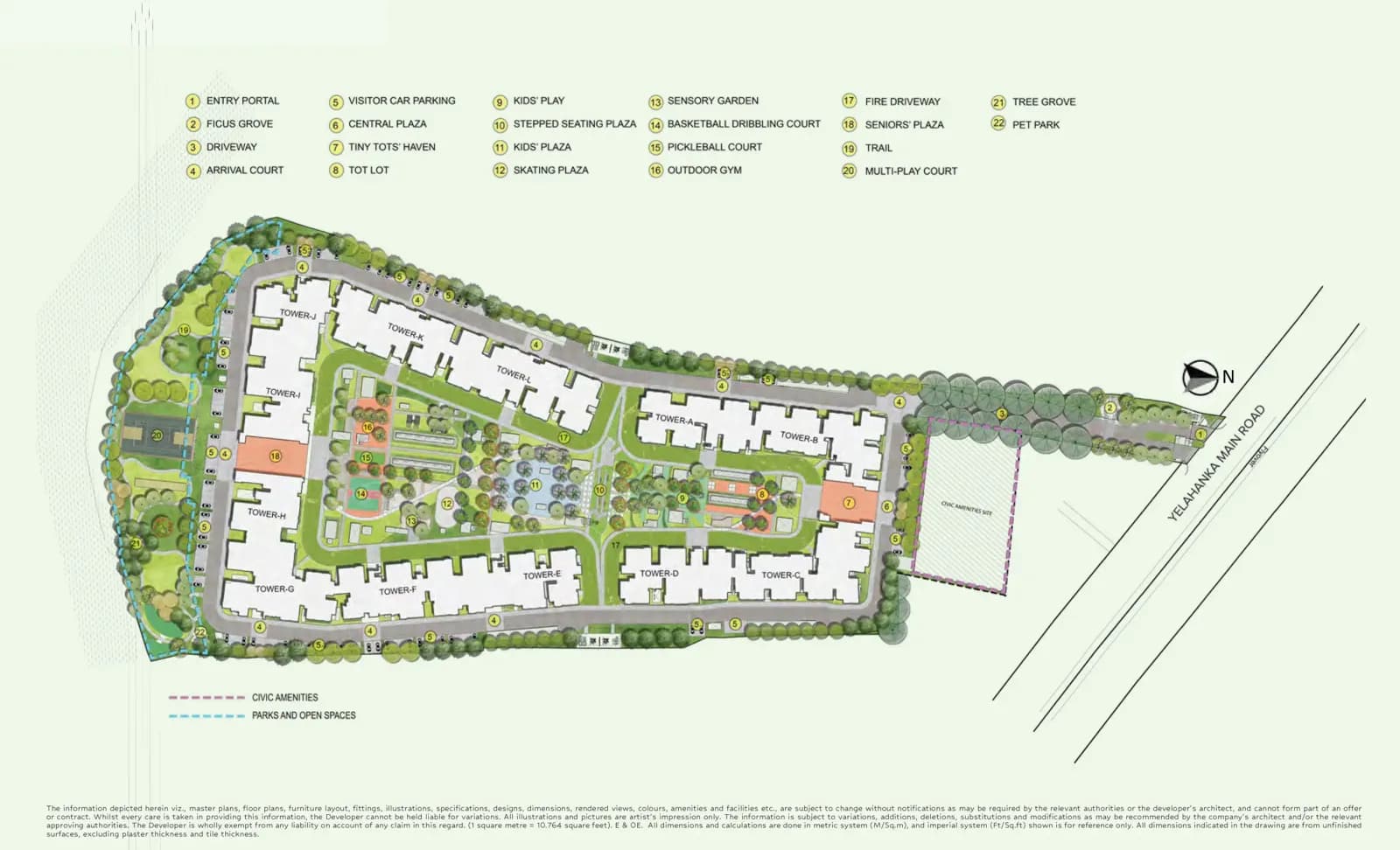

We have not collected floor-plan drawings; the builder’s sales team can share them.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Brigade Eternia possession date and construction status

  • Whole project (promoter’s RERA update)35%

    as on · 769 of 1,124 homes booked

Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-15.

By tower (Q2 2026-27)

  • Tower A6%
  • Tower B4%
  • Tower C3%
  • Tower D5%
  • Tower E42%
  • Tower F39%
  • Tower G41%
  • Tower H20%
  • Tower I19%
  • Tower J42%
  • Tower K41%
  • Tower L42%

Units sold and unsold, from RERA (Q2 2026-27)

TypeHomesBookedAvailable
1 BHK1161115
3 BHK880585295
2 BHK16151
4 BHK1125854

As reported by the promoter in the quarterly update to RERA, not verified by us.

Timeline

  1. 4 Mar 2025BBMP building plan approved
  2. 7 Mar 2025RERA registration approved
  3. 14 Mar 2025Project launched
  4. 17 Mar 2025Project start date in RERA record
  5. 18 Oct 2025Modified plan approved on RERA (applied 2025-08-07)
  6. 30 Jun 2026Builder reports 29% completion and 687 of 1,124 units booked (Q1 2026-27 update, filed 2026-07-15)
  7. 1 Dec 2029Target possession quoted by a listing site (not a builder commitment)
  8. 31 Mar 2030Completion date promised to RERA

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Construction pace from RERA quarterly filings

As on 15 Oct 2026

At the average pace so far, construction would reach 100% around Aug 2029 — about 8 months before the completion date on RERA (31 Mar 2030).

At the pace between the 4 quarterly filings we have (21% → 35% in 9 months), it would be around Mar 2030 — the same month as the RERA date.

0%25%50%75%100%20262027202820292030RERA date21%25%29%35%
  • Filed on RERA
  • Average pace since start
  • Pace between filings (and 0% assumed at the start date)
  • RERA completion date

Quarterly filings

QuarterFiled onBuiltHomes booked
Q2 2026-27to 30 Sep 202615 Oct 202635%769 of 1,124
Q1 2026-27to 30 Jun 202615 Jul 202629%687 of 1,124
Q4 2025-26to 31 Mar 202615 Apr 202625%652 of 1,124
Q3 2025-26to 31 Dec 202514 Jan 202621%580 of 1,124
How we calculate

Average pace = % built ÷ months since the start date in the RERA record. Here: 35% ÷ 18.5 months (17 Mar 2025 to 30 Sep 2026) = 1.9% a month.

Estimated finish = latest filing date + (100 − % built) ÷ pace = 30 Sep 2026 + 65 ÷ 1.9 = 34.3 months → Aug 2029. This is an estimate, not a date from the builder or RERA.

Pace between filings = (35% − 21%) ÷ 9 months = 1.6% a month.

A straight line is a simplification: the builder reports one overall %, which mixes excavation, structure and finishing, and work rarely moves at a constant speed. The % values are the promoter’s own figures filed with RERA, not checked by us. Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-15.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this

Approvals and documents checklist

ApprovalAuthoritySource
Building planBBMP - Bruhat Bengaluru Mahanagara Palike · No. BBMP/Addl.Dir/JDNORTH/0102/2024-25 · dated 2025-03-04Source (rera.karnataka.gov.in) (opens in a new tab)
Land conversion (4 orders)Special Commissioner · No. ALN No. 256/1961-62; BDis/ALN/SR(NA)214/2002-03 and 3 more · dated 2003-01-17Source (rera.karnataka.gov.in) (opens in a new tab)
Commencement Certificatescan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Approved Building Planscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
ESCOM/Electricityscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
KWSSB/Waterscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
KSPCBscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
SEIAAscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Fire Force Departmentscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Airport Authority of Indiascan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)

Documents uploaded to RERA

As on 18 Oct 2026
  • Building or layout plan · Approved drawings from the planning authorityFiled on RERA ✓ — BBMP - Bruhat Bengaluru Mahanagara Palike · No. BBMP/Addl.Dir/JDNORTH/0102/2024-25 · dated 4 Mar 2025
  • Commencement certificate · Permission to start buildingFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Environment clearance · SEIAA KarnatakaFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Fire NOC · Karnataka Fire and Emergency ServicesFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Pollution board consent · KSPCBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Water and sewerage · BWSSBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Electricity · BESCOMFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Height clearance · Airports Authority of IndiaFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Occupancy certificate (OC) · Issued only when the building is finishedNot on RERA yet — expected at completion

From the documents the promoter uploaded to Karnataka RERA, collected 18 Oct 2026. “Filed” means a document is on RERA — we have not checked its contents or validity. Not every approval applies to every project (for example, smaller projects may not need an environment clearance). The project page on RERA lists each upload.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Brigade Eternia RERA complaints and orders

1 complaint as on Source (rera.karnataka.gov.in) (opens in a new tab)

Complaint refFiledSubjectStatusSource
00888/202530 Jun 2025booking amount not returnedDisposedSource (rera.karnataka.gov.in) (opens in a new tab)

Court and consumer cases

CaseCourtYearSubjectOutcomeSource
WP 14579/2025High Court of Karnataka2025Writ petition against revenue (mutation) orders for land in Yelahanka; Brigade Enterprises was a respondent. The project's RERA record lists this writ as litigation on the project, with no stay or injunction issued.Dismissed on 2026-08-19, with liberty to the petitioner to first establish title in a civil courtSource (indiankanoon.org) (opens in a new tab)

We list case numbers, courts and outcomes only — never names of private individuals.

About Brigade Group

Founded
1986
Headquarters
Bengaluru
Bengaluru projects
16
Delivered on time
4 of 10
RERA complaints
44
Court cases listed
3

Brigade Enterprises Limited (CIN L85110KA1995PLC019126) is a listed Bengaluru developer, founded in 1986 and based at the World Trade Center in Malleswaram-Rajajinagar. Karnataka RERA records show its older Bengaluru projects receiving occupancy certificates between 2018 and 2024, some before the original RERA date and several months to about 19 months after it (within extended deadlines). As of 4 October 2026, RERA lists 44 complaints across Brigade Enterprises Ltd projects.

Brigade Group’s full record

Brigade Group delivery record

As on 22 Oct 2026
  • 28Projects in Bengaluru on RERA32 approved registrations under Brigade Enterprises Ltd in Bengaluru Urban and Rural. Source (rera.karnataka.gov.in) (opens in a new tab)
  • 15,990Homes and plots registeredAs stated in 31 of the 32 registrations.
  • 44RERA complaints5 open, 39 disposed. as on Source (rera.karnataka.gov.in) (opens in a new tab)
  • 2.8Complaints per 1,000 homes and plots44 complaints ÷ 15,990 homes and plots in its 32 registrations on Karnataka RERA in Bengaluru.
  • 5Completion filed on RERARegistrations where the promoter applied to RERA for completion; 2 with an occupancy certificate on RERA.
  • 0 of 5Filed by the date given at registrationMedian gap 9.4 months (on-time ones count as 0). The completion application can come after handover, so this is an upper bound on lateness.
  • 3Court cases listedFound in public court records; see the list on the builder’s page.

What the complaints are about

  • Delay in possession or delay interest18
  • Refund of booking or other money10
  • Construction quality, size or inspection4
  • Registration, sale deed or agreement3
  • Owners' association, amenities or documents2
  • Litigation or title disclosure2
  • Other5

44 complaint subjects as written on RERA, as on . Each subject is sorted into one group by keywords (first match wins: delay, refund, registration, quality, litigation, association); one complaint often raises several issues. Source (rera.karnataka.gov.in) (opens in a new tab)

Completion filed on RERA

ProjectDate at registrationCompletion filedGap
Brigade Northridge NeoOC on RERA31 Mar 2022extended to 30 Sep 202220 May 202650 months after
Brigade BricklaneOC on RERA31 Dec 2021extended to 31 Mar 202316 May 202653 months after
Brigade Oasis - Phase 130 Jun 2025extended to 30 Jun 202613 Apr 20269 months after
Brigade Oasis - Phase 230 Jun 2025extended to 30 Jun 202613 Apr 20269 months after
Brigade Oasis - Phase 330 Jun 2025extended to 30 Jun 202613 Apr 20269 months after

Measured against the completion date given at registration; many projects had RERA extensions (including the COVID-period extension), shown under the date.

Handovers we checked by hand

ProjectPromised (at registration)OCResultSource
Plumeria Phase 1 at Brigade Meadows31 Jul 20185 Jul 2018On timeSource (rera.karnataka.gov.in) (opens in a new tab)
Brigade Lakefront - Crimson30 Jun 201928 Dec 2018On timeSource (rera.karnataka.gov.in) (opens in a new tab)
Plumeria Lifestyle at Brigade Meadows30 Sep 202030 Mar 2020On timeSource (rera.karnataka.gov.in) (opens in a new tab)
Brigade Woods31 Dec 20201 Feb 202213 months lateSource (rera.karnataka.gov.in) (opens in a new tab)
Brigade Parkside North31 Mar 202115 Mar 202211 months lateSource (rera.karnataka.gov.in) (opens in a new tab)
Brigade Parkside East31 Dec 20209 May 202216 months lateSource (rera.karnataka.gov.in) (opens in a new tab)
Brigade Northridge Neo31 Mar 202213 May 20221 months lateSource (rera.karnataka.gov.in) (opens in a new tab)
Brigade 7 Gardens31 Oct 20204 Jun 202219 months lateSource (rera.karnataka.gov.in) (opens in a new tab)
Brigade Bricklane31 Dec 202110 Oct 20229 months lateSource (rera.karnataka.gov.in) (opens in a new tab)
Brigade Gem31 Aug 202422 Jul 2024On timeSource (rera.karnataka.gov.in) (opens in a new tab)

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)Source (indiankanoon.org) (opens in a new tab)Source (indiankanoon.org) (opens in a new tab)Source (livelaw.in) (opens in a new tab)How we calculate this

In the news

  • 15 Mar 2025Eternia details: 12 towers of 13–14 floors over two basements, 3 BHK, 3 BHK plus study and 4 BHK homes, about 2 million sq ft built-up — Biltrax Media Read (biltraxmedia.com) (opens in a new tab)
  • 14 Mar 2025Brigade launches Eternia in Yelahanka: 1,124 homes on 14.65 acres, with expected revenue of over ₹2,700 crore and completion by March 2030 — The Week (PTI) Read (theweek.in) (opens in a new tab)

What’s changed since Mar 2025

As on 18 Oct 2026
  1. 15 Oct 2026Quarterly update filed for Q2 2026-27: 35% built, 769 of 1,124 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  2. 4 Oct 2026Builder’s price list seen: 1 BHK from ₹1.13 Cr, 2 BHK from ₹2.11 Cr, 4 BHK from ₹4.45 Cr Source (brigadegroup.com) (opens in a new tab)
  3. 4 Oct 2026Listing price seen on housiey.com: ₹1.06 Cr – ₹4.79 Cr Source (housiey.com) (opens in a new tab)
  4. 19 Aug 2026High Court of Karnataka: WP 14579/2025 — dismissed on 2026-08-19, with liberty to the petitioner to first establish title in a civil court Source (indiankanoon.org) (opens in a new tab)
  5. 15 Jul 2026Quarterly update filed for Q1 2026-27: 29% built, 687 of 1,124 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  6. 15 Apr 2026Quarterly update filed for Q4 2025-26: 25% built, 652 of 1,124 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  7. 14 Jan 2026Quarterly update filed for Q3 2025-26: 21% built, 580 of 1,124 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  8. 18 Oct 2025Modified plan approved on RERA (applied 2025-08-07) (from our research file)
  9. 30 Jun 2025Complaint 00888/2025 filed with RERA: “booking amount not returned” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
  10. 17 Mar 2025Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
  11. 14 Mar 2025Project launched (from our research file)
  12. 7 Mar 2025Registered with Karnataka RERA (PRM/KA/RERA/1251/309/PR/070325/007559); completion date 31 Mar 2030 Source (rera.karnataka.gov.in) (opens in a new tab)
  13. 4 Mar 2025Building plan approved by BBMP - Bruhat Bengaluru Mahanagara Palike (No. BBMP/Addl.Dir/JDNORTH/0102/2024-25) Source (rera.karnataka.gov.in) (opens in a new tab)

Newest first. No extension of the completion date is recorded on RERA. When the RERA crawl sees a new filing, complaint or extension, it is added here with its date.

Home loan EMI calculator

Starts at the lowest listed price; change it to the home you want.

Example only — use your bank’s quote.

Monthly EMI
₹73,591
Down payment
₹21,20,000
Loan amount
₹84,80,000
Total interest
₹91,81,938

A calculation only, from the numbers you enter — not a loan offer.

All-in cost: GST, registration and other charges

As on 4 Oct 2026

The calculator loads when you scroll to it.

Assumptions
  • Base price: the builder’s published “onwards” price for the home type, where it publishes one (it usually says government charges, other charges and taxes are extra). You can change it.
  • GST 5% on the base price and charges — the usual rate for an under-construction home that is not “affordable housing” (1%).
  • Stamp duty about 5.6% and registration 2% — the Karnataka rule (registration was raised from 1% to 2% on 31 Aug 2025). Calculated on the agreement value.
  • Car parking, other charges and the maintenance deposit are not in the public record we collect; enter them from the builder’s cost sheet.
  • Loan on the agreement value (banks usually lend up to 75–90%); EMI is the standard reducing-balance formula. Example rate only — use your bank’s quote.

Sources:Source (brigadegroup.com) (opens in a new tab)How we calculate this

Brigade Eternia FAQs

When is possession of Brigade Eternia?

The completion date promised to Karnataka RERA is 31 March 2030. A listing site gives a target of December 2029, but only the RERA date is a formal commitment.

What is the RERA number of Brigade Eternia?

PRM/KA/RERA/1251/309/PR/070325/007559, approved on 7 March 2025.

What is the price of Brigade Eternia?

On 4 October 2026, housiey.com listed all-inclusive prices from about ₹1.06 crore for a 444 sq ft (carpet) 1 BHK to about ₹4.79 crore for the largest 4.5 BHK.

What sizes and unit types are available?

According to the RERA record there are 116 1 BHK flats (about 441–517 sq ft carpet), 16 2 BHK (about 764–980 sq ft), 880 3 BHK (about 1,012–1,496 sq ft) and 112 4 BHK (about 1,722–1,884 sq ft).

How big is the project?

1,124 homes in 12 towers of 13 or 14 floors over two basements. The builder gives the site as 14.65 acres, while the RERA record shows a land area of 49,622 sq m.

How far along is construction?

The builder's RERA update for the April–June 2026 quarter reports 29% completion, with 687 of 1,124 units booked.

Are there complaints or court cases about Brigade Eternia?

As of 4 October 2026, the RERA record shows one complaint on this project (a booking-amount refund, filed 30 June 2025), which has been disposed. The record also lists Karnataka High Court writ petition 14579/2025, which was dismissed on 19 August 2026.

What is Brigade's track record on complaints?

The RERA record shows 44 complaints across all projects of Brigade Enterprises Ltd as of 4 October 2026.

Which offices and metro stations are nearby?

In straight-line distance, Bagmane Sierra Business District is about 0.8 km away, Embassy Business Hub about 1.8 km and Manyata Tech Park about 6.2 km. The Yelahanka Blue Line metro station, under construction, is about 1 km away.

Which banks give home loans for Brigade Eternia?

A listing site names SBI, HDFC Bank, ICICI Bank, Axis Bank, Kotak Mahindra Bank, Bank of Baroda, Bank of India, Union Bank of India, Central Bank of India and Citibank. The RERA escrow account is with Kotak Mahindra Bank.

What is the maintenance charge?

No per-sq-ft rate was found. A listing site estimates about ₹9,700–₹11,900 a month for a 3 BHK.

What is the payment plan?

A construction-linked plan with payments in slabs as work progresses. The listing says loans up to 90% are possible and the minimum down payment is about ₹11 lakh.

More questions, answered from the RERA record

When will Brigade Eternia be completed?

According to the RERA record, the project completion date is 31 March 2030.

How many homes are in Brigade Eternia?

The project has 1,124 homes across 12 towers with a maximum of 14 floors.

What home types are available in Brigade Eternia?

The project offers 1 BHK (441-517 sq ft carpet area), 2 BHK (763-980 sq ft), 3 BHK (1,012-1,496 sq ft), and 4 BHK (1,718-1,884 sq ft) homes.

What is the RERA registration number for Brigade Eternia?

The RERA registration number is PRM/KA/RERA/1251/309/PR/070325/007559, registered on 7 March 2025.

How many homes are booked in Brigade Eternia?

As of the quarter ended 30 September 2026, 769 homes are booked out of 1,124 homes.

What is the construction progress of Brigade Eternia?

As of the quarter ended 30 September 2026, the project is 35% complete.

Where is Brigade Eternia located?

Brigade Eternia is located in Yelahanka, Bengaluru North taluk, Bengaluru Urban district, with PIN code 560064.

Are there any RERA complaints on Brigade Eternia?

There is 1 RERA complaint on this project according to the RERA record.

What is the builder's complaint history?

Brigade Enterprises Ltd has 44 complaints across all their projects registered with Karnataka RERA.

How many other projects does Brigade Enterprises have?

Brigade Enterprises Ltd has 38 projects in the Karnataka RERA Bengaluru records.

Written by AI from the RERA record above on 18 Oct 2026. Answers use only that record; check them against the source before you decide.

Questions about Brigade Eternia

No questions published yet. Ask the first one: you get an instant answer from this page’s public record, and our team follows up on anything the record does not show.

Bought a home from Brigade Group? Review the builder.

Reviews of Brigade Group by verified buyers

No verified reviews of Brigade Group yet. If you bought a home from them, your review helps other buyers.

How reviews work: only buyers and owners can review; we confirm each purchase by phone before publishing, publish positive and negative reviews alike, never accept payment for reviews, and the builder may reply.

Similar projects within 5 km

ProjectDistanceHomesPossession (RERA)BuiltComplaintsPrice
MLN SignatureMLN Constructions & Developers0.9 km64Jul 2026—0Not collected
Century AstoriaRealkraft Ventures LLP1 km334Feb 20312%0Not collected
Visista By Vista Spaces | OkasVista Spaces Jakkur Residency Private Limited1 km236Dec 2026100%0Not collected
4square Park Sierra4square Estates1.1 km170Dec 202929%0Not collected
Dhiraan GalaxyDhiraan Infrastructure Pvt. Ltd.1.2 km24Aug 2026100%0Not collected
Kanisha White PalaceKanisha Builders1.2 km40Dec 2026100%0Not collected

Projects of the same kind within 5 km in a straight line of this project’s RERA map point, nearest first. % built is the promoter’s latest quarterly figure on RERA (shown for single-registration projects); prices are from the builder’s own website where we found one.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Sources and last checked dates

  1. Karnataka RERA — project register (search by the registration number) (opens in a new tab)
  2. Brigade Group official project page (facts only) (opens in a new tab)
  3. Aurum PropTech Pulse, republished RERA record (opens in a new tab)
  4. Housiey listing (price, specs, banks, maintenance) (opens in a new tab)
  5. The Week (PTI), launch news, 14 Mar 2025 (opens in a new tab)
  6. Biltrax Media, launch details, 15 Mar 2025 (opens in a new tab)
  7. FilingReader news wire, launch, 14 Mar 2025 (opens in a new tab)
  8. Indian Kanoon, Karnataka High Court WP 14579/2025 judgment (opens in a new tab)
  9. OpenStreetMap Nominatim (project outline and landmark coordinates) (opens in a new tab)
  10. Wikipedia, Yelahanka metro station (opens in a new tab)
  11. Business Today, Blue Line progress, 6 Aug 2026 (opens in a new tab)

Collected on 18 Oct 2026 by AI research agents reading public pages. Facts are written in our own words. Not found yet: rera extended to (no extension recorded); maintenance per sqft; car parking; bank approvals from an official source (only a listing site's list); specifications from the builder (rera lists a specifications pdf that could not be opened); power backup details.

How to check on RERA: On rera.karnataka.gov.in/viewAllProjects, type the registration number in 'Registration No', press Search, then click the 'View Project Details' icon. Complaints open from the 'Complaints / Litigation' icon in the same row. Registration number: PRM/KA/RERA/1251/309/PR/070325/007559.

  • RERA record last checked: 18 Oct 2026
  • Last change in the record (registration, quarterly filing or complaint): 18 Oct 2026
  • Builder price list seen: housiey.com (listing marked updated 2026-09-06; all-inclusive prices, 1 BHK 444 sq ft to 4.5 BHK 1,883 sq ft carpet)

How this page is made: software builds it from public records (Karnataka RERA filings, OpenStreetMap, the builder’s own website). AI is used only to read filings into fields and to write the plain-English summary and FAQ answers, which are checked against the record. Facts are checked automatically against the RERA filing. Methodology · How we earn · Report an error
