Classique Willowbell
2, 3 & 4 BHK apartments by Allegro Mahabaleshwara Ventures LLP · Kannur, Hennur Road, Bengaluru
Kannur, Hennur Road, BengaluruOpen on Google Maps (opens in a new tab)
- Under construction
- RERA registered
- residential
by Allegro Mahabaleshwara Ventures LLP
Price: Price on request

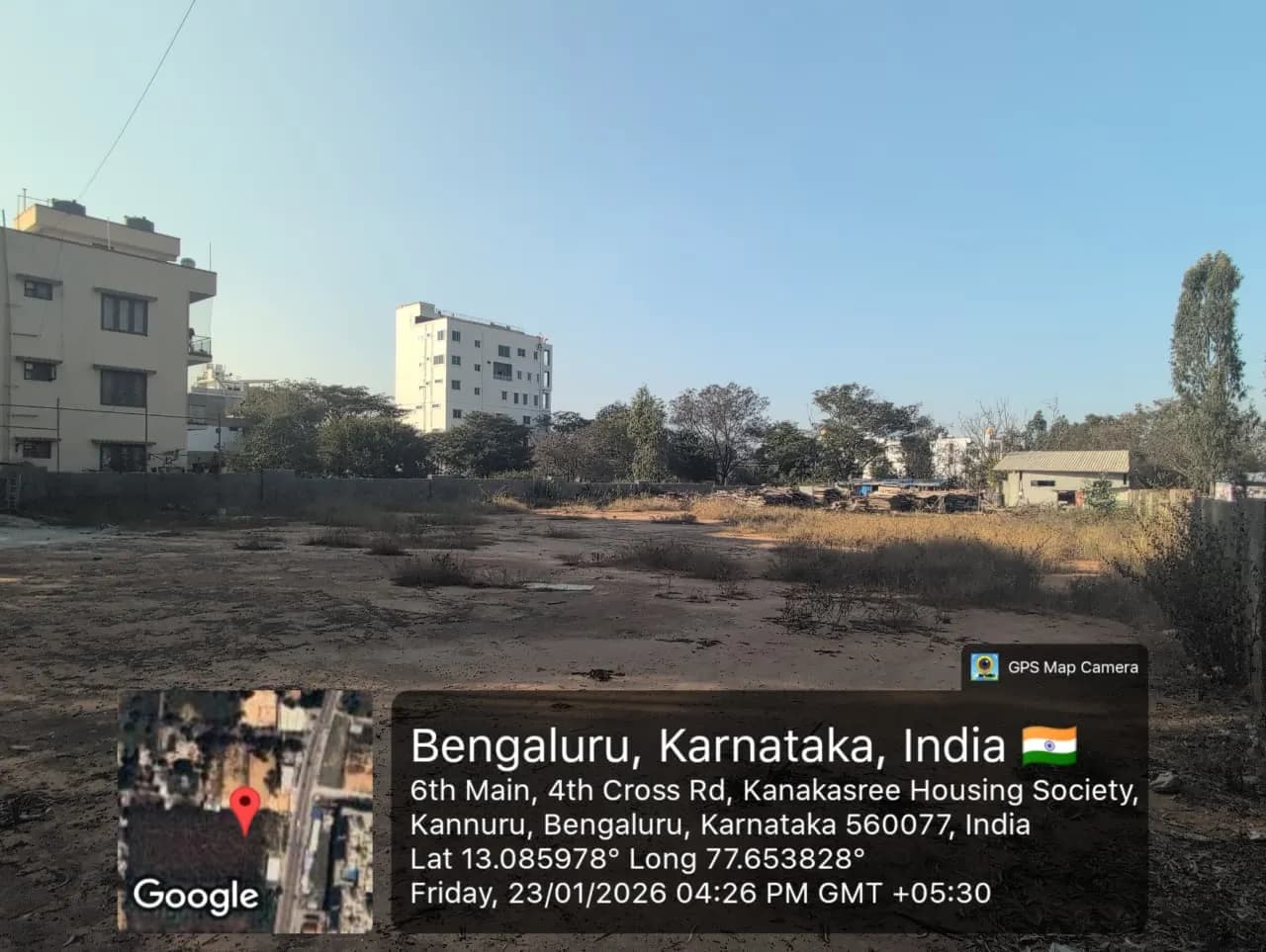

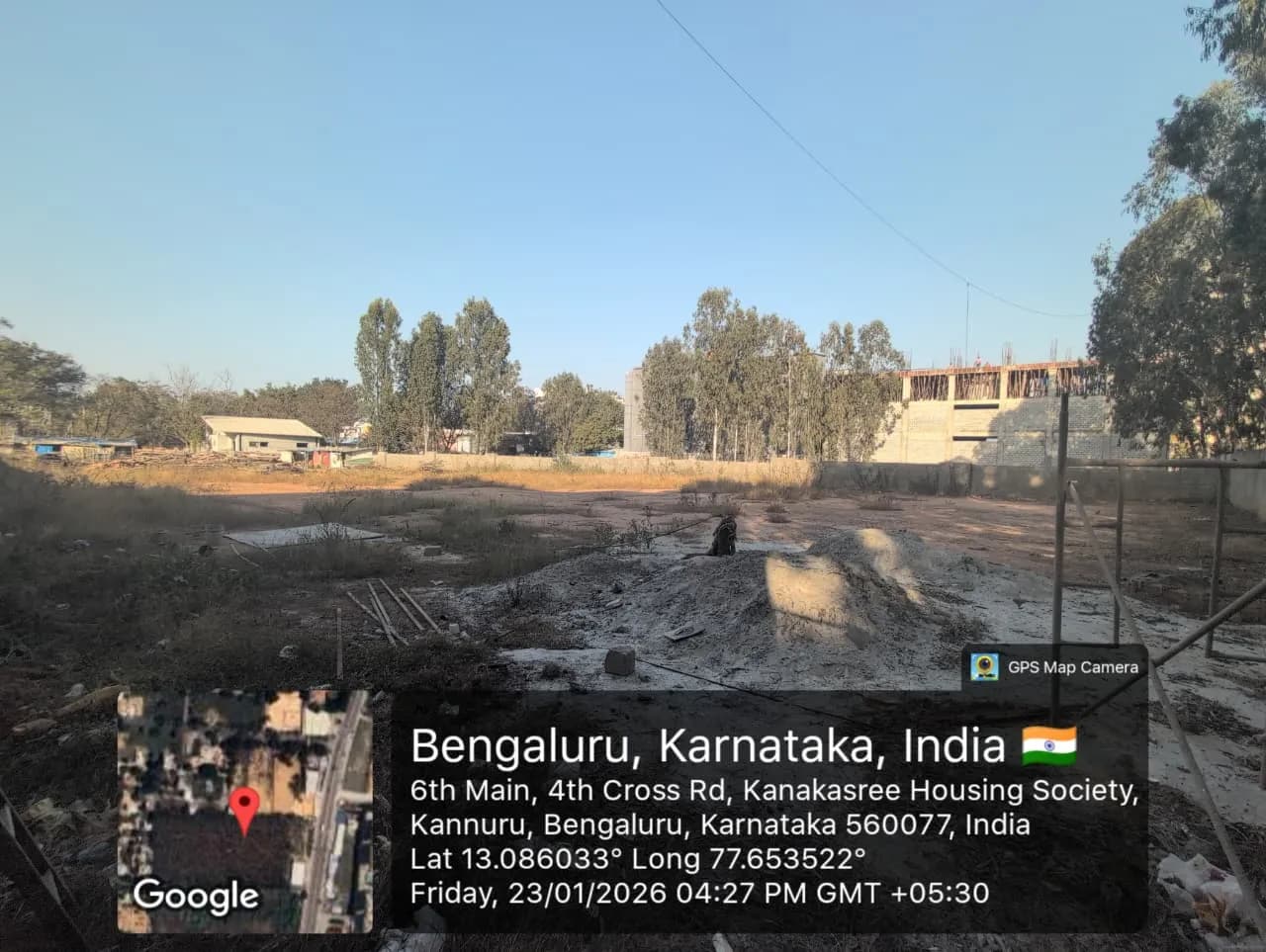

Site photo filed with Karnataka RERA Karnataka RERA filing · Source ↗ (opens in a new tab)
Classique Willowbell at a glance
- Possession (RERA)Dec 2031Karnataka RERA
- Construction16% built · on pace for Aug 2029RERA filing to 30 Sep 2026; estimate from average pace
- Homes booked12 of 79 (15%)RERA update · as on 30 Sep 2026
- RERA complaints (project)None listedKarnataka RERA · as on 19 Oct 2026
- Approvals filed7 of 9 on RERAKarnataka RERA uploads · 19 Oct 2026
- Nearest metroNagawara · 5.91 km (under construction)Open now: Krishnarajapura, 9.97 km · straight line · OpenStreetMap, 5 Oct 2026
- Airport driveapprox. 56 min at peak13.85 km straight line · estimate
- Nearest lakeUnnamed lake · 1,131 mFrom the RERA map point · OpenStreetMap, 5 Oct 2026
Project summary
Classique Willowbell is a residential project by Allegro Mahabaleshwara Ventures LLP in Kannur, Bengaluru with 79 homes, registered with Karnataka RERA. The completion date on RERA is 31 Dec 2031.
Facts collected on 19 Oct 2026 from public records — each linked to its source. Free for buyers. If you book through us, the builder pays us a commission.
Classique Willowbell buyers’ group: join to ask for a group price
No one has joined yet. Be one of the first 10 buyers in this group — the founding members.
Join free. When enough buyers have joined, our agent partner asks Allegro Mahabaleshwara Ventures LLP for a group price — for example a lower price, an easier payment plan or waived charges. Nothing is promised: you see what the builder offers and book directly with the builder if you want to. Free for buyers. If you book through us, the builder pays us a commission.
- Gathering buyers
- Talking to the builder
- Group offer
- Group site visit
- Booking
0 buyers have joined · 0 committed
Committed buyers have confirmed their budget, home type and timeline with us on a call; builders negotiate with them. Joining is free and never obliges you to buy.
Join the Classique Willowbell buyers’ groupHow group buying works
See it for yourself
Visit the site with our team, or get a call to clear your questions. Free, no obligation.
Key facts: home types, towers, land and possession
- Home types
- 2 BHK, 3 BHK, 4 BHK
- Carpet area
- 782 – 1,612 sq ft
- Towers
- 1
- Floors
- 9
- Total homes
- 79
- Land
- 0.83 acres
- Possession (RERA)
- Dec 2031
- Built (RERA update)
- 16%
Classique Willowbell RERA number and registration details
- RERA number
- PRM/KA/RERA/1251/446/PR/220526/008672
- Registered on
- 22 May 2026
- Promised completion
- 31 Dec 2031
- Extended to
- No extension recorded
- RERA status
- New launch
- Homes booked
- 12 of 79 as on
- Price
- Not found in public records yet: price
- Project type
- Residential
Towers and blocks (RERA filing)
| Tower | Floors | Basements | Homes |
|---|---|---|---|
| CLASSIQUE WILLOWBELL | 9 | 2 | 79 |
A dash (—) means the filing did not state that value.
Summary in plain English
Classique Willowbell is a residential project by Allegro Mahabaleshwara Ventures LLP in Kannur, Bengaluru East. It has 79 homes across one tower with 9 floors. The project is registered for completion on 31 December 2031.
Written by AI from the RERA record above on 19 Oct 2026. Every number in it was checked against that record; if anything differs, the record wins.
Open space, home loans, escrow and other details
- Open space
- 66.1% of land
- Water and power
- Water source filed with RERA: BoreWell,Local Authority
- Home loans: approved banks
- Not found in public records yet: bank approvals
- Payment plans
- Not found in public records yet: payment plans
- Maintenance
- Not found in public records yet: maintenance
- Car parking
- Not found in public records yet: car parking charge
- Escrow bank (RERA)
- HDFC, M N Towers Kadri, Mangalore
- Building plan (RERA)
- BDA - Bangalore Development Authority · No. 41/2025-26 · dated 25 Feb 2026
- Project cost declared to RERA
- ₹59.52 Cr
Open area as a share of the land, from the areas filed with RERA (includes driveways and landscaped areas).
Amenities
- Electricity
- CCTV Surveillance
- Community Hall
- Indoor Sports facility
- Swimming Pool
- Gym
- Power Backup
- Piped Gas
- Water and Sanitation
Amenities and internal works as filed by the promoter with Karnataka RERA; we have not visited the site.
Classique Willowbell location and address
- Address
- Sy.No: 129 [p] , Kannur Village, Bidarahalli Hobli , Bengaluru East , Bengaluru Urban, Karnataka - 560077
- Village (RERA)
- Kannur
- Locality
- Hennur RoadAlso known as Hennur Main Road, Hennur-Bagalur Road, Hennur
- PIN code
- 560077
- City
- Bengaluru
- State
- Karnataka
- Coordinates
- 13.08645, 77.65359
Distances to landmarks
Not found in public records yet: landmarksAbout Hennur Road
Not found in public records yet: locality factsCommute times to tech parks and the airport
| To | Straight line | Peak-hour drive (estimate) |
|---|---|---|
| Manyata Tech ParkMap point on OpenStreetMap (opens in a new tab) | 5.61 km | approx. 23 min |
| Kempegowda International AirportMap point on OpenStreetMap (opens in a new tab) | 13.85 km | approx. 56 min |
| ITPL, Whitefield (main gate)Map point on OpenStreetMap (opens in a new tab) | 14.28 km | approx. 58 min |
| KSR Bengaluru City railway station (Majestic)Map point on OpenStreetMap (opens in a new tab) | 15.09 km | approx. 61 min |
| Outer Ring Road tech corridor (RMZ Ecospace, Bellandur)Map point on OpenStreetMap (opens in a new tab) | 18.34 km | approx. 74 min |
| Electronic City Phase 1Map point on OpenStreetMap (opens in a new tab) | 26.36 km | approx. 107 min |
How we calculate
Straight line: from the project’s map point on RERA to the destination’s point on OpenStreetMap.
Peak-hour drive is a rough estimate, not a route: straight line × 1.35 for the road network, at 20 km/h. Real times vary a lot with the route and the hour.
Sources:Source (openstreetmap.org) (opens in a new tab)How we calculate this
Schools and hospitals nearby
Within 2 km
- 21Schools and colleges10 schools, 11 colleges, 0 kindergartens
- 1Hospitals and clinics1 hospitals, 0 clinics
Nearest schools and colleges
- Faran Group of Institutions · 0.29 km
- United International · 0.43 km
- Aadya Academy · 0.46 km
Nearest hospitals and clinics
- Government Primary Health Centre · 1.36 km
Places as mapped on OpenStreetMap (amenity=school, college, kindergarten, university; hospital, clinic), counted within 2 km in a straight line of the RERA map point. Volunteers map these, so some places may be missing or closed. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Nearest metro station and railway
- Nagawara (ನಾಗವಾರ)Pink Line metro, under construction5.91 km
- Bagalur Cross (ಬಾಗಲೂರು ಕ್ರಾಸ್)Blue Line metro, under construction5.99 km
- Yelahanka (ಯಲಹಂಕ)Blue Line metro, under construction6.03 km
- Krishnarajapura (ಕೃಷ್ಣರಾಜಪುರ (ಕೆ.ಆರ್.ಪುರ))Open now — nearest operating metro station9.97 km
- Yelahanka Junction (ಯಲಹಂಕ ಜಂಕ್ಷನ್)Nearest railway station6.99 km
Straight-line distances from the RERA map point to the station points mapped on OpenStreetMap; status (open or under construction) as tagged there. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Lake and lake-buffer check
The nearest mapped lake is Unnamed lake (mapped on OpenStreetMap), 1,131 m from the project’s RERA map point.
The site boundary is not published as a shape, so its nearest edge can be closer than this point. Whether any building sits inside a lake buffer can only be checked on the approved plan.
- Unnamed lake (mapped on OpenStreetMap) on OpenStreetMap (opens in a new tab) 1,131 m
- Chikka Gubbi Kere on OpenStreetMap (opens in a new tab) (ಚಿಕ್ಕಗುಬ್ಬಿ ಕೆರೆ)1,182 m
- Kannuru Lake on OpenStreetMap (opens in a new tab) (ಕಣ್ಣೂರು ಕೆರೆ)1,260 m
The buffer rule
Bengaluru’s lake buffer rule has changed over time: the National Green Tribunal ordered a 75 m buffer in May 2016; the Supreme Court set that order aside on 5 March 2019, leaving the 30 m buffer of the Revised Master Plan 2015. Check the current rule and the approved plan before relying on either number.
- LiveLaw: SC sets aside NGT order enlarging buffer zones (2019) (livelaw.in) (opens in a new tab)
- Citizen Matters: Shrinking lake buffers (citizenmatters.in) (opens in a new tab)
Shortest distance from the RERA map point to the mapped water edge (OpenStreetMap water polygons tagged lake or reservoir, or named lake/kere/tank). Mapped shorelines can differ from the revenue-record boundary of a lake. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Sources:Source (openstreetmap.org) (opens in a new tab)Source (livelaw.in) (opens in a new tab)Source (citizenmatters.in) (opens in a new tab)How we calculate this
Satellite time-lapse of the site
Satellite photos load when you scroll to them.
Photos from Esri World Imagery Wayback, centred on the project’s map point; dates are the capture dates in Esri’s metadata. Loaded from Esri when you scroll here.
Sources:Source (livingatlas.arcgis.com) (opens in a new tab)
Classique Willowbell floor plans, brochure and elevations
Documents the builder uploaded to Karnataka RERA, shown as filed. Tap a page to see it full size; the full PDF opens on the RERA website.
Floor plans4 files

13 All Floor PlanFiled 13 May 2026 · Full PDF on RERA
21 All Floor PlanFiled 13 May 2026 · Full PDF on RERA
13 9th and terrace Floor PlanFiled 13 May 2026 · Full PDF on RERA
21 9th and terrace Floor PlanFiled 13 May 2026 · Full PDF on RERA

Approved building plan

Approved Building PlanFull PDF on RERA

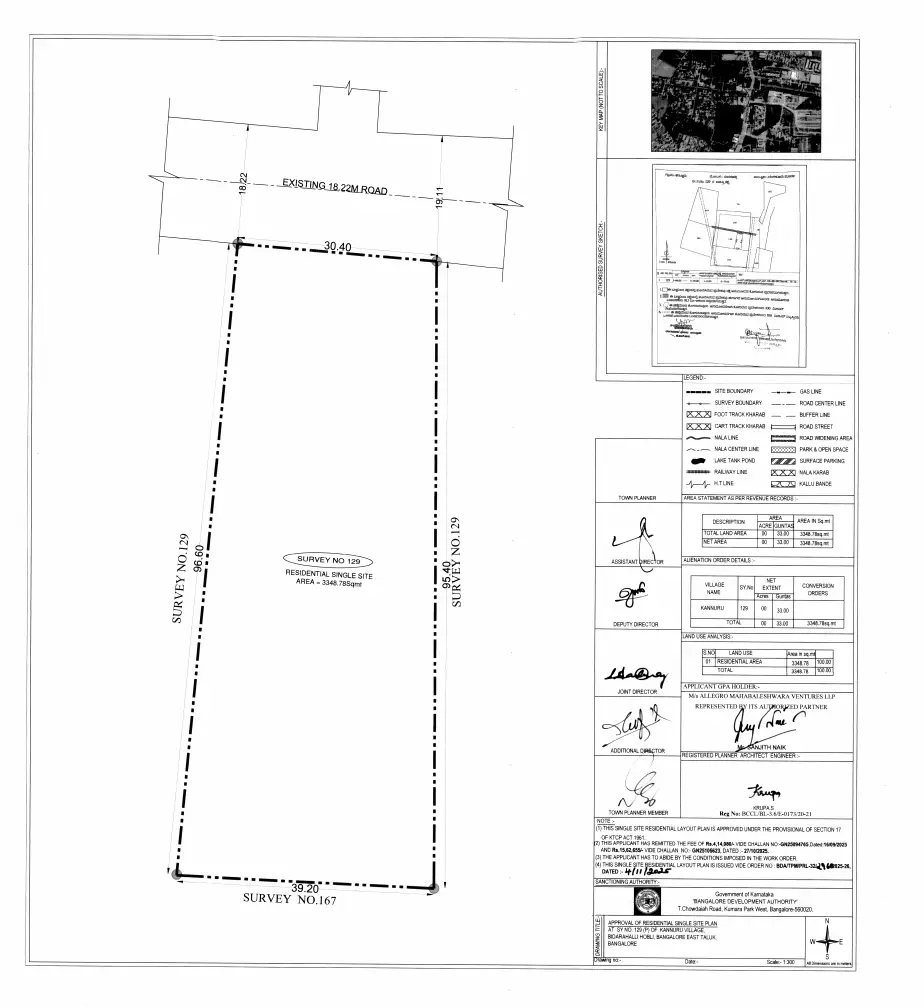

Approved layout plan

AMV LLP Single Plot Layout Plan.pdfFull PDF on RERA
| Home type | Carpet area | Homes |
|---|---|---|
| 2 BHK | 782 – 798 sq ft | 17 |
| 3 BHK | 1,075 – 1,378 sq ft | 54 |
| 4 BHK | 1,612 sq ft | 8 |
Home types, counts and carpet areas as filed with Karnataka RERA (carpet area, not super built-up).
We have not collected floor-plan drawings; the builder’s sales team can share them.
Classique Willowbell possession date and construction status
Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-14.
Units sold and unsold, from RERA (Q2 2026-27)
| Type | Homes | Booked | Available |
|---|---|---|---|
| 2 BHK | 17 | 5 | 12 |
| 3 BHK | 54 | 6 | 48 |
| 4 BHK | 8 | 1 | 7 |
As reported by the promoter in the quarterly update to RERA, not verified by us.
Timeline
- 16 Mar 2026Project start date given to RERA
- 22 May 2026Registered with Karnataka RERA
- 31 Dec 2031Completion date given at registration
Construction pace from RERA quarterly filings
At the average pace so far, construction would reach 100% around Aug 2029 — about 29 months before the completion date on RERA (31 Dec 2031).
At the pace between the 2 quarterly filings we have (7% → 16% in 3 months), it would be around Feb 2029 — about 35 months before the RERA date.
- Filed on RERA
- Average pace since start
- Pace between filings (and 0% assumed at the start date)
- RERA completion date
Quarterly filings
| Quarter | Filed on | Built | Homes booked |
|---|---|---|---|
| Q2 2026-27to 30 Sep 2026 | 14 Oct 2026 | 16% | 12 of 79 |
| Q1 2026-27to 30 Jun 2026 | 14 Jul 2026 | 7% | 3 of 79 |
How we calculate
Average pace = % built ÷ months since the start date in the RERA record. Here: 16% ÷ 6.5 months (16 Mar 2026 to 30 Sep 2026) = 2.5% a month.
Estimated finish = latest filing date + (100 − % built) ÷ pace = 30 Sep 2026 + 84 ÷ 2.5 = 34.1 months → Aug 2029. This is an estimate, not a date from the builder or RERA.
Pace between filings = (16% − 7%) ÷ 3 months = 3% a month.
A straight line is a simplification: the builder reports one overall %, which mixes excavation, structure and finishing, and work rarely moves at a constant speed. The % values are the promoter’s own figures filed with RERA, not checked by us. Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-14.
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
Approvals and documents checklist
| Approval | Authority | Source |
|---|---|---|
| Building plan | BDA - Bangalore Development Authority · No. 41/2025-26 · dated 2026-02-25 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Land conversion | Deputy Commisioner Office Bengaluru · No. ALN(E)(B)SR-119/08-09 · dated 2008-12-11 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Commencement Certificate | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Building Plan | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| ESCOM/Electricity | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KWSSB/Water | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KSPCB | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Fire Force Department | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Airport Authority of India | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
Documents uploaded to RERA
- Building or layout plan · Approved drawings from the planning authorityFiled on RERA ✓ — BDA - Bangalore Development Authority · No. 41/2025-26 · dated 25 Feb 2026
- Commencement certificate · Permission to start buildingFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Environment clearance · SEIAA KarnatakaNot on RERA yet
- Fire NOC · Karnataka Fire and Emergency ServicesFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Pollution board consent · KSPCBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Water and sewerage · BWSSBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Electricity · BESCOMFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Height clearance · Airports Authority of IndiaFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Occupancy certificate (OC) · Issued only when the building is finishedNot on RERA yet — expected at completion
From the documents the promoter uploaded to Karnataka RERA, collected 19 Oct 2026. “Filed” means a document is on RERA — we have not checked its contents or validity. Not every approval applies to every project (for example, smaller projects may not need an environment clearance). The project page on RERA lists each upload.
Classique Willowbell RERA complaints
No complaints listed on Karnataka RERA for this registration as on Source (rera.karnataka.gov.in) (opens in a new tab)
Court and consumer cases
We list case numbers, courts and outcomes only — never names of private individuals.
About Allegro Mahabaleshwara Ventures LLP
- Promoter type
- Partnership Firm
- Projects on this site
- 1
- RERA complaints against promoter
- 1
- Company number (CIN)
- AAR-6784
From Karnataka RERA, as collected so far (19 Oct 2026). Complaints are those RERA lists against this promoter across all its projects.
Allegro Mahabaleshwara Ventures LLP’s RERA recordAllegro Mahabaleshwara Ventures LLP delivery record
- 1Projects in Bengaluru on RERA1 approved registration under Allegro Mahabaleshwara Ventures LLP in Bengaluru Urban and Rural. Source (rera.karnataka.gov.in) (opens in a new tab)
- 79Homes registeredAs stated in each registrations.
- 1RERA complaints0 open, 1 disposed. as on Source (rera.karnataka.gov.in) (opens in a new tab)
- 12.7Complaints per 1,000 homes1 complaints ÷ 79 homes in its 1 registration on Karnataka RERA in Bengaluru.
What the complaints are about
1 complaint subject as written on RERA, as on . Each subject is sorted into one group by keywords (first match wins: delay, refund, registration, quality, litigation, association); one complaint often raises several issues. Source (rera.karnataka.gov.in) (opens in a new tab)
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
What’s changed since Feb 2026
- 14 Oct 2026Quarterly update filed for Q2 2026-27: 16% built, 12 of 79 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 14 Jul 2026Quarterly update filed for Q1 2026-27: 7% built, 3 of 79 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 22 May 2026Registered with Karnataka RERA (PRM/KA/RERA/1251/446/PR/220526/008672); completion date 31 Dec 2031 Source (rera.karnataka.gov.in) (opens in a new tab)
- 16 Mar 2026Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
- 25 Feb 2026Building plan approved by BDA - Bangalore Development Authority (No. 41/2025-26) Source (rera.karnataka.gov.in) (opens in a new tab)
Newest first. No extension of the completion date is recorded on RERA. When the RERA crawl sees a new filing, complaint or extension, it is added here with its date.
Home loan EMI calculator
- Monthly EMI
- —
- Down payment
- —
- Loan amount
- —
- Total interest
- —
A calculation only, from the numbers you enter — not a loan offer.
All-in cost: GST, registration and other charges
The calculator loads when you scroll to it.
Assumptions
- Base price: the builder’s price is not published in a form we could collect — enter it from the cost sheet.
- GST 5% on the base price and charges — the usual rate for an under-construction home that is not “affordable housing” (1%).
- Stamp duty about 5.6% and registration 2% — the Karnataka rule (registration was raised from 1% to 2% on 31 Aug 2025). Calculated on the agreement value.
- Car parking, other charges and the maintenance deposit are not in the public record we collect; enter them from the builder’s cost sheet.
- Loan on the agreement value (banks usually lend up to 75–90%); EMI is the standard reducing-balance formula. Example rate only — use your bank’s quote.
Classique Willowbell FAQs
What is Classique Willowbell?
Classique Willowbell is a residential project by Allegro Mahabaleshwara Ventures LLP located in Kannur, Bengaluru East, with PIN code 560077.
How many homes are in Classique Willowbell?
The project has 79 homes across one tower.
What home types are available in Classique Willowbell?
The project offers 3 BHK (54 homes), 2 BHK (17 homes), and 4 BHK (8 homes) units.
What is the carpet area range in Classique Willowbell?
Carpet areas range from 782 sq ft for 2 BHK units to 1,612 sq ft for 4 BHK units.
When will Classique Willowbell be completed?
The project is registered for completion on 31 December 2031.
What is the RERA registration number for Classique Willowbell?
The RERA registration number is PRM/KA/RERA/1251/446/PR/220526/008672, registered on 22 May 2026.
What is the construction progress of Classique Willowbell?
As of the quarter ended 30 September 2026, the project is 16% complete with 12 homes booked out of 79.
Are there any RERA complaints on Classique Willowbell?
There are no RERA complaints on this project registration.
How many other projects does the builder have in Bengaluru records?
Allegro Mahabaleshwara Ventures LLP has 3 projects in the Bengaluru RERA records.
What is the builder's complaint history?
The builder has 1 RERA complaint across all its projects in the Bengaluru records.
Written by AI from the RERA record above on 19 Oct 2026. Answers use only that record; check them against the source before you decide.
Questions about Classique Willowbell
No questions published yet. Ask the first one: you get an instant answer from this page’s public record, and our team follows up on anything the record does not show.
Bought a home from Allegro Mahabaleshwara Ventures LLP? Review the builder.
Reviews of Allegro Mahabaleshwara Ventures LLP by verified buyers
No verified reviews of Allegro Mahabaleshwara Ventures LLP yet. If you bought a home from them, your review helps other buyers.
How reviews work: only buyers and owners can review; we confirm each purchase by phone before publishing, publish positive and negative reviews alike, never accept payment for reviews, and the builder may reply.
Similar projects within 5 km
| Project | Distance | Homes | Possession (RERA) | Built | Complaints | Price |
|---|---|---|---|---|---|---|
| Amigo PalacioAmigo Shelters Pvt Ltd | 0.4 km | 55 | Mar 2028 | 40% | 0 | Not collected |
| Zala PradosZala Estates And Properties | 0.6 km | 37 | Mar 2029 | 18% | 0 | Not collected |
| DNR ParklinkDNR Corporation Private Limited | 0.7 km | 784 | May 2029 | — | 0 | Not collected |
| La VitaSattva Resi Private Limited | 0.7 km | 63 | Jul 2026 | 66% | 0 | Not collected |
| Neuma ElyseeNeuma Realty Private Limited | 0.9 km | 32 | Dec 2030 | 25% | 0 | Not collected |
| Poulomi FloriquePoulomi Florique LLP | 0.9 km | 448 | Dec 2032 | 10% | 0 | Not collected |
Projects of the same kind within 5 km in a straight line of this project’s RERA map point, nearest first. % built is the promoter’s latest quarterly figure on RERA (shown for single-registration projects); prices are from the builder’s own website where we found one.
Sources and last checked dates
Collected on 19 Oct 2026 by AI research agents reading public pages. Facts are written in our own words. Not found yet: price; court cases; landmarks; specifications; news.
How to check on RERA: On rera.karnataka.gov.in/viewAllProjects, type the registration number in 'Registration No', press Search, then click the 'View Project Details' icon. Complaints open from the 'Complaints / Litigation' icon in the same row. Registration number: PRM/KA/RERA/1251/446/PR/220526/008672.
- RERA record last checked: 19 Oct 2026
- Last change in the record (registration, quarterly filing or complaint): 19 Oct 2026
How this page is made: software builds it from public records (Karnataka RERA filings, OpenStreetMap, the builder’s own website). AI is used only to read filings into fields and to write the plain-English summary and FAQ answers, which are checked against the record. Facts are checked automatically against the RERA filing. Methodology · How we earn · Report an error
More new projects in Hennur Road
Chikkagubbi, Hennur RoadUnder constructionRERA registeredBuyers’ group openAmigo Palacio
by Amigo Shelters
Price: Price on requestGet brochure & price →
- 2 BHK, 3 BHK, 3.5 BHK
- 1,033 – 1,480 sq ft
- Mar 2028
55 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Amigo Palacio
Chikkagubbi, Hennur RoadUnder constructionRERA registeredBuyers’ group openZala Prados
by Zala Estates And Properties
Price: Price on requestGet brochure & price →
- 3 BHK, 4 BHK
- 2,685 – 3,109 sq ft
- Mar 2029
37 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Zala Prados
Byrathi Chikkagubbi, Hennur RoadUnder constructionRERA registeredBuyers’ group openDNR Parklink
by DNR Corporation
Price: Price on requestGet brochure & price →
- 1 BHK, 2 BHK, 2.5 BHK, 3 BHK
- 431 – 12,347 sq ft
- May 2029
2 phases on RERA · 784 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for DNR Parklink
