Jyothi Nivas
3 & 4 BHK apartments by Sai Kiran Constructions · Channasandra, Whitefield, Bengaluru
Channasandra, Whitefield, BengaluruOpen on Google Maps (opens in a new tab)
- Under construction
- RERA registered
- RERA not updated: completion promised Jun 2026; no extension or completion filed
- residential
Price: Price on request

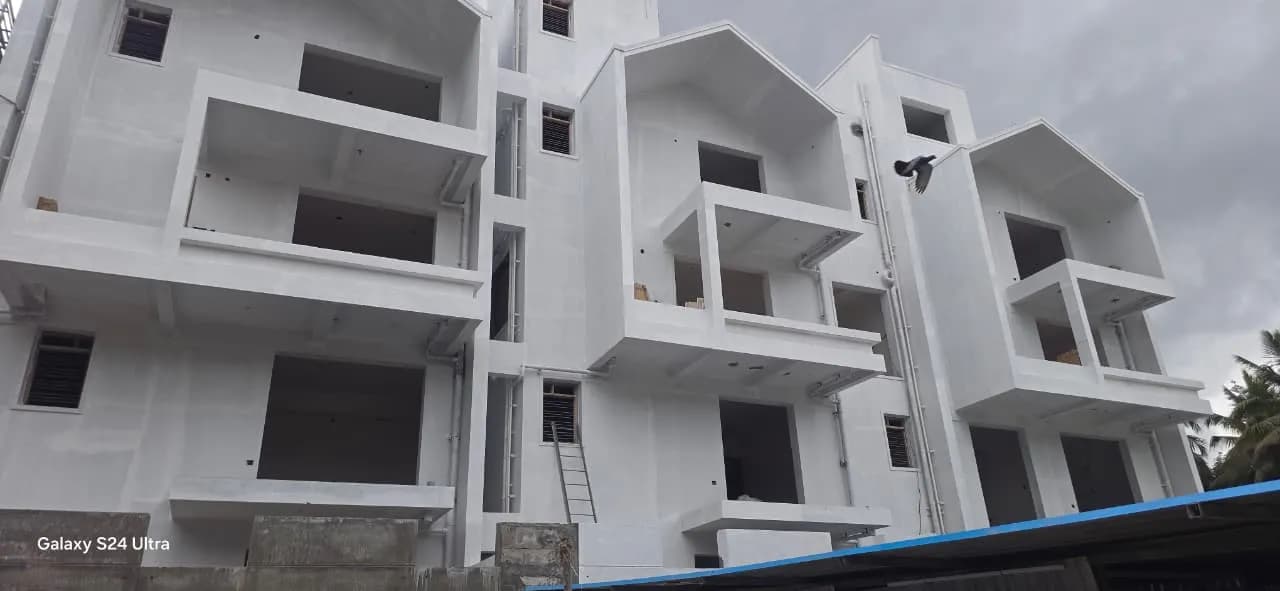

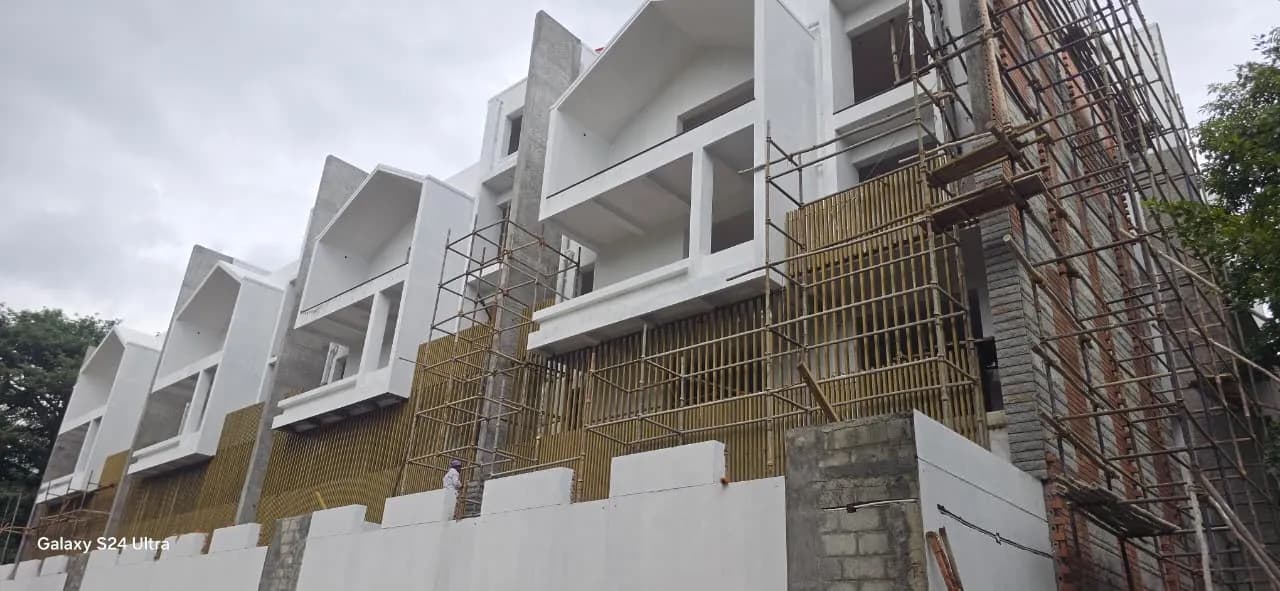

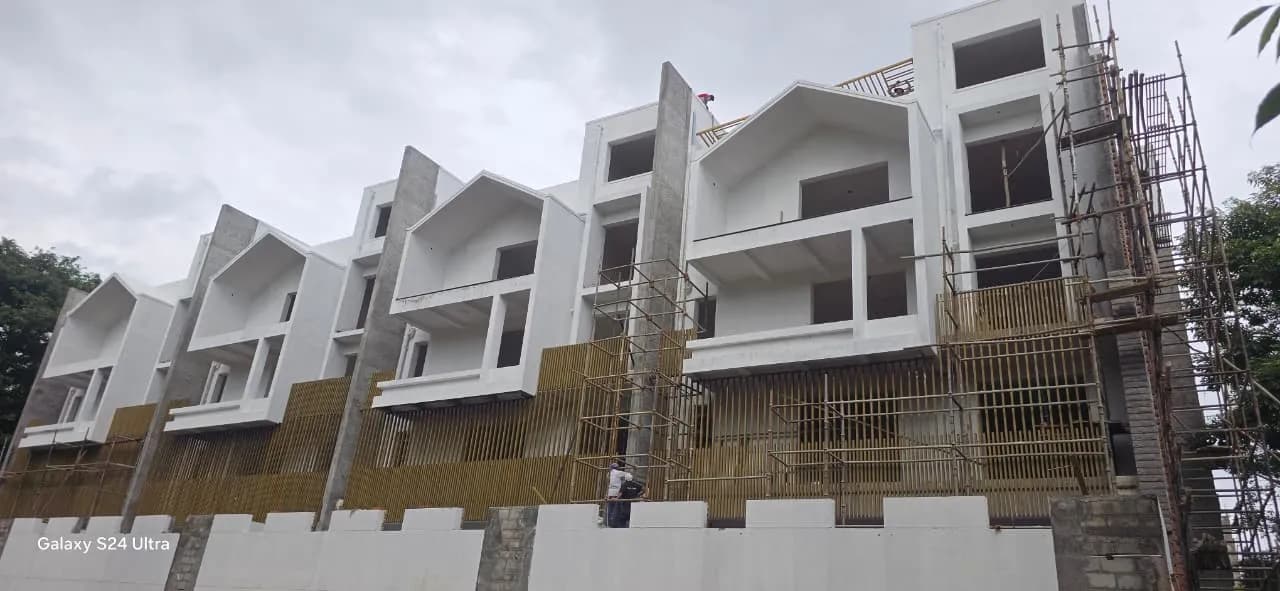

Site photo filed with Karnataka RERA Karnataka RERA filing · Source ↗ (opens in a new tab)
Jyothi Nivas at a glance
- Possession (RERA)Jun 2026 Date passedKarnataka RERA
- Construction63% built · on pace for May 2027 11 mo after RERA dateRERA filing to 31 Dec 2025; estimate from average pace
- Homes booked0 of 14 (0%)RERA update · as on 31 Dec 2025
- RERA complaints (project)None listedKarnataka RERA · as on 19 Oct 2026
- Approvals filed5 of 9 on RERAKarnataka RERA uploads · 19 Oct 2026
- Nearest metroPattanagere · 3.03 kmstraight line · OpenStreetMap, 5 Oct 2026
- Airport driveapprox. 156 min at peak38.6 km straight line · estimate
- Nearest lakeIdle Lake · 1,217 mFrom the RERA map point · OpenStreetMap, 5 Oct 2026
Project summary
Jyothi Nivas is a residential project by Sai Kiran Constructions in Channasandra, Bengaluru with 14 homes, registered with Karnataka RERA. The completion date on RERA is 30 Jun 2026.
Facts collected on 19 Oct 2026 from public records — each linked to its source. Free for buyers. If you book through us, the builder pays us a commission.
Jyothi Nivas buyers’ group: join to ask for a group price
No one has joined yet. Be one of the first 10 buyers in this group — the founding members.
Join free. When enough buyers have joined, our agent partner asks Sai Kiran Constructions for a group price — for example a lower price, an easier payment plan or waived charges. Nothing is promised: you see what the builder offers and book directly with the builder if you want to. Free for buyers. If you book through us, the builder pays us a commission.
- Gathering buyers
- Talking to the builder
- Group offer
- Group site visit
- Booking
0 buyers have joined · 0 committed
Committed buyers have confirmed their budget, home type and timeline with us on a call; builders negotiate with them. Joining is free and never obliges you to buy.
Join the Jyothi Nivas buyers’ groupHow group buying works
See it for yourself
Visit the site with our team, or get a call to clear your questions. Free, no obligation.
Key facts: home types, towers, land and possession
- Home types
- 3 BHK, 4 BHK
- Carpet area
- 1,507 – 2,347 sq ft
- Towers
- 1
- Floors
- 4
- Total homes
- 14
- Land
- 0.57 acres
- Possession (RERA)
- Jun 2026
- Built (RERA update)
- 63%
Jyothi Nivas RERA number and registration details
- RERA number
- PRM/KA/RERA/1251/310/PR/061125/008228
- Registered on
- 6 Nov 2025
- Promised completion
- 30 Jun 2026
- Extended to
- No extension recorded
- RERA status
- Under construction
- Homes booked
- 0 of 14 as on
- Price
- Not found in public records yet: price
- Project type
- Residential
Towers and blocks (RERA filing)
| Tower | Floors | Basements | Homes |
|---|---|---|---|
| JYOTHI NIVAS | 4 | 1 | 14 |
A dash (—) means the filing did not state that value.
Summary in plain English
Jyothi Nivas is a residential project by Sai Kiran Constructions in Channasandra, Bengaluru South. The project has 14 homes across one 4-storey tower, with completion expected on 30 June 2026.
Written by AI from the RERA record above on 8 Oct 2026. Every number in it was checked against that record; if anything differs, the record wins.
Open space, home loans, escrow and other details
- Open space
- 58.1% of land
- Water and power
- Water source filed with RERA: BoreWell,BWSSB
- Home loans: approved banks
- Not found in public records yet: bank approvals
- Payment plans
- Not found in public records yet: payment plans
- Maintenance
- Not found in public records yet: maintenance
- Car parking
- Not found in public records yet: car parking charge
- Escrow bank (RERA)
- Karnataka Bank Ltd., Rajarajeshwari Nagara
- Building plan (RERA)
- BBMP - Bruhat Bengaluru Mahanagara Palike · No. Ad.Com./RJH/1052/22-23 · dated 16 Dec 2022
- Project cost declared to RERA
- ₹28.51 Cr
Open area as a share of the land, from the areas filed with RERA (includes driveways and landscaped areas).
Amenities
- Electricity
- Smart Home Automation
- CCTV Surveillance
- Club House
- Swimming Pool
- Gym
- Power Backup
- Water and Sanitation
Amenities and internal works as filed by the promoter with Karnataka RERA; we have not visited the site.
Jyothi Nivas location and address
- Address
- Khatha No. 242/6, 7,8,9,10,11,12,13,14,15/234 , Channasandra Village, Uttarahalli Hobli, Ward No. 160 , Bengaluru South , Bengaluru Urban, Karnataka - 560098
- Village (RERA)
- Channasandra
- Locality
- WhitefieldAlso known as ITPL
- PIN code
- 560098
- City
- Bengaluru
- State
- Karnataka
- Coordinates
- 12.90488, 77.51799
Distances to landmarks
Not found in public records yet: landmarksAbout Whitefield
Not found in public records yet: locality factsCommute times to tech parks and the airport
| To | Straight line | Peak-hour drive (estimate) |
|---|---|---|
| KSR Bengaluru City railway station (Majestic)Map point on OpenStreetMap (opens in a new tab) | 9.88 km | approx. 40 min |
| Electronic City Phase 1Map point on OpenStreetMap (opens in a new tab) | 17.07 km | approx. 69 min |
| Outer Ring Road tech corridor (RMZ Ecospace, Bellandur)Map point on OpenStreetMap (opens in a new tab) | 17.82 km | approx. 72 min |
| Manyata Tech ParkMap point on OpenStreetMap (opens in a new tab) | 19.38 km | approx. 78 min |
| ITPL, Whitefield (main gate)Map point on OpenStreetMap (opens in a new tab) | 25.53 km | approx. 103 min |
| Kempegowda International AirportMap point on OpenStreetMap (opens in a new tab) | 38.6 km | approx. 156 min |
How we calculate
Straight line: from the project’s map point on RERA to the destination’s point on OpenStreetMap.
Peak-hour drive is a rough estimate, not a route: straight line × 1.35 for the road network, at 20 km/h. Real times vary a lot with the route and the hour.
Sources:Source (openstreetmap.org) (opens in a new tab)How we calculate this
Schools and hospitals nearby
Within 2 km
- 16Schools and colleges10 schools, 6 colleges, 0 kindergartens
- 6Hospitals and clinics3 hospitals, 3 clinics
Nearest schools and colleges
- RNS Institute of Technology · 0.35 km
- JSS School · 0.86 km
- Shri Jnanakshi Vidyaniketan · 1.05 km
Nearest hospitals and clinics
- Manipal Speciality Hospital · 0.66 km
- Unity Hospital, Bengaluru Urban · 0.73 km
- Sudhanva Health Care · 1.27 km
Places as mapped on OpenStreetMap (amenity=school, college, kindergarten, university; hospital, clinic), counted within 2 km in a straight line of the RERA map point. Volunteers map these, so some places may be missing or closed. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Nearest metro station and railway
- Pattanagere (ಪಟ್ಟಣಗೆರೆ)Open now — nearest operating metro station3.03 km
- Jnanabharati (ಜ್ಞಾನಭಾರತಿ)Nearest railway station3.44 km
Straight-line distances from the RERA map point to the station points mapped on OpenStreetMap; status (open or under construction) as tagged there. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Lake and lake-buffer check
The nearest mapped lake is Idle Lake, 1,217 m from the project’s RERA map point.
The site boundary is not published as a shape, so its nearest edge can be closer than this point. Whether any building sits inside a lake buffer can only be checked on the approved plan.
- Idle Lake on OpenStreetMap (opens in a new tab) 1,217 m
- Bheemanakatte Lake on OpenStreetMap (opens in a new tab) (ಭೀಮನಕಟ್ಟೆ ಕೆರೆ)1,543 m
The buffer rule
Bengaluru’s lake buffer rule has changed over time: the National Green Tribunal ordered a 75 m buffer in May 2016; the Supreme Court set that order aside on 5 March 2019, leaving the 30 m buffer of the Revised Master Plan 2015. Check the current rule and the approved plan before relying on either number.
- LiveLaw: SC sets aside NGT order enlarging buffer zones (2019) (livelaw.in) (opens in a new tab)
- Citizen Matters: Shrinking lake buffers (citizenmatters.in) (opens in a new tab)
Shortest distance from the RERA map point to the mapped water edge (OpenStreetMap water polygons tagged lake or reservoir, or named lake/kere/tank). Mapped shorelines can differ from the revenue-record boundary of a lake. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Sources:Source (openstreetmap.org) (opens in a new tab)Source (livelaw.in) (opens in a new tab)Source (citizenmatters.in) (opens in a new tab)How we calculate this
Satellite time-lapse of the site
Satellite photos load when you scroll to them.
Photos from Esri World Imagery Wayback, centred on the project’s map point; dates are the capture dates in Esri’s metadata. Loaded from Esri when you scroll here.
Sources:Source (livingatlas.arcgis.com) (opens in a new tab)
Jyothi Nivas home types and carpet areas
Documents the builder uploaded to Karnataka RERA, shown as filed. Tap a page to see it full size; the full PDF opens on the RERA website.

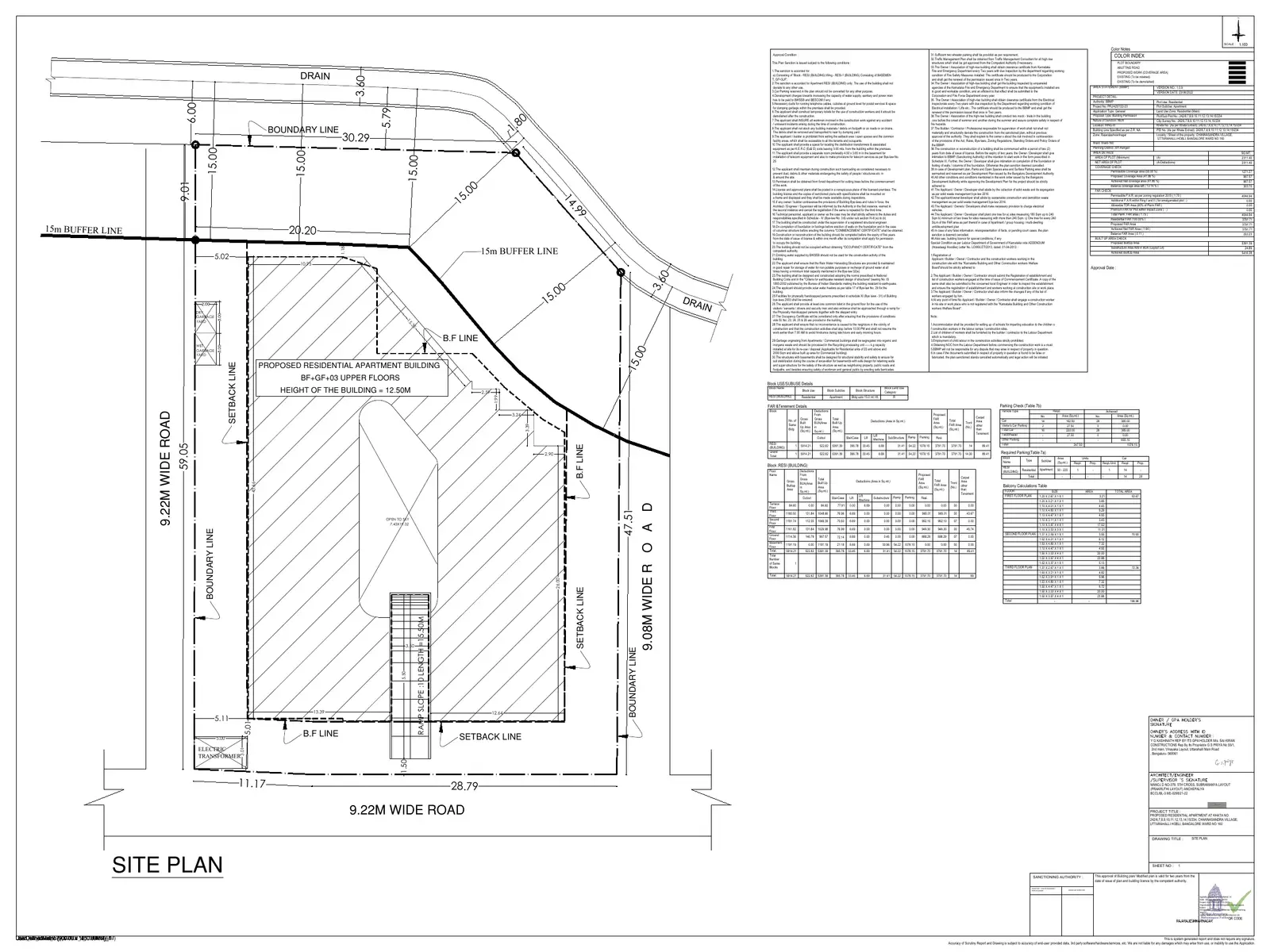

Approved building plan5 pages

Approved Building PlanFull PDF on RERA
Floor plans and brochure not published? The builder shares them only on request. We’ll get the brochure, floor plans and current price list for you, free.
Get brochure, floor plans & price| Home type | Carpet area | Homes |
|---|---|---|
| 3 BHK | 1,507 – 1,814 sq ft | 7 |
| 4 BHK | 1,924 – 2,347 sq ft | 7 |
Home types, counts and carpet areas as filed with Karnataka RERA (carpet area, not super built-up).
We have not collected floor-plan drawings; the builder’s sales team can share them.
Jyothi Nivas possession date and construction status
Promoter’s quarterly update to RERA for Q3 2025-26, submitted 2026-02-20.
Units sold and unsold, from RERA (Q3 2025-26)
| Type | Homes | Booked | Available |
|---|---|---|---|
| 3 BHK | 7 | 0 | 7 |
| 4 BHK | 7 | 0 | 7 |
As reported by the promoter in the quarterly update to RERA, not verified by us.
Timeline
- 19 Aug 2023Project start date given to RERA
- 6 Nov 2025Registered with Karnataka RERA
- 30 Jun 2026Completion date given at registration
Construction pace from RERA quarterly filings
At the average pace so far, construction would reach 100% around May 2027 — about 11 months after the completion date on RERA (30 Jun 2026).
- Filed on RERA
- Average pace since start
- RERA completion date
Quarterly filings
| Quarter | Filed on | Built | Homes booked |
|---|---|---|---|
| Q3 2025-26to 31 Dec 2025 | 20 Feb 2026 | 63% | 0 of 14 |
How we calculate
Average pace = % built ÷ months since the start date in the RERA record. Here: 63% ÷ 28.4 months (19 Aug 2023 to 31 Dec 2025) = 2.2% a month.
Estimated finish = latest filing date + (100 − % built) ÷ pace = 31 Dec 2025 + 37 ÷ 2.2 = 16.7 months → May 2027. This is an estimate, not a date from the builder or RERA.
A straight line is a simplification: the builder reports one overall %, which mixes excavation, structure and finishing, and work rarely moves at a constant speed. The % values are the promoter’s own figures filed with RERA, not checked by us. Promoter’s quarterly update to RERA for Q3 2025-26, submitted 2026-02-20.
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
Approvals and documents checklist
| Approval | Authority | Source |
|---|---|---|
| Building plan | BBMP - Bruhat Bengaluru Mahanagara Palike · No. Ad.Com./RJH/1052/22-23 · dated 2022-12-16 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Land conversion | Deputy Commissioner · No. 346443 · dated 2022-07-25 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Commencement Certificate | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Building Plan | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| ESCOM/Electricity | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KWSSB/Water | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KSPCB | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
Documents uploaded to RERA
- Building or layout plan · Approved drawings from the planning authorityFiled on RERA ✓ — BBMP - Bruhat Bengaluru Mahanagara Palike · No. Ad.Com./RJH/1052/22-23 · dated 16 Dec 2022
- Commencement certificate · Permission to start buildingFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Environment clearance · SEIAA KarnatakaNot on RERA yet
- Fire NOC · Karnataka Fire and Emergency ServicesNot on RERA yet
- Pollution board consent · KSPCBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Water and sewerage · BWSSBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Electricity · BESCOMFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Height clearance · Airports Authority of IndiaNot on RERA yet
- Occupancy certificate (OC) · Issued only when the building is finishedNot on RERA yet — expected at completion
From the documents the promoter uploaded to Karnataka RERA, collected 19 Oct 2026. “Filed” means a document is on RERA — we have not checked its contents or validity. Not every approval applies to every project (for example, smaller projects may not need an environment clearance). The project page on RERA lists each upload.
Jyothi Nivas RERA complaints
No complaints listed on Karnataka RERA for this registration as on Source (rera.karnataka.gov.in) (opens in a new tab)
Court and consumer cases
We list case numbers, courts and outcomes only — never names of private individuals.
About Sai Kiran Constructions
- Promoter type
- Proprietorship
- Projects on this site
- 2
- RERA complaints against promoter
- 1
- Company number (CIN)
- Not found in public records yet: CIN
From Karnataka RERA, as collected so far (19 Oct 2026). Complaints are those RERA lists against this promoter across all its projects.
Sai Kiran Constructions’s RERA recordSai Kiran Constructions delivery record
- 2Projects in Bengaluru on RERA2 approved registrations under Sai Kiran Constructions in Bengaluru Urban and Rural. Source (rera.karnataka.gov.in) (opens in a new tab)
- 244Homes registeredAs stated in each registrations.
- 1RERA complaints0 open, 1 disposed. as on Source (rera.karnataka.gov.in) (opens in a new tab)
- 4.1Complaints per 1,000 homes1 complaints ÷ 244 homes in its 2 registrations on Karnataka RERA in Bengaluru.
- 1Completion filed on RERARegistrations where the promoter applied to RERA for completion; 1 with an occupancy certificate on RERA.
- 1 of 1Filed by the date given at registrationMedian gap 0 months (on-time ones count as 0). The completion application can come after handover, so this is an upper bound on lateness.
What the complaints are about
1 complaint subject as written on RERA, as on . Each subject is sorted into one group by keywords (first match wins: delay, refund, registration, quality, litigation, association); one complaint often raises several issues. Source (rera.karnataka.gov.in) (opens in a new tab)
Completion filed on RERA
| Project | Date at registration | Completion filed | Gap |
|---|---|---|---|
| Garden SquareOC on RERA | 30 Jun 2026 | 30 Jun 2026 | By the date |
Measured against the completion date given at registration; many projects had RERA extensions (including the COVID-period extension), shown under the date.
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
What’s changed since Dec 2022
- 20 Feb 2026Quarterly update filed for Q3 2025-26: 63% built, 0 of 14 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 6 Nov 2025Registered with Karnataka RERA (PRM/KA/RERA/1251/310/PR/061125/008228); completion date 30 Jun 2026 Source (rera.karnataka.gov.in) (opens in a new tab)
- 19 Aug 2023Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
- 16 Dec 2022Building plan approved by BBMP - Bruhat Bengaluru Mahanagara Palike (No. Ad.Com./RJH/1052/22-23) Source (rera.karnataka.gov.in) (opens in a new tab)
Newest first. No extension of the completion date is recorded on RERA. When the RERA crawl sees a new filing, complaint or extension, it is added here with its date.
Home loan EMI calculator
- Monthly EMI
- —
- Down payment
- —
- Loan amount
- —
- Total interest
- —
A calculation only, from the numbers you enter — not a loan offer.
All-in cost: GST, registration and other charges
The calculator loads when you scroll to it.
Assumptions
- Base price: the builder’s price is not published in a form we could collect — enter it from the cost sheet.
- GST 5% on the base price and charges — the usual rate for an under-construction home that is not “affordable housing” (1%).
- Stamp duty about 5.6% and registration 2% — the Karnataka rule (registration was raised from 1% to 2% on 31 Aug 2025). Calculated on the agreement value.
- Car parking, other charges and the maintenance deposit are not in the public record we collect; enter them from the builder’s cost sheet.
- Loan on the agreement value (banks usually lend up to 75–90%); EMI is the standard reducing-balance formula. Example rate only — use your bank’s quote.
Jyothi Nivas FAQs
What is Jyothi Nivas?
Jyothi Nivas is a residential project by Sai Kiran Constructions located in Channasandra, Bengaluru South with 14 homes in one tower.
How many homes are in Jyothi Nivas?
The project has 14 homes: 7 units of 4 BHK and 7 units of 3 BHK.
What is the carpet area of homes in Jyothi Nivas?
4 BHK homes have carpet area from 1,924 to 2,347 sq ft, and 3 BHK homes range from 1,507 to 1,814 sq ft.
When will Jyothi Nivas be completed?
The completion date on RERA is 30 June 2026.
What is the construction progress of Jyothi Nivas?
As of Q3 2025-26 (31 December 2025), construction is 63% complete.
How many homes are booked in Jyothi Nivas?
As of Q3 2025-26, no homes are booked; all 14 homes are in the booking table.
What is the RERA registration number for Jyothi Nivas?
The RERA registration number is PRM/KA/RERA/1251/310/PR/061125/008228, registered on 6 November 2025.
Are there any RERA complaints against Jyothi Nivas?
There are no complaints on RERA against this project.
What is the location and PIN code of Jyothi Nivas?
The project is in Channasandra, Bengaluru South, PIN code 560098.
What is Sai Kiran Constructions' record?
Sai Kiran Constructions has 3 projects in the Bengaluru RERA records and 1 complaint against the builder across all projects.
Written by AI from the RERA record above on 8 Oct 2026. Answers use only that record; check them against the source before you decide.
Questions about Jyothi Nivas
No questions published yet. Ask the first one: you get an instant answer from this page’s public record, and our team follows up on anything the record does not show.
Bought a home from Sai Kiran Constructions? Review the builder.
Reviews of Sai Kiran Constructions by verified buyers
No verified reviews of Sai Kiran Constructions yet. If you bought a home from them, your review helps other buyers.
How reviews work: only buyers and owners can review; we confirm each purchase by phone before publishing, publish positive and negative reviews alike, never accept payment for reviews, and the builder may reply.
Similar projects within 5 km
| Project | Distance | Homes | Possession (RERA) | Built | Complaints | Price |
|---|---|---|---|---|---|---|
| Architha AarnaArchitha Ventures LLP | 0.4 km | 133 | Jan 2026 | 100% | 0 | Not collected |
| Elegant HermitageElegant Builders And Developers | 0.9 km | 240 | Mar 2027extended | 95% | 0 | Not collected |
| KumaravanaEssem18 Developers Private Limited | 1 km | 91 | Dec 2027 | 58% | 0 | Not collected |
| Gopalan FlorenzaGopalan Enterprises | 1.1 km | 480 | Jan 2026extended | 99% | 0 | Not collected |
| Birla OjasviBirla Estates Private Limited | 1.2 km | 615 | Jan 2031 | 26% | 0 | Not collected |
| Aishwarya Green HomesAishwarya Developers | 1.5 km | 28 | Sep 2026 | — | 0 | Not collected |
Projects of the same kind within 5 km in a straight line of this project’s RERA map point, nearest first. % built is the promoter’s latest quarterly figure on RERA (shown for single-registration projects); prices are from the builder’s own website where we found one.
Sources and last checked dates
Collected on 19 Oct 2026 by AI research agents reading public pages. Facts are written in our own words. Not found yet: price; court cases; landmarks; specifications; news.
How to check on RERA: On rera.karnataka.gov.in/viewAllProjects, type the registration number in 'Registration No', press Search, then click the 'View Project Details' icon. Complaints open from the 'Complaints / Litigation' icon in the same row. Registration number: PRM/KA/RERA/1251/310/PR/061125/008228.
- RERA record last checked: 19 Oct 2026
- Last change in the record (registration, quarterly filing or complaint): 20 Feb 2026
How this page is made: software builds it from public records (Karnataka RERA filings, OpenStreetMap, the builder’s own website). AI is used only to read filings into fields and to write the plain-English summary and FAQ answers, which are checked against the record. Facts are checked automatically against the RERA filing. Methodology · How we earn · Report an error
More new projects in Whitefield
Channasandra, WhitefieldUnder constructionRERA registeredBuyers’ group openKamadhenu Heights
by G M Developers
Price: Price on requestGet brochure & price →
- 2 BHK, 3 BHK
- 663 – 1,042 sq ft
- Dec 2030
116 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Kamadhenu Heights
Siddapura, WhitefieldUnder constructionRERA registeredBuyers’ group openSumadhura Edition
by Sumadhura Infracon
Price: Price on requestGet brochure & price →
- 2 BHK, 3 BHK, 4 BHK
- 11 – 1,464 sq ft
- Dec 2029
2 phases on RERA · 900 homes · 1 RERA complaint
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Sumadhura Edition
Siddapura, WhitefieldUnder constructionRERA registeredBuyers’ group openSpectra Parijatha
by Spectra Constructions
Price: Price on requestGet brochure & price →
- 2 BHK, 3 BHK
- 942 – 1,169 sq ft
- Aug 2028
140 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Spectra Parijatha
