SSVR Niyaara
2 & 3 BHK apartments by SSVR Builders · Sorahunase, Varthur, Bengaluru
Sorahunase, Varthur, BengaluruOpen on Google Maps (opens in a new tab)
- Under construction
- RERA registered
- residential
Price: Price on request

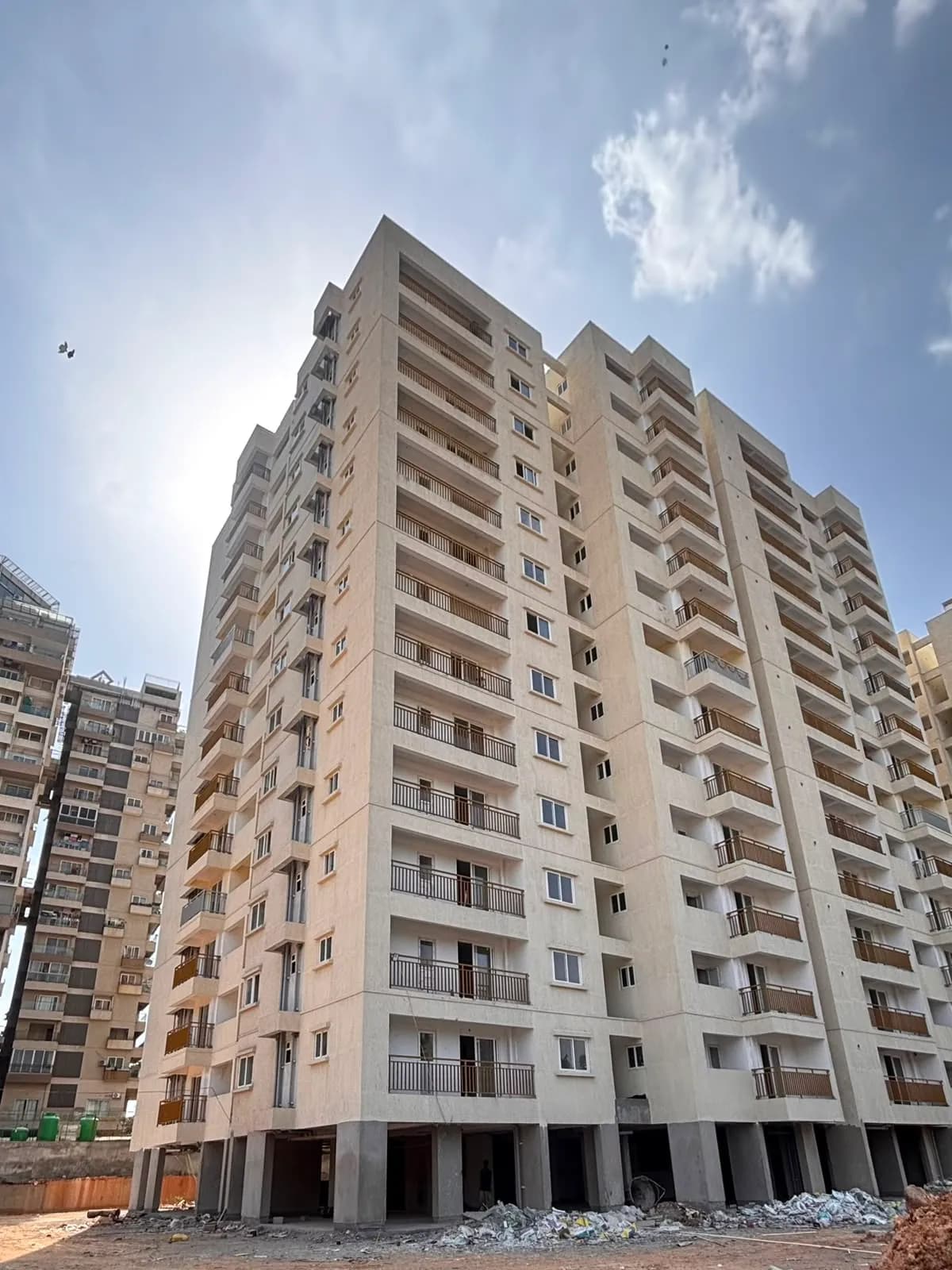

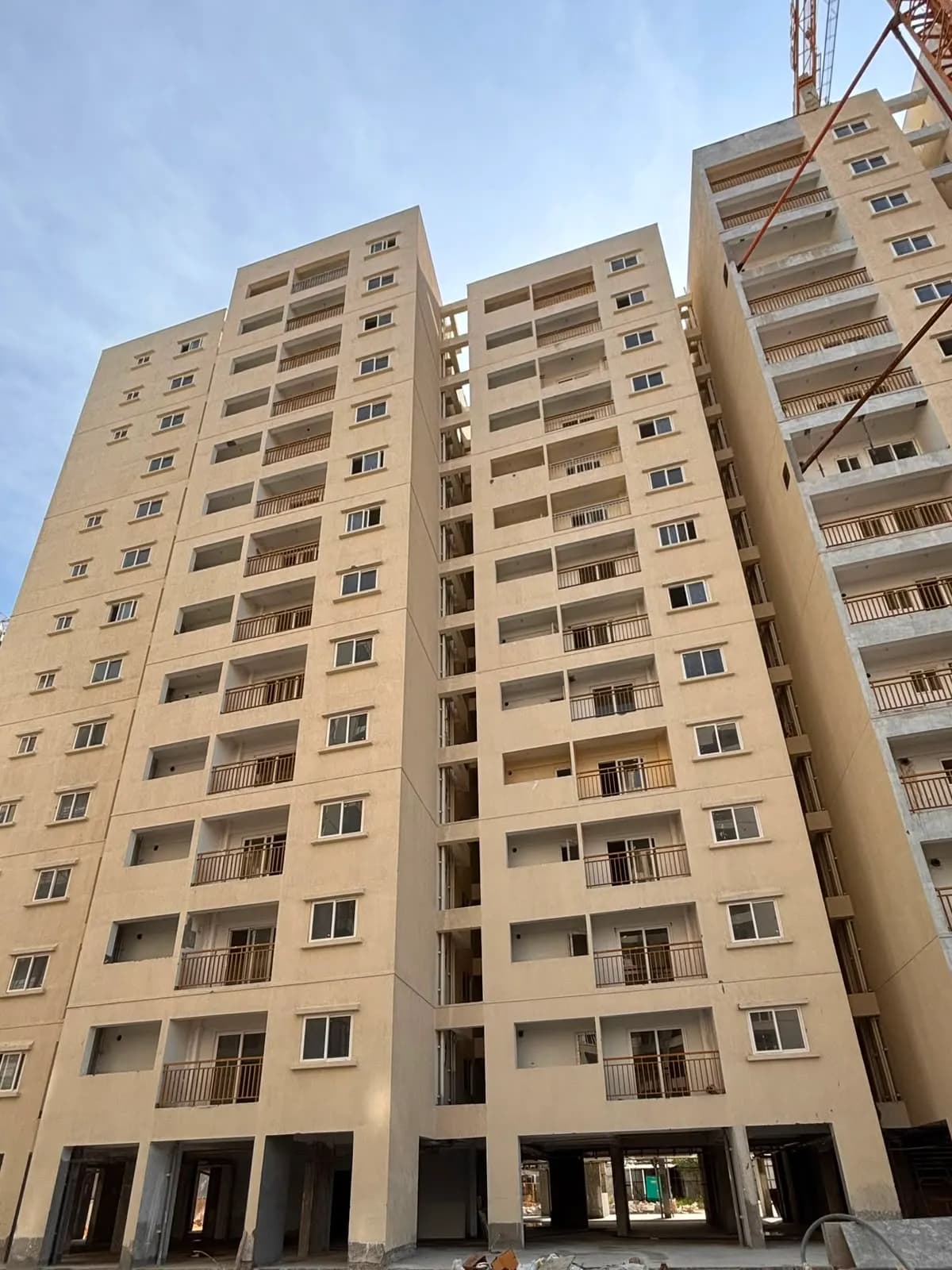

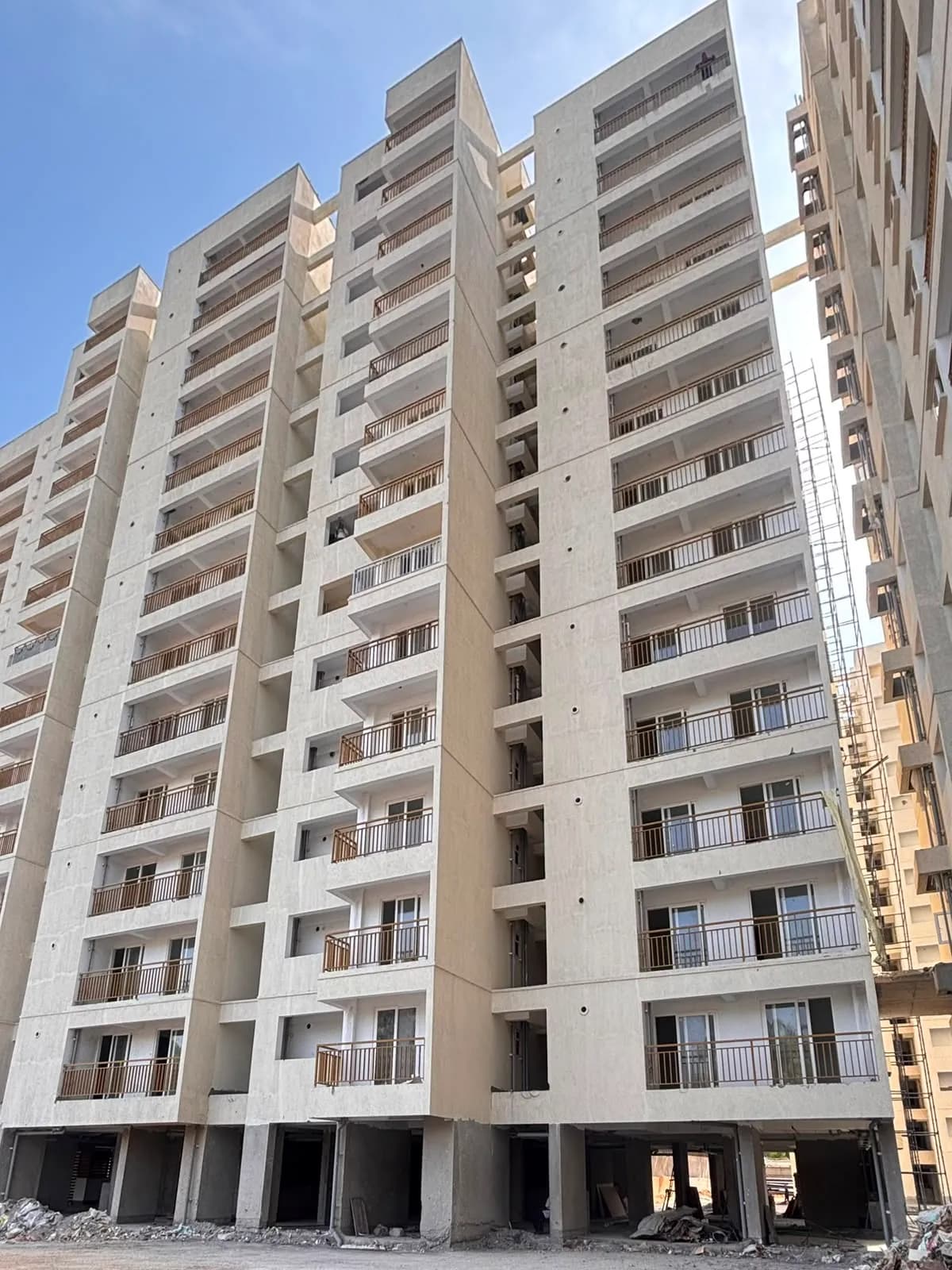

Site photo filed with Karnataka RERA Karnataka RERA filing · Source ↗ (opens in a new tab)
SSVR Niyaara at a glance
- Possession (RERA)Dec 2028Karnataka RERA
- Construction94% built · on pace for Dec 2026RERA filing to 30 Sep 2026; estimate from average pace
- Homes booked268 of 393 (68%)RERA update · as on 30 Sep 2026
- RERA complaints (project)None listedKarnataka RERA · as on 21 Oct 2026
- Approvals filed8 of 9 on RERAKarnataka RERA uploads · 21 Oct 2026
- Nearest metroKadugodi Tree Park · 4.5 kmstraight line · OpenStreetMap, 5 Oct 2026
- Airport driveapprox. 117 min at peak28.85 km straight line · estimate
- Nearest lakeVarthur Lake · 789 mFrom the RERA map point · OpenStreetMap, 5 Oct 2026
Project summary
SSVR Niyaara is a residential project by SSVR Builders in Sorahunase, Bengaluru with 393 homes, registered with Karnataka RERA. The completion date on RERA is 31 Dec 2028.
Facts collected on 21 Oct 2026 from public records — each linked to its source. Free for buyers. If you book through us, the builder pays us a commission.
SSVR Niyaara buyers’ group: join to ask for a group price
No one has joined yet. Be one of the first 10 buyers in this group — the founding members.
Join free. When enough buyers have joined, our agent partner asks SSVR Builders for a group price — for example a lower price, an easier payment plan or waived charges. Nothing is promised: you see what the builder offers and book directly with the builder if you want to. Free for buyers. If you book through us, the builder pays us a commission.
- Gathering buyers
- Talking to the builder
- Group offer
- Group site visit
- Booking
0 buyers have joined · 0 committed
Committed buyers have confirmed their budget, home type and timeline with us on a call; builders negotiate with them. Joining is free and never obliges you to buy.
Join the SSVR Niyaara buyers’ groupHow group buying works
See it for yourself
Visit the site with our team, or get a call to clear your questions. Free, no obligation.
Key facts: home types, towers, land and possession
- Home types
- 2 BHK, 3 BHK
- Carpet area
- 736 – 1,062 sq ft
- Towers
- 2
- Floors
- 13
- Total homes
- 393
- Land
- 4.83 acres
- Possession (RERA)
- Dec 2028
- Built (RERA update)
- 94%
SSVR Niyaara RERA number and registration details
- RERA number
- PRM/KA/RERA/1251/446/PR/160224/006626
- Registered on
- 16 Feb 2024
- Promised completion
- 31 Dec 2028
- Extended to
- No extension recorded
- RERA status
- New launch
- Homes booked
- 268 of 393 as on
- Price
- Not found in public records yet: price
- Project type
- Residential
Towers and blocks (RERA filing)
| Tower | Floors | Basements | Homes |
|---|---|---|---|
| SSVR NIYAARA BLOCK-A | 13 | 1 | 237 |
| SSVR NIYAARA BLOCK-B | 13 | 1 | 156 |
A dash (—) means the filing did not state that value.
Summary in plain English
SSVR Niyaara is a residential project by SSVR Builders in Sorahunase, Bengaluru East with 393 homes across 2 towers. The project is registered with the Karnataka RERA as a new project launch and is scheduled for completion on 31 December 2028.
Written by AI from the RERA record above on 21 Oct 2026. Every number in it was checked against that record; if anything differs, the record wins.
Open space, home loans, escrow and other details
- Open space
- 77.1% of land
- Water and power
- Water source filed with RERA: BoreWell,BWSSB
- Home loans: approved banks
- Not found in public records yet: bank approvals
- Payment plans
- Not found in public records yet: payment plans
- Maintenance
- Not found in public records yet: maintenance
- Car parking
- Not found in public records yet: car parking charge
- Escrow bank (RERA)
- Axis Bank, PANTHUR BNGR
- Building plan (RERA)
- BBMP - Bruhat Bengaluru Mahanagara Palike · No. BBMP/Addl.Dir/JDNORTH/0083/22-23 · dated 30 Dec 2023
- Project cost declared to RERA
- ₹247 Cr
Open area as a share of the land, from the areas filed with RERA (includes driveways and landscaped areas).
Amenities
- Electricity
- CCTV Surveillance
- Outdoor Sports facility
- Swimming Pool
- Power Backup
- Water and Sanitation
Amenities and internal works as filed by the promoter with Karnataka RERA; we have not visited the site.
SSVR Niyaara location and address
- Address
- SY. 6/3 , 6/8 , 6/9 , 6/13 , 7/2 & 7/3 Katha No.932/7/2.6/13,7/3,7/2,6/3,6/9,6/8/32 , SORAHUNASE VILLAGE VARTHUR HOBLI , Bengaluru East , Bengaluru Urban, Karnataka - 560087
- Village (RERA)
- Sorahunase
- Locality
- Varthur
- PIN code
- 560087
- City
- Bengaluru
- State
- Karnataka
- Coordinates
- 12.94581, 77.75413
Distances to landmarks
Not found in public records yet: landmarksAbout Varthur
Not found in public records yet: locality factsCommute times to tech parks and the airport
| To | Straight line | Peak-hour drive (estimate) |
|---|---|---|
| ITPL, Whitefield (main gate)Map point on OpenStreetMap (opens in a new tab) | 4.98 km | approx. 20 min |
| Outer Ring Road tech corridor (RMZ Ecospace, Bellandur)Map point on OpenStreetMap (opens in a new tab) | 8.27 km | approx. 34 min |
| Electronic City Phase 1Map point on OpenStreetMap (opens in a new tab) | 14.41 km | approx. 58 min |
| Manyata Tech ParkMap point on OpenStreetMap (opens in a new tab) | 18.47 km | approx. 75 min |
| KSR Bengaluru City railway station (Majestic)Map point on OpenStreetMap (opens in a new tab) | 20.32 km | approx. 82 min |
| Kempegowda International AirportMap point on OpenStreetMap (opens in a new tab) | 28.85 km | approx. 117 min |
How we calculate
Straight line: from the project’s map point on RERA to the destination’s point on OpenStreetMap.
Peak-hour drive is a rough estimate, not a route: straight line × 1.35 for the road network, at 20 km/h. Real times vary a lot with the route and the hour.
Sources:Source (openstreetmap.org) (opens in a new tab)How we calculate this
Schools and hospitals nearby
Within 2 km
- 14Schools and colleges12 schools, 0 colleges, 2 kindergartens
- 22Hospitals and clinics9 hospitals, 13 clinics
Nearest schools and colleges
- Government School Sorahunase · 0.12 km
- Varthur Government High School · 0.87 km
- Mount Blue High School · 0.93 km
Nearest hospitals and clinics
- Aria · 0.76 km
- Aitone Diagnostics & Clinics · 0.84 km
- Aria Multispeciality Clinic · 0.84 km
Places as mapped on OpenStreetMap (amenity=school, college, kindergarten, university; hospital, clinic), counted within 2 km in a straight line of the RERA map point. Volunteers map these, so some places may be missing or closed. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Nearest metro station and railway
- Kadugodi Tree Park (ಕಾಡುಗೋಡಿ ಟ್ರೀ ಪಾರ್ಕ್)Open now — nearest operating metro station4.5 km
- Belandur Road (ಬೆಳಂದೂರು ರಸ್ತೆ)Nearest railway station5.16 km
Straight-line distances from the RERA map point to the station points mapped on OpenStreetMap; status (open or under construction) as tagged there. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Lake and lake-buffer check
The nearest mapped lake is Varthur Lake, 789 m from the project’s RERA map point.
The site boundary is not published as a shape, so its nearest edge can be closer than this point. Whether any building sits inside a lake buffer can only be checked on the approved plan.
- Varthur Lake on OpenStreetMap (opens in a new tab) (ವರ್ತೂರು ಕೆರೆ)789 m
The buffer rule
Bengaluru’s lake buffer rule has changed over time: the National Green Tribunal ordered a 75 m buffer in May 2016; the Supreme Court set that order aside on 5 March 2019, leaving the 30 m buffer of the Revised Master Plan 2015. Check the current rule and the approved plan before relying on either number.
- LiveLaw: SC sets aside NGT order enlarging buffer zones (2019) (livelaw.in) (opens in a new tab)
- Citizen Matters: Shrinking lake buffers (citizenmatters.in) (opens in a new tab)
Shortest distance from the RERA map point to the mapped water edge (OpenStreetMap water polygons tagged lake or reservoir, or named lake/kere/tank). Mapped shorelines can differ from the revenue-record boundary of a lake. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Sources:Source (openstreetmap.org) (opens in a new tab)Source (livelaw.in) (opens in a new tab)Source (citizenmatters.in) (opens in a new tab)How we calculate this
Satellite time-lapse of the site
Satellite photos load when you scroll to them.
Photos from Esri World Imagery Wayback, centred on the project’s map point; dates are the capture dates in Esri’s metadata. Loaded from Esri when you scroll here.
Sources:Source (livingatlas.arcgis.com) (opens in a new tab)
SSVR Niyaara floor plans, brochure and elevations
Documents the builder uploaded to Karnataka RERA, shown as filed. Tap a page to see it full size; the full PDF opens on the RERA website.

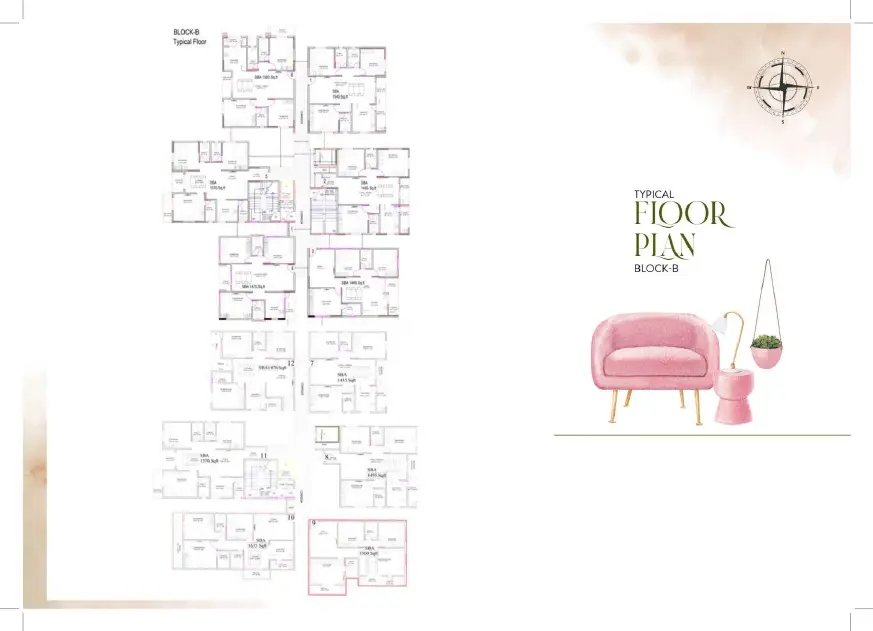

Brochure4 pages

BrochureFull PDF on RERA

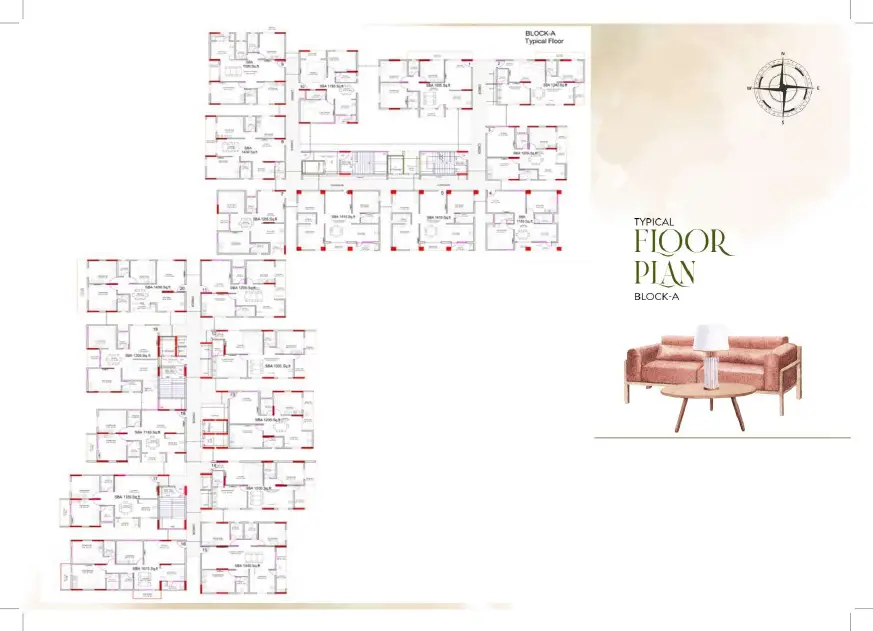

Approved layout plan

SINGLE LAYOUT PLAN.pdfFull PDF on RERA
| Home type | Carpet area | Homes |
|---|---|---|
| 2 BHK | 736 – 914 sq ft | 144 |
| 3 BHK | 750 – 1,062 sq ft | 249 |
| Flats- block-a -2 BHK | 792 sq ft | 146 |
| Flats- block-a -3 BHK | 924 sq ft | 94 |
| Flats- block-b -3 BHK | 978 sq ft | 156 |
Home types, counts and carpet areas as filed with Karnataka RERA (carpet area, not super built-up).
We have not collected floor-plan drawings; the builder’s sales team can share them.
SSVR Niyaara possession date and construction status
Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-15.
By tower (Q2 2026-27)
Units sold and unsold, from RERA (Q2 2026-27)
| Type | Homes | Booked | Available |
|---|---|---|---|
| 2 BHK | 144 | 74 | 70 |
| 3 BHK | 249 | 194 | 55 |
As reported by the promoter in the quarterly update to RERA, not verified by us.
Timeline
- 5 Jan 2024Project start date given to RERA
- 16 Feb 2024Registered with Karnataka RERA
- 31 Dec 2028Completion date given at registration
Construction pace from RERA quarterly filings
At the average pace so far, construction would reach 100% around Dec 2026 — about 25 months before the completion date on RERA (31 Dec 2028).
At the pace between the 4 quarterly filings we have (69% → 94% in 9 months), it would be around Dec 2026 — about 25 months before the RERA date.
- Filed on RERA
- Average pace since start
- Pace between filings (and 0% assumed at the start date)
- RERA completion date
Quarterly filings
| Quarter | Filed on | Built | Homes booked |
|---|---|---|---|
| Q2 2026-27to 30 Sep 2026 | 15 Oct 2026 | 94% | 268 of 393 |
| Q1 2026-27to 30 Jun 2026 | 14 Jul 2026 | 88% | 254 of 393 |
| Q4 2025-26to 31 Mar 2026 | 15 Apr 2026 | 80% | 223 of 393 |
| Q3 2025-26to 31 Dec 2025 | 19 Feb 2026 | 69% | 187 of 393 |
How we calculate
Average pace = % built ÷ months since the start date in the RERA record. Here: 94% ÷ 32.8 months (5 Jan 2024 to 30 Sep 2026) = 2.9% a month.
Estimated finish = latest filing date + (100 − % built) ÷ pace = 30 Sep 2026 + 6 ÷ 2.9 = 2.1 months → Dec 2026. This is an estimate, not a date from the builder or RERA.
Pace between filings = (94% − 69%) ÷ 9 months = 2.8% a month.
A straight line is a simplification: the builder reports one overall %, which mixes excavation, structure and finishing, and work rarely moves at a constant speed. The % values are the promoter’s own figures filed with RERA, not checked by us. Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-15.
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
Approvals and documents checklist
20 rows: approvals. Scroll inside the table to see them all.
| Approval | Authority | Source |
|---|---|---|
| Building plan | BBMP - Bruhat Bengaluru Mahanagara Palike · No. BBMP/Addl.Dir/JDNORTH/0083/22-23 · dated 2023-12-30 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Land conversion (6 orders) | DISTRICT COLLECTOR BANGALORE · No. ALN(EVH-1)SR/99/2021-22 and 5 more · dated 2022-09-08 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Commencement Certificate | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Electricity Permission Letter | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Water Permission Letter | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Layout Plan | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Building/Plotting Plan | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Section Of Building/Infrastructure Plan of Plotting | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Change of Land Use | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| District Magistrate | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Conversion Certificate under section 95 of the KLR Act 1964 | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| ESCOM/Electricity | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KWSSB/Water | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approval/NOC under section 109 of KLR Act 1961 | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approval/NOC under section 14 of the KTCP Act | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Fire Force Department | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Airport Authority of India | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KSPCB | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| SEIAA | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| NOC in case of building proposals abutting to neighbouring properties | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
Documents uploaded to RERA
- Building or layout plan · Approved drawings from the planning authorityFiled on RERA ✓ — BBMP - Bruhat Bengaluru Mahanagara Palike · No. BBMP/Addl.Dir/JDNORTH/0083/22-23 · dated 30 Dec 2023
- Commencement certificate · Permission to start buildingFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Environment clearance · SEIAA KarnatakaFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Fire NOC · Karnataka Fire and Emergency ServicesFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Pollution board consent · KSPCBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Water and sewerage · BWSSBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Electricity · BESCOMFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Height clearance · Airports Authority of IndiaFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Occupancy certificate (OC) · Issued only when the building is finishedNot on RERA yet — expected at completion
From the documents the promoter uploaded to Karnataka RERA, collected 21 Oct 2026. “Filed” means a document is on RERA — we have not checked its contents or validity. Not every approval applies to every project (for example, smaller projects may not need an environment clearance). The project page on RERA lists each upload.
SSVR Niyaara RERA complaints
No complaints listed on Karnataka RERA for this registration as on Source (rera.karnataka.gov.in) (opens in a new tab)
Court and consumer cases
We list case numbers, courts and outcomes only — never names of private individuals.
About SSVR Builders
- Promoter type
- Partnership Firm
- Projects on this site
- 1
- RERA complaints against promoter
- 0
- Company number (CIN)
- Not found in public records yet: CIN
From Karnataka RERA, as collected so far (21 Oct 2026). Complaints are those RERA lists against this promoter across all its projects.
SSVR Builders’s RERA recordSSVR Builders delivery record
- 1Projects in Bengaluru on RERA1 approved registration under SSVR Builders in Bengaluru Urban and Rural. Source (rera.karnataka.gov.in) (opens in a new tab)
- 393Homes registeredAs stated in each registrations.
- 0RERA complaintsas on Source (rera.karnataka.gov.in) (opens in a new tab)
- 0Complaints per 1,000 homes0 complaints ÷ 393 homes in its 1 registration on Karnataka RERA in Bengaluru.
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
What’s changed since Dec 2023
- 15 Oct 2026Quarterly update filed for Q2 2026-27: 94% built, 268 of 393 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 14 Jul 2026Quarterly update filed for Q1 2026-27: 88% built, 254 of 393 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 15 Apr 2026Quarterly update filed for Q4 2025-26: 80% built, 223 of 393 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 19 Feb 2026Quarterly update filed for Q3 2025-26: 69% built, 187 of 393 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 16 Feb 2024Registered with Karnataka RERA (PRM/KA/RERA/1251/446/PR/160224/006626); completion date 31 Dec 2028 Source (rera.karnataka.gov.in) (opens in a new tab)
- 5 Jan 2024Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
- 30 Dec 2023Building plan approved by BBMP - Bruhat Bengaluru Mahanagara Palike (No. BBMP/Addl.Dir/JDNORTH/0083/22-23) Source (rera.karnataka.gov.in) (opens in a new tab)
Newest first. No extension of the completion date is recorded on RERA. When the RERA crawl sees a new filing, complaint or extension, it is added here with its date.
Home loan EMI calculator
- Monthly EMI
- —
- Down payment
- —
- Loan amount
- —
- Total interest
- —
A calculation only, from the numbers you enter — not a loan offer.
All-in cost: GST, registration and other charges
The calculator loads when you scroll to it.
Assumptions
- Base price: the builder’s price is not published in a form we could collect — enter it from the cost sheet.
- GST 5% on the base price and charges — the usual rate for an under-construction home that is not “affordable housing” (1%).
- Stamp duty about 5.6% and registration 2% — the Karnataka rule (registration was raised from 1% to 2% on 31 Aug 2025). Calculated on the agreement value.
- Car parking, other charges and the maintenance deposit are not in the public record we collect; enter them from the builder’s cost sheet.
- Loan on the agreement value (banks usually lend up to 75–90%); EMI is the standard reducing-balance formula. Example rate only — use your bank’s quote.
SSVR Niyaara FAQs
What is the RERA registration number for SSVR Niyaara?
The project is registered under RERA registration number PRM/KA/RERA/1251/446/PR/160224/006626, registered on 16 February 2024.
When will SSVR Niyaara be completed?
The project completion date on RERA is 31 December 2028.
How many homes are in SSVR Niyaara and what types are available?
The project has 393 homes: 146 homes of 2 BHK with 792 sq ft carpet area, 94 homes of 2 BHK with 792 sq ft, 156 homes of 3 BHK with 978 sq ft, 144 homes with carpet areas from 736 to 914 sq ft, and 249 homes with carpet areas from 750 to 1,062 sq ft.
What is the construction progress of SSVR Niyaara?
As of the latest quarterly update for Q2 2026-27 (ended 30 September 2026), the project is 94 percent complete.
How many homes have been booked in SSVR Niyaara?
As of Q2 2026-27, 268 homes have been booked out of the 393 homes in the project.
Where is SSVR Niyaara located?
The project is located in Sorahunase, Bengaluru East taluk, Bengaluru Urban district, with PIN code 560087.
Are there any RERA complaints against SSVR Niyaara?
There are no RERA complaints on this project registration.
Are there RERA complaints against SSVR Builders?
There are no RERA complaints against SSVR Builders across all projects in our Bengaluru records.
How many other projects does SSVR Builders have on the RERA record?
SSVR Builders has 3 other projects on the Karnataka RERA record in Bengaluru.
Which bank holds the escrow account for SSVR Niyaara?
Axis Bank holds the escrow account for this project.
Written by AI from the RERA record above on 21 Oct 2026. Answers use only that record; check them against the source before you decide.
Questions about SSVR Niyaara
No questions published yet. Ask the first one: you get an instant answer from this page’s public record, and our team follows up on anything the record does not show.
Bought a home from SSVR Builders? Review the builder.
Reviews of SSVR Builders by verified buyers
No verified reviews of SSVR Builders yet. If you bought a home from them, your review helps other buyers.
How reviews work: only buyers and owners can review; we confirm each purchase by phone before publishing, publish positive and negative reviews alike, never accept payment for reviews, and the builder may reply.
Similar projects within 5 km
| Project | Distance | Homes | Possession (RERA) | Built | Complaints | Price |
|---|---|---|---|---|---|---|
| Green Edge SignatureGreen Edge Ventures | 0.4 km | 216 | Dec 2026 | 47% | 0 | Not collected |
| Adithya ValiosoAdithya Constructions | 0.4 km | 156 | Dec 2027 | 97% | 0 | Not collected |
| Tru AquapolisTru Infra Projects And Realty LLP | 0.5 km | 310 | Apr 2029 | 35% | 0 | Not collected |
| Lotus HillAcrolith Builders | 0.6 km | 28 | Dec 2025 | — | 0 | Not collected |
| Inspira InfinityInspira Infinity Limited Liability Partnership | 1.2 km | 105 | Jan 2029 | 80% | 0 | Not collected |
| Evergreen @ Prestige Raintree ParkPrestige Estates Projects Ltd | 1.2 km | 2,000 | Jun 2030 | 11% | 0 | Not collected |
Projects of the same kind within 5 km in a straight line of this project’s RERA map point, nearest first. % built is the promoter’s latest quarterly figure on RERA (shown for single-registration projects); prices are from the builder’s own website where we found one.
Sources and last checked dates
Collected on 21 Oct 2026 by AI research agents reading public pages. Facts are written in our own words. Not found yet: price; court cases; landmarks; specifications; news.
How to check on RERA: On rera.karnataka.gov.in/viewAllProjects, type the registration number in 'Registration No', press Search, then click the 'View Project Details' icon. Complaints open from the 'Complaints / Litigation' icon in the same row. Registration number: PRM/KA/RERA/1251/446/PR/160224/006626.
- RERA record last checked: 21 Oct 2026
- Last change in the record (registration, quarterly filing or complaint): 21 Oct 2026
How this page is made: software builds it from public records (Karnataka RERA filings, OpenStreetMap, the builder’s own website). AI is used only to read filings into fields and to write the plain-English summary and FAQ answers, which are checked against the record. Facts are checked automatically against the RERA filing. Methodology · How we earn · Report an error
More new projects in Varthur
Sorahunase Cross Sorahunase Varthur, VarthurUnder constructionRERA registeredBuyers’ group openGreen Edge Signature
by Green Edge Ventures
Price: Price on requestGet brochure & price →
- 2 BHK, 3 BHK, 4 BHK
- 835 – 1,548 sq ft
- Dec 2026
216 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Green Edge Signature
Sorahunase, VarthurUnder constructionRERA registeredBuyers’ group openAdithya Valioso
by Adithya Constructions
Price: Price on requestGet brochure & price →
- 2 BHK, 3 BHK, 4 BHK
- 770 – 1,320 sq ft
- Dec 2027
156 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Adithya Valioso
VarthurUnder constructionRERA registeredBuyers’ group openTru Aquapolis
by Tru Infra Projects And Realty
Price: Price on requestGet brochure & price →
- 1 BHK, 2 BHK, 3 BHK, 4 BHK
- 340 – 1,631 sq ft
- Apr 2029
310 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Tru Aquapolis
