Sterling Ascentia
2 & 3 BHK apartments by M/s Sterling Urban Ventures Pvt. Ltd · Bellandur, Bengaluru
Bellandur, BengaluruOpen on Google Maps (opens in a new tab)
- Under construction
- RERA registered
- RERA not updated: completion promised Sep 2026; no extension or completion filed
- residential
by M/s Sterling Urban Ventures Pvt. Ltd
Price: Price on request
Sterling Ascentia luxury apartments exterior elevation Artist’s impression · © M/s Sterling Urban Ventures Pvt. Ltd · Source ↗ (opens in a new tab)
Sterling Ascentia at a glance
- Possession (RERA)Sep 2026 Date passedWas Dec 2021 · Karnataka RERA
- Construction96% built · on pace for Mar 2027 6 mo after RERA dateRERA filing to 30 Sep 2026; estimate from average pace
- Homes booked281 of 301 (93%)RERA update · as on 30 Sep 2026
- RERA complaints (project)30 complaintsKarnataka RERA · as on 15 Oct 2026
- Approvals filed1 of 9 on RERAKarnataka RERA uploads · 15 Oct 2026
- Nearest metroPrestige Bellandur · 0.22 km (under construction)Open now: Hongasandra, 6.19 km · straight line · OpenStreetMap, 5 Oct 2026
- Airport driveapprox. 123 min at peak30.27 km straight line · estimate
- Nearest lakeBellandur Lake · 526 mFrom the RERA map point · OpenStreetMap, 5 Oct 2026
Project summary
Sterling Ascentia is a residential project by M/s Sterling Urban Ventures Pvt. Ltd in Bengaluru with 301 homes, registered with Karnataka RERA. The completion date on RERA is 30 Sep 2026.
Not in the RERA record we collected yet: locality. This page fills in as the record is collected.
Facts collected on 15 Oct 2026 from public records — each linked to its source. Free for buyers. If you book through us, the builder pays us a commission.
Sterling Ascentia buyers’ group: join to ask for a group price
No one has joined yet. Be one of the first 10 buyers in this group — the founding members.
Join free. When enough buyers have joined, our agent partner asks M/s Sterling Urban Ventures Pvt. Ltd for a group price — for example a lower price, an easier payment plan or waived charges. Nothing is promised: you see what the builder offers and book directly with the builder if you want to. Free for buyers. If you book through us, the builder pays us a commission.
- Gathering buyers
- Talking to the builder
- Group offer
- Group site visit
- Booking
0 buyers have joined · 0 committed
Committed buyers have confirmed their budget, home type and timeline with us on a call; builders negotiate with them. Joining is free and never obliges you to buy.
Join the Sterling Ascentia buyers’ groupHow group buying works
See it for yourself
Visit the site with our team, or get a call to clear your questions. Free, no obligation.
Key facts: home types, towers, land and possession
- Home types
- 2 BHK, 3 BHK
- Carpet area
- 1,057 – 1,351 sq ft
- Towers
- 4
- Floors
- 14
- Total homes
- 301
- Land
- 5.66 acres
- Possession (extended)
- Sep 2026
- Built (RERA update)
- 96%
Sterling Ascentia RERA number and registration details
- RERA number
- PRM/KA/RERA/1251/446/PR/171026/000563
- Registered on
- 26 Oct 2017
- Promised completion
- 31 Dec 2021
- Extended to
- 30 Sep 2026
- RERA status
- Under construction
- Homes booked
- 281 of 301 as on
- Price
- Not found in public records yet: price
- Project type
- Residential
Towers and blocks (RERA filing)
| Tower | Floors | Basements | Homes |
|---|---|---|---|
| Tower 3 | 14 | 2 | 59 |
| Tower 4 | 14 | 2 | 59 |
| Tower 5 | 14 | 2 | 86 |
| Tower 6 | 14 | 2 | 86 |
A dash (—) means the filing did not state that value.
Summary in plain English
Sterling Ascentia is a residential project by M/s Sterling Urban Ventures Pvt. Ltd in Bengaluru East with 301 homes across 4 towers. The project was registered with RERA on 26 October 2017 with an original completion date of 31 December 2021, extended to 30 September 2026.
Written by AI from the RERA record above on 15 Oct 2026. Every number in it was checked against that record; if anything differs, the record wins.
Open space, home loans, escrow and other details
- Open space
- 79.4% of land
- Water and power
- Not found in public records yet: water and power
- Home loans: approved banks
- Not found in public records yet: bank approvals
- Payment plans
- Not found in public records yet: payment plans
- Maintenance
- Not found in public records yet: maintenance
- Car parking
- Not found in public records yet: car parking charge
- Escrow bank (RERA)
- PUNJAB NATIONAL BANK OF INDIA, MG Road
- Project cost declared to RERA
- ₹450 Cr
Open area as a share of the land, from the areas filed with RERA (includes driveways and landscaped areas).
Amenities
Sterling Ascentia location and address
- Address
- 13 Outer Ring Road Opposite Accenture Kariyammana Agrahara , Bellandur Bengaluru Karnataka 560103
- Village (RERA)
- Not found in public records yet: village
- Locality
- Bellandur
- PIN code
- 560025
- City
- Bengaluru
- State
- Karnataka
- Coordinates
- 12.92939, 77.68152
Distances to landmarks
Not found in public records yet: landmarksAbout Bellandur
Not found in public records yet: locality factsCommute times to tech parks and the airport
| To | Straight line | Peak-hour drive (estimate) |
|---|---|---|
| Outer Ring Road tech corridor (RMZ Ecospace, Bellandur)Map point on OpenStreetMap (opens in a new tab) | 0.63 km | approx. 5 min |
| ITPL, Whitefield (main gate)Map point on OpenStreetMap (opens in a new tab) | 8.89 km | approx. 36 min |
| Electronic City Phase 1Map point on OpenStreetMap (opens in a new tab) | 9.04 km | approx. 37 min |
| KSR Bengaluru City railway station (Majestic)Map point on OpenStreetMap (opens in a new tab) | 13.29 km | approx. 54 min |
| Manyata Tech ParkMap point on OpenStreetMap (opens in a new tab) | 14.8 km | approx. 60 min |
| Kempegowda International AirportMap point on OpenStreetMap (opens in a new tab) | 30.27 km | approx. 123 min |
How we calculate
Straight line: from the project’s map point on RERA to the destination’s point on OpenStreetMap.
Peak-hour drive is a rough estimate, not a route: straight line × 1.35 for the road network, at 20 km/h. Real times vary a lot with the route and the hour.
Sources:Source (openstreetmap.org) (opens in a new tab)How we calculate this
Schools and hospitals nearby
Within 2 km
- 25Schools and colleges15 schools, 2 colleges, 8 kindergartens
- 33Hospitals and clinics19 hospitals, 14 clinics
Nearest schools and colleges
- Bellandur Government School · 0.61 km
- Patel Public School · 0.91 km
- Narayana e-Techno School - Bellandur · 0.92 km
Nearest hospitals and clinics
- Sakra World · 0.51 km
- Sakra World Hospital · 0.52 km
- Dr Ramesh Dalwai Spine Surgeon · 0.54 km
Places as mapped on OpenStreetMap (amenity=school, college, kindergarten, university; hospital, clinic), counted within 2 km in a straight line of the RERA map point. Volunteers map these, so some places may be missing or closed. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Nearest metro station and railway
- Prestige Bellandur (ಬೆಳ್ಳಂದೂರ್)Blue Line metro, under construction0.22 km
- Embassy Tech Village Kadubeesanahalli (ಕಾಡುಬೀಸನಹಳ್ಳಿ)Blue Line metro, under construction0.72 km
- Ibbaluru (ಇಬ್ಬಲೂರು)Blue Line metro, under construction2.2 km
- Hongasandra (ಹೊಂಗಸಂದ್ರ)Open now — nearest operating metro station6.19 km
- Belandur Road (ಬೆಳಂದೂರು ರಸ್ತೆ)Nearest railway station2.96 km
Straight-line distances from the RERA map point to the station points mapped on OpenStreetMap; status (open or under construction) as tagged there. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Lake and lake-buffer check
The nearest mapped lake is Bellandur Lake, 526 m from the project’s RERA map point.
The site boundary is not published as a shape, so its nearest edge can be closer than this point. Whether any building sits inside a lake buffer can only be checked on the approved plan.
- Bellandur Lake on OpenStreetMap (opens in a new tab) (ಬೆಳ್ಳಂದೂರು ಕೆರೆ)526 m
- Deverabisanahalli Lake on OpenStreetMap (opens in a new tab) (ದೇವರ ಬಿಸನಹಳ್ಳಿ ಕೆರೆ)745 m
- Saul Kere on OpenStreetMap (opens in a new tab) (ಸಾಲ್ ಕೆರೆ)1,037 m
The buffer rule
Bengaluru’s lake buffer rule has changed over time: the National Green Tribunal ordered a 75 m buffer in May 2016; the Supreme Court set that order aside on 5 March 2019, leaving the 30 m buffer of the Revised Master Plan 2015. Check the current rule and the approved plan before relying on either number.
- LiveLaw: SC sets aside NGT order enlarging buffer zones (2019) (livelaw.in) (opens in a new tab)
- Citizen Matters: Shrinking lake buffers (citizenmatters.in) (opens in a new tab)
Shortest distance from the RERA map point to the mapped water edge (OpenStreetMap water polygons tagged lake or reservoir, or named lake/kere/tank). Mapped shorelines can differ from the revenue-record boundary of a lake. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Sources:Source (openstreetmap.org) (opens in a new tab)Source (livelaw.in) (opens in a new tab)Source (citizenmatters.in) (opens in a new tab)How we calculate this
Satellite time-lapse of the site
Satellite photos load when you scroll to them.
Photos from Esri World Imagery Wayback, centred on the project’s map point; dates are the capture dates in Esri’s metadata. Loaded from Esri when you scroll here.
Sources:Source (livingatlas.arcgis.com) (opens in a new tab)
Sterling Ascentia floor plans
| Home type | Carpet area | Homes |
|---|---|---|
| 2 BHK | 1,057 – 1,325 sq ft | 80 |
| 3 BHK | 1,057 – 1,351 sq ft | 210 |
| Type e | 1,253 sq ft | 5 |
| Type h | 1,351 sq ft | 6 |
Home types, counts and carpet areas as filed with Karnataka RERA (carpet area, not super built-up).

(opens full size in a new tab)Type C floor plan - 1885 sq ft, 3BR + 2T Artist’s impression · © M/s Sterling Urban Ventures Pvt. Ltd · Source ↗ (opens in a new tab)

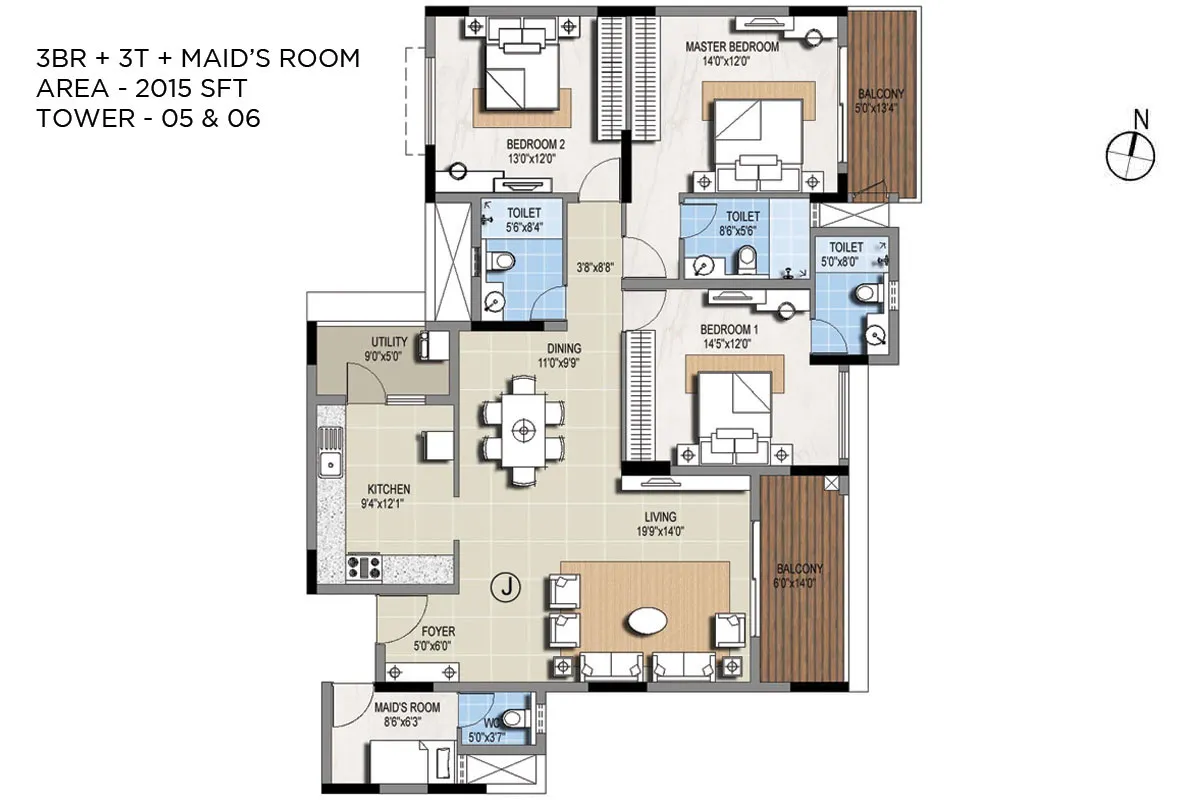

(opens full size in a new tab)Type D floor plan - 2015 sq ft, 3BR + 3T + Handyman Artist’s impression · © M/s Sterling Urban Ventures Pvt. Ltd · Source ↗ (opens in a new tab)

(opens full size in a new tab)Type E floor plan - 1890 sq ft, 3BR + 3T Artist’s impression · © M/s Sterling Urban Ventures Pvt. Ltd · Source ↗ (opens in a new tab)

(opens full size in a new tab)Type F floor plan - 1927 sq ft, 3BR + 3T Artist’s impression · © M/s Sterling Urban Ventures Pvt. Ltd · Source ↗ (opens in a new tab)

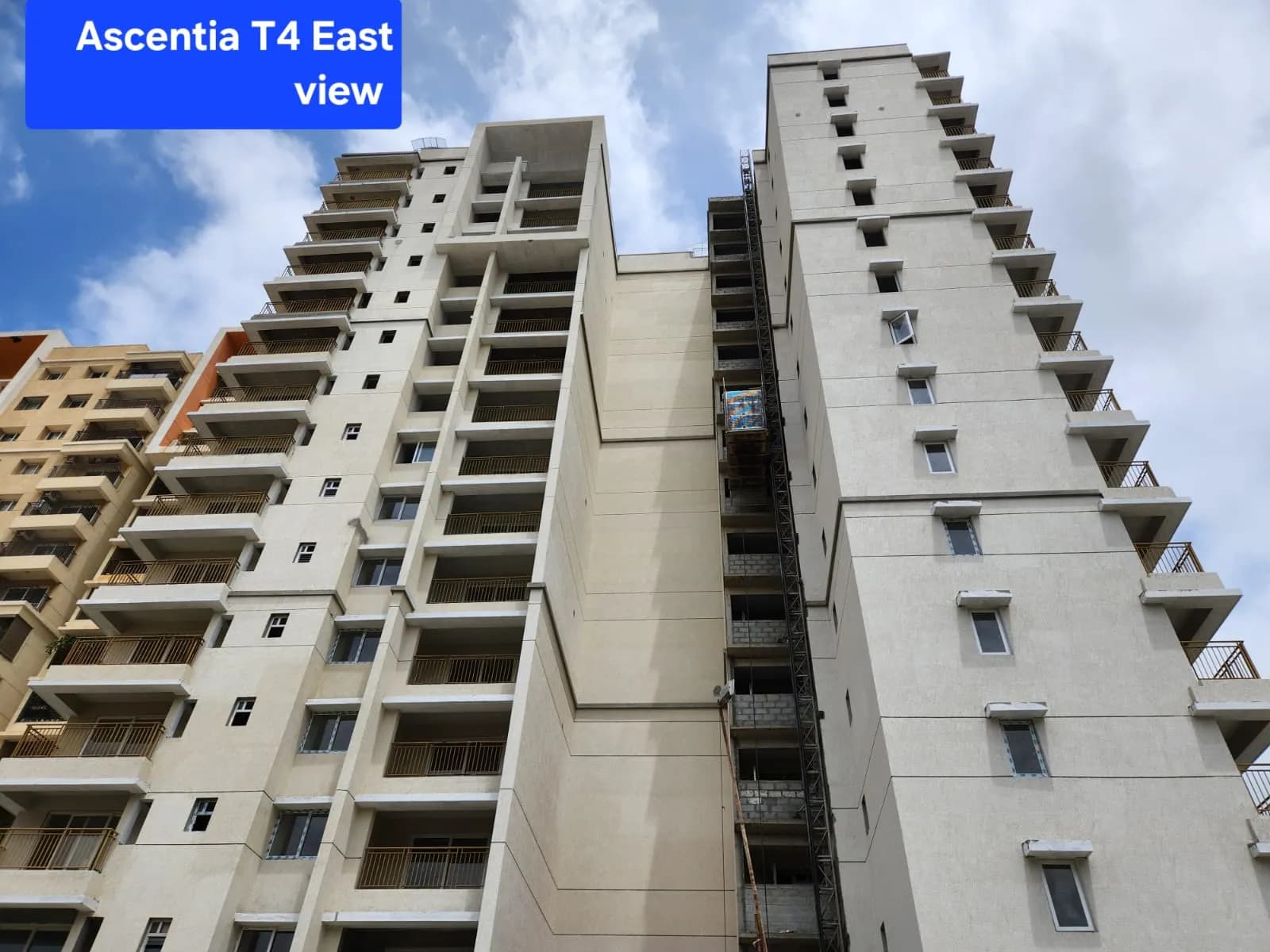

Sterling Ascentia possession date and construction status
Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-15.
By tower (Q2 2026-27)
Units sold and unsold, from RERA (Q2 2026-27)
| Type | Homes | Booked | Available |
|---|---|---|---|
| 3 BHK | 210 | 201 | 9 |
| 2 BHK | 80 | 80 | 0 |
As reported by the promoter in the quarterly update to RERA, not verified by us.
Timeline
- 15 Sep 2015Project start date given to RERA
- 26 Oct 2017Registered with Karnataka RERA
- 31 Dec 2021Completion date given at registration
- 30 Sep 2023Section 6 Extension: completion date moved to this date
- 30 Sep 2026Further Extension: completion date moved to this date
Construction pace from RERA quarterly filings
At the average pace so far, construction would reach 100% around Mar 2027 — about 6 months after the completion date on RERA (30 Sep 2026).
At the pace between the 4 quarterly filings we have (87% → 96% in 9 months), it would be around Jan 2027 — about 4 months after the RERA date.
- Filed on RERA
- Average pace since start
- Pace between filings (and 0% assumed at the start date)
- RERA completion date
Quarterly filings
| Quarter | Filed on | Built | Homes booked |
|---|---|---|---|
| Q2 2026-27to 30 Sep 2026 | 15 Oct 2026 | 96% | 281 of 290 |
| Q1 2026-27to 30 Jun 2026 | 9 Jul 2026 | 97% | 281 of 290 |
| Q4 2025-26to 31 Mar 2026 | 3 Apr 2026 | 88% | 281 of 290 |
| Q3 2025-26to 31 Dec 2025 | 7 Jan 2026 | 87% | 281 of 290 |
How we calculate
Average pace = % built ÷ months since the start date in the RERA record. Here: 96% ÷ 132.5 months (15 Sep 2015 to 30 Sep 2026) = 0.7% a month.
Estimated finish = latest filing date + (100 − % built) ÷ pace = 30 Sep 2026 + 4 ÷ 0.7 = 5.5 months → Mar 2027. This is an estimate, not a date from the builder or RERA.
Pace between filings = (96% − 87%) ÷ 9 months = 1% a month.
A straight line is a simplification: the builder reports one overall %, which mixes excavation, structure and finishing, and work rarely moves at a constant speed. The % values are the promoter’s own figures filed with RERA, not checked by us. Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-15.
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
Approvals and documents checklist
| Approval | Authority | Source |
|---|---|---|
| Building plan | BBMP - Bruhat Bengaluru Mahanagara Palike | Source (rera.karnataka.gov.in) (opens in a new tab) |
Documents uploaded to RERA
- Building or layout plan · Approved drawings from the planning authorityFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Commencement certificate · Permission to start buildingNot on RERA yet
- Environment clearance · SEIAA KarnatakaNot on RERA yet
- Fire NOC · Karnataka Fire and Emergency ServicesNot on RERA yet
- Pollution board consent · KSPCBNot on RERA yet
- Water and sewerage · BWSSBNot on RERA yet
- Electricity · BESCOMNot on RERA yet
- Height clearance · Airports Authority of IndiaNot on RERA yet
- Occupancy certificate (OC) · Issued only when the building is finishedNot on RERA yet — expected at completion
From the documents the promoter uploaded to Karnataka RERA, collected 15 Oct 2026. “Filed” means a document is on RERA — we have not checked its contents or validity. Not every approval applies to every project (for example, smaller projects may not need an environment clearance). The project page on RERA lists each upload.
Sterling Ascentia RERA complaints and orders
30 complaints as on Source (rera.karnataka.gov.in) (opens in a new tab)
30 rows: rera complaints. Scroll inside the table to see them all.
| Complaint ref | Filed | Subject | Status | Source |
|---|---|---|---|---|
| 00615/2024 | 20 Jun 2024 | Non adherence to the sanctioned plan and specification | Disposed | Source (rera.karnataka.gov.in) (opens in a new tab) |
| 00347/2024 | 2 Apr 2024 | Failure to complete that duty of promoter of section 11 sub sec 04 of rera act | Disposed | Source (rera.karnataka.gov.in) (opens in a new tab) |
| 00187/2024 | 13 Feb 2024 | Failure to complete the duty of Promoter under Sec 11 subsection 4 of RERA ACT | Disposed | Source (rera.karnataka.gov.in) (opens in a new tab) |
| 00050/2024 | 11 Jan 2024 | Maintenance not provided by the Builder for amenities not handed over | Disposed | Source (rera.karnataka.gov.in) (opens in a new tab) |
| 00508/2023 | 18 Apr 2023 | Adherence of sanctioned plan | Disposed | Source (rera.karnataka.gov.in) (opens in a new tab) |
| 00514/2023 | 18 Apr 2023 | Structural Defect and Pending Amenities in Sterling Ascentia | Disposed ao | Source (rera.karnataka.gov.in) (opens in a new tab) |
| 00033/2023 | 9 Jan 2023 | Structural Defect and Pending Amenities in Sterling Ascentia | Disposed ao | Source (rera.karnataka.gov.in) (opens in a new tab) |
| 00029/2023 | 6 Jan 2023 | Structural defect and delayed ameniies | Disposed ao | Source (rera.karnataka.gov.in) (opens in a new tab) |
| CMP/221209/0010445 | 9 Dec 2022 | Illegal Conctruction of 14th Floor in Tower 4 | Disposed | Source (rera.karnataka.gov.in) (opens in a new tab) |
| CMP/221209/0010443 | 9 Dec 2022 | Structural DEFECTS & Pending amenities in Sterling Ascentia | Disposed ao | Source (rera.karnataka.gov.in) (opens in a new tab) |
| CMP/221130/0010414 | 30 Nov 2022 | Structural Defect and Pending Amenities in Sterling Ascentia | Disposed ao | Source (rera.karnataka.gov.in) (opens in a new tab) |
| CMP/221128/0010410 | 28 Nov 2022 | Structural Defect and Pending Amenities in Sterling Ascentia | Disposed ao | Source (rera.karnataka.gov.in) (opens in a new tab) |
| CMP/221123/0010394 | 23 Nov 2022 | Structural defects and pending amenities of sterling ascentia | Disposed ao | Source (rera.karnataka.gov.in) (opens in a new tab) |
| CMP/221123/0010390 | 23 Nov 2022 | Structural Defect and Pending Amenities in Sterling Ascentia | Disposed ao | Source (rera.karnataka.gov.in) (opens in a new tab) |
| CMP/221123/0010395 | 23 Nov 2022 | Clubhouse not provided and Illegal 14th floor construction | Disposed ao | Source (rera.karnataka.gov.in) (opens in a new tab) |
| CMP/221122/0010386 | 22 Nov 2022 | Structural Defect and Pending Amenities in Sterling Ascentia | Disposed ao | Source (rera.karnataka.gov.in) (opens in a new tab) |
| CMP/221122/0010389 | 22 Nov 2022 | Structural Defect and Pending Amenities in Sterling Ascentia | Disposed ao | Source (rera.karnataka.gov.in) (opens in a new tab) |
| CMP/221122/0010388 | 22 Nov 2022 | Structural Defect and Pending Amenities in Sterling Ascentia | Disposed ao | Source (rera.karnataka.gov.in) (opens in a new tab) |
| CMP/221122/0010378 | 22 Nov 2022 | Structural Defect, Pending Amenities and Clubhouse | Disposed ao | Source (rera.karnataka.gov.in) (opens in a new tab) |
| CMP/221122/0010379 | 22 Nov 2022 | Structural Defect and Pending Amenities in Sterling Ascentia | Disposed ao | Source (rera.karnataka.gov.in) (opens in a new tab) |
| CMP/221122/0010384 | 22 Nov 2022 | Structural Defect and Pending Amenities in Sterling Ascentia | Disposed ao | Source (rera.karnataka.gov.in) (opens in a new tab) |
| CMP/221122/0010383 | 22 Nov 2022 | Structural Defect and Pending Amenities in Sterling Ascentia | Disposed ao | Source (rera.karnataka.gov.in) (opens in a new tab) |
| CMP/221122/0010382 | 22 Nov 2022 | Structural Defect & Pending Amenties in Sterling Ascentia | Disposed ao | Source (rera.karnataka.gov.in) (opens in a new tab) |
| CMP/221122/0010381 | 22 Nov 2022 | Structural Defects and pending amenities | Disposed ao | Source (rera.karnataka.gov.in) (opens in a new tab) |
| CMP/221122/0010380 | 22 Nov 2022 | Structural Defect and Pending Amenities in Sterling Ascentia | Disposed ao | Source (rera.karnataka.gov.in) (opens in a new tab) |
| CMP/221122/0010385 | 22 Nov 2022 | Structural Defect and Pending Amenities in Sterling Ascentia | Disposed ao | Source (rera.karnataka.gov.in) (opens in a new tab) |
| CMP/221122/0010387 | 22 Nov 2022 | Structural Defect and Pending Amenities in Sterling Ascentia | Disposed ao | Source (rera.karnataka.gov.in) (opens in a new tab) |
| CMP/221122/0010377 | 22 Nov 2022 | Structural Defect and Pending Amenities in Sterling Ascentia | Disposed ao | Source (rera.karnataka.gov.in) (opens in a new tab) |
| CMP/221021/0010125 | 21 Oct 2022 | Structural Defect and Pending Amenities in Sterling Ascentia | Disposed ao | Source (rera.karnataka.gov.in) (opens in a new tab) |
| CMP/221007/0010064 | 7 Oct 2022 | Structural Defects and Missing Amenities in Sterling Ascentia | Disposed ao | Source (rera.karnataka.gov.in) (opens in a new tab) |
Court and consumer cases
We list case numbers, courts and outcomes only — never names of private individuals.
About M/s Sterling Urban Ventures Pvt. Ltd
- Promoter type
- Company
- Projects on this site
- 1
- RERA complaints against promoter
- 30
- Company number (CIN)
- U70102KA2007PTC042496
From Karnataka RERA, as collected so far (15 Oct 2026). Complaints are those RERA lists against this promoter across all its projects.
M/s Sterling Urban Ventures Pvt. Ltd’s RERA recordM/s Sterling Urban Ventures Pvt. Ltd delivery record
- 1Projects in Bengaluru on RERA1 approved registration under M/s Sterling Urban Ventures Pvt. Ltd in Bengaluru Urban and Rural. Source (rera.karnataka.gov.in) (opens in a new tab)
- 301Homes registeredAs stated in each registrations.
- 30RERA complaints0 open, 30 disposed. as on Source (rera.karnataka.gov.in) (opens in a new tab)
- 99.7Complaints per 1,000 homes30 complaints ÷ 301 homes in its 1 registration on Karnataka RERA in Bengaluru.
What the complaints are about
30 complaint subjects as written on RERA, as on . Each subject is sorted into one group by keywords (first match wins: delay, refund, registration, quality, litigation, association); one complaint often raises several issues. Source (rera.karnataka.gov.in) (opens in a new tab)
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
What’s changed since Sep 2015
- 15 Oct 2026Quarterly update filed for Q2 2026-27: 96% built, 281 of 290 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 30 Sep 2026Completion date extended to 30 Sep 2026 Source (rera.karnataka.gov.in) (opens in a new tab)
- 9 Jul 2026Quarterly update filed for Q1 2026-27: 97% built, 281 of 290 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 3 Apr 2026Quarterly update filed for Q4 2025-26: 88% built, 281 of 290 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 7 Jan 2026Quarterly update filed for Q3 2025-26: 87% built, 281 of 290 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 20 Jun 2024Complaint 00615/2024 filed with RERA: “Non adherence to the sanctioned plan and specification” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 2 Apr 2024Complaint 00347/2024 filed with RERA: “Failure to complete that duty of promoter of section 11 sub sec 04 of rera act” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 13 Feb 2024Complaint 00187/2024 filed with RERA: “Failure to complete the duty of Promoter under Sec 11 subsection 4 of RERA ACT” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 11 Jan 2024Complaint 00050/2024 filed with RERA: “Maintenance not provided by the Builder for amenities not handed over” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 18 Apr 2023Complaint 00508/2023 filed with RERA: “Adherence of sanctioned plan” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 18 Apr 2023Complaint 00514/2023 filed with RERA: “Structural Defect and Pending Amenities in Sterling Ascentia” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 9 Jan 2023Complaint 00033/2023 filed with RERA: “Structural Defect and Pending Amenities in Sterling Ascentia” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 6 Jan 2023Complaint 00029/2023 filed with RERA: “Structural defect and delayed ameniies” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 9 Dec 2022Complaint CMP/221209/0010445 filed with RERA: “Illegal Conctruction of 14th Floor in Tower 4” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 9 Dec 2022Complaint CMP/221209/0010443 filed with RERA: “Structural DEFECTS & Pending amenities in Sterling Ascentia” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 30 Nov 2022Complaint CMP/221130/0010414 filed with RERA: “Structural Defect and Pending Amenities in Sterling Ascentia” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 28 Nov 2022Complaint CMP/221128/0010410 filed with RERA: “Structural Defect and Pending Amenities in Sterling Ascentia” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 23 Nov 2022Complaint CMP/221123/0010394 filed with RERA: “Structural defects and pending amenities of sterling ascentia” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 23 Nov 2022Complaint CMP/221123/0010390 filed with RERA: “Structural Defect and Pending Amenities in Sterling Ascentia” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 23 Nov 2022Complaint CMP/221123/0010395 filed with RERA: “Clubhouse not provided and Illegal 14th floor construction” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 22 Nov 2022Complaint CMP/221122/0010386 filed with RERA: “Structural Defect and Pending Amenities in Sterling Ascentia” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 22 Nov 2022Complaint CMP/221122/0010389 filed with RERA: “Structural Defect and Pending Amenities in Sterling Ascentia” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 22 Nov 2022Complaint CMP/221122/0010388 filed with RERA: “Structural Defect and Pending Amenities in Sterling Ascentia” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 22 Nov 2022Complaint CMP/221122/0010378 filed with RERA: “Structural Defect, Pending Amenities and Clubhouse” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 22 Nov 2022Complaint CMP/221122/0010379 filed with RERA: “Structural Defect and Pending Amenities in Sterling Ascentia” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 22 Nov 2022Complaint CMP/221122/0010384 filed with RERA: “Structural Defect and Pending Amenities in Sterling Ascentia” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 22 Nov 2022Complaint CMP/221122/0010383 filed with RERA: “Structural Defect and Pending Amenities in Sterling Ascentia” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 22 Nov 2022Complaint CMP/221122/0010382 filed with RERA: “Structural Defect & Pending Amenties in Sterling Ascentia” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 22 Nov 2022Complaint CMP/221122/0010381 filed with RERA: “Structural Defects and pending amenities” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 22 Nov 2022Complaint CMP/221122/0010380 filed with RERA: “Structural Defect and Pending Amenities in Sterling Ascentia” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
Newest first. Showing the latest 30 of 37 dated events. When the RERA crawl sees a new filing, complaint or extension, it is added here with its date.
Home loan EMI calculator
- Monthly EMI
- —
- Down payment
- —
- Loan amount
- —
- Total interest
- —
A calculation only, from the numbers you enter — not a loan offer.
All-in cost: GST, registration and other charges
The calculator loads when you scroll to it.
Assumptions
- Base price: the builder’s price is not published in a form we could collect — enter it from the cost sheet.
- GST 5% on the base price and charges — the usual rate for an under-construction home that is not “affordable housing” (1%).
- Stamp duty about 5.6% and registration 2% — the Karnataka rule (registration was raised from 1% to 2% on 31 Aug 2025). Calculated on the agreement value.
- Car parking, other charges and the maintenance deposit are not in the public record we collect; enter them from the builder’s cost sheet.
- Loan on the agreement value (banks usually lend up to 75–90%); EMI is the standard reducing-balance formula. Example rate only — use your bank’s quote.
Sterling Ascentia FAQs
What is the completion date for Sterling Ascentia?
The current completion date on RERA is 30 September 2026. The project has received multiple extensions: a Covid Extension, a Section 6 Extension to 30 September 2023, and a Further Extension to 30 September 2026.
How many homes are in Sterling Ascentia?
The project has 301 homes across 4 towers with a maximum of 14 floors.
What home types are available in Sterling Ascentia?
The project offers 2 BHK (80 homes, 1,057 to 1,325 carpet area sq ft), 3 BHK (210 homes, 1,057 to 1,351 carpet area sq ft), TYPE H (6 homes, 1,351 carpet area sq ft), and TYPE E (5 homes, 1,253 carpet area sq ft).
What is the construction progress of Sterling Ascentia?
As of Q2 2026-27 (quarter ended 30 September 2026), the project is 96% complete.
How many homes are booked in Sterling Ascentia?
As of Q2 2026-27, 281 homes are booked out of 290 homes in the booking table.
What is the RERA registration number for Sterling Ascentia?
The project is registered under RERA registration number PRM/KA/RERA/1251/446/PR/171026/000563.
Where is Sterling Ascentia located?
The project is located in Bengaluru East taluk, Bengaluru Urban district, PIN code 560025.
How many RERA complaints are there against Sterling Ascentia?
There are 30 RERA complaints filed on this project registration.
What is the land area of Sterling Ascentia?
The project is built on a land area of 22,915 sq m.
What bank is the escrow agent for Sterling Ascentia?
The escrow bank for the project is Punjab National Bank of India.
Written by AI from the RERA record above on 15 Oct 2026. Answers use only that record; check them against the source before you decide.
Questions about Sterling Ascentia
No questions published yet. Ask the first one: you get an instant answer from this page’s public record, and our team follows up on anything the record does not show.
Bought a home from M/s Sterling Urban Ventures Pvt. Ltd? Review the builder.
Reviews of M/s Sterling Urban Ventures Pvt. Ltd by verified buyers
No verified reviews of M/s Sterling Urban Ventures Pvt. Ltd yet. If you bought a home from them, your review helps other buyers.
How reviews work: only buyers and owners can review; we confirm each purchase by phone before publishing, publish positive and negative reviews alike, never accept payment for reviews, and the builder may reply.
Similar projects within 5 km
| Project | Distance | Homes | Possession (RERA) | Built | Complaints | Price |
|---|---|---|---|---|---|---|
| DNR AristaInesa Ventures LLP | 1.1 km | 518 | Jul 2026extended | — | 0 | Not collected |
| Greenfinch MeadowsGreenfinch Projects Pvt Ltd | 1.3 km | 181 | Sep 2026 | 99% | 0 | Not collected |
| Sri Balaji VaibhavSri Balaji Builders | 1.5 km | 136 | Jun 2026 | — | 0 | Not collected |
| Sri Vyshnavi Infra Brundavanam Phase 2Sri Vyshnavi Infra | 1.6 km | 48 | Dec 2028 | 68% | 0 | Not collected |
| Adarsh RosewoodAkarsh Residence Pvt Ltd | 2 km | 118 | Dec 2027 | 15% | 0 | Not collected |
| Heavie EdenSentient Developers Private Limited | 2.1 km | 28 | Dec 2026extended | 94% | 0 | Not collected |
Projects of the same kind within 5 km in a straight line of this project’s RERA map point, nearest first. % built is the promoter’s latest quarterly figure on RERA (shown for single-registration projects); prices are from the builder’s own website where we found one.
Sources and last checked dates
Collected on 15 Oct 2026 by AI research agents reading public pages. Facts are written in our own words. Not found yet: price; court cases; landmarks; specifications; news.
How to check on RERA: On rera.karnataka.gov.in/viewAllProjects, type the registration number in 'Registration No', press Search, then click the 'View Project Details' icon. Complaints open from the 'Complaints / Litigation' icon in the same row. Registration number: PRM/KA/RERA/1251/446/PR/171026/000563.
- RERA record last checked: 15 Oct 2026
- Last change in the record (registration, quarterly filing or complaint): 15 Oct 2026
How this page is made: software builds it from public records (Karnataka RERA filings, OpenStreetMap, the builder’s own website). AI is used only to read filings into fields and to write the plain-English summary and FAQ answers, which are checked against the record. Facts are checked automatically against the RERA filing. Methodology · How we earn · Report an error
More new projects in Bellandur
Kaikondarahalli, BellandurUnder constructionRERA registeredBuyers’ group openDNR Arista
by Inesa Ventures
Price: Price on requestGet brochure & price →
- 2 BHK, 3 BHK, 4 BHK
- 861 – 1,671 sq ft
- Jul 2026 (extended)
RERA not updated since promised Jul 2026 · 2 phases on RERA · 518 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for DNR Arista
Kaikondrahalli, BellandurUnder constructionRERA registeredBuyers’ group openSri Balaji Vaibhav
by Sri Balaji Builders
Price: Price on requestGet brochure & price →
- 1 BHK, 2 BHK, 3 BHK
- 390 – 1,007 sq ft
- Jun 2026
RERA not updated since promised Jun 2026 · 136 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Sri Balaji Vaibhav
Kasavanahalli, BellandurUnder constructionRERA registeredBuyers’ group openHeavie Eden
by Sentient
Price: Price on requestGet brochure & price →
- 1 BHK, 2 BHK
- 555 – 1,271 sq ft
- Dec 2026 (extended)
28 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Heavie Eden
