Sumukha Silverstone

2 & 3 BHK apartments by Sumukha Ventures · JP Nagar, Bengaluru

JP Nagar, BengaluruOpen on Google Maps (opens in a new tab)

  • Under construction
  • RERA registered
  • RERA not updated: completion promised Mar 2026; no extension or completion filed
  • residential

by Sumukha Ventures

Price: Price on request

Get brochure, floor plans & price

Brochure, floor plans and price list for Sumukha Silverstone

Builders share their brochure, floor plans and price list only on request. Tell us how to reach you and we’ll get them and send them to you, free.

Free for buyers. If you book through us, the builder pays us a commission. How we earn

Project summary

Sumukha Silverstone is a residential project by Sumukha Ventures in Bengaluru with 69 homes, registered with Karnataka RERA. The completion date on RERA is 31 Mar 2026.

Not in the RERA record we collected yet: locality. This page fills in as the record is collected.

Facts collected on 22 Oct 2026 from public records — each linked to its source. Free for buyers. If you book through us, the builder pays us a commission.

Sumukha Silverstone buyers’ group: join to ask for a group price

No one has joined yet. Be one of the first 10 buyers in this group — the founding members.

Join free. When enough buyers have joined, our agent partner asks Sumukha Ventures for a group price — for example a lower price, an easier payment plan or waived charges. Nothing is promised: you see what the builder offers and book directly with the builder if you want to. Free for buyers. If you book through us, the builder pays us a commission.

  1. Gathering buyers
  2. Talking to the builder
  3. Group offer
  4. Group site visit
  5. Booking

0 buyers have joined · 0 committed

Committed buyers have confirmed their budget, home type and timeline with us on a call; builders negotiate with them. Joining is free and never obliges you to buy.

Join the Sumukha Silverstone buyers’ groupHow group buying works

See it for yourself

Visit the site with our team, or get a call to clear your questions. Free, no obligation.

Key facts: home types, towers, land and possession

Updated on 22 Oct 2026
Home types
2 BHK, 3 BHK
Carpet area
779 – 1,103 sq ft
Towers
1
Floors
4
Total homes
69
Land
0.8 acres
Possession (extended)
Mar 2026
Built (RERA update)
98%

Sumukha Silverstone RERA number and registration details

RERA number
PRM/KA/RERA/1251/310/PR/181122/005460
Registered on
18 Nov 2022
Promised completion
31 Jul 2025
Extended to
31 Mar 2026
RERA status
New launch
Homes booked
39 of 69 as on
Price
Not found in public records yet: price
Project type
Residential

Towers and blocks (RERA filing)

TowerFloorsBasementsHomes
A Block4169

A dash (—) means the filing did not state that value.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Summary in plain English

Sumukha Silverstone is a residential project by Sumukha Ventures in Bengaluru South with 69 homes across one 4-storey tower. The project offers 3 BHK and 2 BHK homes and is scheduled for completion on 31 March 2026.

Written by AI from the RERA record above on 5 Oct 2026. Every number in it was checked against that record; if anything differs, the record wins.

Open space, home loans, escrow and other details

Open space
55.7% of land
Water and power
Water source filed with RERA: BoreWell
Home loans: approved banks
Not found in public records yet: bank approvals
Payment plans
Not found in public records yet: payment plans
Maintenance
Not found in public records yet: maintenance
Car parking
Not found in public records yet: car parking charge
Escrow bank (RERA)
HDFC, C V RAMANNAGAR
Building plan (RERA)
BBMP - Bruhat Bengaluru Mahanagara Palike · No. BBMP/Addl.Dir/JDSOUTH/0052/21-22 · dated 1 Aug 2022
Project cost declared to RERA
₹21.88 Cr

Open area as a share of the land, from the areas filed with RERA (includes driveways and landscaped areas).

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Amenities

  • Electricity
  • CCTV Surveillance
  • Community Hall
  • Indoor Sports facility
  • Swimming Pool
  • Gym
  • Power Backup
  • Water and Sanitation

Amenities and internal works as filed by the promoter with Karnataka RERA; we have not visited the site.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Sumukha Silverstone location and address

Address
Sy No.4 Bilekahalli , Devarachikkanahalli Main Road , Bengaluru South , Bengaluru Urban, Karnataka - 560076
Village (RERA)
Not found in public records yet: village
Locality
JP NagarAlso known as J P Nagar, Jayaprakash Nagar
PIN code
560076
City
Bengaluru
State
Karnataka
Coordinates
12.89948, 77.60436

Distances to landmarks

Not found in public records yet: landmarks

About JP Nagar

Not found in public records yet: locality facts

Commute times to tech parks and the airport

As on 5 Oct 2026
ToStraight linePeak-hour drive (estimate)
Electronic City Phase 1Map point on OpenStreetMap (opens in a new tab)8.59 kmapprox. 35 min
Outer Ring Road tech corridor (RMZ Ecospace, Bellandur)Map point on OpenStreetMap (opens in a new tab)8.76 kmapprox. 35 min
KSR Bengaluru City railway station (Majestic)Map point on OpenStreetMap (opens in a new tab)9.53 kmapprox. 39 min
Manyata Tech ParkMap point on OpenStreetMap (opens in a new tab)16.62 kmapprox. 67 min
ITPL, Whitefield (main gate)Map point on OpenStreetMap (opens in a new tab)17.47 kmapprox. 71 min
Kempegowda International AirportMap point on OpenStreetMap (opens in a new tab)35.21 kmapprox. 143 min
How we calculate

Straight line: from the project’s map point on RERA to the destination’s point on OpenStreetMap.

Peak-hour drive is a rough estimate, not a route: straight line × 1.35 for the road network, at 20 km/h. Real times vary a lot with the route and the hour.

Sources:Source (openstreetmap.org) (opens in a new tab)How we calculate this

Schools and hospitals nearby

As on 5 Oct 2026

Within 2 km

  • 70Schools and colleges54 schools, 4 colleges, 12 kindergartens
  • 58Hospitals and clinics28 hospitals, 30 clinics

Nearest schools and colleges

  • Gnanaprakasham KHPS Bilekalli · 0.11 km
  • Ankith HPS Bilekalli · 0.15 km
  • Mgs Infant LPS Bilekalli · 0.34 km

Nearest hospitals and clinics

  • Akshara Eye Hospital · 0.14 km
  • Anand Clinic · 0.22 km
  • Parimala Health Care · 0.4 km

Places as mapped on OpenStreetMap (amenity=school, college, kindergarten, university; hospital, clinic), counted within 2 km in a straight line of the RERA map point. Volunteers map these, so some places may be missing or closed. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.

Sources:Source (openstreetmap.org) (opens in a new tab)

Nearest metro station and railway

As on 5 Oct 2026
  • IIMB (ಐಐಎಂಬಿ)Pink Line metro, under construction0.66 km
  • JP Nagar 4th Phase (ಜೆಪಿ ನಗರ 4 ನೇ ಹಂತ)Pink Line metro, under construction1.24 km
  • BTM Layout (ಬಿಟಿಎಂ ಬಡಾವಣೆ)Open now — nearest operating metro station1.95 km
  • Krishnadevaraya Halt (ಕೃಷ್ಣದೇವರಾಯ)Nearest railway station9.61 km

Straight-line distances from the RERA map point to the station points mapped on OpenStreetMap; status (open or under construction) as tagged there. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.

Sources:Source (openstreetmap.org) (opens in a new tab)

Lake and lake-buffer check

As on 5 Oct 2026

The nearest mapped lake is Madiwala Lake, 812 m from the project’s RERA map point.

The site boundary is not published as a shape, so its nearest edge can be closer than this point. Whether any building sits inside a lake buffer can only be checked on the approved plan.

The buffer rule

Bengaluru’s lake buffer rule has changed over time: the National Green Tribunal ordered a 75 m buffer in May 2016; the Supreme Court set that order aside on 5 March 2019, leaving the 30 m buffer of the Revised Master Plan 2015. Check the current rule and the approved plan before relying on either number.

Shortest distance from the RERA map point to the mapped water edge (OpenStreetMap water polygons tagged lake or reservoir, or named lake/kere/tank). Mapped shorelines can differ from the revenue-record boundary of a lake. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.

Sources:Source (openstreetmap.org) (opens in a new tab)Source (livelaw.in) (opens in a new tab)Source (citizenmatters.in) (opens in a new tab)How we calculate this

Satellite time-lapse of the site

Satellite photos load when you scroll to them.

Photos from Esri World Imagery Wayback, centred on the project’s map point; dates are the capture dates in Esri’s metadata. Loaded from Esri when you scroll here.

Sources:Source (livingatlas.arcgis.com) (opens in a new tab)

Sumukha Silverstone floor plans, brochure and elevations

Documents the builder uploaded to Karnataka RERA, shown as filed. Tap a page to see it full size; the full PDF opens on the RERA website.

Brochure2 pages

Home typeCarpet areaHomes
2 BHK795 – 1,095 sq ft30
3 BHK779 – 1,103 sq ft39

Home types, counts and carpet areas as filed with Karnataka RERA (carpet area, not super built-up).

We have not collected floor-plan drawings; the builder’s sales team can share them.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

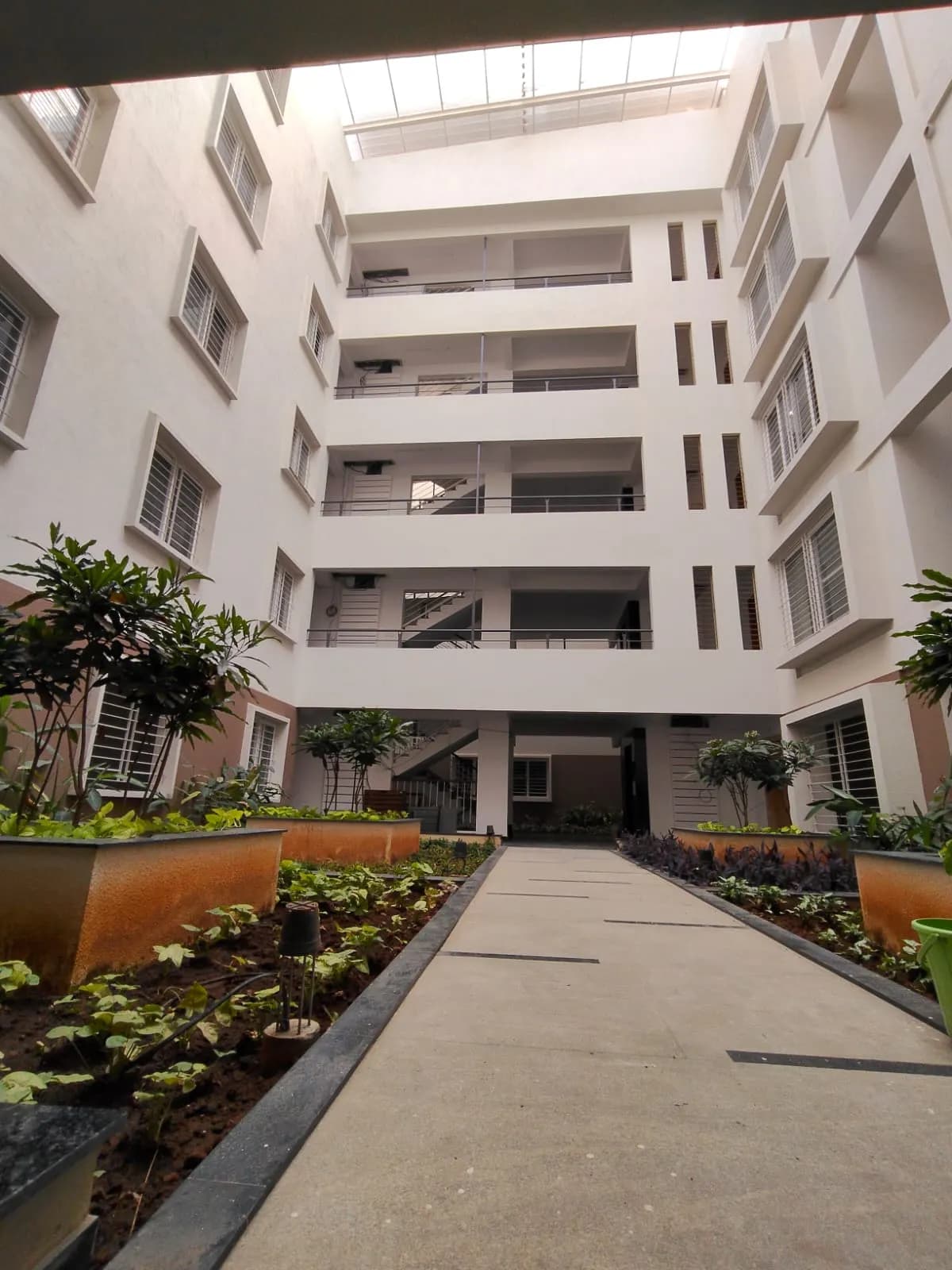

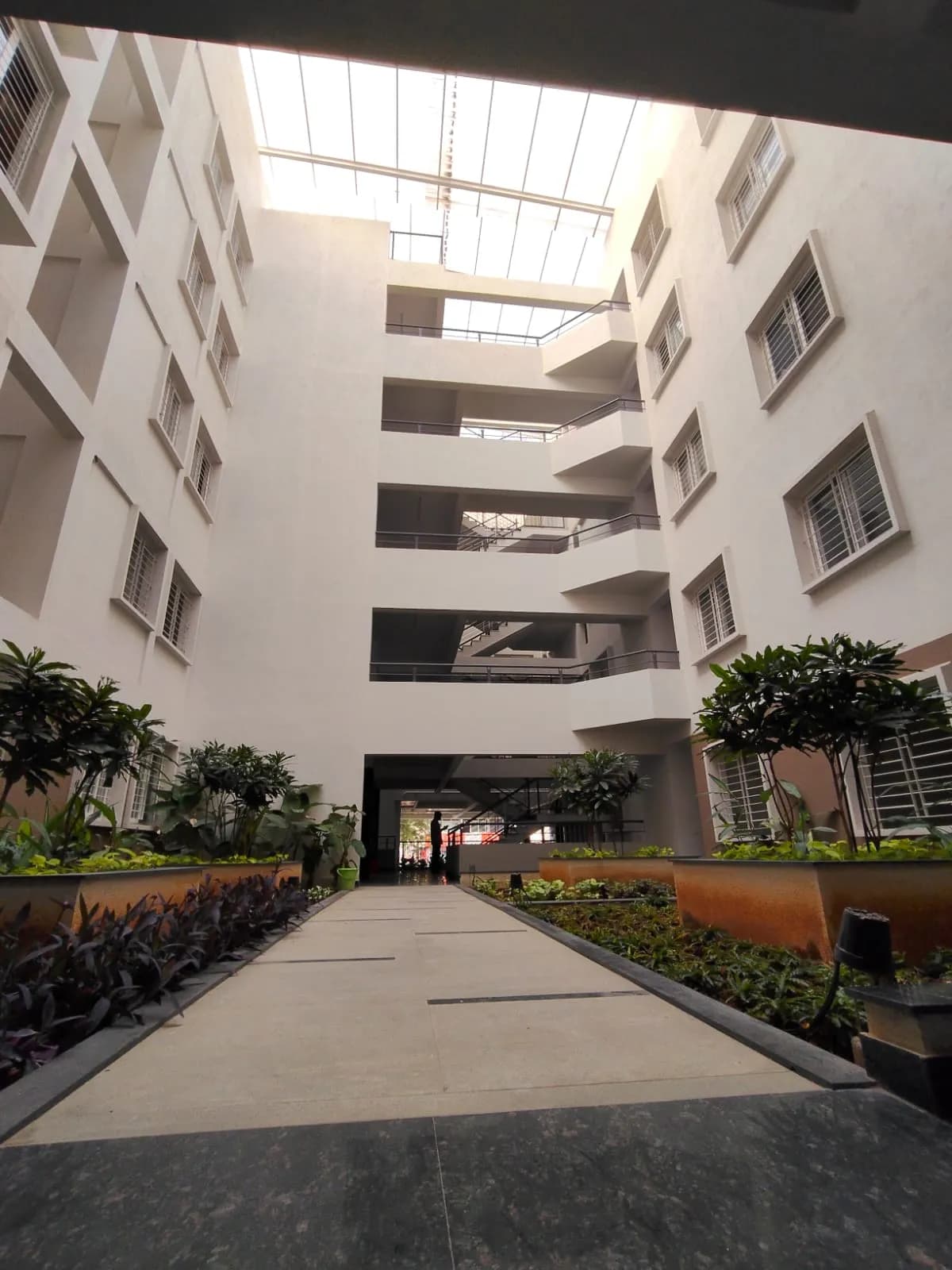

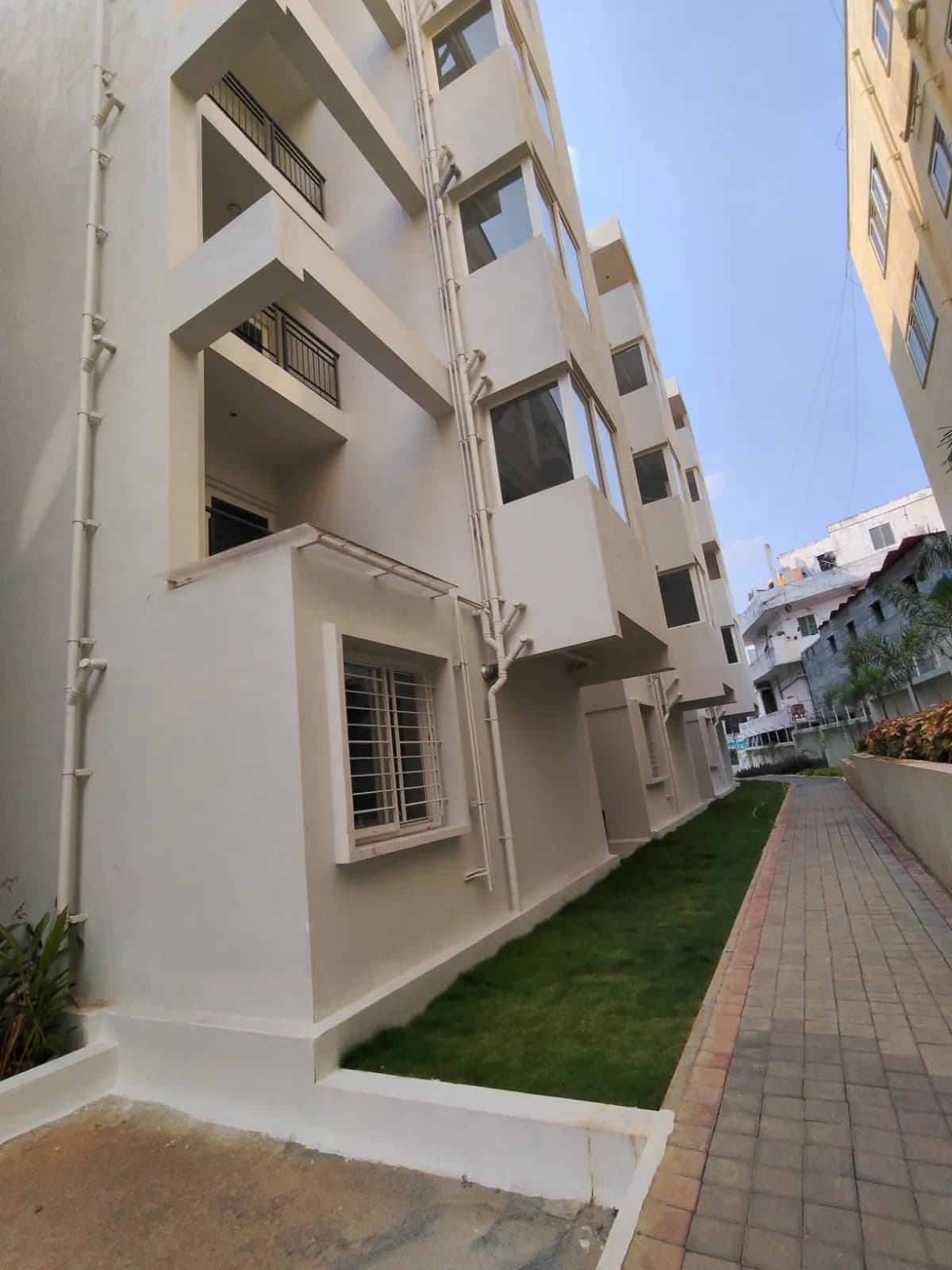

Sumukha Silverstone possession date and construction status

  • Whole project (promoter’s RERA update)98%

    as on · 39 of 69 homes booked

Promoter’s quarterly update to RERA for Q3 2025-26, submitted 2026-03-30.

Units sold and unsold, from RERA (Q3 2025-26)

TypeHomesBookedAvailable
2 BHK301614
3 BHK392316

As reported by the promoter in the quarterly update to RERA, not verified by us.

Timeline

  1. 1 Aug 2022Project start date given to RERA
  2. 18 Nov 2022Registered with Karnataka RERA
  3. 31 Jul 2025Completion date given at registration
  4. 31 Mar 2026Section 6 Extension: completion date moved to this date

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Construction pace from RERA quarterly filings

As on 30 Mar 2026

At the average pace so far, construction would reach 100% around Jan 2026 — about 2 months before the completion date on RERA (31 Mar 2026).

0%25%50%75%100%2023202420252026RERA date98%
  • Filed on RERA
  • Average pace since start
  • RERA completion date

Quarterly filings

QuarterFiled onBuiltHomes booked
Q3 2025-26to 31 Dec 202530 Mar 202698%39 of 69
How we calculate

Average pace = % built ÷ months since the start date in the RERA record. Here: 98% ÷ 41 months (1 Aug 2022 to 31 Dec 2025) = 2.4% a month.

Estimated finish = latest filing date + (100 − % built) ÷ pace = 31 Dec 2025 + 2 ÷ 2.4 = 0.8 months → Jan 2026. This is an estimate, not a date from the builder or RERA.

A straight line is a simplification: the builder reports one overall %, which mixes excavation, structure and finishing, and work rarely moves at a constant speed. The % values are the promoter’s own figures filed with RERA, not checked by us. Promoter’s quarterly update to RERA for Q3 2025-26, submitted 2026-03-30.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this

Approvals and documents checklist

ApprovalAuthoritySource
Building planBBMP - Bruhat Bengaluru Mahanagara Palike · No. BBMP/Addl.Dir/JDSOUTH/0052/21-22 · dated 2022-08-01Source (rera.karnataka.gov.in) (opens in a new tab)
Land conversionRevenue department · No. 240124 · dated 2021-08-23Source (rera.karnataka.gov.in) (opens in a new tab)
Water Permission Letterscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Approved Building/Plotting Planscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Approved Section Of Building/Infrastructure Plan of Plottingscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Conversion Certificate under section 95 of the KLR Act 1964scan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
KWSSB/Waterscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
KSPCBscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)

Documents uploaded to RERA

As on 22 Oct 2026
  • Building or layout plan · Approved drawings from the planning authorityFiled on RERA ✓ — BBMP - Bruhat Bengaluru Mahanagara Palike · No. BBMP/Addl.Dir/JDSOUTH/0052/21-22 · dated 1 Aug 2022
  • Commencement certificate · Permission to start buildingNot on RERA yet
  • Environment clearance · SEIAA KarnatakaNot on RERA yet
  • Fire NOC · Karnataka Fire and Emergency ServicesNot on RERA yet
  • Pollution board consent · KSPCBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Water and sewerage · BWSSBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Electricity · BESCOMNot on RERA yet
  • Height clearance · Airports Authority of IndiaNot on RERA yet
  • Occupancy certificate (OC) · Issued only when the building is finishedNot on RERA yet — expected at completion

From the documents the promoter uploaded to Karnataka RERA, collected 22 Oct 2026. “Filed” means a document is on RERA — we have not checked its contents or validity. Not every approval applies to every project (for example, smaller projects may not need an environment clearance). The project page on RERA lists each upload.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Sumukha Silverstone RERA complaints

No complaints listed on Karnataka RERA for this registration as on Source (rera.karnataka.gov.in) (opens in a new tab)

Court and consumer cases

Not found in public records yet: court cases

We list case numbers, courts and outcomes only — never names of private individuals.

About Sumukha Ventures

Promoter type
Partnership Firm
Projects on this site
3
RERA complaints against promoter
0
Company number (CIN)
Not found in public records yet: CIN

From Karnataka RERA, as collected so far (22 Oct 2026). Complaints are those RERA lists against this promoter across all its projects.

Sumukha Ventures’s RERA record

Sumukha Ventures delivery record

As on 22 Oct 2026

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this

What’s changed since Aug 2022

As on 22 Oct 2026
  1. 31 Mar 2026Completion date extended to 31 Mar 2026 Source (rera.karnataka.gov.in) (opens in a new tab)
  2. 30 Mar 2026Quarterly update filed for Q3 2025-26: 98% built, 39 of 69 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  3. 18 Nov 2022Registered with Karnataka RERA (PRM/KA/RERA/1251/310/PR/181122/005460); completion date 31 Jul 2025 Source (rera.karnataka.gov.in) (opens in a new tab)
  4. 1 Aug 2022Building plan approved by BBMP - Bruhat Bengaluru Mahanagara Palike (No. BBMP/Addl.Dir/JDSOUTH/0052/21-22) Source (rera.karnataka.gov.in) (opens in a new tab)
  5. 1 Aug 2022Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)

Newest first. When the RERA crawl sees a new filing, complaint or extension, it is added here with its date.

Home loan EMI calculator

No listed price found — enter one to try.

Example only — use your bank’s quote.

Monthly EMI
—
Down payment
—
Loan amount
—
Total interest
—

A calculation only, from the numbers you enter — not a loan offer.

All-in cost: GST, registration and other charges

The calculator loads when you scroll to it.

Assumptions
  • Base price: the builder’s price is not published in a form we could collect — enter it from the cost sheet.
  • GST 5% on the base price and charges — the usual rate for an under-construction home that is not “affordable housing” (1%).
  • Stamp duty about 5.6% and registration 2% — the Karnataka rule (registration was raised from 1% to 2% on 31 Aug 2025). Calculated on the agreement value.
  • Car parking, other charges and the maintenance deposit are not in the public record we collect; enter them from the builder’s cost sheet.
  • Loan on the agreement value (banks usually lend up to 75–90%); EMI is the standard reducing-balance formula. Example rate only — use your bank’s quote.

How we calculate this

Sumukha Silverstone FAQs

What is Sumukha Silverstone?

Sumukha Silverstone is a residential project by Sumukha Ventures located in Bengaluru South (PIN 560076) with 69 homes in one tower.

How many homes are in Sumukha Silverstone and what types?

The project has 69 homes: 39 units of 3 BHK and 30 units of 2 BHK.

What is the carpet area range in Sumukha Silverstone?

3 BHK homes range from 779 to 1,103 sq ft carpet area, and 2 BHK homes range from 795 to 1,095 sq ft carpet area.

When will Sumukha Silverstone be completed?

The completion date on RERA is 31 March 2026, which is a Section 6 Extension from the original date of 31 July 2025.

What is the RERA registration number for Sumukha Silverstone?

The RERA registration number is PRM/KA/RERA/1251/310/PR/181122/005460, registered on 18 November 2022.

How many homes in Sumukha Silverstone are booked?

As of Q3 2025-26 (ended 31 December 2025), 39 homes are booked out of 69 total homes.

What is the construction progress of Sumukha Silverstone?

As of Q3 2025-26 (ended 31 December 2025), the project is 98% complete.

Are there any RERA complaints on Sumukha Silverstone?

No RERA complaints have been filed on this project.

Does Sumukha Ventures have any other projects on RERA record?

Sumukha Ventures has 4 projects recorded in the Bengaluru RERA register.

Are there complaints against Sumukha Ventures?

No RERA complaints have been filed against Sumukha Ventures across any of its projects.

Written by AI from the RERA record above on 5 Oct 2026. Answers use only that record; check them against the source before you decide.

Questions about Sumukha Silverstone

No questions published yet. Ask the first one: you get an instant answer from this page’s public record, and our team follows up on anything the record does not show.

Bought a home from Sumukha Ventures? Review the builder.

Reviews of Sumukha Ventures by verified buyers

No verified reviews of Sumukha Ventures yet. If you bought a home from them, your review helps other buyers.

How reviews work: only buyers and owners can review; we confirm each purchase by phone before publishing, publish positive and negative reviews alike, never accept payment for reviews, and the builder may reply.

Similar projects within 5 km

ProjectDistanceHomesPossession (RERA)BuiltComplaintsPrice
Pacific LegacyMaryiam Infrastructure Private Limited0.4 km40Dec 2025100%0Not collected
Navin'S Antheia PoetryNavin Housing & Properties Pvt Ltd0.7 km42Jan 202821%0Not collected
Perody Peepal TreeM/s Perody Builders Pvt Ltd1.2 km19Dec 202690%0Not collected
MGR Windsor GardensSri Manjunatha Developers1.6 km36Dec 2025—0Not collected
ADARSH LAKE RESERVA Phase 1M/s Adarsh Developers1.9 km162Dec 20270%0Not collected
Adarsh Stratuss Phase 1M/s Adarsh Developers2 km108Nov 2025extended75%15Not collected

Projects of the same kind within 5 km in a straight line of this project’s RERA map point, nearest first. % built is the promoter’s latest quarterly figure on RERA (shown for single-registration projects); prices are from the builder’s own website where we found one.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Sources and last checked dates

  1. Karnataka RERA — project register (search by the registration number) (opens in a new tab)

Collected on 22 Oct 2026 by AI research agents reading public pages. Facts are written in our own words. Not found yet: price; court cases; landmarks; specifications; news.

How to check on RERA: On rera.karnataka.gov.in/viewAllProjects, type the registration number in 'Registration No', press Search, then click the 'View Project Details' icon. Complaints open from the 'Complaints / Litigation' icon in the same row. Registration number: PRM/KA/RERA/1251/310/PR/181122/005460.

  • RERA record last checked: 22 Oct 2026
  • Last change in the record (registration, quarterly filing or complaint): 30 Mar 2026

How this page is made: software builds it from public records (Karnataka RERA filings, OpenStreetMap, the builder’s own website). AI is used only to read filings into fields and to write the plain-English summary and FAQ answers, which are checked against the record. Facts are checked automatically against the RERA filing. Methodology · How we earn · Report an error
