Vistaas

1, 2, 3 & 4 BHK apartments by Sona Heights · Begur Road, Bengaluru

Begur Road, Bengaluru

  • Under construction
  • RERA registered
  • RERA not updated: completion promised Sep 2026; no extension or completion filed
  • residential

by Sona Heights

Price: Price on request

Get brochure, floor plans & price

Brochure, floor plans and price list for Vistaas

Builders share their brochure, floor plans and price list only on request. Tell us how to reach you and we’ll get them and send them to you, free.

Free for buyers. If you book through us, the builder pays us a commission. How we earn

Project summary

Vistaas is a residential project by Sona Heights in Begur, Bengaluru with 551 homes, registered with Karnataka RERA. The completion date on RERA is 1 Sep 2026.

Not in the RERA record we collected yet: map location. This page fills in as the record is collected.

Facts collected on 15 Oct 2026 from public records — each linked to its source. Free for buyers. If you book through us, the builder pays us a commission.

Vistaas buyers’ group: join to ask for a group price

No one has joined yet. Be one of the first 10 buyers in this group — the founding members.

Join free. When enough buyers have joined, our agent partner asks Sona Heights for a group price — for example a lower price, an easier payment plan or waived charges. Nothing is promised: you see what the builder offers and book directly with the builder if you want to. Free for buyers. If you book through us, the builder pays us a commission.

  1. Gathering buyers
  2. Talking to the builder
  3. Group offer
  4. Group site visit
  5. Booking

0 buyers have joined · 0 committed

Committed buyers have confirmed their budget, home type and timeline with us on a call; builders negotiate with them. Joining is free and never obliges you to buy.

Join the Vistaas buyers’ groupHow group buying works

See it for yourself

Visit the site with our team, or get a call to clear your questions. Free, no obligation.

Key facts: home types, towers, land and possession

Updated on 15 Oct 2026
Home types
1 BHK, 2 BHK, 3 BHK, 3.5 BHK, +2 more
Carpet area
331 – 1,791 sq ft
Towers
9
Floors
4
Total homes
551
Land
9.07 acres
Possession (extended)
Sep 2026
Built (RERA update)
82%

Vistaas RERA number and registration details

RERA number
PRM/KA/RERA/1251/310/PR/171103/001748
Registered on
3 Nov 2017
Promised completion
1 Dec 2024
Extended to
1 Sep 2026
RERA status
New launch
Homes booked
323 of 551 as on
Price
Not found in public records yet: price
Project type
Residential

Towers and blocks (RERA filing)

TowerFloorsBasementsHomes
Aster4140
Bluebell4130
Clover4139
Daffodil41106
Erica4150
F4175
G4180
H4195
I4165

A dash (—) means the filing did not state that value.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Summary in plain English

Vistaas is a residential project by Sona Heights in Begur, Bengaluru South, with 551 homes across 9 towers of up to 4 floors. The project is registered with RERA with a current completion date of 1 September 2026.

Written by AI from the RERA record above on 15 Oct 2026. Every number in it was checked against that record; if anything differs, the record wins.

Open space, home loans, escrow and other details

Open space
9.9% of land
Water and power
Not found in public records yet: water and power
Home loans: approved banks
Not found in public records yet: bank approvals
Payment plans
Not found in public records yet: payment plans
Maintenance
Not found in public records yet: maintenance
Car parking
Not found in public records yet: car parking charge
Escrow bank (RERA)
CENTRAL BANK OF INDIA, MILLER ROAD
Project cost declared to RERA
₹473 Cr

Open area as a share of the land, from the areas filed with RERA (includes driveways and landscaped areas).

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Amenities

Not found in public records yet: amenities

Vistaas location and address

Address
SURVEY NO 314/2, 314/1, 314/7,375/1, BEGUR VILLAGE, BEGUR HOBLI
Village (RERA)
Begur
Locality
Begur RoadAlso known as Begur, Begur Main Road, Begur Koppa Road
PIN code
400018
City
Bengaluru
State
Karnataka
Coordinates
Not found in public records yet: coordinates

Distances to landmarks

Not found in public records yet: landmarks

About Begur Road

Not found in public records yet: locality facts

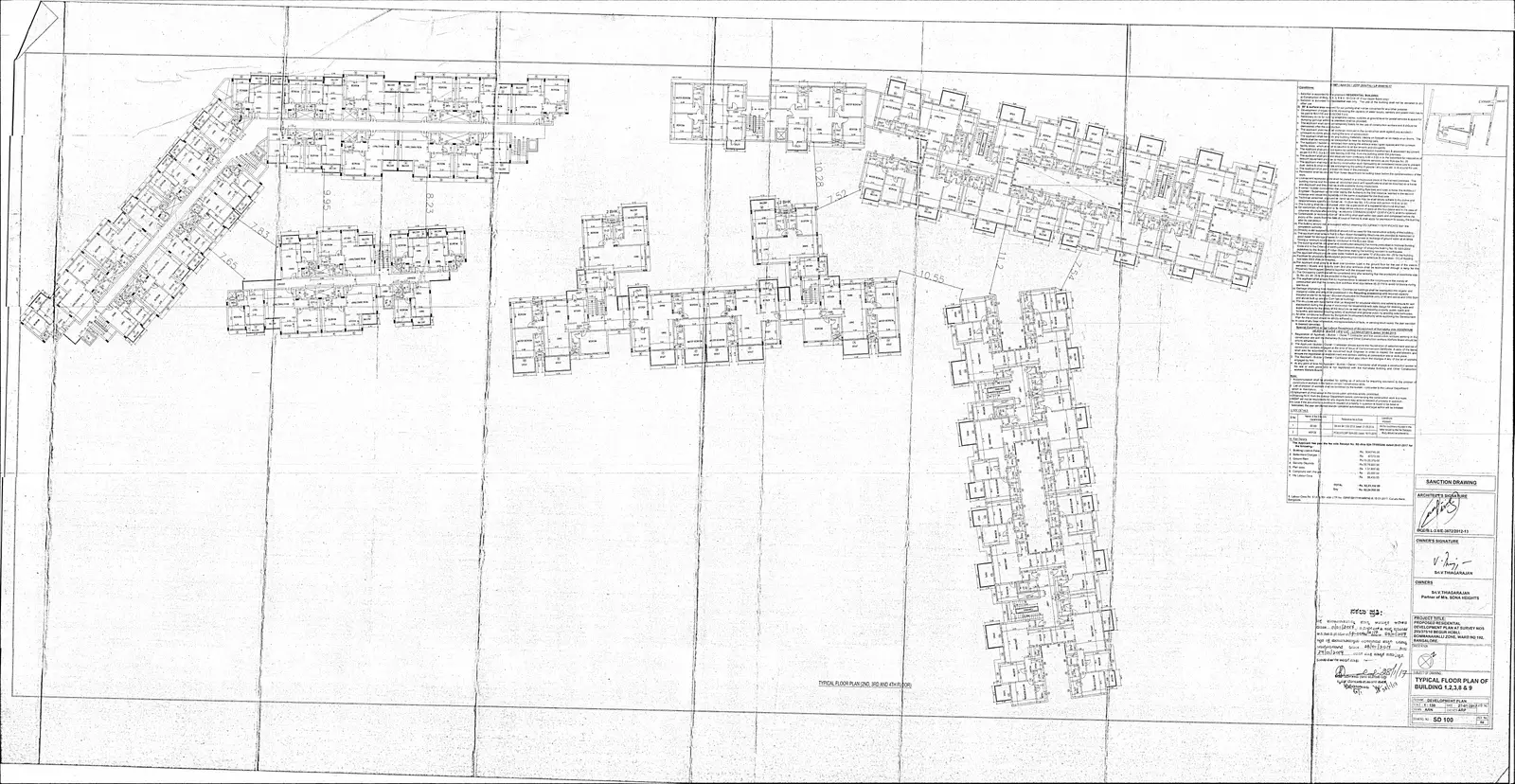

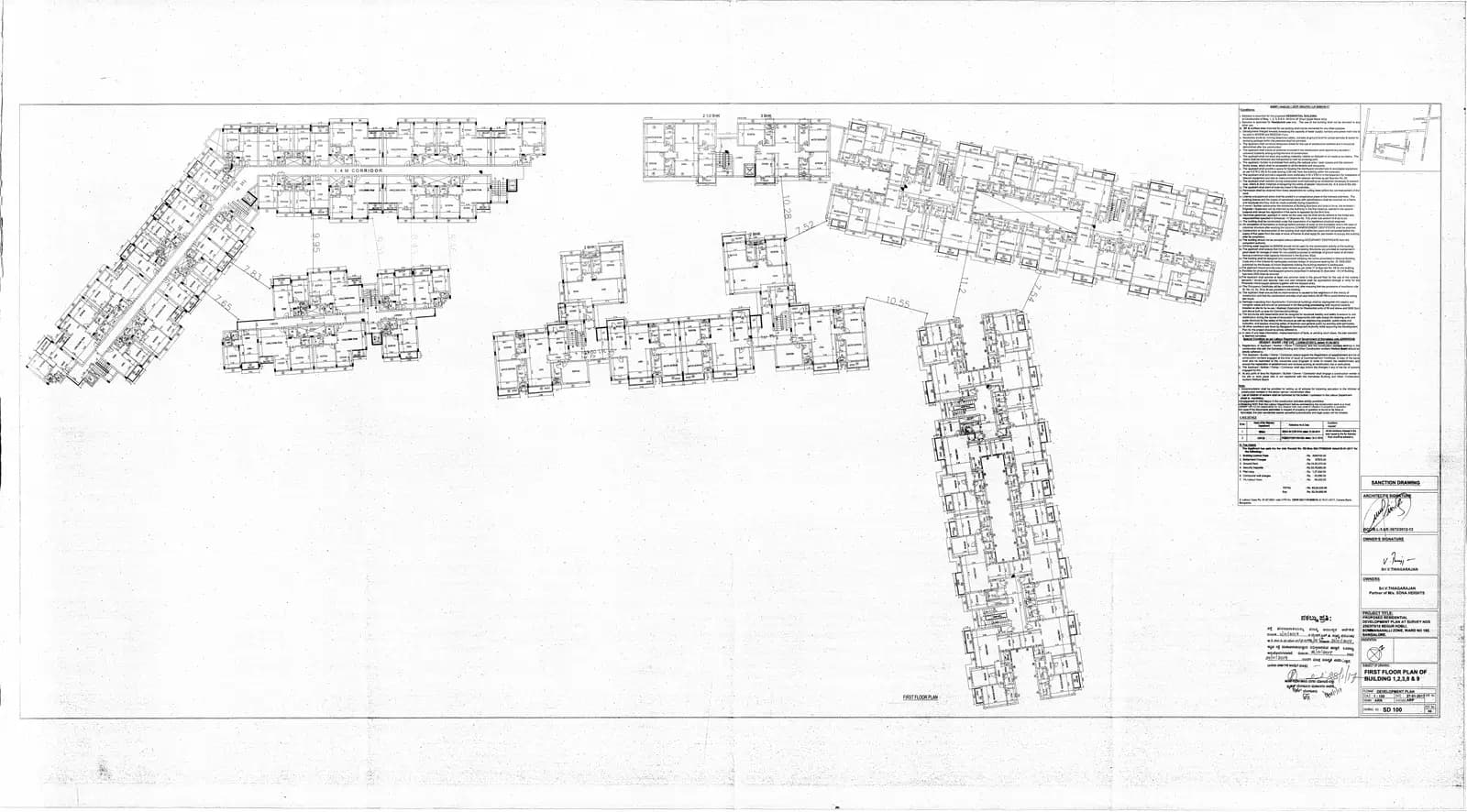

Vistaas floor plans, brochure and elevations

Documents the builder uploaded to Karnataka RERA, shown as filed. Tap a page to see it full size; the full PDF opens on the RERA website.

Floor plans3 files

Home typeCarpet areaHomes
1 BHK331 – 378 sq ft36
1 BHK - r336 sq ft4
2 BHK597 – 1,079 sq ft99
3 BHK984 – 1,370 sq ft361
3.5 BHK1,417 – 1,433 sq ft30
4 BHK1,421 – 1,791 sq ft1
4.5 BHK1,524 sq ft20

Home types, counts and carpet areas as filed with Karnataka RERA (carpet area, not super built-up).

We have not collected floor-plan drawings; the builder’s sales team can share them.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Vistaas possession date and construction status

  • Whole project (promoter’s RERA update)82%

    as on · 323 of 551 homes booked

Promoter’s quarterly update to RERA for Q4 2025-26, submitted 2026-06-22.

By tower (Q4 2025-26)

  • Aster100%
  • Bluebell100%
  • Clover100%
  • Daffodil100%
  • Erica100%
  • F95%
  • G90%
  • H95%
  • I85%

Units sold and unsold, from RERA (Q4 2025-26)

TypeHomesBookedAvailable
2 BHK918110
3 BHK361166195
1 BHK73721
3.5 BHK24420
4 BHK22022
1 BHK - R404

As reported by the promoter in the quarterly update to RERA, not verified by us.

Timeline

  1. 1 Nov 2017Project start date given to RERA
  2. 3 Nov 2017Registered with Karnataka RERA
  3. 1 Dec 2024Completion date given at registration
  4. 1 Sep 2026Section 6 Extension: completion date moved to this date

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Construction pace from RERA quarterly filings

As on 22 Jun 2026

At the average pace so far, construction would reach 100% around Feb 2028 — about 17 months after the completion date on RERA (1 Sep 2026).

At the pace between the 2 quarterly filings we have (78% → 82% in 3 months), it would be around May 2027 — about 8 months after the RERA date.

0%25%50%75%100%201820202022202420262028RERA date78%82%
  • Filed on RERA
  • Average pace since start
  • Pace between filings (and 0% assumed at the start date)
  • RERA completion date

Quarterly filings

QuarterFiled onBuiltHomes booked
Q4 2025-26to 31 Mar 202622 Jun 202682%323 of 575
Q3 2025-26to 31 Dec 202512 Feb 202678%309 of 515
How we calculate

Average pace = % built ÷ months since the start date in the RERA record. Here: 82% ÷ 100.9 months (1 Nov 2017 to 31 Mar 2026) = 0.8% a month.

Estimated finish = latest filing date + (100 − % built) ÷ pace = 31 Mar 2026 + 18 ÷ 0.8 = 22.2 months → Feb 2028. This is an estimate, not a date from the builder or RERA.

Pace between filings = (82% − 78%) ÷ 3 months = 1.4% a month.

A straight line is a simplification: the builder reports one overall %, which mixes excavation, structure and finishing, and work rarely moves at a constant speed. The % values are the promoter’s own figures filed with RERA, not checked by us. Promoter’s quarterly update to RERA for Q4 2025-26, submitted 2026-06-22.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this

Approvals and documents checklist

ApprovalAuthoritySource
Building planBDA - Bangalore Development AuthoritySource (rera.karnataka.gov.in) (opens in a new tab)

Documents uploaded to RERA

As on 15 Oct 2026
  • Building or layout plan · Approved drawings from the planning authorityFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Commencement certificate · Permission to start buildingNot on RERA yet
  • Environment clearance · SEIAA KarnatakaNot on RERA yet
  • Fire NOC · Karnataka Fire and Emergency ServicesNot on RERA yet
  • Pollution board consent · KSPCBNot on RERA yet
  • Water and sewerage · BWSSBNot on RERA yet
  • Electricity · BESCOMNot on RERA yet
  • Height clearance · Airports Authority of IndiaNot on RERA yet
  • Occupancy certificate (OC) · Issued only when the building is finishedNot on RERA yet — expected at completion

From the documents the promoter uploaded to Karnataka RERA, collected 15 Oct 2026. “Filed” means a document is on RERA — we have not checked its contents or validity. Not every approval applies to every project (for example, smaller projects may not need an environment clearance). The project page on RERA lists each upload.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Vistaas RERA complaints

1 complaint as on Source (rera.karnataka.gov.in) (opens in a new tab)

Complaint refFiledSubjectStatusSource
00402/202616 Apr 2026Complaint under Section 18 and 19 of the RERA Act regarding delayed possession, denial of monthly delay interest, Section 13 (1) breach, and coercive extra-contractual demands in respect of Apartment.Under enquirySource (rera.karnataka.gov.in) (opens in a new tab)

Court and consumer cases

Not found in public records yet: court cases

We list case numbers, courts and outcomes only — never names of private individuals.

About Sona Heights

Promoter type
Partnership Firm
Projects on this site
1
RERA complaints against promoter
1
Company number (CIN)
Not found in public records yet: CIN

From Karnataka RERA, as collected so far (15 Oct 2026). Complaints are those RERA lists against this promoter across all its projects.

Sona Heights’s RERA record

Sona Heights delivery record

As on 15 Oct 2026

What the complaints are about

  • Delay in possession or delay interest1

1 complaint subject as written on RERA, as on . Each subject is sorted into one group by keywords (first match wins: delay, refund, registration, quality, litigation, association); one complaint often raises several issues. Source (rera.karnataka.gov.in) (opens in a new tab)

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this

What’s changed since Nov 2017

As on 15 Oct 2026
  1. 1 Sep 2026Completion date extended to 1 Sep 2026 Source (rera.karnataka.gov.in) (opens in a new tab)
  2. 22 Jun 2026Quarterly update filed for Q4 2025-26: 82% built, 323 of 575 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  3. 16 Apr 2026Complaint 00402/2026 filed with RERA: “Complaint under Section 18 and 19 of the RERA Act regarding delayed possession, denial of monthly delay interest, Section 13 (1) breach, and coercive extra-contractual demands in respect of Apartment.” — now under enquiry Source (rera.karnataka.gov.in) (opens in a new tab)
  4. 12 Feb 2026Quarterly update filed for Q3 2025-26: 78% built, 309 of 515 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  5. 3 Nov 2017Registered with Karnataka RERA (PRM/KA/RERA/1251/310/PR/171103/001748); completion date 1 Dec 2024 Source (rera.karnataka.gov.in) (opens in a new tab)
  6. 1 Nov 2017Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)

Newest first. When the RERA crawl sees a new filing, complaint or extension, it is added here with its date.

Home loan EMI calculator

No listed price found — enter one to try.

Example only — use your bank’s quote.

Monthly EMI
—
Down payment
—
Loan amount
—
Total interest
—

A calculation only, from the numbers you enter — not a loan offer.

All-in cost: GST, registration and other charges

The calculator loads when you scroll to it.

Assumptions
  • Base price: the builder’s price is not published in a form we could collect — enter it from the cost sheet.
  • GST 5% on the base price and charges — the usual rate for an under-construction home that is not “affordable housing” (1%).
  • Stamp duty about 5.6% and registration 2% — the Karnataka rule (registration was raised from 1% to 2% on 31 Aug 2025). Calculated on the agreement value.
  • Car parking, other charges and the maintenance deposit are not in the public record we collect; enter them from the builder’s cost sheet.
  • Loan on the agreement value (banks usually lend up to 75–90%); EMI is the standard reducing-balance formula. Example rate only — use your bank’s quote.

How we calculate this

Vistaas FAQs

What is the completion date for Vistaas?

The current completion date on RERA is 1 September 2026. The original completion date was 1 December 2024, and it has been extended twice: once for Covid Extension and once under Section 6 Extension.

How many homes are there in Vistaas?

Vistaas has 551 homes across 9 towers.

What home types are available in Vistaas?

Vistaas offers 1 BHK, 1 BHK - R, 2 BHK, 3 BHK, 3.5 BHK, 4 BHK and 4.5 BHK homes. Carpet areas range from 331 sq ft for 1 BHK homes to 1,791 sq ft for 4 BHK homes.

What is the carpet area range for 3 BHK homes in Vistaas?

3 BHK homes in Vistaas have carpet areas between 984 sq ft and 1,370 sq ft. There are 361 such homes in the project.

Where is Vistaas located?

Vistaas is located in Begur, Bengaluru South taluk, with PIN code 400018.

What is the construction progress of Vistaas?

As of Q4 2025-26 (quarter ended 31 March 2026), the project is 82% complete with 323 homes booked out of 575 in the booking table.

What is the RERA registration number for Vistaas?

The RERA registration number is PRM/KA/RERA/1251/310/PR/171103/001748, registered on 3 November 2017.

How many RERA complaints are there on Vistaas?

There is 1 RERA complaint on this project.

Who is the builder of Vistaas and what is their track record?

The builder is Sona Heights, a Partnership Firm. There is 1 RERA complaint against the builder across all their projects, and Vistaas is the only project of this builder in our Bengaluru records.

What is the escrow bank for Vistaas?

The escrow bank for Vistaas is Central Bank of India.

Written by AI from the RERA record above on 15 Oct 2026. Answers use only that record; check them against the source before you decide.

Questions about Vistaas

No questions published yet. Ask the first one: you get an instant answer from this page’s public record, and our team follows up on anything the record does not show.

Bought a home from Sona Heights? Review the builder.

Reviews of Sona Heights by verified buyers

No verified reviews of Sona Heights yet. If you bought a home from them, your review helps other buyers.

How reviews work: only buyers and owners can review; we confirm each purchase by phone before publishing, publish positive and negative reviews alike, never accept payment for reviews, and the builder may reply.

Sources and last checked dates

  1. Karnataka RERA — project register (search by the registration number) (opens in a new tab)

Collected on 15 Oct 2026 by AI research agents reading public pages. Facts are written in our own words. Not found yet: price; court cases; landmarks; specifications; news.

How to check on RERA: On rera.karnataka.gov.in/viewAllProjects, type the registration number in 'Registration No', press Search, then click the 'View Project Details' icon. Complaints open from the 'Complaints / Litigation' icon in the same row. Registration number: PRM/KA/RERA/1251/310/PR/171103/001748.

  • RERA record last checked: 15 Oct 2026
  • Last change in the record (registration, quarterly filing or complaint): 22 Jun 2026

How this page is made: software builds it from public records (Karnataka RERA filings, OpenStreetMap, the builder’s own website). AI is used only to read filings into fields and to write the plain-English summary and FAQ answers, which are checked against the record. Facts are checked automatically against the RERA filing. Methodology · How we earn · Report an error

More new projects in Begur Road

  • Casagrand Amor: Site photo filed with Karnataka RERAChandrashekarapura, Begur RoadUnder constructionRERA registeredBuyers’ group open

    Casagrand Amor

    by Casa Grande Garden City Builders

    Price: Price on requestGet brochure & price →

    • 1 BHK, 2 BHK, 3 BHK
    • 337 – 1,338 sq ft
    • Feb 2028

    480 homes · 1 RERA complaint

    Be one of the first 10 buyers in this groupFounding members — it’s free

    Join group for Casagrand Amor
