VRR Golden Enclave

1 & 3 BHK apartments by H N Vijayaraghava Reddy Co · Hulimangala, near Electronic City Phase 1, Bengaluru

Hulimangala, near Electronic City Phase 1, BengaluruOpen on Google Maps (opens in a new tab)

  • Under construction
  • RERA registered
  • residential

by H N Vijayaraghava Reddy Co

Price: Price on request

Get brochure, floor plans & price

Brochure, floor plans and price list for VRR Golden Enclave

Builders share their brochure, floor plans and price list only on request. Tell us how to reach you and we’ll get them and send them to you, free.

Free for buyers. If you book through us, the builder pays us a commission. How we earn

Project summary

VRR Golden Enclave is a residential project by H N Vijayaraghava Reddy Co in Hulimangala, Bengaluru with 97 homes, registered with Karnataka RERA. The completion date on RERA is 31 Dec 2027. It is registered in 2 phases.

Facts collected on 20 Oct 2026 from public records — each linked to its source. Free for buyers. If you book through us, the builder pays us a commission.

VRR Golden Enclave buyers’ group: join to ask for a group price

No one has joined yet. Be one of the first 10 buyers in this group — the founding members.

Join free. When enough buyers have joined, our agent partner asks H N Vijayaraghava Reddy Co for a group price — for example a lower price, an easier payment plan or waived charges. Nothing is promised: you see what the builder offers and book directly with the builder if you want to. Free for buyers. If you book through us, the builder pays us a commission.

  1. Gathering buyers
  2. Talking to the builder
  3. Group offer
  4. Group site visit
  5. Booking

0 buyers have joined · 0 committed

Committed buyers have confirmed their budget, home type and timeline with us on a call; builders negotiate with them. Joining is free and never obliges you to buy.

Join the VRR Golden Enclave buyers’ groupHow group buying works

See it for yourself

Visit the site with our team, or get a call to clear your questions. Free, no obligation.

Key facts: home types, towers, land and possession

Updated on 20 Oct 2026
Home types
1 BHK, 3 BHK, Villa
Carpet area
463 – 3,291 sq ft
Towers
2
Floors
3
Total homes
97
Land
7.88 acres
Possession (RERA)
Dec 2027
Built (RERA update)
Not found in public records yet: construction progress

VRR Golden Enclave RERA number and registration details

RERA number
PRM/KA/RERA/1251/308/PR/211222/005548
Registered on
21 Dec 2022
Promised completion
31 Dec 2027
Extended to
No extension recorded
RERA status
Under construction
Homes booked
Not found in public records yet: homes booked
Price
Not found in public records yet: price
Project type
Residential

2 RERA registrations (one per phase) are shown together on this page; dates above are the latest across phases.

Phases and RERA numbers

PhaseRERA numberPromised completionHomesStatusSource
Phase IIPRM/KA/RERA/1251/308/PR/211222/00554831 Dec 202784CompletedSource (rera.karnataka.gov.in) (opens in a new tab)
Phase-IIIPRM/KA/RERA/1251/308/PR/290425/00769830 Jun 202713Under constructionSource (rera.karnataka.gov.in) (opens in a new tab)

Towers and blocks (RERA filing)

TowerPhaseFloorsBasementsHomes
GOLDEN ENCLAVE PHASE-IIPhase II3146
ROW HOUSESPhase-III3013

A dash (—) means the filing did not state that value.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Summary in plain English

VRR Golden Enclave is a residential project by H N Vijayaraghava Reddy Co in Hulimangala, Anekal. The project has 97 homes across 2 phases with villas, rowhouses, and apartments. Completion is scheduled for 31 December 2027 for Phase II and 30 June 2027 for Phase III.

Written by AI from the RERA record above on 20 Oct 2026. Every number in it was checked against that record; if anything differs, the record wins.

Open space, home loans, escrow and other details

Open space
Not found in public records yet: open space
Water and power
Water source filed with RERA: BoreWell,Local Authority
Home loans: approved banks
Not found in public records yet: bank approvals
Payment plans
Not found in public records yet: payment plans
Maintenance
Not found in public records yet: maintenance
Car parking
Not found in public records yet: car parking charge
Escrow bank (RERA) · Phase II
Karnataka Bank Ltd., Koramangala
Escrow bank (RERA) · Phase-III
Karnataka Bank Ltd., KORAMANGALA

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Amenities

  • Electricity
  • Smart Home Automation
  • CCTV Surveillance
  • Club House
  • Community Hall
  • Outdoor Sports facility
  • Indoor Sports facility
  • Swimming Pool
  • Gym
  • Parks
  • Power Backup
  • Water and Sanitation
  • Air Conditioning

Amenities and internal works as filed by the promoter with Karnataka RERA; we have not visited the site.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

VRR Golden Enclave location and address

Address
Sy.no 355 (Old Sy.no.155/14) , Hulimangala Village, Jigani Hobli, Anekal Taluk, Bengaluru , Anekal , Bengaluru Urban, Karnataka - 560100
Village (RERA)
Hulimangala
Locality
Near Electronic City Phase 1Also known as Electronic City, Electronics City, E-City
PIN code
560100
City
Bengaluru
State
Karnataka
Coordinates
12.82355, 77.65277

Distances to landmarks

Not found in public records yet: landmarks

About Hulimangala

Not found in public records yet: locality facts

Commute times to tech parks and the airport

As on 5 Oct 2026
ToStraight linePeak-hour drive (estimate)
Electronic City Phase 1Map point on OpenStreetMap (opens in a new tab)3.19 kmapprox. 13 min
Outer Ring Road tech corridor (RMZ Ecospace, Bellandur)Map point on OpenStreetMap (opens in a new tab)11.56 kmapprox. 47 min
KSR Bengaluru City railway station (Majestic)Map point on OpenStreetMap (opens in a new tab)19.41 kmapprox. 79 min
ITPL, Whitefield (main gate)Map point on OpenStreetMap (opens in a new tab)20.44 kmapprox. 83 min
Manyata Tech ParkMap point on OpenStreetMap (opens in a new tab)25.23 kmapprox. 102 min
Kempegowda International AirportMap point on OpenStreetMap (opens in a new tab)42.31 kmapprox. 171 min
How we calculate

Straight line: from the project’s map point on RERA to the destination’s point on OpenStreetMap.

Peak-hour drive is a rough estimate, not a route: straight line × 1.35 for the road network, at 20 km/h. Real times vary a lot with the route and the hour.

Sources:Source (openstreetmap.org) (opens in a new tab)How we calculate this

Schools and hospitals nearby

As on 5 Oct 2026

Within 2 km

  • 4Schools and colleges4 schools, 0 colleges, 0 kindergartens
  • 5Hospitals and clinics1 hospitals, 4 clinics

Nearest schools and colleges

  • Treamis World School · 0.7 km
  • EuroSchool Electronic City · 0.74 km
  • Government School · 1.78 km

Nearest hospitals and clinics

  • Shree Vinayaka Multispeciality Centre · 1.31 km
  • Thirumala clinic · 1.59 km
  • Wipro First Aid Clinic · 1.69 km

Places as mapped on OpenStreetMap (amenity=school, college, kindergarten, university; hospital, clinic), counted within 2 km in a straight line of the RERA map point. Volunteers map these, so some places may be missing or closed. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.

Sources:Source (openstreetmap.org) (opens in a new tab)

Nearest metro station and railway

As on 5 Oct 2026
  • Biocon Hebbagodi (ಬಯೋಕಾನ್ ಹೆಬ್ಬಗೋಡಿ)Open now — nearest operating metro station3.16 km
  • Heelalige (ಹೀಲಲಿಗೆ ರೈಲು ನಿಲ್ದಾಣ)Nearest railway station6.42 km

Straight-line distances from the RERA map point to the station points mapped on OpenStreetMap; status (open or under construction) as tagged there. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.

Sources:Source (openstreetmap.org) (opens in a new tab)

Lake and lake-buffer check

As on 5 Oct 2026

The nearest mapped lake is Unnamed lake (mapped on OpenStreetMap), 774 m from the project’s RERA map point.

The site boundary is not published as a shape, so its nearest edge can be closer than this point. Whether any building sits inside a lake buffer can only be checked on the approved plan.

The buffer rule

Bengaluru’s lake buffer rule has changed over time: the National Green Tribunal ordered a 75 m buffer in May 2016; the Supreme Court set that order aside on 5 March 2019, leaving the 30 m buffer of the Revised Master Plan 2015. Check the current rule and the approved plan before relying on either number.

Shortest distance from the RERA map point to the mapped water edge (OpenStreetMap water polygons tagged lake or reservoir, or named lake/kere/tank). Mapped shorelines can differ from the revenue-record boundary of a lake. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.

Sources:Source (openstreetmap.org) (opens in a new tab)Source (livelaw.in) (opens in a new tab)Source (citizenmatters.in) (opens in a new tab)How we calculate this

Satellite time-lapse of the site

Satellite photos load when you scroll to them.

Photos from Esri World Imagery Wayback, centred on the project’s map point; dates are the capture dates in Esri’s metadata. Loaded from Esri when you scroll here.

Sources:Source (livingatlas.arcgis.com) (opens in a new tab)

VRR Golden Enclave floor plans, brochure and elevations

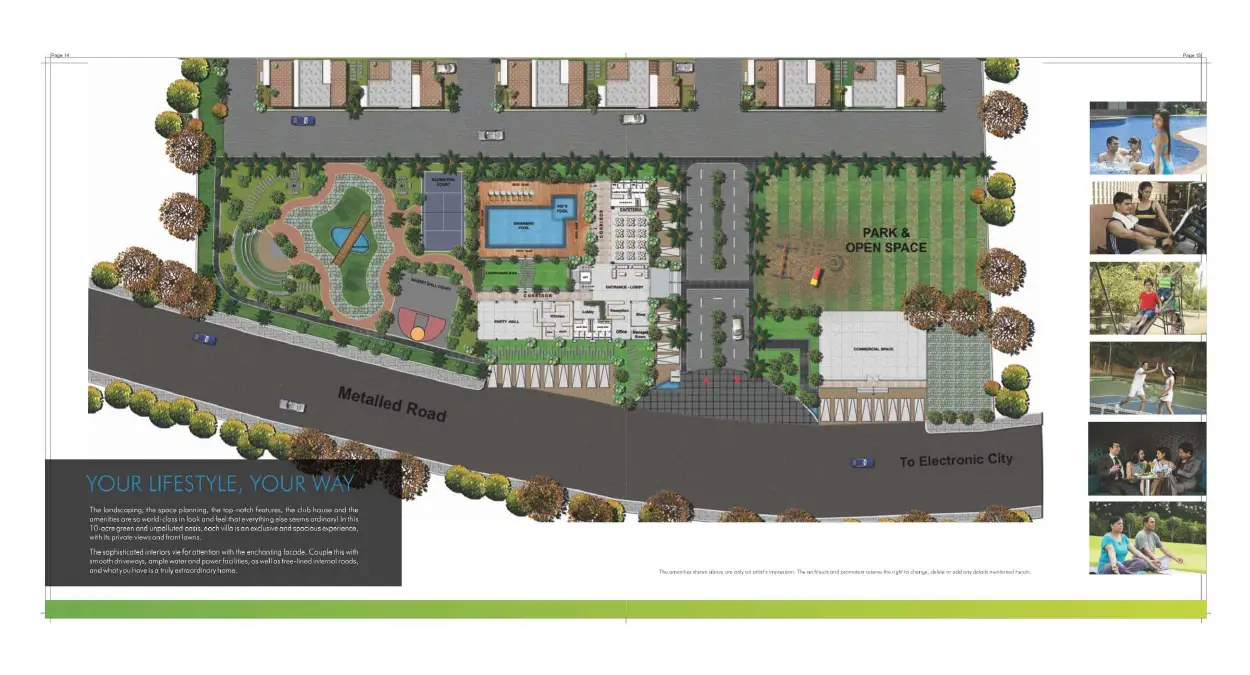

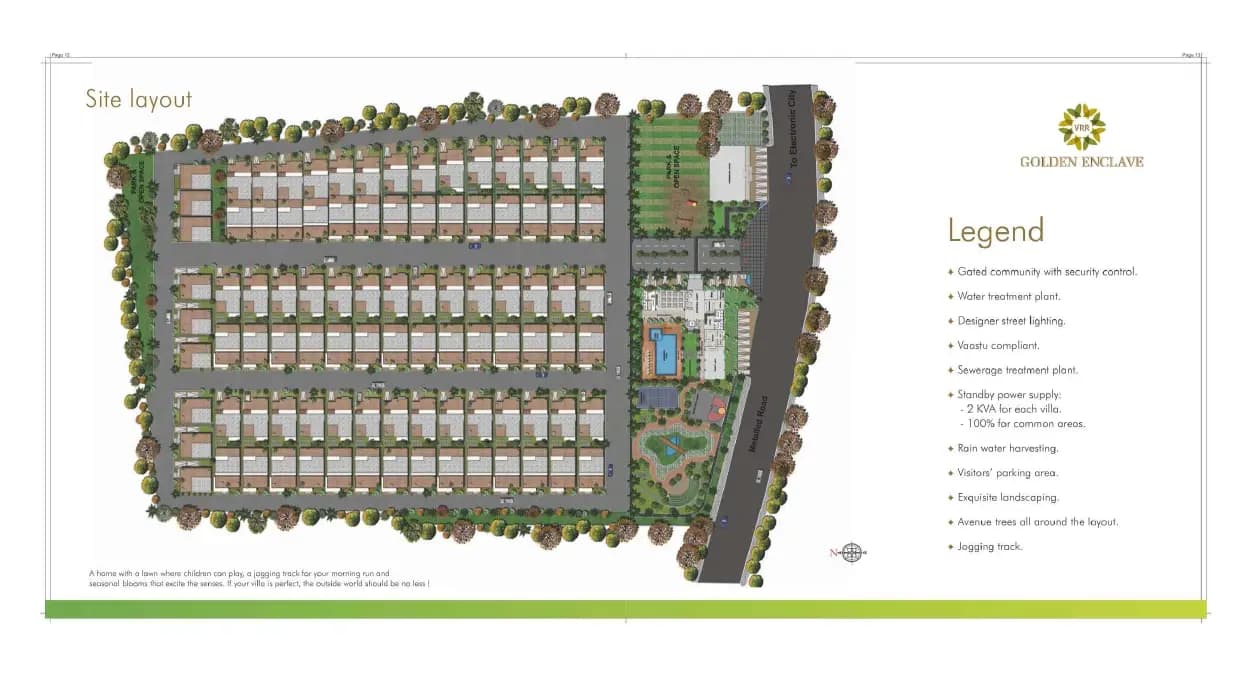

Documents the builder uploaded to Karnataka RERA, shown as filed. Tap a page to see it full size; the full PDF opens on the RERA website.

Brochure20 pages

Approved building plan

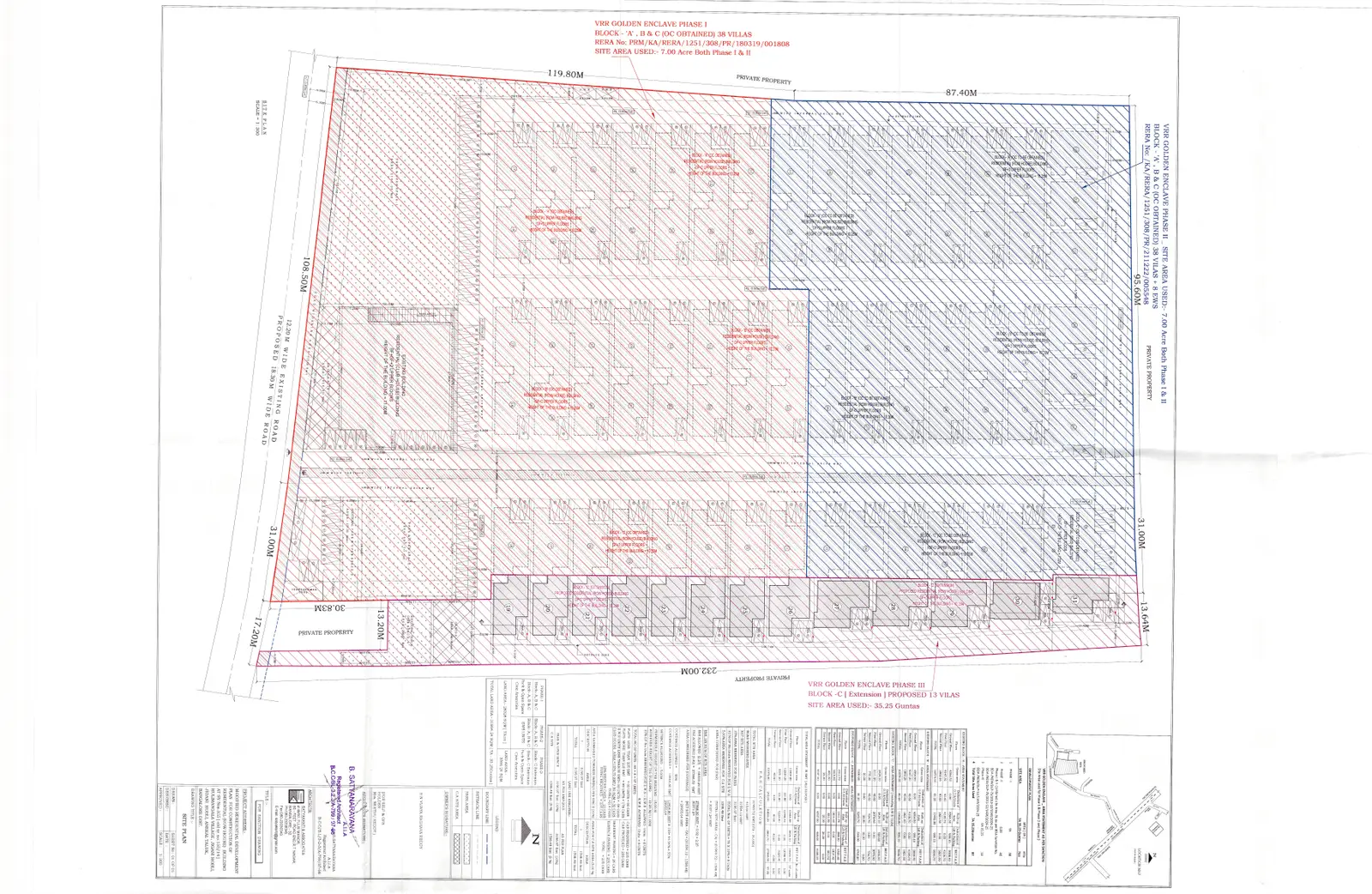

Approved layout plan3 files

Home typeCarpet areaHomes
1 BHK463 sq ft8
3 BHK2,329 – 3,291 sq ft13
Rowhouses2,971 sq ft13
Villa2,637 – 2,852 sq ft46

Home types, counts and carpet areas as filed with Karnataka RERA (carpet area, not super built-up).

We have not collected floor-plan drawings; the builder’s sales team can share them.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

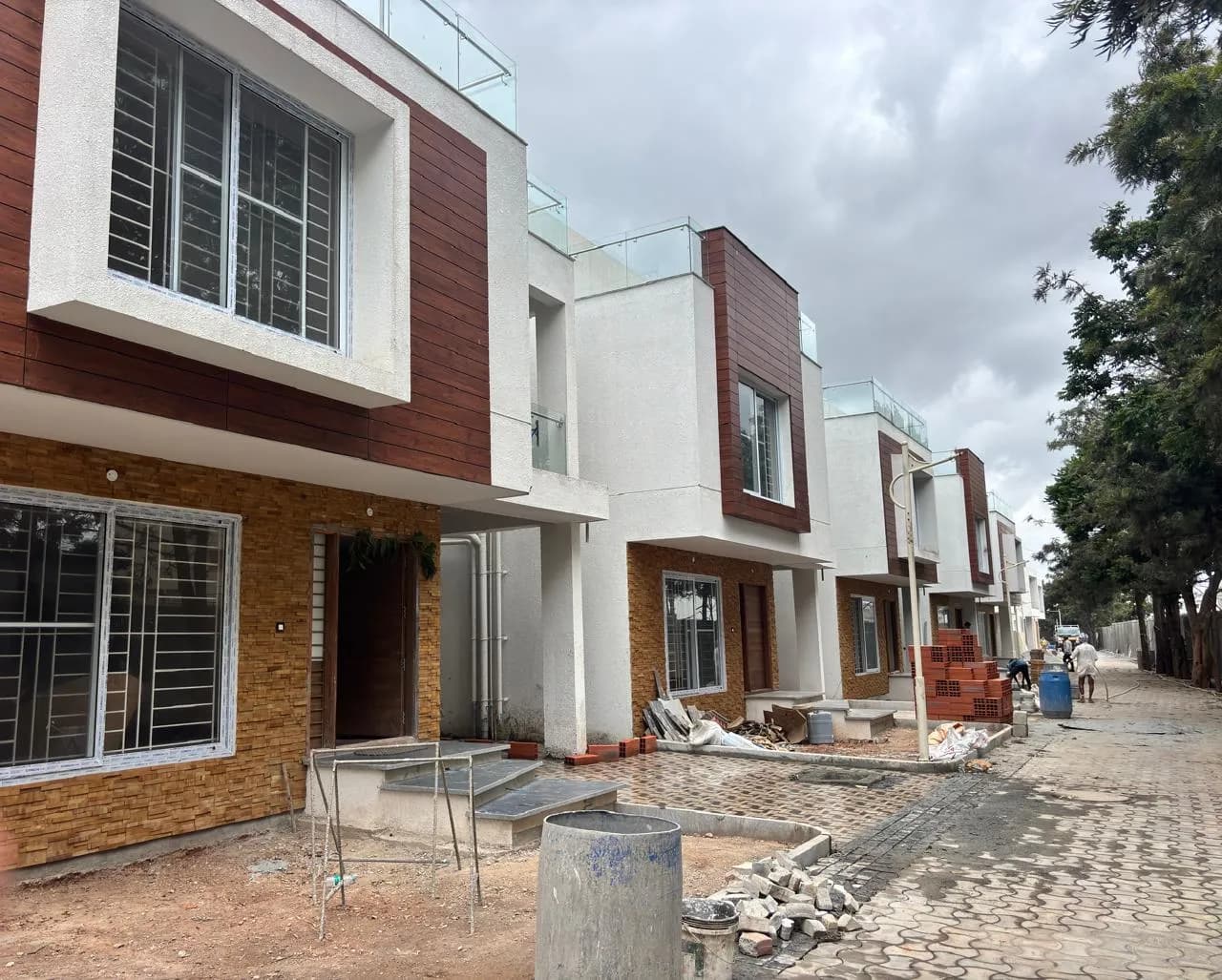

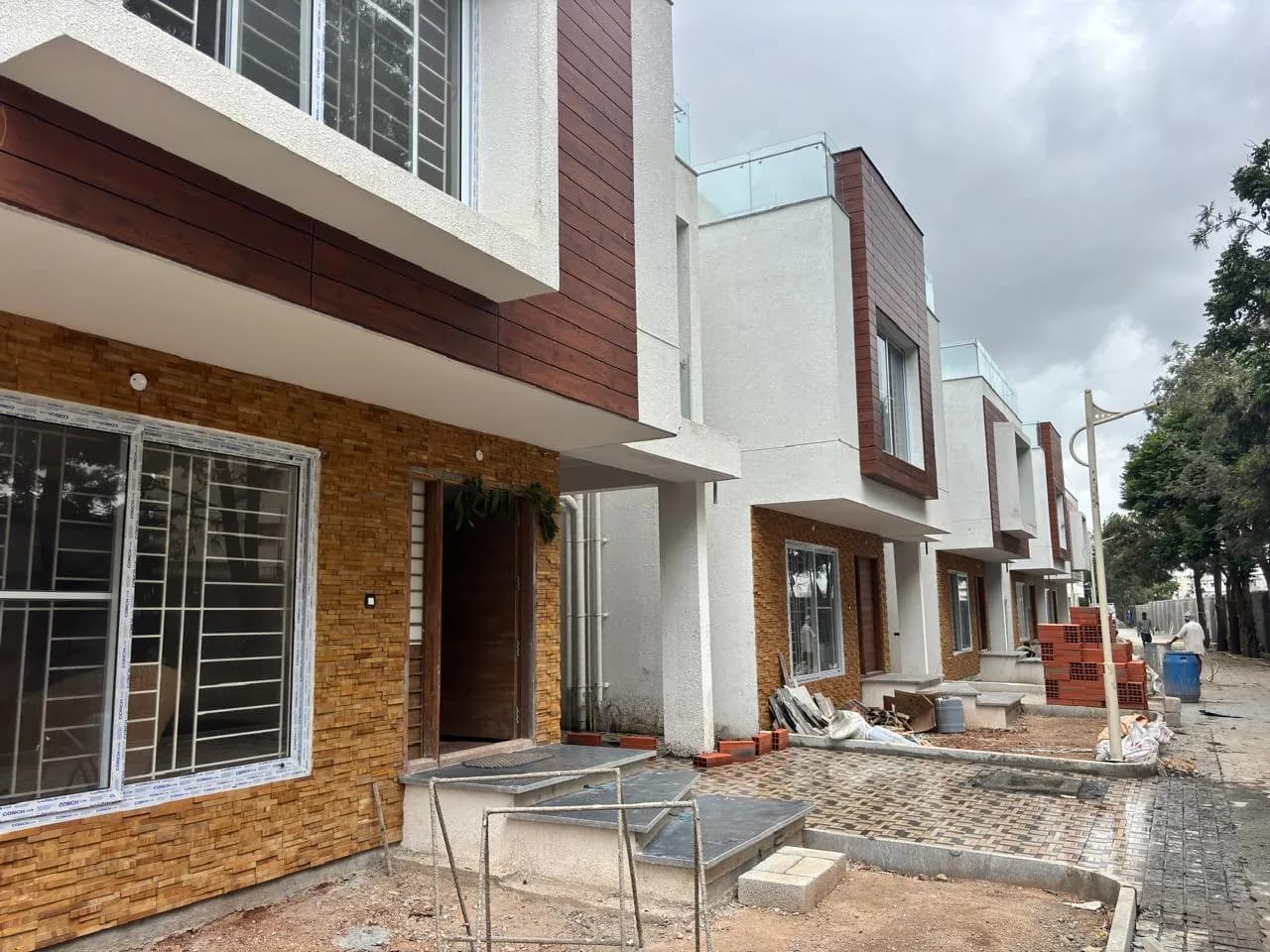

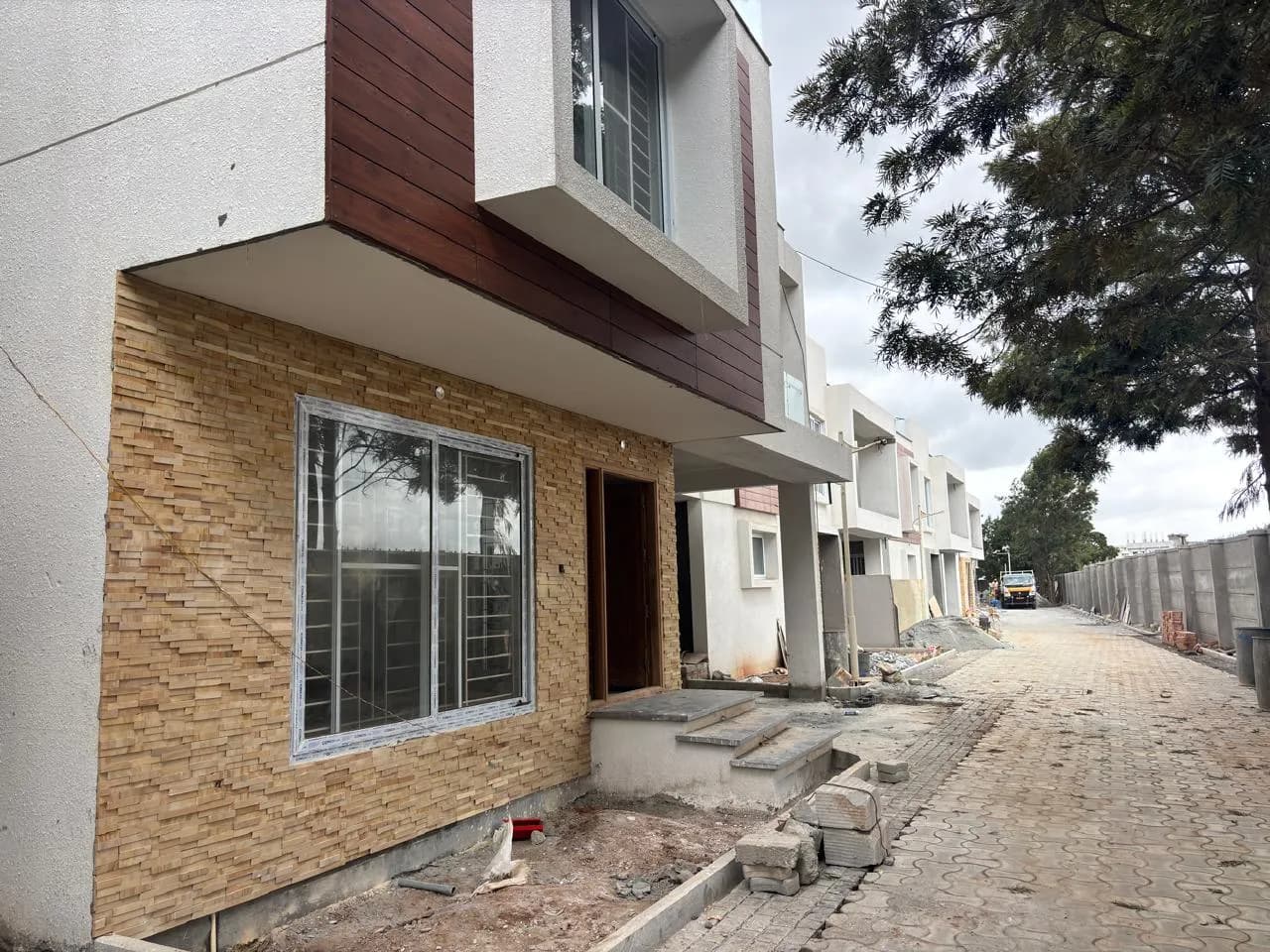

VRR Golden Enclave possession date and construction status

  • Phase-III99%

    as on · 6 of 13 homes booked

Timeline

  1. 1 Aug 2021Phase II: Project start date given to RERA
  2. 21 Dec 2022Phase II: Registered with Karnataka RERA
  3. 25 Nov 2024Phase-III: Project start date given to RERA
  4. 29 Apr 2025Phase-III: Registered with Karnataka RERA
  5. 1 Jul 2025Phase II: Promoter applied to RERA for completion
  6. 30 Jun 2027Phase-III: Completion date given at registration
  7. 31 Dec 2027Phase II: Completion date given at registration

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Construction pace from RERA quarterly filings (Phase-III)

As on 13 Oct 2026

At the average pace so far, construction would reach 100% around Oct 2026 — about 9 months before the completion date on RERA (30 Jun 2027).

At the pace between the 4 quarterly filings we have (80% → 99% in 9 months), it would be around Oct 2026 — about 8 months before the RERA date.

This project has 2 RERA registrations; the chart uses Phase-III, the one with the most quarterly filings.

0%25%50%75%100%202520262027RERA date80%87%98%99%
  • Filed on RERA
  • Average pace since start
  • Pace between filings (and 0% assumed at the start date)
  • RERA completion date

Quarterly filings

QuarterFiled onBuiltHomes booked
Q2 2026-27to 30 Sep 202613 Oct 202699%6 of 13
Q1 2026-27to 30 Jun 20269 Jul 202698%6 of 13
Q4 2025-26to 31 Mar 202620 Apr 202687%5 of 13
Q3 2025-26to 31 Dec 202516 Jan 202680%3 of 13
How we calculate

Average pace = % built ÷ months since the start date in the RERA record. Here: 99% ÷ 22.1 months (25 Nov 2024 to 30 Sep 2026) = 4.5% a month.

Estimated finish = latest filing date + (100 − % built) ÷ pace = 30 Sep 2026 + 1 ÷ 4.5 = 0.2 months → Oct 2026. This is an estimate, not a date from the builder or RERA.

Pace between filings = (99% − 80%) ÷ 9 months = 2.1% a month.

A straight line is a simplification: the builder reports one overall %, which mixes excavation, structure and finishing, and work rarely moves at a constant speed. The % values are the promoter’s own figures filed with RERA, not checked by us.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this

Approvals and documents checklist

20 rows: approvals. Scroll inside the table to see them all.

ApprovalAuthoritySource
Building plan (Phase II)BDA - Bangalore Development Authority · No. NM/AS/AA03/TS02/S/05/2021-22 · dated 2021-09-13Source (rera.karnataka.gov.in) (opens in a new tab)
Land conversion (Phase II)Special Deputy Commissioner · No. 111/2007-08 & 97/10-11 · dated 2009-12-23Source (rera.karnataka.gov.in) (opens in a new tab)
Commencement Certificate (Phase II)scan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Electricity Permission Letter (Phase II)scan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Water Permission Letter (Phase II)scan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Approved Layout Plan (Phase II)scan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Approved Building/Plotting Plan (Phase II)scan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Change of Land Use (Phase II)scan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Conversion Certificate under section 95 of the KLR Act 1964 (Phase II)scan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
ESCOM/Electricity (Phase II)scan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
KWSSB/Water (Phase II)scan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Fire Force Department (Phase II)scan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
KSPCB (Phase II)scan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Building plan (Phase-III)BDA - Bangalore Development Authority · No. BDA/TPM/DLP-75/2011-12/2088/2024-25-DT:25.11.2024 · dated 2024-11-25Source (rera.karnataka.gov.in) (opens in a new tab)
Land conversion (Phase-III)DEPUTY COMMISSIONER · No. 620535 · dated 2024-05-03Source (rera.karnataka.gov.in) (opens in a new tab)
Commencement Certificate (Phase-III)scan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Approved Building Plan (Phase-III)scan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
ESCOM/Electricity (Phase-III)scan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
KWSSB/Water (Phase-III)scan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
KSPCB (Phase-III)scan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)

Documents uploaded to RERA (Phase II)

As on 4 Oct 2026
  • Building or layout plan · Approved drawings from the planning authorityFiled on RERA ✓ — BDA - Bangalore Development Authority · No. NM/AS/AA03/TS02/S/05/2021-22 · dated 13 Sep 2021
  • Commencement certificate · Permission to start buildingFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Environment clearance · SEIAA KarnatakaNot on RERA yet
  • Fire NOC · Karnataka Fire and Emergency ServicesFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Pollution board consent · KSPCBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Water and sewerage · BWSSBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Electricity · BESCOMFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Height clearance · Airports Authority of IndiaNot on RERA yet
  • Occupancy certificate (OC) · Issued only when the building is finishedNot on RERA yet

From the documents the promoter uploaded to Karnataka RERA, collected 4 Oct 2026. “Filed” means a document is on RERA — we have not checked its contents or validity. Not every approval applies to every project (for example, smaller projects may not need an environment clearance). Each phase is registered separately; this list is for the phase named above. The project page on RERA lists each upload.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

VRR Golden Enclave RERA complaints

No complaints listed on Karnataka RERA for these registrations as on Source (rera.karnataka.gov.in) (opens in a new tab)

Court and consumer cases

Not found in public records yet: court cases

We list case numbers, courts and outcomes only — never names of private individuals.

About H N Vijayaraghava Reddy Co

Promoter type
Partnership Firm
Projects on this site
1
RERA complaints against promoter
1
Company number (CIN)
Not found in public records yet: CIN

From Karnataka RERA, as collected so far (20 Oct 2026). Complaints are those RERA lists against this promoter across all its projects.

H N Vijayaraghava Reddy Co’s RERA record

H N Vijayaraghava Reddy Co delivery record

As on 20 Oct 2026
  • 1Projects in Bengaluru on RERA2 approved registrations under H N Vijayaraghava Reddy Co in Bengaluru Urban and Rural. Source (rera.karnataka.gov.in) (opens in a new tab)
  • 97Homes registeredAs stated in each registrations.
  • 1RERA complaints0 open, 1 disposed. as on Source (rera.karnataka.gov.in) (opens in a new tab)
  • 10.3Complaints per 1,000 homes1 complaints ÷ 97 homes in its 2 registrations on Karnataka RERA in Bengaluru.
  • 1Completion filed on RERARegistrations where the promoter applied to RERA for completion; 1 with an occupancy certificate on RERA.
  • 1 of 1Filed by the date given at registrationMedian gap 0 months (on-time ones count as 0). The completion application can come after handover, so this is an upper bound on lateness.

What the complaints are about

  • Registration, sale deed or agreement1

1 complaint subject as written on RERA, as on . Each subject is sorted into one group by keywords (first match wins: delay, refund, registration, quality, litigation, association); one complaint often raises several issues. Source (rera.karnataka.gov.in) (opens in a new tab)

Completion filed on RERA

ProjectDate at registrationCompletion filedGap
VRR Golden Enclave Phase IIOC on RERA31 Dec 20271 Jul 2025By the date

Measured against the completion date given at registration; many projects had RERA extensions (including the COVID-period extension), shown under the date.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this

What’s changed since Aug 2021

As on 20 Oct 2026
  1. 13 Oct 2026Phase-III: Quarterly update filed for Q2 2026-27: 99% built, 6 of 13 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  2. 9 Jul 2026Phase-III: Quarterly update filed for Q1 2026-27: 98% built, 6 of 13 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  3. 20 Apr 2026Phase-III: Quarterly update filed for Q4 2025-26: 87% built, 5 of 13 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  4. 16 Jan 2026Phase-III: Quarterly update filed for Q3 2025-26: 80% built, 3 of 13 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  5. 1 Jul 2025Phase II: Promoter applied to RERA for completion (occupancy certificate on RERA) Source (rera.karnataka.gov.in) (opens in a new tab)
  6. 29 Apr 2025Phase-III: Registered with Karnataka RERA (PRM/KA/RERA/1251/308/PR/290425/007698); completion date 30 Jun 2027 Source (rera.karnataka.gov.in) (opens in a new tab)

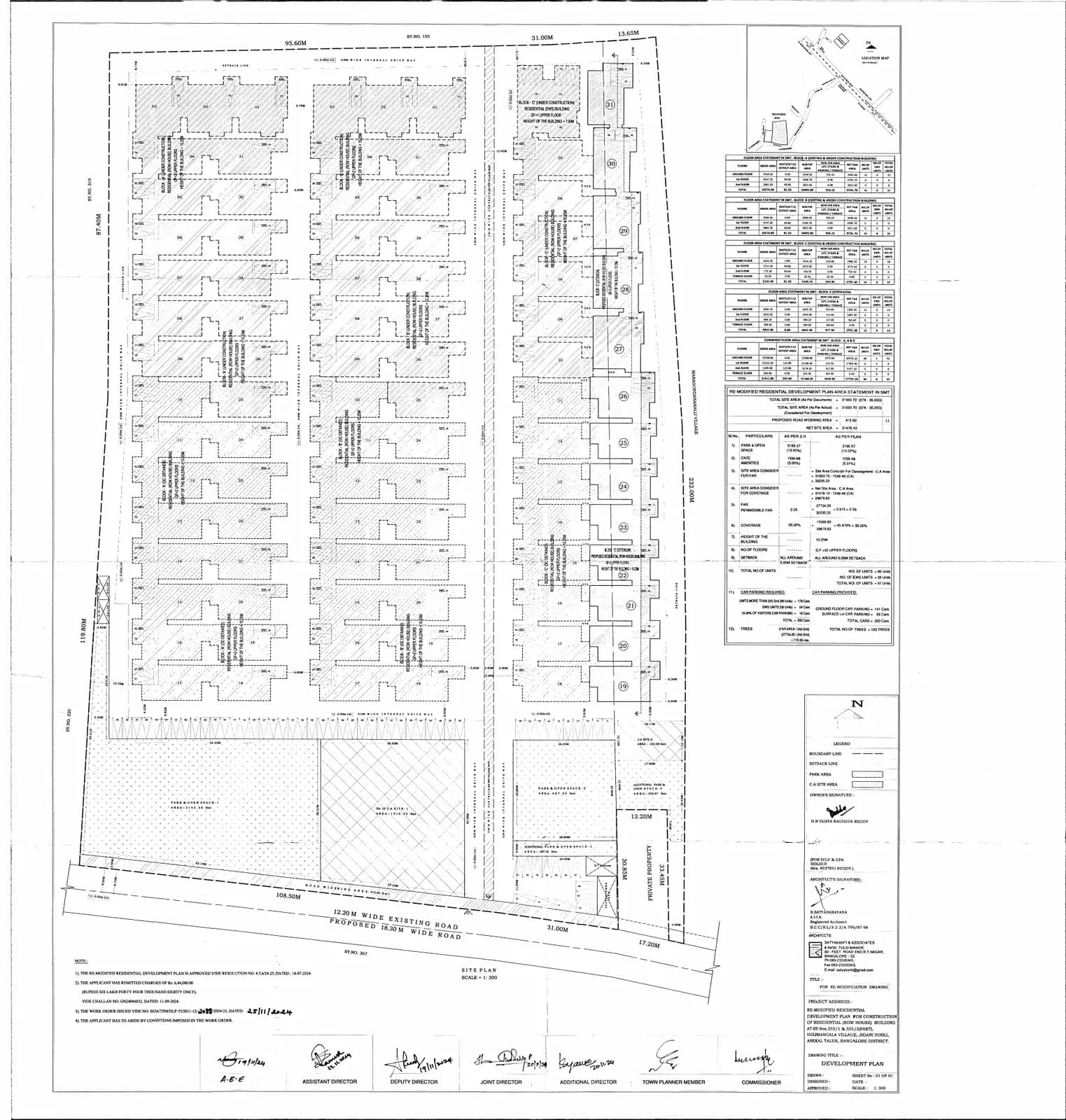

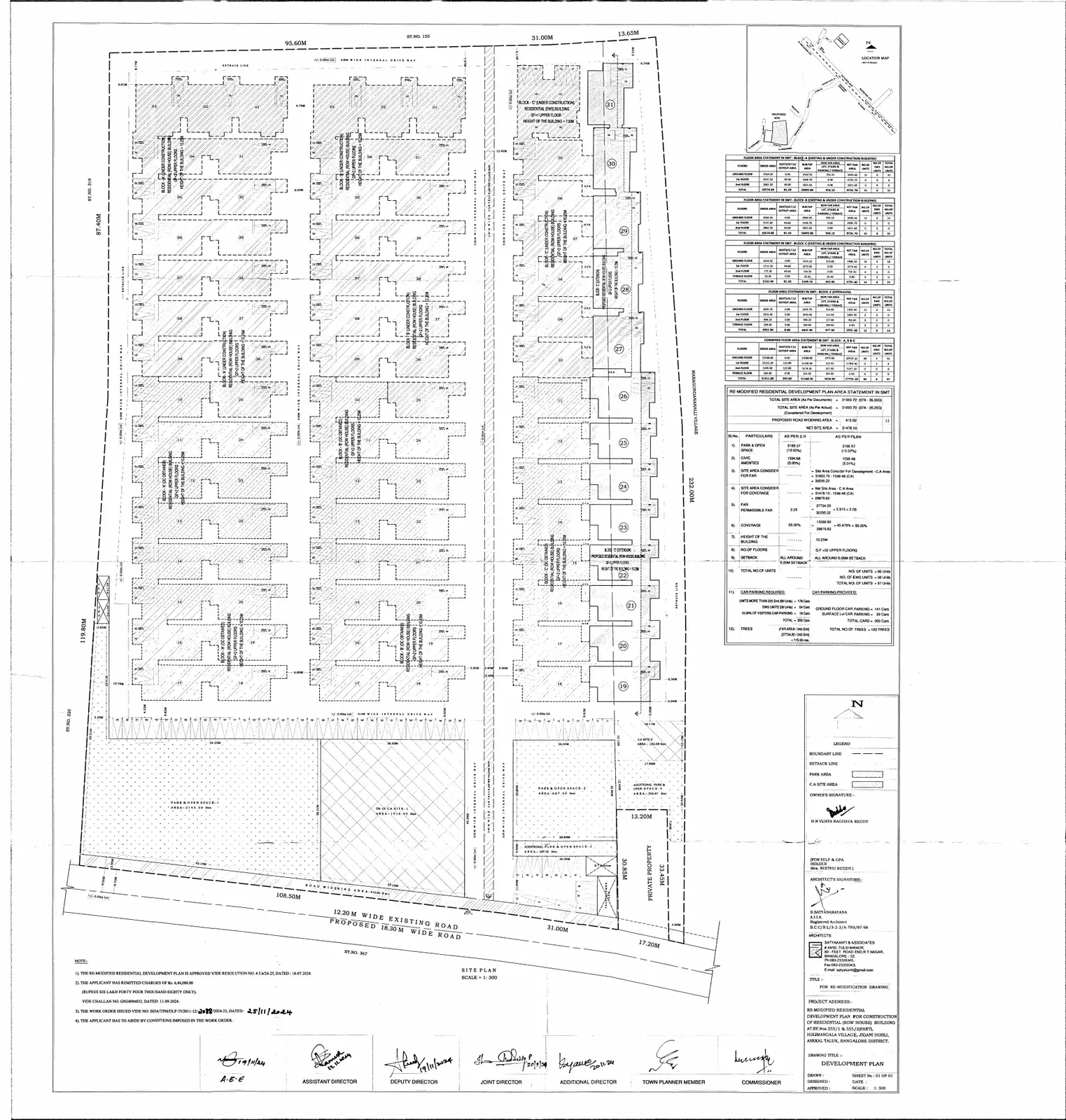

  7. 25 Nov 2024Phase-III: Building plan approved by BDA - Bangalore Development Authority (No. BDA/TPM/DLP-75/2011-12/2088/2024-25-DT:25.11.2024) Source (rera.karnataka.gov.in) (opens in a new tab)
  8. 25 Nov 2024Phase-III: Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
  9. 21 Dec 2022Phase II: Registered with Karnataka RERA (PRM/KA/RERA/1251/308/PR/211222/005548); completion date 31 Dec 2027 Source (rera.karnataka.gov.in) (opens in a new tab)
  10. 13 Sep 2021Phase II: Building plan approved by BDA - Bangalore Development Authority (No. NM/AS/AA03/TS02/S/05/2021-22) Source (rera.karnataka.gov.in) (opens in a new tab)
  11. 1 Aug 2021Phase II: Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)

Newest first. No extension of the completion date is recorded on RERA. When the RERA crawl sees a new filing, complaint or extension, it is added here with its date.

Home loan EMI calculator

No listed price found — enter one to try.

Example only — use your bank’s quote.

Monthly EMI
—
Down payment
—
Loan amount
—
Total interest
—

A calculation only, from the numbers you enter — not a loan offer.

All-in cost: GST, registration and other charges

The calculator loads when you scroll to it.

Assumptions
  • Base price: the builder’s price is not published in a form we could collect — enter it from the cost sheet.
  • GST 5% on the base price and charges — the usual rate for an under-construction home that is not “affordable housing” (1%).
  • Stamp duty about 5.6% and registration 2% — the Karnataka rule (registration was raised from 1% to 2% on 31 Aug 2025). Calculated on the agreement value.
  • Car parking, other charges and the maintenance deposit are not in the public record we collect; enter them from the builder’s cost sheet.
  • Loan on the agreement value (banks usually lend up to 75–90%); EMI is the standard reducing-balance formula. Example rate only — use your bank’s quote.

How we calculate this

VRR Golden Enclave FAQs

What is VRR Golden Enclave?

VRR Golden Enclave is a residential project in Hulimangala, Anekal, Bengaluru Urban with 97 homes developed by H N Vijayaraghava Reddy Co.

When will VRR Golden Enclave be completed?

Phase II completion is scheduled for 31 December 2027 and Phase III for 30 June 2027, as per the RERA records.

What types of homes are in VRR Golden Enclave?

The project has villas (46 units), rowhouses (13 units), 1 BHK apartments (8 units), and 3 BHK apartments (13 units).

What are the carpet areas in VRR Golden Enclave?

Villas range from 2,637 to 2,852 sq ft, 1 BHK apartments are 463 sq ft, rowhouses are 2,971 sq ft, and 3 BHK apartments range from 2,329 to 3,291 sq ft.

How many homes are booked in VRR Golden Enclave Phase III?

As of Q2 2026-27, 6 homes are booked out of 13 homes in the booking table for Phase III.

What is the construction progress of VRR Golden Enclave?

Phase III is 99% complete as of Q2 2026-27 (quarter ended 30 September 2026).

Are there any RERA complaints against VRR Golden Enclave?

There are no RERA complaints against this project.

What is the RERA registration number for VRR Golden Enclave?

Phase II is registered as PRM/KA/RERA/1251/308/PR/211222/005548 and Phase III as PRM/KA/RERA/1251/308/PR/290425/007698.

Where is VRR Golden Enclave located?

VRR Golden Enclave is in Hulimangala, Anekal taluk, Bengaluru Urban district, PIN code 560100.

Does the builder have other projects on record?

VRR Golden Enclave is the only project by H N Vijayaraghava Reddy Co in the Bengaluru RERA records, though the builder has 1 RERA complaint across all projects.

Written by AI from the RERA record above on 20 Oct 2026. Answers use only that record; check them against the source before you decide.

Questions about VRR Golden Enclave

No questions published yet. Ask the first one: you get an instant answer from this page’s public record, and our team follows up on anything the record does not show.

Bought a home from H N Vijayaraghava Reddy Co? Review the builder.

Reviews of H N Vijayaraghava Reddy Co by verified buyers

No verified reviews of H N Vijayaraghava Reddy Co yet. If you bought a home from them, your review helps other buyers.

How reviews work: only buyers and owners can review; we confirm each purchase by phone before publishing, publish positive and negative reviews alike, never accept payment for reviews, and the builder may reply.

Similar projects within 5 km

ProjectDistanceHomesPossession (RERA)BuiltComplaintsPrice
Srikara Urban ParkSrikara Structures0.2 km126Mar 2027extended91%0Not collected
Habulus Oasis GroveHabulus Homes Private Limited0.3 km296Mar 203120%0Not collected
Alchemy ElixirAratt City Towers LLP0.4 km349Sep 2026—1Not collected
Sidvin SymmetraSidvin Properties0.7 km328Aug 2031—0Not collected
Sreenidhi E-CitySreenidhi Developers0.7 km44Dec 2025100%0Not collected
M5 EchelonMahendra Homes Private Limited0.8 km795Dec 20317%0Not collected

Projects of the same kind within 5 km in a straight line of this project’s RERA map point, nearest first. % built is the promoter’s latest quarterly figure on RERA (shown for single-registration projects); prices are from the builder’s own website where we found one.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Sources and last checked dates

  1. Karnataka RERA — project register (search by the registration number) (opens in a new tab)

Collected on 20 Oct 2026 by AI research agents reading public pages. Facts are written in our own words. Not found yet: price; court cases; landmarks; specifications; news.

How to check on RERA: On rera.karnataka.gov.in/viewAllProjects, type the registration number in 'Registration No', press Search, then click the 'View Project Details' icon. Complaints open from the 'Complaints / Litigation' icon in the same row. Registration numbers: PRM/KA/RERA/1251/308/PR/211222/005548, PRM/KA/RERA/1251/308/PR/290425/007698.

  • RERA record last checked: 20 Oct 2026
  • Last change in the record (registration, quarterly filing or complaint): 20 Oct 2026

How this page is made: software builds it from public records (Karnataka RERA filings, OpenStreetMap, the builder’s own website). AI is used only to read filings into fields and to write the plain-English summary and FAQ answers, which are checked against the record. Facts are checked automatically against the RERA filing. Methodology · How we earn · Report an error
