Casagrand Zaiden
2 & 3 BHK apartments by Casa Grande Garden City Builders Pvt Ltd · Uttarahalli Manavarthakaval, near Kanakapura Road, Bengaluru
Uttarahalli Manavarthakaval, near Kanakapura Road, BengaluruOpen on Google Maps (opens in a new tab)
- Under construction
- RERA registered
- residential
by Casa Grande Garden City Builders Pvt Ltd
Price: Price on request

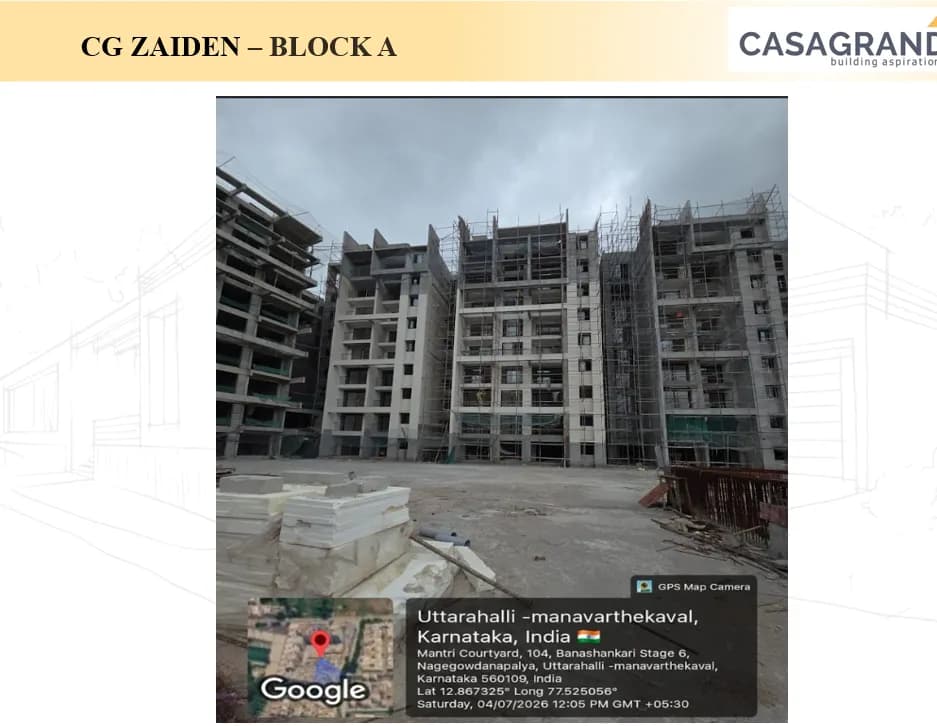

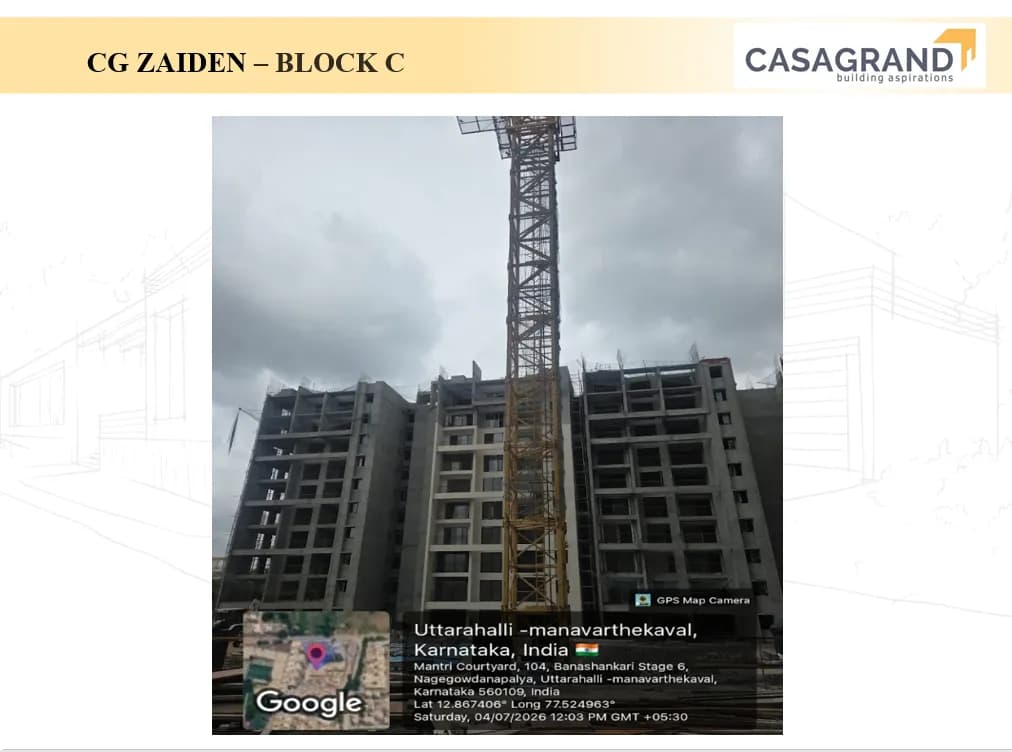

Site photo filed with Karnataka RERA Karnataka RERA filing · Source ↗ (opens in a new tab)
Casagrand Zaiden at a glance
- Possession (RERA)Mar 2027 ExtendedWas Mar 2026 · Karnataka RERA
- Construction70% built · on pace for Mar 2028 12 mo after RERA dateRERA filing to 30 Sep 2026; estimate from average pace
- Homes booked286 of 286 (100%)RERA update · as on 30 Sep 2026
- RERA complaints (project)5 complaintsKarnataka RERA · as on 22 Oct 2026
- Approvals filed5 of 9 on RERAKarnataka RERA uploads · 22 Oct 2026
- Nearest metroSilk Institute · 0.82 kmstraight line · OpenStreetMap, 5 Oct 2026
- Airport driveapprox. 169 min at peak41.8 km straight line · estimate
- Nearest lakeThalaghattapura Lake · 527 mFrom the RERA map point · OpenStreetMap, 5 Oct 2026
Project summary
Casagrand Zaiden is a residential project by Casa Grande Garden City Builders Pvt Ltd in Uttarahalli Manavarthakaval, Bengaluru with 286 homes, registered with Karnataka RERA. The completion date on RERA is 22 Mar 2027.
Facts collected on 22 Oct 2026 from public records — each linked to its source. Free for buyers. If you book through us, the builder pays us a commission.
Casagrand Zaiden buyers’ group: join to ask for a group price
No one has joined yet. Be one of the first 10 buyers in this group — the founding members.
Join free. When enough buyers have joined, our agent partner asks Casa Grande Garden City Builders Pvt Ltd for a group price — for example a lower price, an easier payment plan or waived charges. Nothing is promised: you see what the builder offers and book directly with the builder if you want to. Free for buyers. If you book through us, the builder pays us a commission.
- Gathering buyers
- Talking to the builder
- Group offer
- Group site visit
- Booking
0 buyers have joined · 0 committed
Committed buyers have confirmed their budget, home type and timeline with us on a call; builders negotiate with them. Joining is free and never obliges you to buy.
Join the Casagrand Zaiden buyers’ groupHow group buying works
See it for yourself
Visit the site with our team, or get a call to clear your questions. Free, no obligation.
Key facts: home types, towers, land and possession
- Home types
- 2 BHK, 3 BHK
- Carpet area
- 747 – 1,209 sq ft
- Towers
- 3
- Floors
- 9
- Total homes
- 286
- Land
- 3.69 acres
- Possession (extended)
- Mar 2027
- Built (RERA update)
- 70%
Casagrand Zaiden RERA number and registration details
- RERA number
- PRM/KA/RERA/1251/310/PR/120423/005862
- Registered on
- 12 Apr 2023
- Promised completion
- 22 Mar 2026
- Extended to
- 22 Mar 2027
- RERA status
- New launch
- Homes booked
- 286 of 286 as on
- Price
- Not found in public records yet: price
- Project type
- Residential
Towers and blocks (RERA filing)
| Tower | Floors | Basements | Homes |
|---|---|---|---|
| Tower A | 9 | 0 | 81 |
| Tower B | 9 | 1 | 95 |
| Tower C | 9 | 1 | 110 |
A dash (—) means the filing did not state that value.
Summary in plain English
Casagrand Zaiden is a residential project by Casa Grande Garden City Builders Pvt Ltd in Uttarahalli Manavarthakaval, Bengaluru South. It has 286 homes across 3 towers with completion expected on 22 March 2027.
Written by AI from the RERA record above on 22 Oct 2026. Every number in it was checked against that record; if anything differs, the record wins.
Open space, home loans, escrow and other details
- Open space
- 56.8% of land
- Water and power
- Water source filed with RERA: BWSSB
- Home loans: approved banks
- Not found in public records yet: bank approvals
- Payment plans
- Not found in public records yet: payment plans
- Maintenance
- Not found in public records yet: maintenance
- Car parking
- Not found in public records yet: car parking charge
- Escrow bank (RERA)
- ICICI Bank, Ulsoor Branch
- Building plan (RERA)
- BBMP - Bruhat Bengaluru Mahanagara Palike · No. PRJ/14724/22-23IN · dated 21 Mar 2023
- Project cost declared to RERA
- ₹161 Cr
Open area as a share of the land, from the areas filed with RERA (includes driveways and landscaped areas).
Amenities
- Electricity
- CCTV Surveillance
- Club House
- Community Hall
- Outdoor Sports facility
- Swimming Pool
- Gym
- Power Backup
- Water and Sanitation
Amenities and internal works as filed by the promoter with Karnataka RERA; we have not visited the site.
Casagrand Zaiden location and address
- Address
- SY.NO.59 (OLD SY.NO.7/9), KHATHA NO.237/1/7/9/7/18 at WARD NO.198 , UTTARAHALLI MANAVARTHAKAVAL VILLAGE , Bengaluru South , Bengaluru Urban, Karnataka - 560062
- Village (RERA)
- Uttarahalli Manavarthakaval
- Locality
- Near Kanakapura RoadAlso known as Kanakapura Main Road
- PIN code
- 560062
- City
- Bengaluru
- State
- Karnataka
- Coordinates
- 12.86769, 77.52543
Distances to landmarks
Not found in public records yet: landmarksAbout Uttarahalli Manavarthakaval
Not found in public records yet: locality factsCommute times to tech parks and the airport
| To | Straight line | Peak-hour drive (estimate) |
|---|---|---|
| KSR Bengaluru City railway station (Majestic)Map point on OpenStreetMap (opens in a new tab) | 13.18 km | approx. 53 min |
| Electronic City Phase 1Map point on OpenStreetMap (opens in a new tab) | 15.26 km | approx. 62 min |
| Outer Ring Road tech corridor (RMZ Ecospace, Bellandur)Map point on OpenStreetMap (opens in a new tab) | 18 km | approx. 73 min |
| Manyata Tech ParkMap point on OpenStreetMap (opens in a new tab) | 22.52 km | approx. 91 min |
| ITPL, Whitefield (main gate)Map point on OpenStreetMap (opens in a new tab) | 26.6 km | approx. 108 min |
| Kempegowda International AirportMap point on OpenStreetMap (opens in a new tab) | 41.8 km | approx. 169 min |
How we calculate
Straight line: from the project’s map point on RERA to the destination’s point on OpenStreetMap.
Peak-hour drive is a rough estimate, not a route: straight line × 1.35 for the road network, at 20 km/h. Real times vary a lot with the route and the hour.
Sources:Source (openstreetmap.org) (opens in a new tab)How we calculate this
Schools and hospitals nearby
Within 2 km
- 8Schools and colleges7 schools, 1 colleges, 0 kindergartens
- 3Hospitals and clinics0 hospitals, 3 clinics
Nearest schools and colleges
- Jnana Sweekar Public School · 0.88 km
- Deeksha PU College · 0.92 km
- NGS Madrasa Ashraful Banat · 1.22 km
Nearest hospitals and clinics
- Central Ayurveda Research Institute · 1.22 km
- Apollo Clinic · 1.7 km
- GS Family Clinic · 1.91 km
Places as mapped on OpenStreetMap (amenity=school, college, kindergarten, university; hospital, clinic), counted within 2 km in a straight line of the RERA map point. Volunteers map these, so some places may be missing or closed. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Nearest metro station and railway
- Silk Institute (ರೇಷ್ಮೆ ಸಂಸ್ಥೆ)Open now — nearest operating metro station0.82 km
- Kengeri (ಕೆಂಗೇರಿ)Nearest railway station7.16 km
Straight-line distances from the RERA map point to the station points mapped on OpenStreetMap; status (open or under construction) as tagged there. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Lake and lake-buffer check
The nearest mapped lake is Thalaghattapura Lake, 527 m from the project’s RERA map point.
The site boundary is not published as a shape, so its nearest edge can be closer than this point. Whether any building sits inside a lake buffer can only be checked on the approved plan.
- Thalaghattapura Lake on OpenStreetMap (opens in a new tab) (ತಲಘಟ್ಟಪುರ ಕೆರೆ)527 m
- Lingadeeranahalli Lake on OpenStreetMap (opens in a new tab) 1,255 m
- Jogi Kere on OpenStreetMap (opens in a new tab) (ಜೋಗಿ ಕೆರೆ)1,441 m
The buffer rule
Bengaluru’s lake buffer rule has changed over time: the National Green Tribunal ordered a 75 m buffer in May 2016; the Supreme Court set that order aside on 5 March 2019, leaving the 30 m buffer of the Revised Master Plan 2015. Check the current rule and the approved plan before relying on either number.
- LiveLaw: SC sets aside NGT order enlarging buffer zones (2019) (livelaw.in) (opens in a new tab)
- Citizen Matters: Shrinking lake buffers (citizenmatters.in) (opens in a new tab)
Shortest distance from the RERA map point to the mapped water edge (OpenStreetMap water polygons tagged lake or reservoir, or named lake/kere/tank). Mapped shorelines can differ from the revenue-record boundary of a lake. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Sources:Source (openstreetmap.org) (opens in a new tab)Source (livelaw.in) (opens in a new tab)Source (citizenmatters.in) (opens in a new tab)How we calculate this
Satellite time-lapse of the site
Satellite photos load when you scroll to them.
Photos from Esri World Imagery Wayback, centred on the project’s map point; dates are the capture dates in Esri’s metadata. Loaded from Esri when you scroll here.
Sources:Source (livingatlas.arcgis.com) (opens in a new tab)
Casagrand Zaiden floor plans, brochure and elevations
Documents the builder uploaded to Karnataka RERA, shown as filed. Tap a page to see it full size; the full PDF opens on the RERA website.

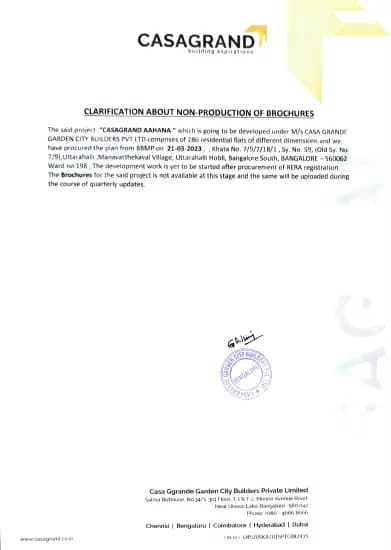

Brochure

BrochureFull PDF on RERA
Approved building plan2 files

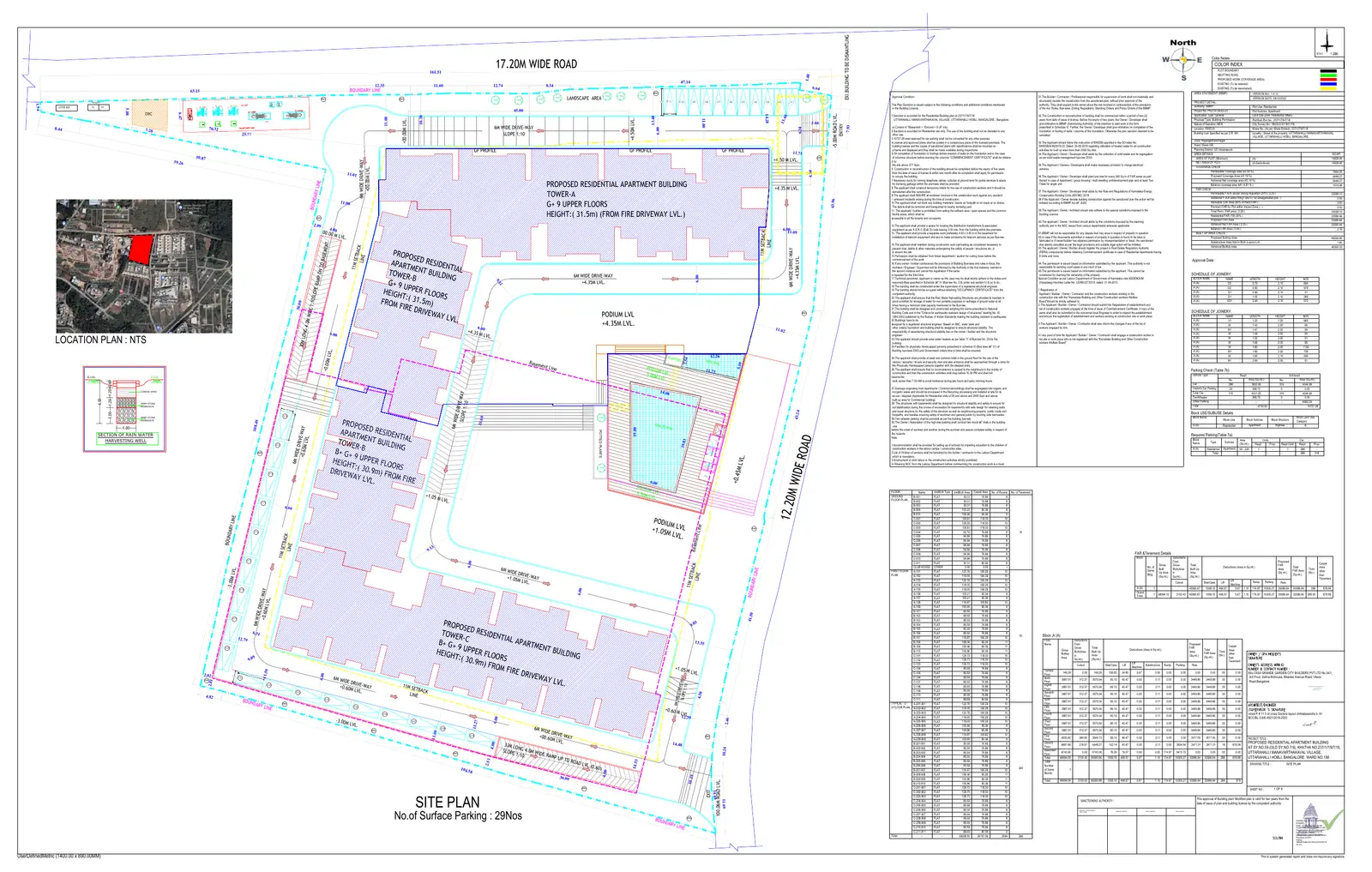

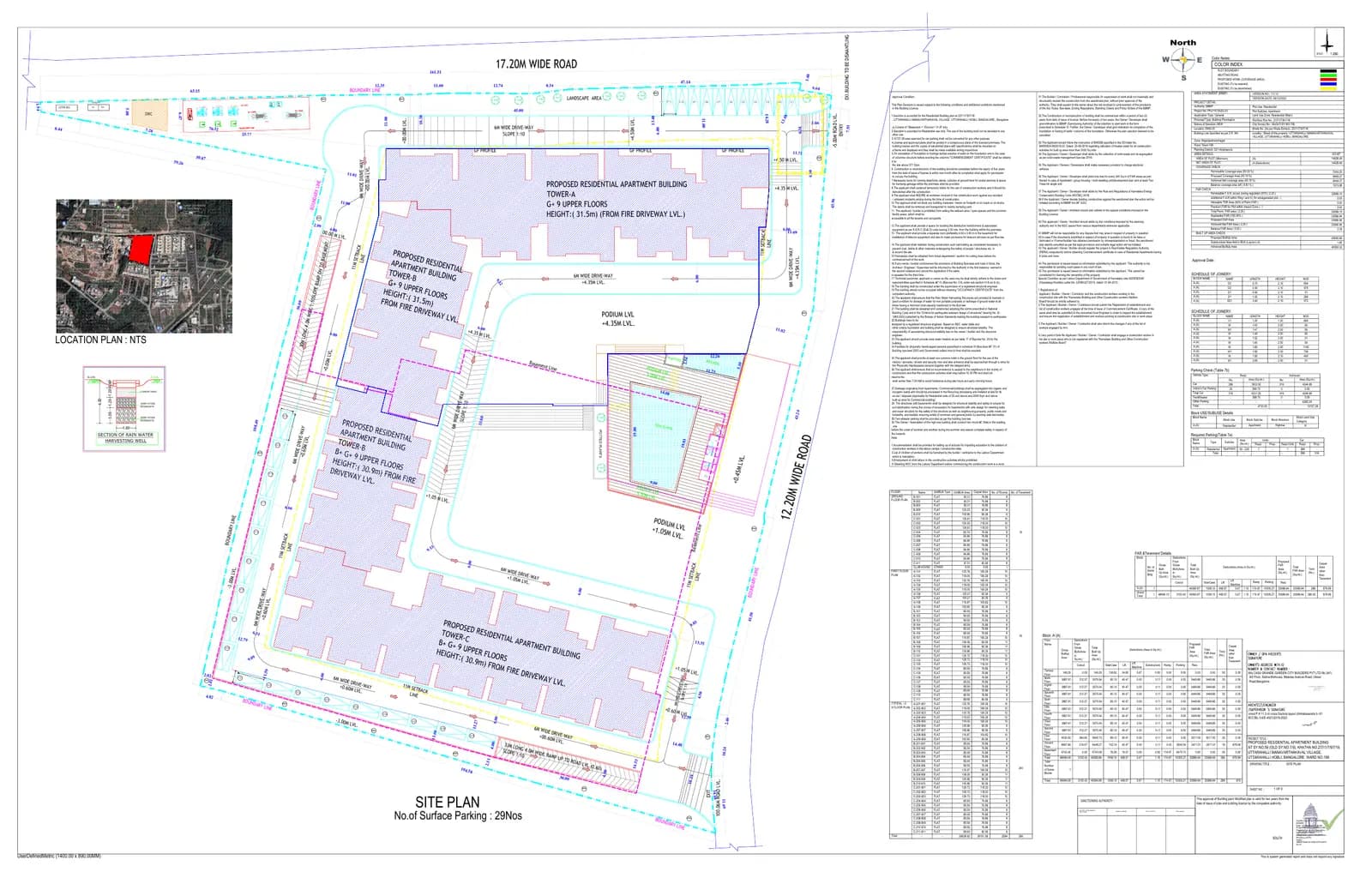

5 BBMP Approved PlanFiled 11 Apr 2023 · Full PDF on RERA

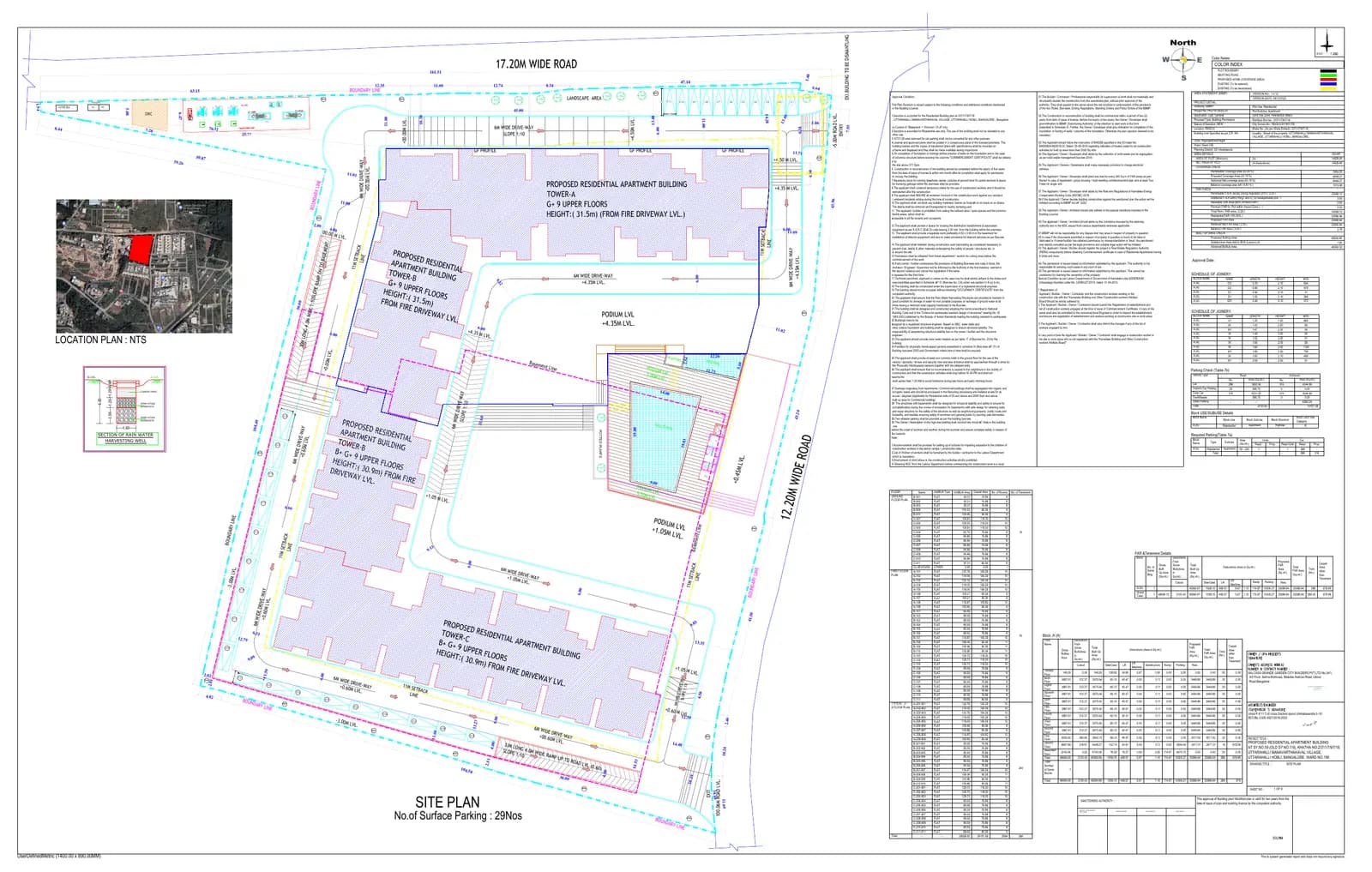

Zaiden Approved Building PlanFiled 16 Jul 2026 · Full PDF on RERA

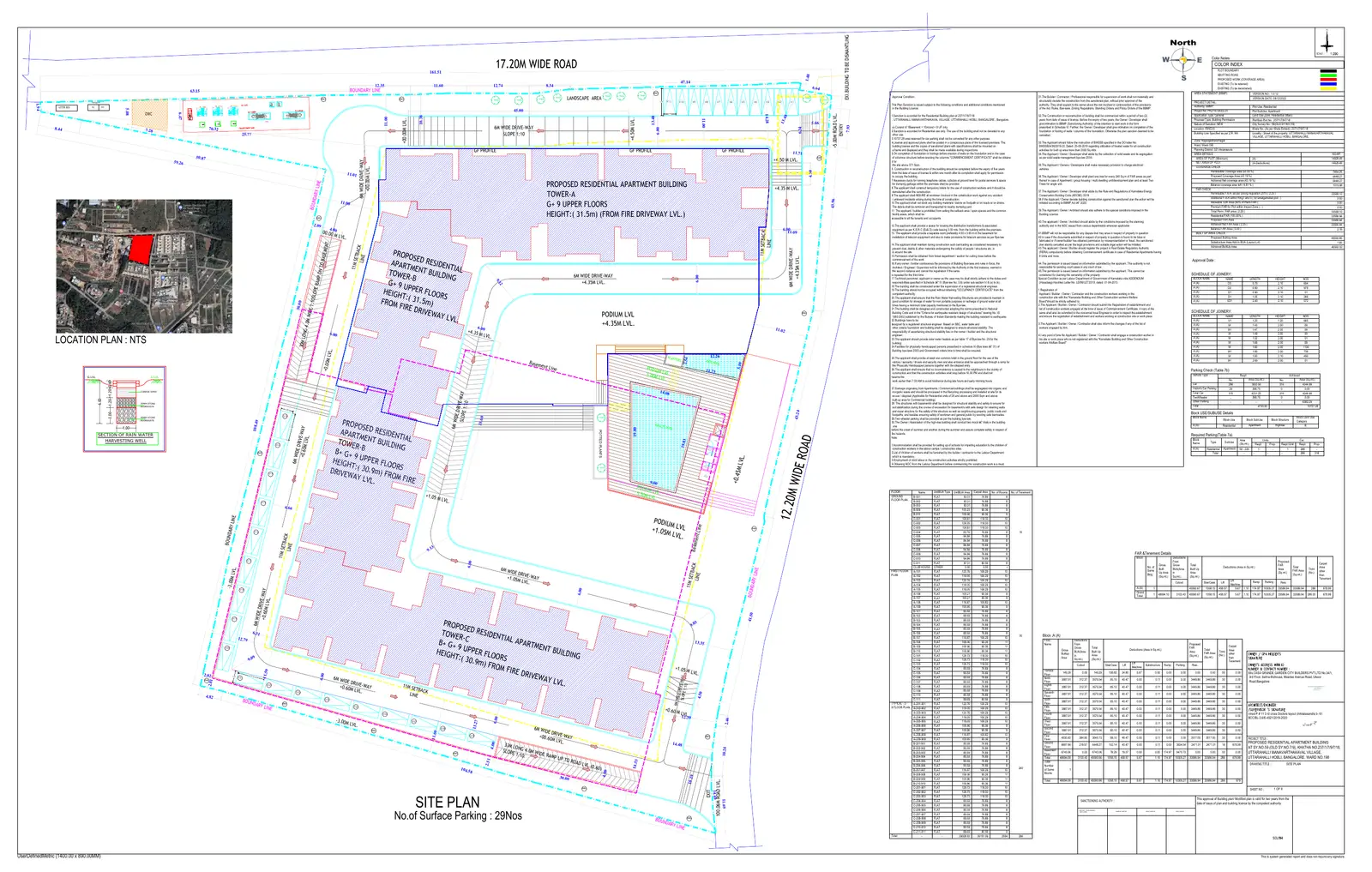

Approved layout plan3 files

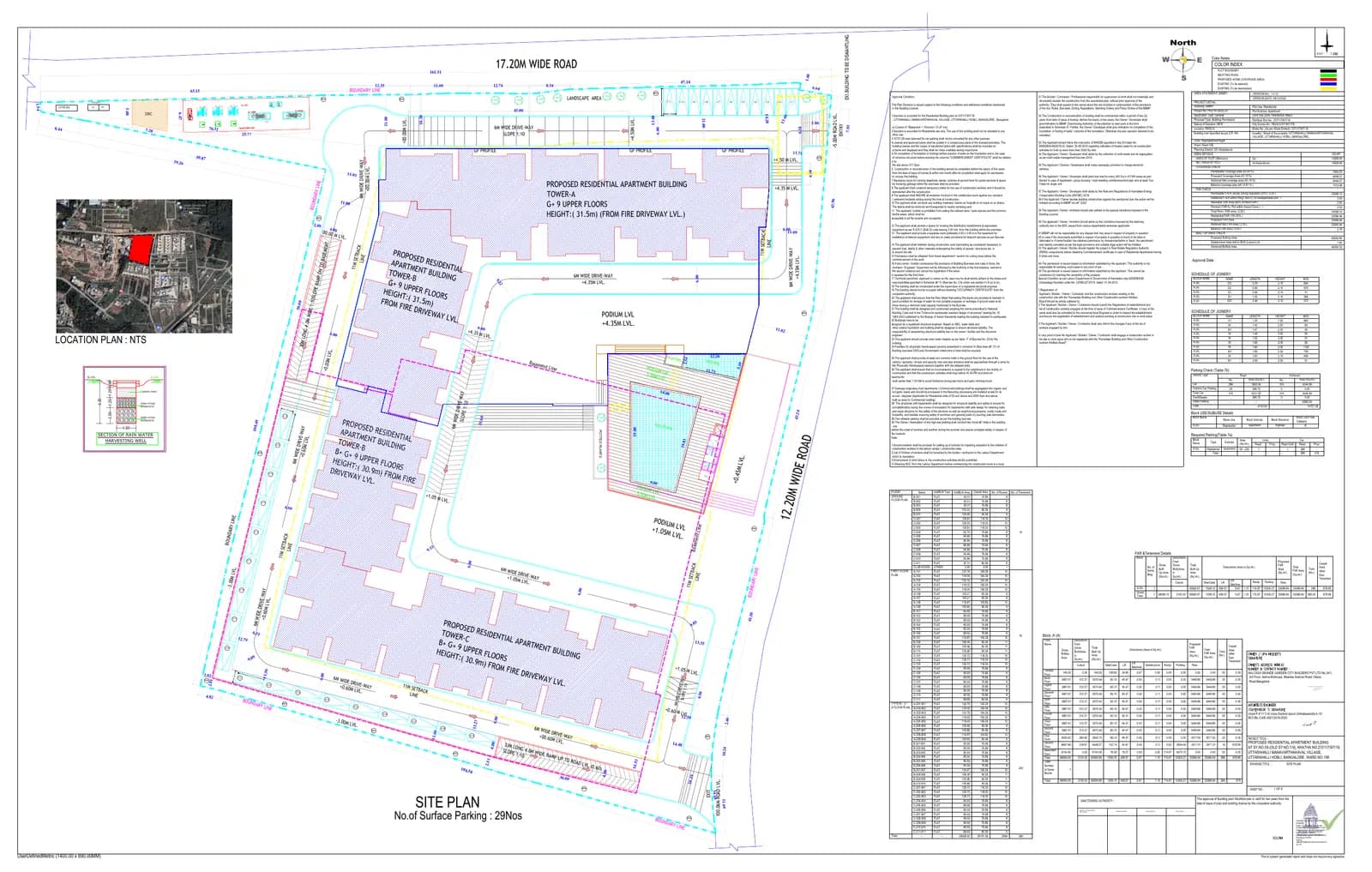

Approved Layout PlanFull PDF on RERA
Existing Layout PlanFull PDF on RERA

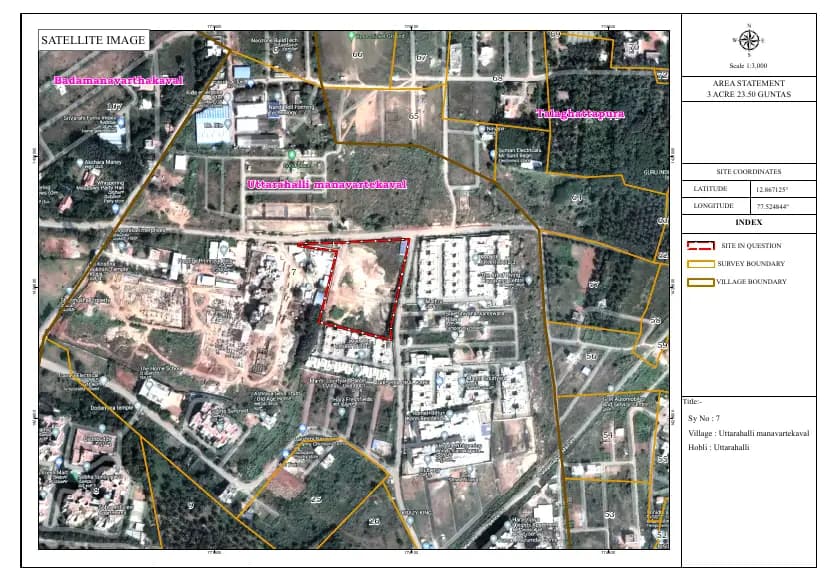

Location Demarcation.pdfFull PDF on RERA
| Home type | Carpet area | Homes |
|---|---|---|
| 2 BHK + 2t | 747 – 779 sq ft | 137 |
| 3 BHK + 2t | 946 – 947 sq ft | 56 |
| 3 BHK + 3t | 1,052 – 1,209 sq ft | 93 |
Home types, counts and carpet areas as filed with Karnataka RERA (carpet area, not super built-up).
We have not collected floor-plan drawings; the builder’s sales team can share them.

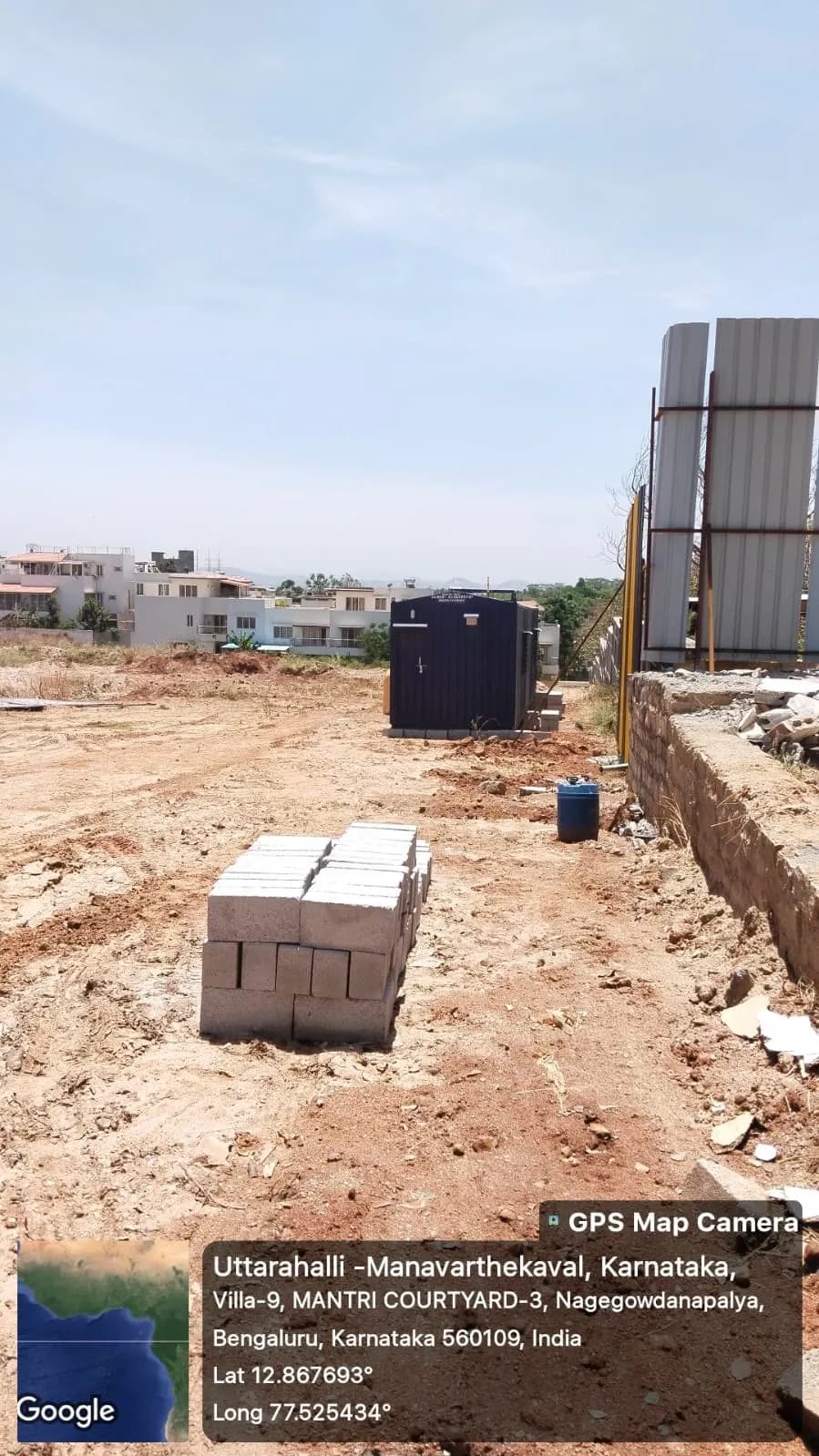

Casagrand Zaiden possession date and construction status
Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-14.
By tower (Q2 2026-27)
Units sold and unsold, from RERA (Q2 2026-27)
| Type | Homes | Booked | Available |
|---|---|---|---|
| 3 BHK + 2T | 56 | 56 | 0 |
| 3 BHK + 3T | 93 | 93 | 0 |
| 2 BHK + 2T | 137 | 137 | 0 |
As reported by the promoter in the quarterly update to RERA, not verified by us.
Timeline
- 7 Apr 2023Project start date given to RERA
- 12 Apr 2023Registered with Karnataka RERA
- 22 Mar 2026Completion date given at registration
- 22 Mar 2027Section 6 Extension: completion date moved to this date
Construction pace from RERA quarterly filings
At the average pace so far, construction would reach 100% around Mar 2028 — about 12 months after the completion date on RERA (22 Mar 2027).
At the pace between the 4 quarterly filings we have (55% → 70% in 9 months), it would be around Mar 2028 — about 12 months after the RERA date.
- Filed on RERA
- Average pace since start
- Pace between filings (and 0% assumed at the start date)
- RERA completion date
Quarterly filings
| Quarter | Filed on | Built | Homes booked |
|---|---|---|---|
| Q2 2026-27to 30 Sep 2026 | 14 Oct 2026 | 70% | 286 of 286 |
| Q1 2026-27to 30 Jun 2026 | 10 Jul 2026 | 65% | 286 of 286 |
| Q4 2025-26to 31 Mar 2026 | 11 Apr 2026 | 60% | 266 of 286 |
| Q3 2025-26to 31 Dec 2025 | 13 Jan 2026 | 55% | 266 of 286 |
How we calculate
Average pace = % built ÷ months since the start date in the RERA record. Here: 70% ÷ 41.8 months (7 Apr 2023 to 30 Sep 2026) = 1.7% a month.
Estimated finish = latest filing date + (100 − % built) ÷ pace = 30 Sep 2026 + 30 ÷ 1.7 = 17.9 months → Mar 2028. This is an estimate, not a date from the builder or RERA.
Pace between filings = (70% − 55%) ÷ 9 months = 1.7% a month.
A straight line is a simplification: the builder reports one overall %, which mixes excavation, structure and finishing, and work rarely moves at a constant speed. The % values are the promoter’s own figures filed with RERA, not checked by us. Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-14.
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
Approvals and documents checklist
14 rows: approvals. Scroll inside the table to see them all.
| Approval | Authority | Source |
|---|---|---|
| Building plan | BBMP - Bruhat Bengaluru Mahanagara Palike · No. PRJ/14724/22-23IN · dated 2023-03-21 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Land conversion | DC Bengaluru · No. BDS.ALN:SR(S):238/2002-03 · dated 2002-12-13 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Commencement Certificate | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Electricity Permission Letter | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Water Permission Letter | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Layout Plan | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Building/Plotting Plan | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Section Of Building/Infrastructure Plan of Plotting | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Change of Land Use | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| District Magistrate | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Conversion Certificate under section 95 of the KLR Act 1964 | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| ESCOM/Electricity | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KWSSB/Water | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Fire Force Department | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
Documents uploaded to RERA
- Building or layout plan · Approved drawings from the planning authorityFiled on RERA ✓ — BBMP - Bruhat Bengaluru Mahanagara Palike · No. PRJ/14724/22-23IN · dated 21 Mar 2023
- Commencement certificate · Permission to start buildingFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Environment clearance · SEIAA KarnatakaNot on RERA yet
- Fire NOC · Karnataka Fire and Emergency ServicesFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Pollution board consent · KSPCBNot on RERA yet
- Water and sewerage · BWSSBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Electricity · BESCOMFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Height clearance · Airports Authority of IndiaNot on RERA yet
- Occupancy certificate (OC) · Issued only when the building is finishedNot on RERA yet — expected at completion
From the documents the promoter uploaded to Karnataka RERA, collected 22 Oct 2026. “Filed” means a document is on RERA — we have not checked its contents or validity. Not every approval applies to every project (for example, smaller projects may not need an environment clearance). The project page on RERA lists each upload.
Casagrand Zaiden RERA complaints and orders
5 complaints as on Source (rera.karnataka.gov.in) (opens in a new tab)
| Complaint ref | Filed | Subject | Status | Source |
|---|---|---|---|---|
| 00871/2026 | 27 Jul 2026 | Delay in Project Completion and Interest on Delay Period. | Under enquiry | Source (rera.karnataka.gov.in) (opens in a new tab) |
| 00431/2026 | 22 Apr 2026 | Delay in Project and insufficient reporting to the Purchasers | Posted for orders | Source (rera.karnataka.gov.in) (opens in a new tab) |
| 01351/2024 | 24 Dec 2024 | Cancellation of allotment and refund of the entire amount paid by the Complainants | Disposed | Source (rera.karnataka.gov.in) (opens in a new tab) |
| 01863/2023 | 21 Dec 2023 | Refund of Booking Amount | Disposed | Source (rera.karnataka.gov.in) (opens in a new tab) |
| 01808/2023 | 8 Dec 2023 | Refund for cancellation on booking the property | Disposed | Source (rera.karnataka.gov.in) (opens in a new tab) |
Court and consumer cases
We list case numbers, courts and outcomes only — never names of private individuals.
About Casa Grande Garden City Builders Pvt Ltd
- Promoter type
- Company
- Projects on this site
- 13
- RERA complaints against promoter
- 168
- Company number (CIN)
- U45205KA2015PTC082415
From Karnataka RERA, as collected so far (22 Oct 2026). Complaints are those RERA lists against this promoter across all its projects.
Casa Grande Garden City Builders Pvt Ltd’s RERA recordCasa Grande Garden City Builders Pvt Ltd delivery record
- 13Projects in Bengaluru on RERA13 approved registrations under Casa Grande Garden City Builders Pvt Ltd in Bengaluru Urban and Rural. Source (rera.karnataka.gov.in) (opens in a new tab)
- 5,190Homes registeredAs stated in each registrations.
- 168RERA complaints30 open, 138 disposed. as on Source (rera.karnataka.gov.in) (opens in a new tab)
- 32.4Complaints per 1,000 homes168 complaints ÷ 5,190 homes in its 13 registrations on Karnataka RERA in Bengaluru.
What the complaints are about
168 complaint subjects as written on RERA, as on . Each subject is sorted into one group by keywords (first match wins: delay, refund, registration, quality, litigation, association); one complaint often raises several issues. Source (rera.karnataka.gov.in) (opens in a new tab)
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
What’s changed since Mar 2023
- 22 Mar 2027Completion date extended to 22 Mar 2027 Source (rera.karnataka.gov.in) (opens in a new tab)
- 14 Oct 2026Quarterly update filed for Q2 2026-27: 70% built, 286 of 286 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 27 Jul 2026Complaint 00871/2026 filed with RERA: “Delay in Project Completion and Interest on Delay Period.” — now under enquiry Source (rera.karnataka.gov.in) (opens in a new tab)
- 10 Jul 2026Quarterly update filed for Q1 2026-27: 65% built, 286 of 286 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 22 Apr 2026Complaint 00431/2026 filed with RERA: “Delay in Project and insufficient reporting to the Purchasers” — now posted for orders Source (rera.karnataka.gov.in) (opens in a new tab)
- 11 Apr 2026Quarterly update filed for Q4 2025-26: 60% built, 266 of 286 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 13 Jan 2026Quarterly update filed for Q3 2025-26: 55% built, 266 of 286 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 24 Dec 2024Complaint 01351/2024 filed with RERA: “Cancellation of allotment and refund of the entire amount paid by the Complainants” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 21 Dec 2023Complaint 01863/2023 filed with RERA: “Refund of Booking Amount” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 8 Dec 2023Complaint 01808/2023 filed with RERA: “Refund for cancellation on booking the property” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 12 Apr 2023Registered with Karnataka RERA (PRM/KA/RERA/1251/310/PR/120423/005862); completion date 22 Mar 2026 Source (rera.karnataka.gov.in) (opens in a new tab)
- 7 Apr 2023Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
- 21 Mar 2023Building plan approved by BBMP - Bruhat Bengaluru Mahanagara Palike (No. PRJ/14724/22-23IN) Source (rera.karnataka.gov.in) (opens in a new tab)
Newest first. When the RERA crawl sees a new filing, complaint or extension, it is added here with its date.
Home loan EMI calculator
- Monthly EMI
- —
- Down payment
- —
- Loan amount
- —
- Total interest
- —
A calculation only, from the numbers you enter — not a loan offer.
All-in cost: GST, registration and other charges
The calculator loads when you scroll to it.
Assumptions
- Base price: the builder’s price is not published in a form we could collect — enter it from the cost sheet.
- GST 5% on the base price and charges — the usual rate for an under-construction home that is not “affordable housing” (1%).
- Stamp duty about 5.6% and registration 2% — the Karnataka rule (registration was raised from 1% to 2% on 31 Aug 2025). Calculated on the agreement value.
- Car parking, other charges and the maintenance deposit are not in the public record we collect; enter them from the builder’s cost sheet.
- Loan on the agreement value (banks usually lend up to 75–90%); EMI is the standard reducing-balance formula. Example rate only — use your bank’s quote.
Casagrand Zaiden FAQs
When will Casagrand Zaiden be completed?
The completion date on RERA is 22 March 2027. This date was extended under Section 6 Extension from the original registration date of 22 March 2026.
How many homes are in Casagrand Zaiden?
There are 286 homes in the project across 3 towers, with a maximum of 9 floors.
What home types are available in Casagrand Zaiden?
The project offers 2 BHK + 2T (137 homes, carpet area 747-779 sq ft), 3 BHK + 2T (56 homes, carpet area 946-947 sq ft), and 3 BHK + 3T (93 homes, carpet area 1,052-1,209 sq ft).
What is the RERA registration number for Casagrand Zaiden?
The RERA registration number is PRM/KA/RERA/1251/310/PR/120423/005862, registered on 12 April 2023.
Where is Casagrand Zaiden located?
The project is in Uttarahalli Manavarthakaval, Bengaluru South taluk, Bengaluru Urban district, PIN code 560062.
How much of Casagrand Zaiden is complete?
As of Q2 2026-27 (quarter ended 30 September 2026), the project is 70% complete.
How many homes are booked in Casagrand Zaiden?
As of Q2 2026-27, all 286 homes are booked.
Are there any RERA complaints on Casagrand Zaiden?
There are 5 complaints on RERA against this project.
Who is the builder of Casagrand Zaiden?
Casa Grande Garden City Builders Pvt Ltd is the builder. The builder has 168 complaints across all projects and 18 projects recorded in the Bengaluru RERA register.
What is the escrow bank for Casagrand Zaiden?
ICICI Bank is the escrow bank for this project.
Written by AI from the RERA record above on 22 Oct 2026. Answers use only that record; check them against the source before you decide.
Questions about Casagrand Zaiden
No questions published yet. Ask the first one: you get an instant answer from this page’s public record, and our team follows up on anything the record does not show.
Bought a home from Casa Grande Garden City Builders Pvt Ltd? Review the builder.
Reviews of Casa Grande Garden City Builders Pvt Ltd by verified buyers
No verified reviews of Casa Grande Garden City Builders Pvt Ltd yet. If you bought a home from them, your review helps other buyers.
How reviews work: only buyers and owners can review; we confirm each purchase by phone before publishing, publish positive and negative reviews alike, never accept payment for reviews, and the builder may reply.
Similar projects within 5 km
| Project | Distance | Homes | Possession (RERA) | Built | Complaints | Price |
|---|---|---|---|---|---|---|
| Jhanavi Trishul AlaskaJhanavi Heights Trishul LLP | 0.8 km | 148 | Sep 2028 | 40% | 0 | Not collected |
| Vanshika'S Nature'S HarmonyVanshika Life Spaces Private Limited | 0.9 km | 335 | Dec 2028 | 36% | 0 | Not collected |
| TG HeritageT G Developers | 1.8 km | 84 | Dec 2027 | 100% | 0 | Not collected |
| Provident Park Square 5Puravankara Limited | 1.9 km | 185 | Jun 2026extended | 91% | 2 | Not collected |
| Zest at Godrej EternityGodrej Home Constructions Private Limited | 1.9 km | 180 | Jul 2024extended | — | 4 | Not collected |
| Salarpuria Sattva Misty CharmSattva Resi Private Limited | 2.1 km | 1,339 | Oct 2024extended | — | 1 | Not collected |
Projects of the same kind within 5 km in a straight line of this project’s RERA map point, nearest first. % built is the promoter’s latest quarterly figure on RERA (shown for single-registration projects); prices are from the builder’s own website where we found one.
Sources and last checked dates
Collected on 22 Oct 2026 by AI research agents reading public pages. Facts are written in our own words. Not found yet: price; court cases; landmarks; specifications; news.
How to check on RERA: On rera.karnataka.gov.in/viewAllProjects, type the registration number in 'Registration No', press Search, then click the 'View Project Details' icon. Complaints open from the 'Complaints / Litigation' icon in the same row. Registration number: PRM/KA/RERA/1251/310/PR/120423/005862.
- RERA record last checked: 22 Oct 2026
- Last change in the record (registration, quarterly filing or complaint): 22 Oct 2026
How this page is made: software builds it from public records (Karnataka RERA filings, OpenStreetMap, the builder’s own website). AI is used only to read filings into fields and to write the plain-English summary and FAQ answers, which are checked against the record. Facts are checked automatically against the RERA filing. Methodology · How we earn · Report an error
More new projects nearby
Thalaghattapura, Kanakapura RoadUnder constructionRERA registeredBuyers’ group openJhanavi Trishul Alaska
by Jhanavi Heights Trishul
Price: Price on requestGet brochure & price →
- 3 BHK
- 898 – 1,333 sq ft
- Sep 2028
148 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Jhanavi Trishul Alaska
Uttarahalli Manavarthekaval, near Kanakapura RoadUnder constructionRERA registeredBuyers’ group openVanshika'S Nature'S Harmony
by Vanshika Life Spaces
Price: Price on requestGet brochure & price →
- 3 BHK, 4 BHK
- 959 – 2,152 sq ft
- Dec 2028
335 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Vanshika'S Nature'S Harmony
Mallasandra, Kanakapura RoadUnder constructionRERA registeredBuyers’ group openTG Heritage
by T G Developers
Price: Price on requestGet brochure & price →
- 1 BHK, 2 BHK, 3 BHK
- 489 – 971 sq ft
- Dec 2027
84 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for TG Heritage
