Earthsong by Manyata
30×50, 40×50 +6 more plots by Manyata Developers Pvt Ltd · Illthore, near Bellary Road (Airport Road), Bengaluru
Illthore, near Bellary Road (Airport Road), BengaluruOpen on Google Maps (opens in a new tab)
- Under construction
- RERA registered
- plotted
Price: Price on request

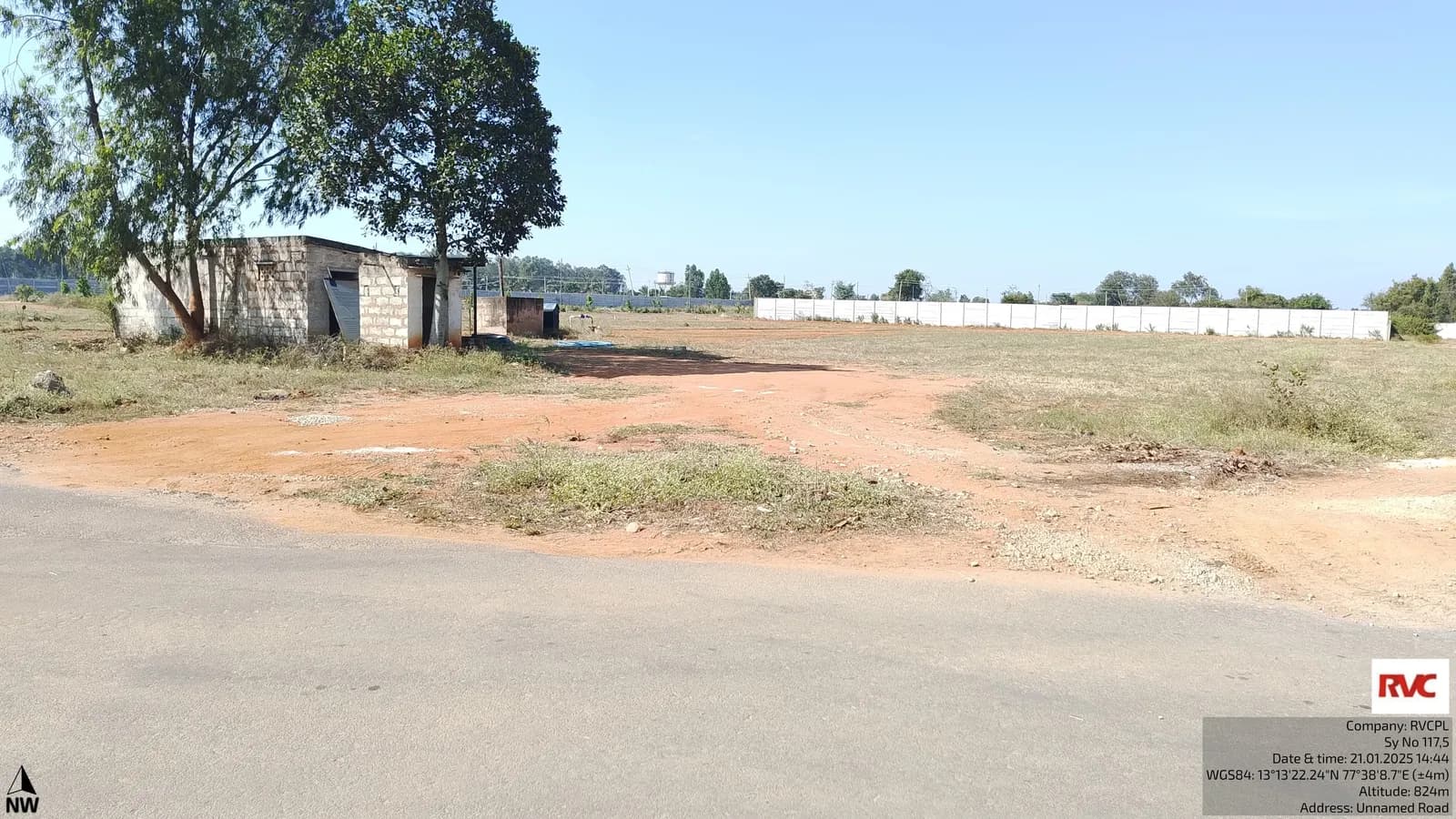

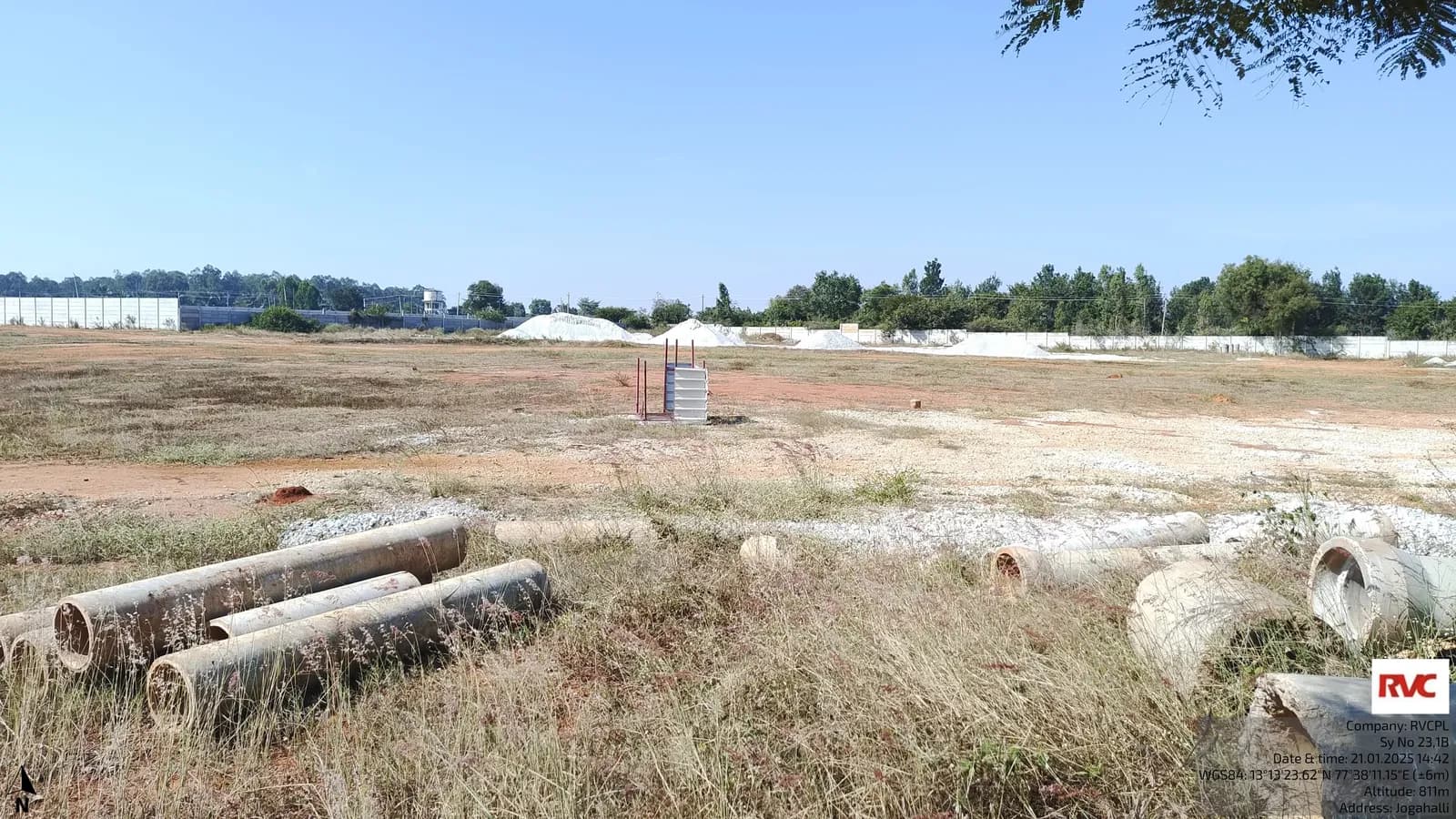

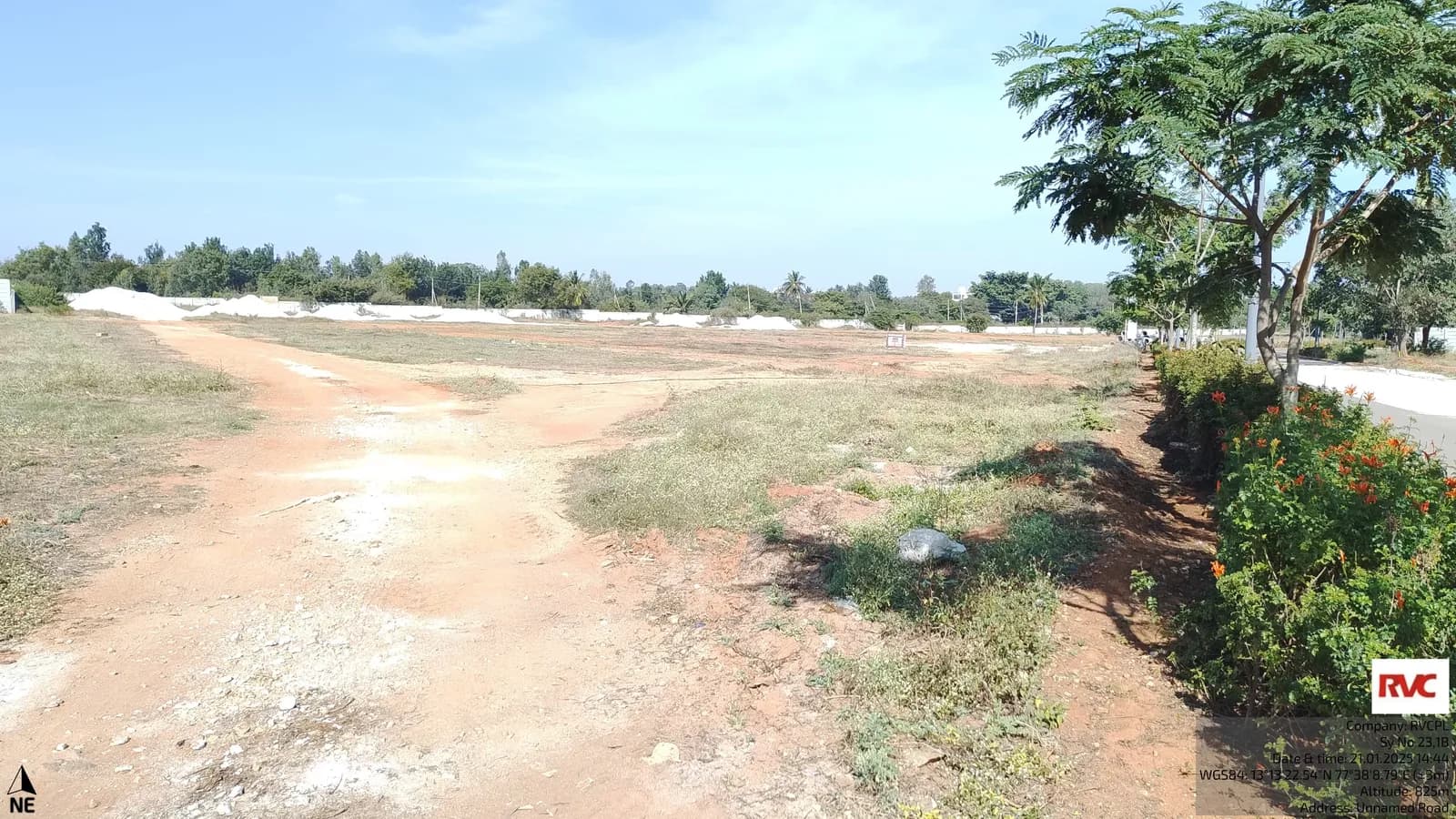

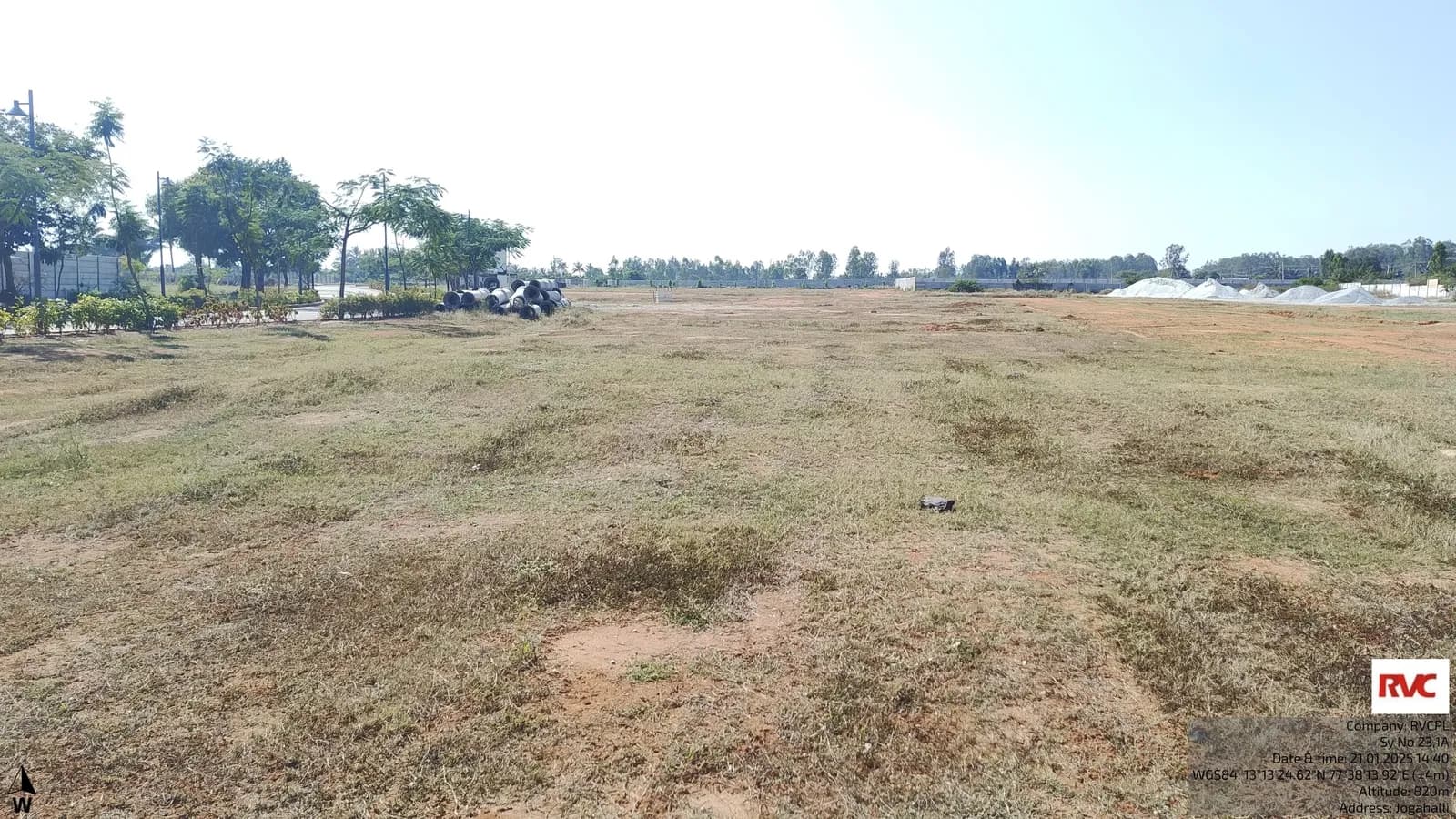

Site photo filed with Karnataka RERA Karnataka RERA filing · Source ↗ (opens in a new tab)
Earthsong by Manyata at a glance
- Completion (RERA)Sep 2022 Date passedWas Dec 2026 · Karnataka RERA
- Construction63% built · on pace for Aug 2027 8 mo after RERA dateRERA filing to 30 Sep 2026 (Phase-5b); estimate from average pace
- RERA complaints (project)None listedKarnataka RERA · as on 17 Oct 2026
- Approvals filed4 of 9 on RERAKarnataka RERA uploads · 4 Oct 2026
- Nearest metroDoddajala · 3.8 km (under construction)Open now: Peenya, 23.44 km · straight line · OpenStreetMap, 5 Oct 2026
- Airport driveapprox. 33 min at peak8.1 km straight line · estimate
- Nearest lakeUnnamed lake · 201 mFrom the RERA map point · OpenStreetMap, 5 Oct 2026
Project summary
Earthsong by Manyata is a plotted development by Manyata Developers Pvt Ltd in Illthore, Bengaluru, registered with Karnataka RERA. The completion date on RERA is 30 Sep 2022. It is registered in 7 phases.
Not in the RERA record we collected yet: number of plots. This page fills in as the record is collected.
Facts collected on 17 Oct 2026 from public records — each linked to its source. Free for buyers. If you book through us, the developer pays us a commission.
Earthsong by Manyata buyers’ group: join to ask for a group price
No one has joined yet. Be one of the first 10 buyers in this group — the founding members.
Join free. When enough buyers have joined, our agent partner asks Manyata Developers Pvt Ltd for a group price — for example a lower price, an easier payment plan or waived charges. Nothing is promised: you see what the developer offers and book directly with the developer if you want to. Free for buyers. If you book through us, the developer pays us a commission.
- Gathering buyers
- Talking to the developer
- Group offer
- Group site visit
- Booking
0 buyers have joined · 0 committed
Committed buyers have confirmed their budget, plot size and timeline with us on a call; developers negotiate with them. Joining is free and never obliges you to buy.
Join the Earthsong by Manyata buyers’ groupHow group buying works
See it for yourself
Visit the site with our team, or get a call to clear your questions. Free, no obligation.
Key facts: plot sizes, approval, land and completion
- Plot sizes (feet)
- 30×50, 40×50, 40×60, 50×50 +4 more
- Plot area
- 935 – 82,682 sq ft
- Total plots
- Not found in public records yet: total plots
- Layout approved by
- BIAAPA
- Land
- Not found in public records yet: land area
- Land conversion orders
- 44
- Completion (extended)
- Sep 2022
- Development (RERA update)
- Not found in public records yet: development progress
Plot sizes (RERA filing)
| Size (feet) | Area | Plots |
|---|---|---|
| 30×50 | 1,500 sq ft | 229 |
| 40×50 | 2,000 sq ft | 7 |
| 40×60 | 2,400 sq ft | 132 |
| 50×50 | 2,500 sq ft | 4 |
| 40×65 | 2,600 sq ft | 5 |
| 40×70 | 2,800 sq ft | 3 |
| 50×82 | 4,100 sq ft | 11 |
| 50×85 | 4,250 sq ft | 11 |
| Odd-sized (irregular) | varies | 192 |
Sizes as filed with RERA, converted from metres to feet (9.14 m = 30 ft, 12.19 m = 40 ft). Ask the developer which plots are still unsold.
Approving authority as filed: BIAPPA - Bangalore Airport Area Planning Authority.
Land conversion orders (RERA filing)
44 rows: land conversion orders. Scroll inside the table to see them all.
| Phase | Survey no. | Converted for | Order | By |
|---|---|---|---|---|
| Phase-4a | 34-1 | Residential | No. ALN(DE.KU)SR.28/2013-14, 4 Dec 2013 | DC Bengaluru |
| Phase-4a | 34-3 | Residential | No. 331961, 26 May 2022 | DC Bengaluru |
| Phase-4a | 35 | Residential | No. ALN.SR(DE) 162/2005-06, 22 Sep 2005 | DC Bengaluru |
| Phase-4a | 117-3 | Residential | No. 242880, 12 Oct 2021 | DC Bengaluru |
| Phase-4a | 117-4 | Residential | No. 242881, 12 Oct 2021 | DC Bengaluru |
| Phase-4b | 41-1 | Residential | No. ALN(DE.KU)SR.97/2017-18, 6 Feb 2018 | DC Bengaluru |
| Phase-4b | 41-2 | Residential | No. No. 334237, 8 Jun 2022 | DC Bengaluru |
| Phase-4b | 194-1 | Residential | No. No. 331973, 26 May 2022 | DC Bengaluru |
| Phase-4b | 194-2 | Residential | No. No. 331975, 26 May 2022 | DC Bengaluru |
| Phase-4b | 194-3 | Residential | No. No. 350442, 5 Jul 2022 | DC Bengaluru |
| Phase-4c | 33/12 | Residential | No. AAL AN: SR(DE) 160:05-06, 22 Sep 2005 | Su division Office, Doddaballapura |
| Phase-5a | 11/1 | Residential | No. LAND10015816, 22 Feb 2019 | DC Office, Bangalore Rural |
| Phase-5a | 11/2 | Residential | No. ALN(DE.KU)SR/33/2013-14, 19 Oct 2013 | DC Office, Bangalore Rural |
| Phase-5a | 11/3 | Residential | No. 242879, 12 Oct 2021 | DC Office, Bangalore Rural |
| Phase-5a | 11/4 | Residential | No. ALN(DE.KU)SR/24/2013-14, 19 Oct 2013 | DC Office, Bangalore Rural |
| Phase-5a | 12/1 | Residential | No. 489587, 19 May 2023 | DC Office, Bangalore Rural |
| Phase-5a | 12/4 | Residential | No. 680308, 11 Jul 2024 | DC Office, Bangalore Rural |
| Phase-5a | 12/9 | Residential | No. 680306, 10 Jul 2024 | DC Office, Bangalore Rural |
| Phase-5a | 23/1A | Residential | No. ALN(DE.KU)SR/21/2013-14, 19 Oct 2013 | DC Office, Bangalore Rural |
| Phase-5a | 12/3 | Residential | No. 541771, 3 Nov 2023 | DC Office, Bangalore Rural |
| Phase-5a | 12/5 | Residential | No. 489591, 19 May 2023 | DC Office, Bangalore Rural |
| Phase-5a | 12/6 | Residential | No. 541782, 3 Nov 2023 | DC Office, Bangalore Rural |
| Phase-5a | 12/7 | Residential | No. 541773, 30 Oct 2023 | DC Office, Bangalore Rural |
| Phase-5a | 12/8 | Residential | No. 541775, 30 Oct 2023 | DC Office, Bangalore Rural |
| Phase-5a | 16/2 | Residential | No. 541780, 30 Oct 2023 | DC Office, Bangalore Rural |
| Phase-5a | 16/3 | Residential | No. 541781, 3 Nov 2023 | DC Office, Bangalore Rural |
| Phase-5a | 19 | Residential | No. 489589, 19 May 2023 | DC Office, Bangalore Rural |
| Phase-5a | 20 | Residential | No. 339771, 13 Jun 2022 | DC Office, Bangalore Rural |
| Phase-5a | 22/2 | Residential | No. 21291, 18 Jul 2024 | DC Office, Bangalore Rural |
| Phase-5a | 22/3 | Residential | No. 21294, 18 Jul 2024 | DC Office, Bangalore Rural |
| Phase-5a | 22/4 | Residential | No. 21290, 18 Jul 2024 | DC Office, Bangalore Rural |
| Phase-5a | 22/5 | Residential | No. 21284, 18 Jul 2024 | DC Office, Bangalore Rural |
| Phase-5a | 22/6 | Residential | No. 21283, 18 Jul 2024 | DC Office, Bangalore Rural |
| Phase-5a | 22/7 | Residential | No. 21282, 18 Jul 2024 | DC Office, Bangalore Rural |
| Phase-5a | 22/8 | Residential | No. 21274, 18 Jul 2024 | DC Office, Bangalore Rural |
| Phase-5a | 23/2 | Residential | No. 27/2013-14, 4 Dec 2013 | DC Office, Bangalore Rural |
| Phase-5b | 122/1 | Residential | No. 502457, 9 Jun 2023 | DC Office, Bangalore Rural |
| Phase-5b | 122/2 | Residential | No. 502452, 9 Jun 2023 | DC Office, Bangalore Rural |
| Phase-5b | 165 | Residential | No. LNDC10000059, 19 Jun 2018 | DC Office, Bangalore Rural |
| Phase-5b | 167/1 | Residential | No. 502453, 9 Jun 2023 | DC Office, Bangalore Rura |
| Phase-5b | 167/2 | Residential | No. 481244, 3 Apr 2023 | DC Office, Bangalore Rural |
| Phase-5b | 168/1 | Residential | No. 502455, 9 Jun 2023 | DC Office, Bangalore Rural |
| Phase-5b | 168/2 | Residential | No. 502456, 9 Jun 2023 | DC Office, Bangalore Rural |
| Phase-5b | 168/3 | Residential | No. 481245, 2 Jun 2023 | DC Office, Bangalore Rural |
RERA does not cover each plot’s khata. Ask the developer for the khata and title documents and have a lawyer check them before paying an advance.
Earthsong by Manyata RERA number and registration details
- RERA number
- PRM/KA/RERA/1250/303/PR/180518/001740
- Registered on
- 18 May 2018
- Promised completion
- 31 Dec 2026
- Extended to
- 30 Sep 2022
- RERA status
- New launch
- Plots booked
- Not found in public records yet: plots booked
- Price
- Not found in public records yet: price
- Project type
- Plotted
7 RERA registrations (one per phase) are shown together on this page; dates above are the latest across phases.
Phases and RERA numbers
| Phase | RERA number | Promised completion | Plots | Status | Source |
|---|---|---|---|---|---|
| Main registration | PRM/KA/RERA/1250/303/PR/180518/001740 | 31 Jan 2020 | — | Completed | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Phase 2 | PRM/KA/RERA/1250/303/PR/200109/003146 | 31 Dec 2021Extended to 30 Sep 2022 | 195 | Completed | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Phase-4a | PRM/KA/RERA/1250/303/PR/220223/005747 | 31 Dec 2026 | 78 | New launch | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Phase-4b | PRM/KA/RERA/1251/309/PR/020323/005765 | 31 Dec 2026 | 96 | Completed | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Phase-4c | PRM/KA/RERA/1250/303/PR/150523/005932 | 28 Mar 2023 | 50 | Completed | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Phase-5a | PRM/KA/RERA/1250/303/PR/260525/007779 | 31 Dec 2026 | 216 | Under construction | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Phase-5b | PRM/KA/RERA/1250/303/PR/260525/007780 | 31 Dec 2026 | 154 | Under construction | Source (rera.karnataka.gov.in) (opens in a new tab) |
Summary in plain English
Earthsong by Manyata is a plotted layout by Manyata Developers Pvt Ltd in Illthore, Devanahalli, Bengaluru Rural. The project has 7 RERA registrations across multiple phases. Completion dates range from 2020 to 31 December 2026.
Written by AI from the RERA record above on 17 Oct 2026. Every number in it was checked against that record; if anything differs, the record wins.
Open space, loans, escrow and other details
- Open space
- Not found in public records yet: open space
- Water and power
- Water source filed with RERA: BWSSB, Local Authority, BoreWell,Local Authority
- Plot loans: approved banks
- Not found in public records yet: bank approvals
- Payment plans
- Not found in public records yet: payment plans
- Maintenance
- Not found in public records yet: maintenance
- Car parking
- Not found in public records yet: car parking charge
- Escrow bank (RERA) · Main registration
- HDFC, Richmond Road
- Escrow bank (RERA) · Phase 2
- HDFC, Richmond Road
- Escrow bank (RERA) · Phase-4a
- YES BANK, CMH Road
- Escrow bank (RERA) · Phase-4b
- YES BANK, CMH Road
- Escrow bank (RERA) · Phase-4c
- YES BANK, CMH Road
- Escrow bank (RERA) · Phase-5a
- YES BANK, Kasturba Road
- Escrow bank (RERA) · Phase-5b
- YES BANK, Kasturba Road
Amenities
Earthsong by Manyata location and address
- Address
- Sy No.36,37,38,39 & 40, Illthore Village, Kundana Hobli, Devanahalli Tq
- Village (RERA)
- Illthore
- Locality
- Near Bellary Road (Airport Road)Also known as Airport Road, International Airport Road, Bellary Road, NH 44
- PIN code
- 560025
- City
- Bengaluru
- State
- Karnataka
- Coordinates
- 13.22041, 77.63240
Distances to landmarks
Not found in public records yet: landmarksAbout Illthore
Not found in public records yet: locality factsCommute times to tech parks and the airport
| To | Straight line | Peak-hour drive (estimate) |
|---|---|---|
| Kempegowda International AirportMap point on OpenStreetMap (opens in a new tab) | 8.1 km | approx. 33 min |
| Manyata Tech ParkMap point on OpenStreetMap (opens in a new tab) | 19.2 km | approx. 78 min |
| KSR Bengaluru City railway station (Majestic)Map point on OpenStreetMap (opens in a new tab) | 27.78 km | approx. 113 min |
| ITPL, Whitefield (main gate)Map point on OpenStreetMap (opens in a new tab) | 28.29 km | approx. 115 min |
| Outer Ring Road tech corridor (RMZ Ecospace, Bellandur)Map point on OpenStreetMap (opens in a new tab) | 33.41 km | approx. 135 min |
| Electronic City Phase 1Map point on OpenStreetMap (opens in a new tab) | 41.37 km | approx. 168 min |
How we calculate
Straight line: from the project’s map point on RERA to the destination’s point on OpenStreetMap.
Peak-hour drive is a rough estimate, not a route: straight line × 1.35 for the road network, at 20 km/h. Real times vary a lot with the route and the hour.
Sources:Source (openstreetmap.org) (opens in a new tab)How we calculate this
Nearest metro station and railway
- Doddajala (ದೊಡ್ಡಜಾಲ)Blue Line metro, under construction3.8 km
- Airport City (ವಿಮಾನ ನಿಲ್ದಾಣ ನಗರ)Blue Line metro, under construction6.4 km
- KIAL Terminals (ಕೆಐಎಬಿ ವಿಮಾನ ನಿಲ್ದಾಣ ಟರ್ಮಿನಲ್ಸ್)Blue Line metro, under construction9.06 km
- Peenya (ಪೀಣ್ಯ)Open now — nearest operating metro station23.44 km
- Doddajala Nearest railway station4.51 km
Straight-line distances from the RERA map point to the station points mapped on OpenStreetMap; status (open or under construction) as tagged there. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Lake and lake-buffer check
The nearest mapped lake is Unnamed lake (mapped on OpenStreetMap), 201 m from the project’s RERA map point.
The site boundary is not published as a shape, so its nearest edge can be closer than this point. Whether any building sits inside a lake buffer can only be checked on the approved plan.
- Unnamed lake (mapped on OpenStreetMap) on OpenStreetMap (opens in a new tab) 201 m
- Unnamed lake (mapped on OpenStreetMap) on OpenStreetMap (opens in a new tab) 1,499 m
- Unnamed lake (mapped on OpenStreetMap) on OpenStreetMap (opens in a new tab) 1,825 m
The buffer rule
Bengaluru’s lake buffer rule has changed over time: the National Green Tribunal ordered a 75 m buffer in May 2016; the Supreme Court set that order aside on 5 March 2019, leaving the 30 m buffer of the Revised Master Plan 2015. Check the current rule and the approved plan before relying on either number.
- LiveLaw: SC sets aside NGT order enlarging buffer zones (2019) (livelaw.in) (opens in a new tab)
- Citizen Matters: Shrinking lake buffers (citizenmatters.in) (opens in a new tab)
Shortest distance from the RERA map point to the mapped water edge (OpenStreetMap water polygons tagged lake or reservoir, or named lake/kere/tank). Mapped shorelines can differ from the revenue-record boundary of a lake. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Sources:Source (openstreetmap.org) (opens in a new tab)Source (livelaw.in) (opens in a new tab)Source (citizenmatters.in) (opens in a new tab)How we calculate this
Satellite time-lapse of the site
Satellite photos load when you scroll to them.
Photos from Esri World Imagery Wayback, centred on the project’s map point; dates are the capture dates in Esri’s metadata. Loaded from Esri when you scroll here.
Sources:Source (livingatlas.arcgis.com) (opens in a new tab)
Earthsong by Manyata layout plan and plot types as filed
Documents the developer uploaded to Karnataka RERA, shown as filed. Tap a page to see it full size; the full PDF opens on the RERA website.
Approved building plan2 files

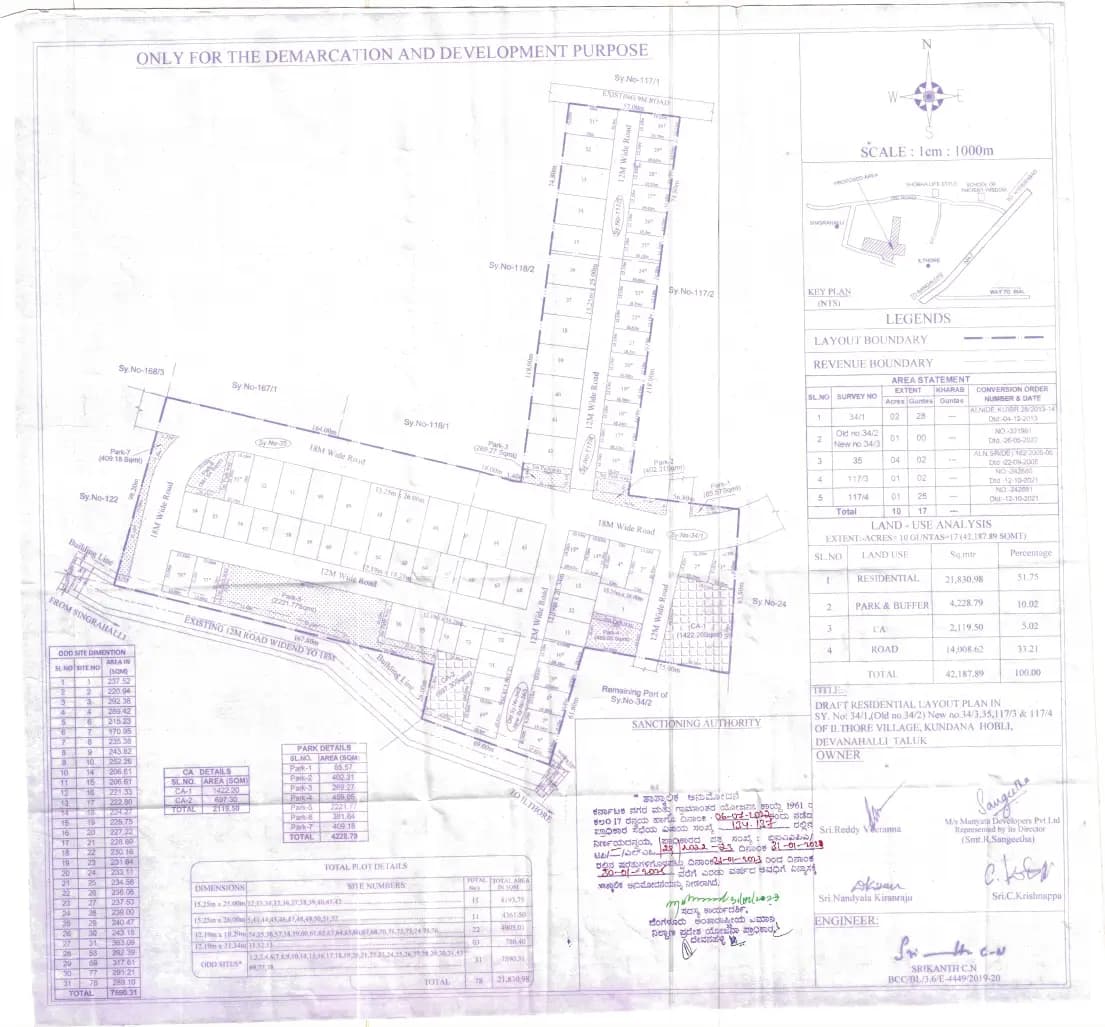

Phase-4a: Approved Building/Plotting PlanFull PDF on RERA

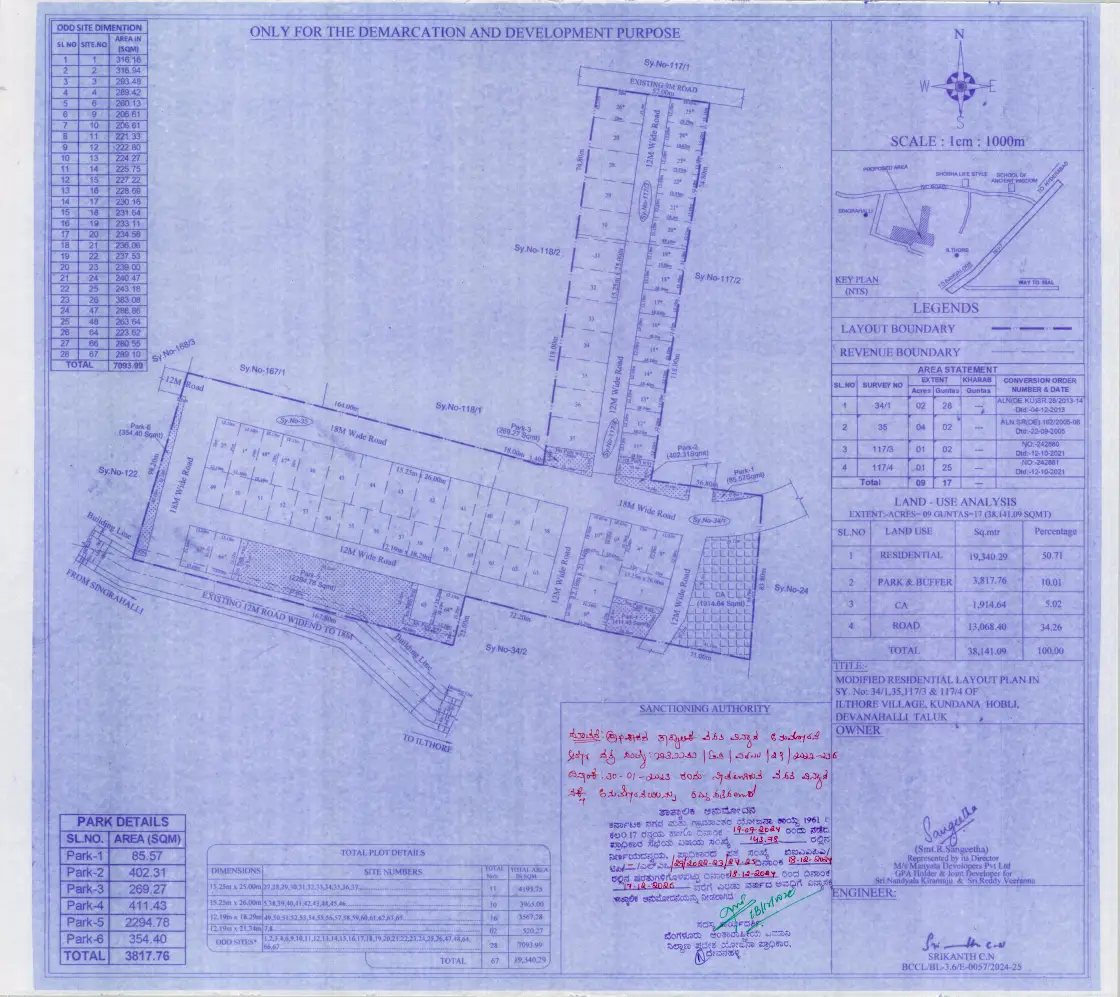

Phase-4a: Phase 4A sanctioned plan.pdfFull PDF on RERA

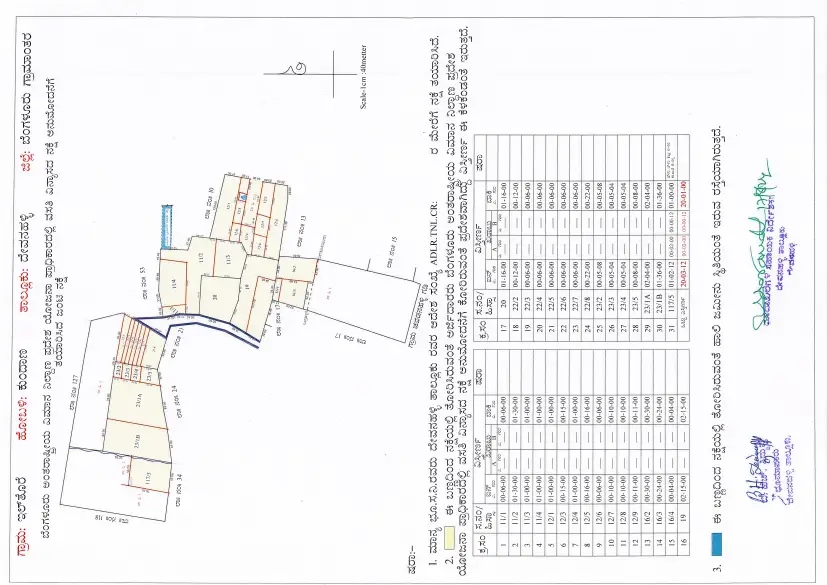

Approved layout plan7 files

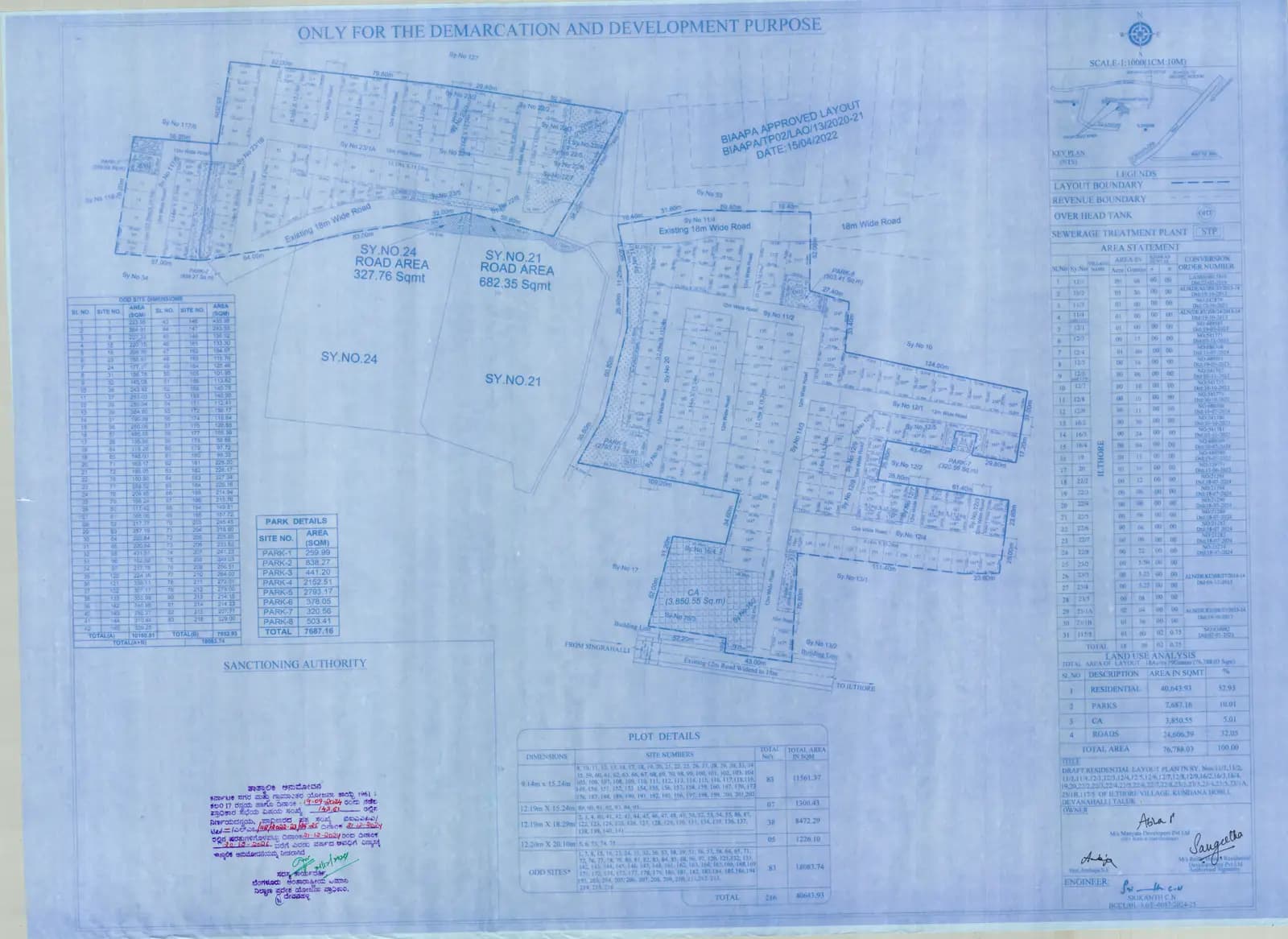

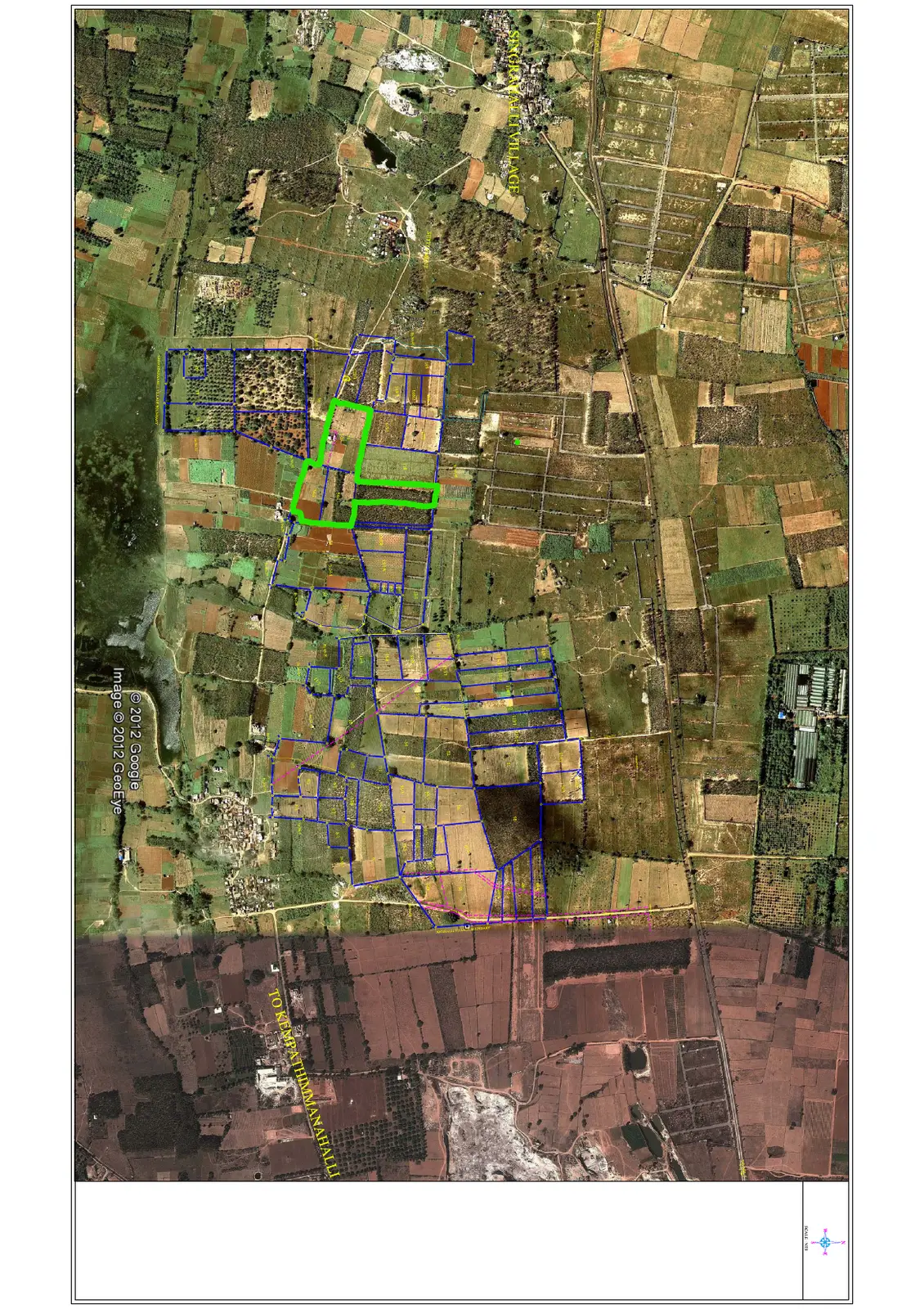

Phase-4a: Approved Layout PlanFull PDF on RERA

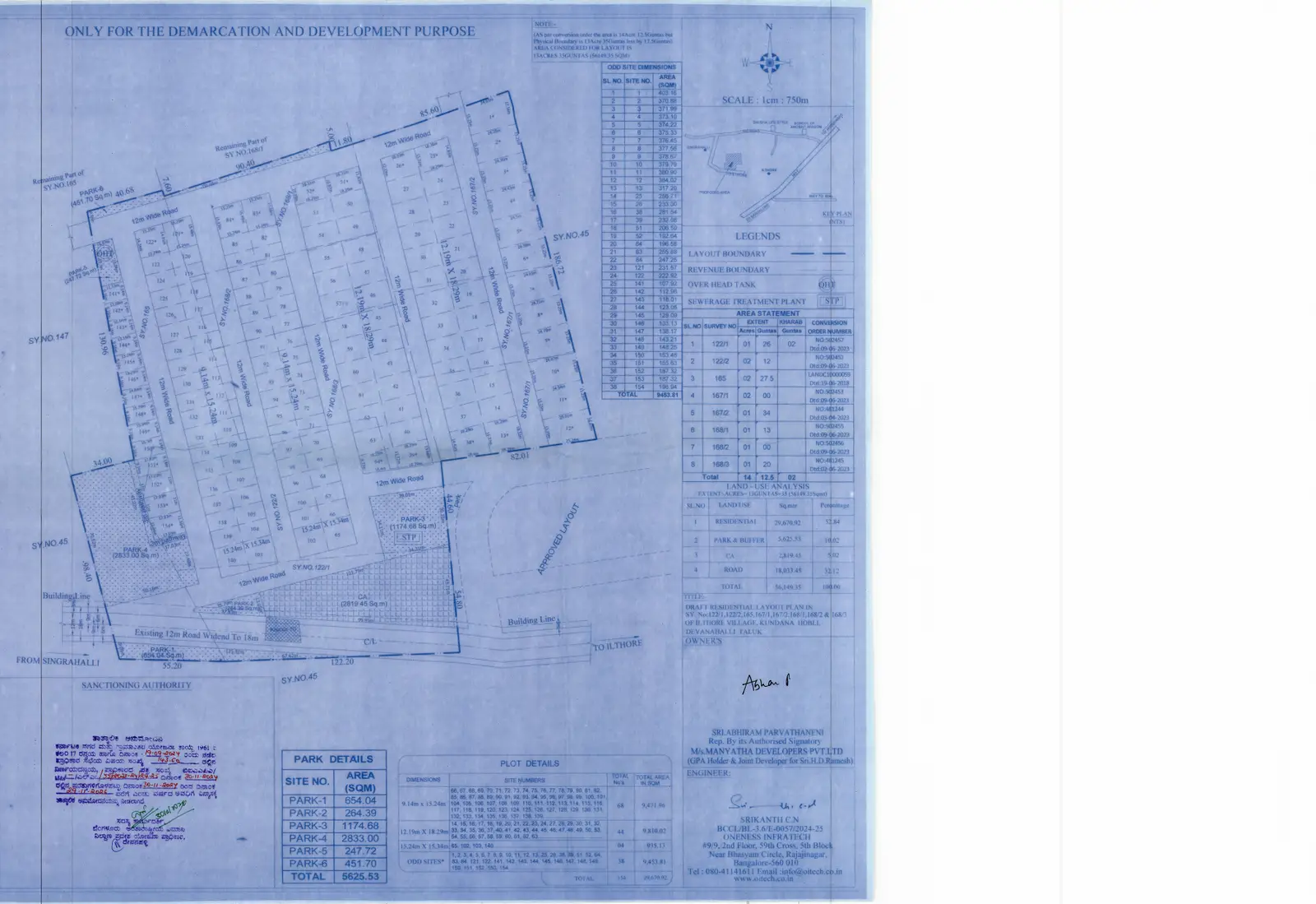

Phase-4a: Existing Layout PlanFull PDF on RERA
Phase-5b: Approved Layout Plan/Demarcation PlanFull PDF on RERA
Phase-5a: Approved Layout Plan/Demarcation PlanFull PDF on RERA
Phase-5b: ADLR and Demarcation of Sy No in Village Map.pdfFull PDF on RERA

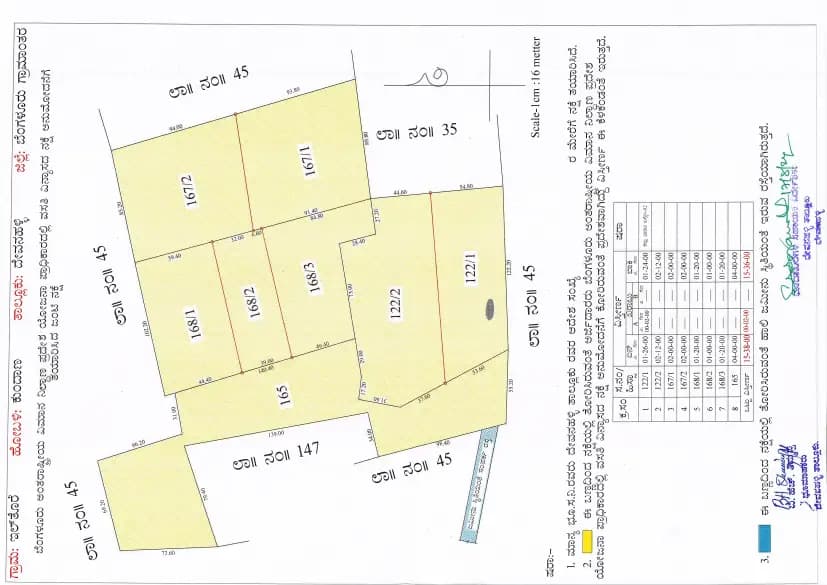

Phase-5a: ADLR and Demarcation of Village Map.pdfFull PDF on RERA
Phase-4a: Location Demarcation 4A.pdfFull PDF on RERA
Layout plan and brochure not published? The developer shares them only on request. We’ll get the brochure, layout plan and current price list for you, free.
Get brochure, layout plan & price| Plot type (as filed) | Area | Plots |
|---|---|---|
| Plot 9.14 m × 15.24 m | — | 151 |
| 9.14m * 15.24m | — | 27 |
| Plot 9.14 m × 15.24 m | — | 51 |
| Plot 12.19 m × 15.24 m | — | 7 |
| Plot 12.19 m × 18.29 m | — | 82 |
| 12.19m * 18.29m | — | 9 |
| Plot 12.19 m × 18.29 m | — | 41 |
| Plot 12.19 m × 21.34 m | — | 3 |
| Plot 12.20 m × 20.10 m | — | 5 |
| Plot 15.24 m × 15.34 m | — | 4 |
| Plot 15.25 m × 25.00 m | — | 11 |
| Plot 15.25 m × 26.00 m | — | 11 |
| Odd | — | 14 |
| Odd-shaped plots | — | 178 |
| Plots | 1,656 sq ft | 195 |
Plot types and counts as filed with Karnataka RERA.
We have not collected the layout plan drawing; the developer’s sales team can share it.
Earthsong by Manyata completion date and development status
Timeline
- 1 Feb 2018Main registration: Project start date given to RERA
- 18 May 2018Main registration: Registered with Karnataka RERA
- 9 Dec 2019Phase 2: Project start date given to RERA
- 9 Jan 2020Phase 2: Registered with Karnataka RERA
- 31 Jan 2020Main registration: Completion date given at registration
- 11 Feb 2020Main registration: Promoter applied to RERA for completion
- 31 Dec 2021Phase 2: Completion date given at registration
- 7 Apr 2022Phase 2: Promoter applied to RERA for completion
- 1 Jul 2022Phase-4c: Project start date given to RERA
- 30 Sep 2022Phase 2: Covid Extension: completion date moved to this date
- 1 Feb 2023Phase-4a: Project start date given to RERA
- 1 Feb 2023Phase-4b: Project start date given to RERA
- 22 Feb 2023Phase-4a: Registered with Karnataka RERA
- 2 Mar 2023Phase-4b: Registered with Karnataka RERA
- 28 Mar 2023Phase-4c: Completion date given at registration
- 15 May 2023Phase-4c: Registered with Karnataka RERA
- 17 Jul 2023Phase-4c: Promoter applied to RERA for completion
- 2 Jan 2025Phase-4b: Promoter applied to RERA for completion
- 1 Apr 2025Phase-5a: Project start date given to RERA
- 1 Apr 2025Phase-5b: Project start date given to RERA
- 26 May 2025Phase-5a: Registered with Karnataka RERA
- 26 May 2025Phase-5b: Registered with Karnataka RERA
- 31 Dec 2026Phase-4a: Completion date given at registration
- 31 Dec 2026Phase-4b: Completion date given at registration
- 31 Dec 2026Phase-5a: Completion date given at registration
- 31 Dec 2026Phase-5b: Completion date given at registration
Construction pace from RERA quarterly filings (Phase-5b)
At the average pace so far, construction would reach 100% around Aug 2027 — about 8 months after the completion date on RERA (31 Dec 2026).
At the pace between the 4 quarterly filings we have (55% → 63% in 9 months), it would be around Mar 2030 — about 38 months after the RERA date.
This project has 7 RERA registrations; the chart uses Phase-5b, the one with the most quarterly filings.
- Filed on RERA
- Average pace since start
- Pace between filings (and 0% assumed at the start date)
- RERA completion date
Quarterly filings
| Quarter | Filed on | Developed | Plots booked |
|---|---|---|---|
| Q2 2026-27to 30 Sep 2026 | 15 Oct 2026 | 63% | — |
| Q1 2026-27to 30 Jun 2026 | 14 Jul 2026 | 59% | — |
| Q4 2025-26to 31 Mar 2026 | 15 Apr 2026 | 56% | — |
| Q3 2025-26to 31 Dec 2025 | 20 Feb 2026 | 55% | — |
How we calculate
Average pace = % built ÷ months since the start date in the RERA record. Here: 63% ÷ 18 months (1 Apr 2025 to 30 Sep 2026) = 3.5% a month.
Estimated finish = latest filing date + (100 − % built) ÷ pace = 30 Sep 2026 + 37 ÷ 3.5 = 10.6 months → Aug 2027. This is an estimate, not a date from the builder or RERA.
Pace between filings = (63% − 55%) ÷ 9 months = 0.9% a month.
A straight line is a simplification: the builder reports one overall %, which mixes excavation, structure and finishing, and work rarely moves at a constant speed. The % values are the promoter’s own figures filed with RERA, not checked by us.
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
Approvals and documents checklist
49 rows: approvals. Scroll inside the table to see them all.
| Approval | Authority | Source |
|---|---|---|
| Layout plan (Main registration) | BIAPPA - Bangalore Airport Area Planning Authority | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Layout plan (Phase 2) | BIAPPA - Bangalore Airport Area Planning Authority | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Layout plan (Phase-4a) | BIAPPA - Bangalore Airport Area Planning Authority · No. BIAAPA/TP/LAO/29/2022-23 · dated 2023-01-31 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Land conversion (5 orders) (Phase-4a) | DC Bengaluru · No. ALN(DE.KU)SR.28/2013-14 and 4 more · dated 2022-05-26 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Commencement Certificate (Phase-4a) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Electricity Permission Letter (Phase-4a) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Water Permission Letter (Phase-4a) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Layout Plan (Phase-4a) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Building/Plotting Plan (Phase-4a) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| District Magistrate (Phase-4a) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| ESCOM/Electricity (Phase-4a) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KWSSB/Water (Phase-4a) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KSPCB (Phase-4a) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Layout plan (Phase-4b) | BIAPPA - Bangalore Airport Area Planning Authority · No. BIAPPA/TP/LAO/30/2022-23 · dated 2023-01-31 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Land conversion (5 orders) (Phase-4b) | DC Bengaluru · No. ALN(DE.KU)SR.97/2017-18 and 4 more · dated 2022-07-05 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Commencement Certificate (Phase-4b) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Electricity Permission Letter (Phase-4b) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Water Permission Letter (Phase-4b) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Layout Plan (Phase-4b) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Building/Plotting Plan (Phase-4b) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Change of Land Use (Phase-4b) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| District Magistrate (Phase-4b) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| ESCOM/Electricity (Phase-4b) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KWSSB/Water (Phase-4b) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Layout plan (Phase-4c) | BIAPPA - Bangalore Airport Area Planning Authority · No. BIAPPA/TP/LAO/43/2021-22/618 · dated 2022-06-21 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Land conversion (Phase-4c) | Su division Office, Doddaballapura · No. AAL AN: SR(DE) 160:05-06 · dated 2005-09-22 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Commencement Certificate (Phase-4c) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Electricity Permission Letter (Phase-4c) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Water Permission Letter (Phase-4c) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Layout Plan (Phase-4c) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Building/Plotting Plan (Phase-4c) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Section Of Building/Infrastructure Plan of Plotting (Phase-4c) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Change of Land Use (Phase-4c) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| District Magistrate (Phase-4c) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Conversion Certificate under section 95 of the KLR Act 1964 (Phase-4c) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| ESCOM/Electricity (Phase-4c) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KWSSB/Water (Phase-4c) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Layout plan (Phase-5a) | BIAPPA - Bangalore Airport Area Planning Authority · No. BIAAPA/TP/LAO/118/2022-23/24-25 · dated 2024-12-21 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Land conversion (25 orders) (Phase-5a) | DC Office, Bangalore Rural · No. LAND10015816 and 24 more · dated 2024-07-18 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Layout Plan/Demarcation Plan (Phase-5a) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| NOC from ESCOMs (Phase-5a) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| NOC for Water (Phase-5a) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KSPCB (If Applicable) (Phase-5a) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Layout plan (Phase-5b) | BIAPPA - Bangalore Airport Area Planning Authority · No. BIAAPA/TP/LAO/55/2023-24/24-25 · dated 2024-11-30 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Land conversion (8 orders) (Phase-5b) | DC Office, Bangalore Rural · No. 502457 and 7 more · dated 2023-06-09 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Layout Plan/Demarcation Plan (Phase-5b) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| NOC from ESCOMs (Phase-5b) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| NOC for Water (Phase-5b) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KSPCB (If Applicable) (Phase-5b) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
Documents uploaded to RERA (Phase-4c)
- Building or layout plan · Approved drawings from the planning authorityFiled on RERA ✓ — BIAPPA - Bangalore Airport Area Planning Authority · No. BIAPPA/TP/LAO/43/2021-22/618 · dated 21 Jun 2022
- Commencement certificate · Permission to start buildingFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Environment clearance · SEIAA KarnatakaNot on RERA yet
- Fire NOC · Karnataka Fire and Emergency ServicesNot on RERA yet
- Pollution board consent · KSPCBNot on RERA yet
- Water and sewerage · BWSSBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Electricity · BESCOMFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Height clearance · Airports Authority of IndiaNot on RERA yet
- Occupancy certificate (OC) · Issued only when the building is finishedNot on RERA yet — expected at completion
From the documents the promoter uploaded to Karnataka RERA, collected 4 Oct 2026. “Filed” means a document is on RERA — we have not checked its contents or validity. Not every approval applies to every project (for example, smaller projects may not need an environment clearance). Each phase is registered separately; this list is for the phase named above. The project page on RERA lists each upload.
Earthsong by Manyata RERA complaints
No complaints listed on Karnataka RERA for these registrations as on Source (rera.karnataka.gov.in) (opens in a new tab)
Court and consumer cases
We list case numbers, courts and outcomes only — never names of private individuals.
About Manyata Developers Pvt Ltd
- Promoter type
- Company
- Projects on this site
- 4
- RERA complaints against promoter
- 1
- Company number (CIN)
- U45201KA2008PTC047296
From Karnataka RERA, as collected so far (17 Oct 2026). Complaints are those RERA lists against this promoter across all its projects.
Manyata Developers Pvt Ltd’s RERA recordManyata Developers Pvt Ltd delivery record
- 4Projects in Bengaluru on RERA10 approved registrations under Manyata Developers Pvt Ltd in Bengaluru Urban and Rural. Source (rera.karnataka.gov.in) (opens in a new tab)
- 1,404Plots registeredAs stated in 9 of the 10 registrations.
- 1RERA complaints1 open, 0 disposed. as on Source (rera.karnataka.gov.in) (opens in a new tab)
- 0.7Complaints per 1,000 plots1 complaints ÷ 1,404 plots in its 10 registrations on Karnataka RERA in Bengaluru.
- 4Completion filed on RERARegistrations where the promoter applied to RERA for completion; 0 with an occupancy certificate on RERA.
- 1 of 4Filed by the date given at registrationMedian gap 1.8 months (on-time ones count as 0). The completion application can come after handover, so this is an upper bound on lateness.
What the complaints are about
1 complaint subject as written on RERA, as on . Each subject is sorted into one group by keywords (first match wins: delay, refund, registration, quality, litigation, association); one complaint often raises several issues. Source (rera.karnataka.gov.in) (opens in a new tab)
Completion filed on RERA
| Project | Date at registration | Completion filed | Gap |
|---|---|---|---|
| Earthsong By Manyata Phase-4b | 31 Dec 2026 | 2 Jan 2025 | By the date |
| Earthsong By Manyata Phase-4c | 28 Mar 2023 | 17 Jul 2023 | 4 months after |
| Earthsong By Manyata- Phase 2 | 31 Dec 2021extended to 30 Sep 2022 | 7 Apr 2022 | 3 months after |
| Earthsong by Manyata | 31 Jan 2020 | 11 Feb 2020 | 1 months after |
Measured against the completion date given at registration; many projects had RERA extensions (including the COVID-period extension), shown under the date.
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
What’s changed since Feb 2018
- 15 Oct 2026Phase-5b: Quarterly update filed for Q2 2026-27: 63% built Source (rera.karnataka.gov.in) (opens in a new tab)
- 14 Jul 2026Phase-5a: Quarterly update filed for Q1 2026-27: 68% built Source (rera.karnataka.gov.in) (opens in a new tab)
- 14 Jul 2026Phase-5b: Quarterly update filed for Q1 2026-27: 59% built Source (rera.karnataka.gov.in) (opens in a new tab)
- 15 Apr 2026Phase-5a: Quarterly update filed for Q4 2025-26: 63% built Source (rera.karnataka.gov.in) (opens in a new tab)
- 15 Apr 2026Phase-5b: Quarterly update filed for Q4 2025-26: 56% built Source (rera.karnataka.gov.in) (opens in a new tab)
- 20 Feb 2026Phase-5a: Quarterly update filed for Q3 2025-26: 62% built Source (rera.karnataka.gov.in) (opens in a new tab)
- 20 Feb 2026Phase-5b: Quarterly update filed for Q3 2025-26: 55% built Source (rera.karnataka.gov.in) (opens in a new tab)
- 26 May 2025Phase-5a: Registered with Karnataka RERA (PRM/KA/RERA/1250/303/PR/260525/007779); completion date 31 Dec 2026 Source (rera.karnataka.gov.in) (opens in a new tab)
- 26 May 2025Phase-5b: Registered with Karnataka RERA (PRM/KA/RERA/1250/303/PR/260525/007780); completion date 31 Dec 2026 Source (rera.karnataka.gov.in) (opens in a new tab)
- 1 Apr 2025Phase-5a: Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
- 1 Apr 2025Phase-5b: Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
- 2 Jan 2025Phase-4b: Promoter applied to RERA for completion Source (rera.karnataka.gov.in) (opens in a new tab)
- 21 Dec 2024Phase-5a: Building plan approved by BIAPPA - Bangalore Airport Area Planning Authority (No. BIAAPA/TP/LAO/118/2022-23/24-25) Source (rera.karnataka.gov.in) (opens in a new tab)
- 30 Nov 2024Phase-5b: Building plan approved by BIAPPA - Bangalore Airport Area Planning Authority (No. BIAAPA/TP/LAO/55/2023-24/24-25) Source (rera.karnataka.gov.in) (opens in a new tab)
- 17 Jul 2023Phase-4c: Promoter applied to RERA for completion Source (rera.karnataka.gov.in) (opens in a new tab)
- 15 May 2023Phase-4c: Registered with Karnataka RERA (PRM/KA/RERA/1250/303/PR/150523/005932); completion date 28 Mar 2023 Source (rera.karnataka.gov.in) (opens in a new tab)
- 2 Mar 2023Phase-4b: Registered with Karnataka RERA (PRM/KA/RERA/1251/309/PR/020323/005765); completion date 31 Dec 2026 Source (rera.karnataka.gov.in) (opens in a new tab)
- 22 Feb 2023Phase-4a: Registered with Karnataka RERA (PRM/KA/RERA/1250/303/PR/220223/005747); completion date 31 Dec 2026 Source (rera.karnataka.gov.in) (opens in a new tab)
- 1 Feb 2023Phase-4a: Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
- 1 Feb 2023Phase-4b: Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
- 31 Jan 2023Phase-4a: Building plan approved by BIAPPA - Bangalore Airport Area Planning Authority (No. BIAAPA/TP/LAO/29/2022-23) Source (rera.karnataka.gov.in) (opens in a new tab)
- 31 Jan 2023Phase-4b: Building plan approved by BIAPPA - Bangalore Airport Area Planning Authority (No. BIAPPA/TP/LAO/30/2022-23) Source (rera.karnataka.gov.in) (opens in a new tab)
- 30 Sep 2022Phase 2: Completion date extended to 30 Sep 2022 Source (rera.karnataka.gov.in) (opens in a new tab)
- 1 Jul 2022Phase-4c: Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
- 21 Jun 2022Phase-4c: Building plan approved by BIAPPA - Bangalore Airport Area Planning Authority (No. BIAPPA/TP/LAO/43/2021-22/618) Source (rera.karnataka.gov.in) (opens in a new tab)
- 7 Apr 2022Phase 2: Promoter applied to RERA for completion Source (rera.karnataka.gov.in) (opens in a new tab)
- 11 Feb 2020Main registration: Promoter applied to RERA for completion Source (rera.karnataka.gov.in) (opens in a new tab)
- 9 Jan 2020Phase 2: Registered with Karnataka RERA (PRM/KA/RERA/1250/303/PR/200109/003146); completion date 31 Dec 2021 Source (rera.karnataka.gov.in) (opens in a new tab)
- 9 Dec 2019Phase 2: Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
- 18 May 2018Main registration: Registered with Karnataka RERA (PRM/KA/RERA/1250/303/PR/180518/001740); completion date 31 Jan 2020 Source (rera.karnataka.gov.in) (opens in a new tab)
Newest first. Showing the latest 30 of 31 dated events. When the RERA crawl sees a new filing, complaint or extension, it is added here with its date.
Plot loan EMI calculator
- Monthly EMI
- —
- Down payment
- —
- Loan amount
- —
- Total interest
- —
A calculation only, from the numbers you enter — not a loan offer.
Earthsong by Manyata FAQs
What plot sizes are available in Earthsong by Manyata Phase 4a?
Phase 4a offers 40×60 (2,400 sq ft), 50×82 (4,100 sq ft), 50×85 (4,250 sq ft), and 40×70 (2,800 sq ft) plots, with 31 odd-sized plots also available.
What plot sizes are available in Earthsong by Manyata Phase 4b?
Phase 4b offers 30×50 (1,500 sq ft) and 40×60 (2,400 sq ft) plots, with 26 odd-sized plots also available.
How many plots does Phase 2 of Earthsong by Manyata have?
Phase 2 has 195 plots.
What authority approved the layout for Earthsong by Manyata?
The layout is approved by BIAAPA.
What are the RERA registration numbers for Earthsong by Manyata?
The project has registrations: PRM/KA/RERA/1250/303/PR/180518/001740 (Phase Main), PRM/KA/RERA/1250/303/PR/200109/003146 (Phase 2), PRM/KA/RERA/1250/303/PR/220223/005747 (Phase 4a), PRM/KA/RERA/1251/309/PR/020323/005765 (Phase 4b), PRM/KA/RERA/1250/303/PR/150523/005932 (Phase 4c), PRM/KA/RERA/1250/303/PR/260525/007779 (Phase 5a), and PRM/KA/RERA/1250/303/PR/260525/007780 (Phase 5b).
When will Earthsong by Manyata be completed?
Phase Main and Phase 4c are marked as completed on RERA. Phase 2 has a completion date of 30 September 2022. Phases 4a, 4b, 5a, and 5b have a completion date of 31 December 2026.
Are there any RERA complaints against Earthsong by Manyata?
There are no RERA complaints on this project. The developer has 1 RERA complaint across all projects.
Where is Earthsong by Manyata located?
The project is located in Illthore, Devanahalli taluk, Bengaluru Rural district, PIN code 560025.
What is the development progress of Earthsong by Manyata Phase 5a?
Phase 5a is 62% developed as of Q3 2025-26 (quarter ended 31 December 2025) and has 216 plots.
How many land conversion orders does Phase 5a of Earthsong by Manyata have?
Phase 5a has 25 land conversion orders.
Written by AI from the RERA record above on 17 Oct 2026. Answers use only that record; check them against the source before you decide.
Questions about Earthsong by Manyata
No questions published yet. Ask the first one: you get an instant answer from this page’s public record, and our team follows up on anything the record does not show.
Bought a plot from Manyata Developers Pvt Ltd? Review the developer.
Reviews of Manyata Developers Pvt Ltd by verified buyers
No verified reviews of Manyata Developers Pvt Ltd yet. If you bought a plot from them, your review helps other buyers.
How reviews work: only buyers and owners can review; we confirm each purchase by phone before publishing, publish positive and negative reviews alike, never accept payment for reviews, and the developer may reply.
Similar projects within 5 km
| Project | Distance | Plots | Completion (RERA) | Developed | Complaints | Price |
|---|---|---|---|---|---|---|
| Konig Marvel CountyKonig Estates | 0.8 km | 115 | May 2030 | 5% | 0 | Not collected |
| Serene GardensContinental Builders And Developers | 1 km | 108 | Sep 2023 | — | 0 | Not collected |
| Nisarga LotusNisarga Developers | 1.2 km | 52 | Dec 2026 | — | 0 | Not collected |
| Earthsong By Manyata Phase-5cSquare plots Private limited | 1.3 km | 62 | Dec 2025 | 100% | 0 | Not collected |
| Aurum ValleyBangarukadiyala Syed Munaf | 1.5 km | 43 | Dec 2026 | 100% | 0 | Not collected |
| SilverspringsManyata Developers Private Limited | 1.6 km | 127 | Oct 2028 | 20% | 0 | Not collected |
Projects of the same kind within 5 km in a straight line of this project’s RERA map point, nearest first. % built is the promoter’s latest quarterly figure on RERA (shown for single-registration projects); prices are from the developer’s own website where we found one.
Sources and last checked dates
Collected on 17 Oct 2026 by AI research agents reading public pages. Facts are written in our own words. Not found yet: price; court cases; landmarks; specifications; news.
How to check on RERA: On rera.karnataka.gov.in/viewAllProjects, type the registration number in 'Registration No', press Search, then click the 'View Project Details' icon. Complaints open from the 'Complaints / Litigation' icon in the same row. Registration numbers: PRM/KA/RERA/1250/303/PR/180518/001740, PRM/KA/RERA/1250/303/PR/200109/003146, PRM/KA/RERA/1250/303/PR/220223/005747, PRM/KA/RERA/1251/309/PR/020323/005765, PRM/KA/RERA/1250/303/PR/150523/005932, PRM/KA/RERA/1250/303/PR/260525/007779, PRM/KA/RERA/1250/303/PR/260525/007780.
- RERA record last checked: 17 Oct 2026
- Last change in the record (registration, quarterly filing or complaint): 16 Oct 2026
How this page is made: software builds it from public records (Karnataka RERA filings, OpenStreetMap, the developer’s own website). AI is used only to read filings into fields and to write the plain-English summary and FAQ answers, which are checked against the record. Facts are checked automatically against the RERA filing. Methodology · How we earn · Report an error
More new projects nearby
Sadahalli, near Bellary Road (Airport Road)Under constructionRERA registeredBuyers’ group openKonig Marvel County
by Konig Estates
Price: Price on requestGet brochure & price →
- 30×40, 30×50, 40×40 +1 more
- 1,163 – 4,301 sq ft plots
- Approved by BIAAPA
- May 2030
115 plots
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Konig Marvel County- Nagamangala, DevanahalliReady to moveRERA registeredBuyers’ group open
Serene Gardens
by Continental Builders And
Price: Price on requestGet brochure & price →
- 50×70, 53×75
- 2,636 – 6,749 sq ft plots
- Approved by BIAAPA
- Sep 2023
2 phases on RERA · 108 plots
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Serene Gardens - Ilthore, near Bellary Road (Airport Road)© Esri, Maxar, Earthstar GeographicsReady to moveRERA registeredBuyers’ group open
Nisarga Lotus
by Nisarga
Price: Price on requestGet brochure & price →
- 30×40, 40×60
- 838 – 3,626 sq ft plots
- Approved by BIAAPA
- Dec 2026
52 plots
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Nisarga Lotus
