East Park Residences at a glance
- Possession (RERA)Mar 2028Karnataka RERA
- Construction71% built · on pace for Nov 2027RERA filing to 30 Sep 2026; estimate from average pace
- Homes booked461 of 497 (93%)RERA update · as on 30 Sep 2026
- RERA complaints (project)2 complaintsKarnataka RERA · as on 21 Oct 2026
- Approvals filed6 of 9 on RERAKarnataka RERA uploads · 21 Oct 2026
- Nearest metroEmbassy Tech Village Kadubeesanahalli · 4.25 km (under construction)Open now: Beratena Agrahara, 6.89 km · straight line · OpenStreetMap, 5 Oct 2026
- Airport driveapprox. 135 min at peak33.4 km straight line · estimate
- Nearest lakeChikkabelanduru Kere · 351 mFrom the RERA map point · OpenStreetMap, 5 Oct 2026
Project summary
East Park Residences is a residential project by Ramsons Trendsquares Realty LLP in Bengaluru with 497 homes, registered with Karnataka RERA. The completion date on RERA is 31 Mar 2028.
Not in the RERA record we collected yet: locality. This page fills in as the record is collected.
Facts collected on 21 Oct 2026 from public records — each linked to its source. Free for buyers. If you book through us, the builder pays us a commission.
East Park Residences buyers’ group: join to ask for a group price
No one has joined yet. Be one of the first 10 buyers in this group — the founding members.
Join free. When enough buyers have joined, our agent partner asks Ramsons Trendsquares Realty LLP for a group price — for example a lower price, an easier payment plan or waived charges. Nothing is promised: you see what the builder offers and book directly with the builder if you want to. Free for buyers. If you book through us, the builder pays us a commission.
- Gathering buyers
- Talking to the builder
- Group offer
- Group site visit
- Booking
0 buyers have joined · 0 committed
Committed buyers have confirmed their budget, home type and timeline with us on a call; builders negotiate with them. Joining is free and never obliges you to buy.
Join the East Park Residences buyers’ groupHow group buying works
See it for yourself
Visit the site with our team, or get a call to clear your questions. Free, no obligation.
Key facts: home types, towers, land and possession
- Home types
- 2.5 BHK, 3 BHK, 3.5 BHK, 4 BHK
- Carpet area
- 282 – 1,602 sq ft
- Towers
- 6
- Floors
- 24
- Total homes
- 497
- Land
- 6.56 acres
- Possession (RERA)
- Mar 2028
- Built (RERA update)
- 71%
East Park Residences RERA number and registration details
- RERA number
- PRM/KA/RERA/1251/310/PR/280224/006657
- Registered on
- 28 Feb 2024
- Promised completion
- 31 Mar 2028
- Extended to
- No extension recorded
- RERA status
- New launch
- Homes booked
- 461 of 497 as on
- Price
- Not found in public records yet: price
- Project type
- Residential
Towers and blocks (RERA filing)
| Tower | Floors | Basements | Homes |
|---|---|---|---|
| A | 24 | 2 | 123 |
| B | 24 | 2 | 100 |
| C | 24 | 2 | 100 |
| D | 24 | 2 | 122 |
| E | 24 | 2 | 100 |
| F | 24 | 2 | 115 |
A dash (—) means the filing did not state that value.
Summary in plain English
East Park Residences is a residential project by Ramsons Trendsquares Realty LLP in Bengaluru South with 497 homes across 6 towers. The project is registered with RERA and has a completion date of 31 March 2028.
Written by AI from the RERA record above on 21 Oct 2026. Every number in it was checked against that record; if anything differs, the record wins.
Open space, home loans, escrow and other details
- Open space
- 81.7% of land
- Water and power
- Water source filed with RERA: BoreWell,Local Authority
- Home loans: approved banks
- Not found in public records yet: bank approvals
- Payment plans
- Not found in public records yet: payment plans
- Maintenance
- Not found in public records yet: maintenance
- Car parking
- Not found in public records yet: car parking charge
- Escrow bank (RERA)
- INDUSIND BANK, MG ROAD BANGALORE
- Building plan (RERA)
- BDA - Bangalore Development Authority · No. 44/2023-24 · dated 5 Jan 2024
- Project cost declared to RERA
- ₹492 Cr
Open area as a share of the land, from the areas filed with RERA (includes driveways and landscaped areas).
Amenities
- Electricity
- CCTV Surveillance
- Club House
- Community Hall
- Outdoor Sports facility
- Indoor Sports facility
- Swimming Pool
- Gym
- Parks
- Power Backup
- Water and Sanitation
Amenities and internal works as filed by the promoter with Karnataka RERA; we have not visited the site.
East Park Residences location and address
- Address
- Proposed Residential Apartment Building at 96/1(P) , Sarjapura Road, Kodathi, Varthur Hobli , Bengaluru South , Bengaluru Urban, Karnataka - 560035
- Village (RERA)
- Not found in public records yet: village
- Locality
- Sarjapur RoadAlso known as Sarjapura Road, Sarjapur Main Road, Sarjapura Main Road
- PIN code
- 560035
- City
- Bengaluru
- State
- Karnataka
- Coordinates
- 12.90037, 77.70926
Distances to landmarks
Not found in public records yet: landmarksAbout Sarjapur Road
Not found in public records yet: locality factsCommute times to tech parks and the airport
| To | Straight line | Peak-hour drive (estimate) |
|---|---|---|
| Outer Ring Road tech corridor (RMZ Ecospace, Bellandur)Map point on OpenStreetMap (opens in a new tab) | 4 km | approx. 16 min |
| Electronic City Phase 1Map point on OpenStreetMap (opens in a new tab) | 7.4 km | approx. 30 min |
| ITPL, Whitefield (main gate)Map point on OpenStreetMap (opens in a new tab) | 10.18 km | approx. 41 min |
| KSR Bengaluru City railway station (Majestic)Map point on OpenStreetMap (opens in a new tab) | 17.44 km | approx. 71 min |
| Manyata Tech ParkMap point on OpenStreetMap (opens in a new tab) | 19.07 km | approx. 77 min |
| Kempegowda International AirportMap point on OpenStreetMap (opens in a new tab) | 33.4 km | approx. 135 min |
How we calculate
Straight line: from the project’s map point on RERA to the destination’s point on OpenStreetMap.
Peak-hour drive is a rough estimate, not a route: straight line × 1.35 for the road network, at 20 km/h. Real times vary a lot with the route and the hour.
Sources:Source (openstreetmap.org) (opens in a new tab)How we calculate this
Schools and hospitals nearby
Within 2 km
- 21Schools and colleges16 schools, 4 colleges, 1 kindergartens
- 9Hospitals and clinics4 hospitals, 5 clinics
Nearest schools and colleges
- St. Jerome's College · 0.55 km
- St Patrick's Academy · 0.73 km
- Sapthagiri Vidya Mandir · 0.86 km
Nearest hospitals and clinics
- Kodathi Primary Health Centre · 0.53 km
- Snehadaan Hospital · 0.72 km
- Camillian Pastoral Health Centre · 0.83 km
Places as mapped on OpenStreetMap (amenity=school, college, kindergarten, university; hospital, clinic), counted within 2 km in a straight line of the RERA map point. Volunteers map these, so some places may be missing or closed. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Nearest metro station and railway
- Embassy Tech Village Kadubeesanahalli (ಕಾಡುಬೀಸನಹಳ್ಳಿ)Blue Line metro, under construction4.25 km
- Prestige Bellandur (ಬೆಳ್ಳಂದೂರ್)Blue Line metro, under construction4.37 km
- Kodibisanahalli (ಕೋಡಿಬೀಸನಹಳ್ಳಿ)Blue Line metro, under construction5.13 km
- Beratena Agrahara (ಬೆರಟೇನ ಅಗ್ರಹಾರ)Open now — nearest operating metro station6.89 km
- Carmelaram (ಕರ್ಮೇಲರಮ್)Nearest railway station0.86 km
Straight-line distances from the RERA map point to the station points mapped on OpenStreetMap; status (open or under construction) as tagged there. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Lake and lake-buffer check
The nearest mapped lake is Chikkabelanduru Kere, 351 m from the project’s RERA map point.
The site boundary is not published as a shape, so its nearest edge can be closer than this point. Whether any building sits inside a lake buffer can only be checked on the approved plan.
- Chikkabelanduru Kere on OpenStreetMap (opens in a new tab) (ಚಿಕ್ಕಬೇಳಂದೂರು ಕೆರೆ)351 m
- Hadosiddapura Lake on OpenStreetMap (opens in a new tab) (ಹಾಡೋಸಿದ್ದಾಪುರ ಕೆರೆ)1,071 m
- Chikka Bellanduru Lake on OpenStreetMap (opens in a new tab) (ಚಿಕ್ಕ ಬೆಳ್ಳಂದೂರು ಕೆರೆ)1,453 m
The buffer rule
Bengaluru’s lake buffer rule has changed over time: the National Green Tribunal ordered a 75 m buffer in May 2016; the Supreme Court set that order aside on 5 March 2019, leaving the 30 m buffer of the Revised Master Plan 2015. Check the current rule and the approved plan before relying on either number.
- LiveLaw: SC sets aside NGT order enlarging buffer zones (2019) (livelaw.in) (opens in a new tab)
- Citizen Matters: Shrinking lake buffers (citizenmatters.in) (opens in a new tab)
Shortest distance from the RERA map point to the mapped water edge (OpenStreetMap water polygons tagged lake or reservoir, or named lake/kere/tank). Mapped shorelines can differ from the revenue-record boundary of a lake. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Sources:Source (openstreetmap.org) (opens in a new tab)Source (livelaw.in) (opens in a new tab)Source (citizenmatters.in) (opens in a new tab)How we calculate this
Satellite time-lapse of the site
Satellite photos load when you scroll to them.
Photos from Esri World Imagery Wayback, centred on the project’s map point; dates are the capture dates in Esri’s metadata. Loaded from Esri when you scroll here.
Sources:Source (livingatlas.arcgis.com) (opens in a new tab)
East Park Residences floor plans, brochure and elevations
Documents the builder uploaded to Karnataka RERA, shown as filed. Tap a page to see it full size; the full PDF opens on the RERA website.

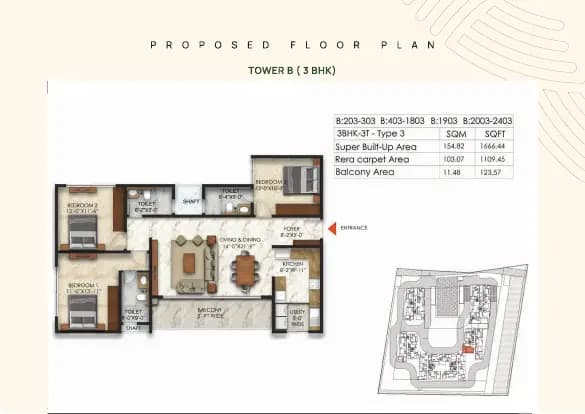

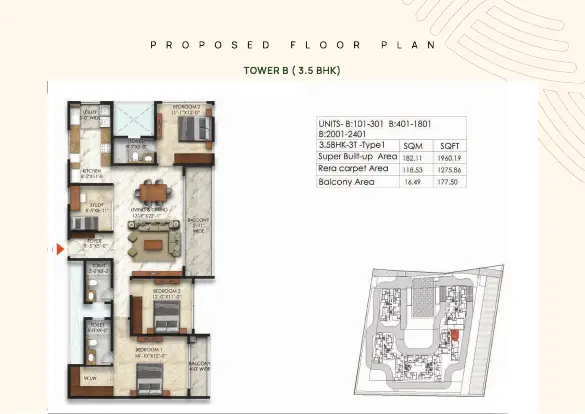

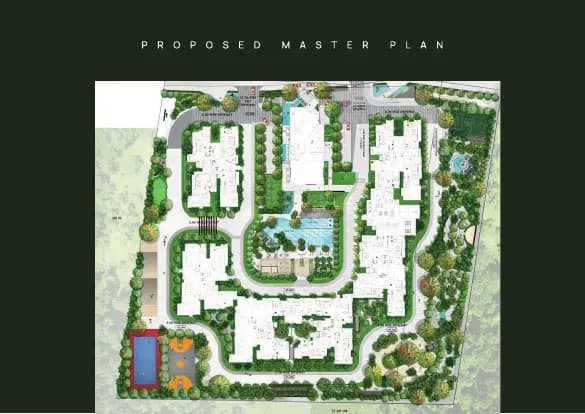

Brochure10 pages

BrochureFull PDF on RERA

Floor plans10 files

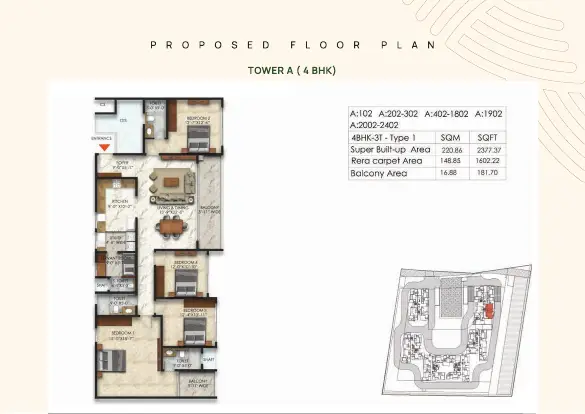

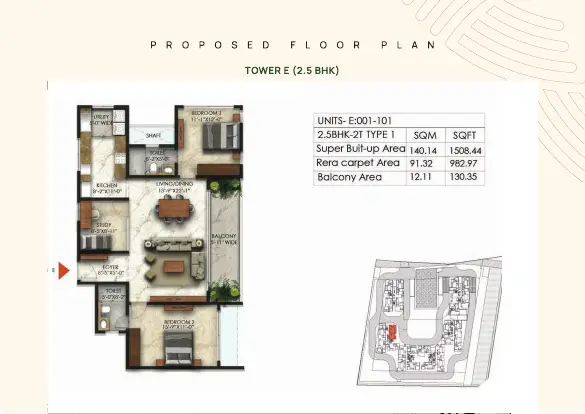

Approved Building/Plotting PlanFull PDF on RERA
11th to 18th and 21st to 24 Floor Plan.pdfFull PDF on RERA

19th Floor Plan.pdfFull PDF on RERA
4th and 10th Floor Plan.pdfFull PDF on RERA

First Floor Plan.pdfFull PDF on RERA

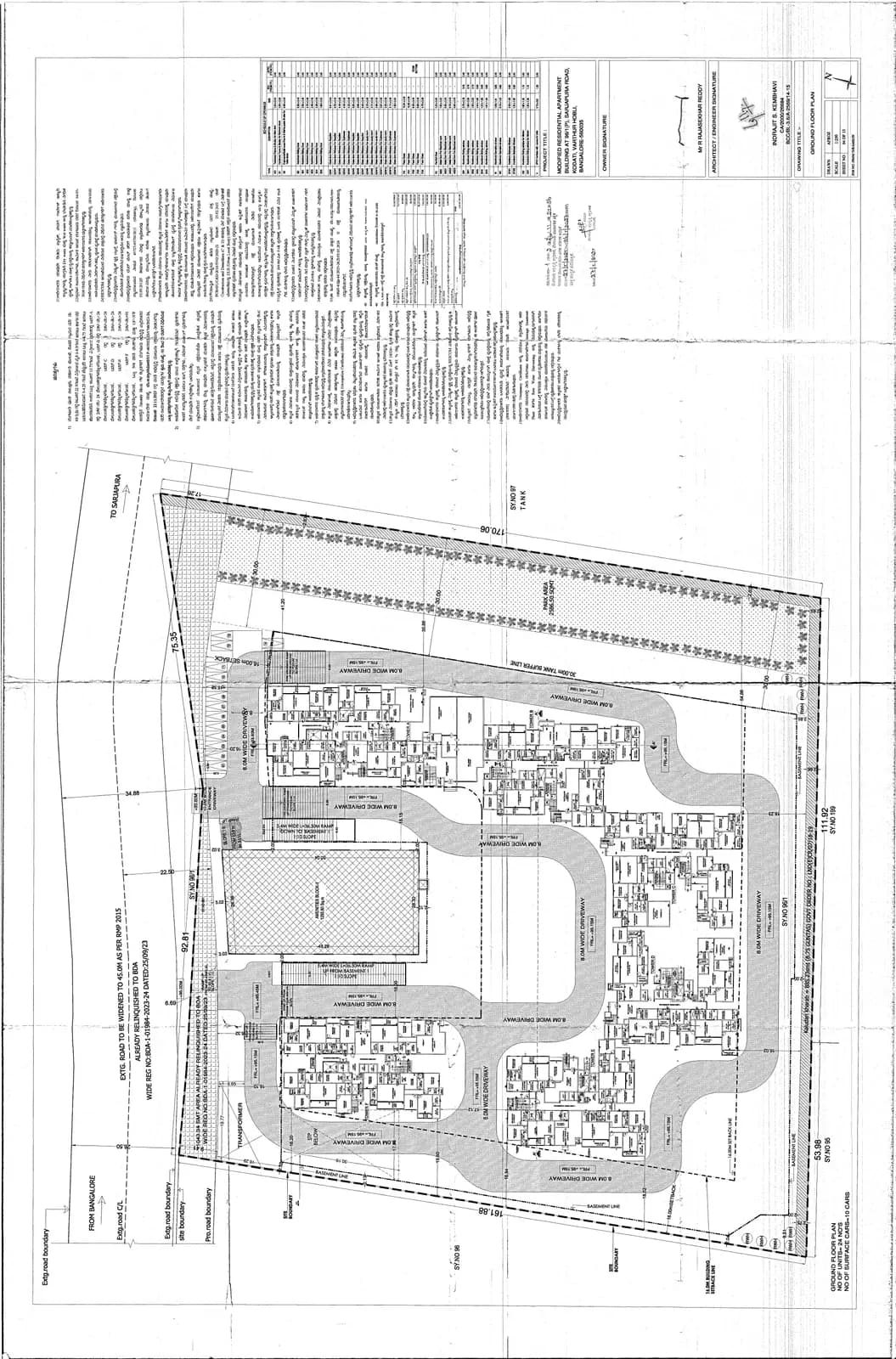

Ground Floor Plan.pdfFull PDF on RERA
Ground Floor Plan.pdfFull PDF on RERA

1st Basement Floor Plan.pdfFull PDF on RERA
2nd Basement Floor Plan.pdfFull PDF on RERA
Terrace Floor Plan.pdfFull PDF on RERA
Approved layout plan2 files

Approved Layout PlanFull PDF on RERA
Existing Layout PlanFull PDF on RERA
| Home type | Carpet area | Homes |
|---|---|---|
| 2.5 BHK | 932 – 1,185 sq ft | 65 |
| 3 BHK | 1,109 – 1,478 sq ft | 165 |
| 3.5 BHK | 1,223 – 1,333 sq ft | 139 |
| 4 BHK | 1,545 – 1,602 sq ft | 83 |
| Ews | 282 – 293 sq ft | 45 |
Home types, counts and carpet areas as filed with Karnataka RERA (carpet area, not super built-up).
We have not collected floor-plan drawings; the builder’s sales team can share them.

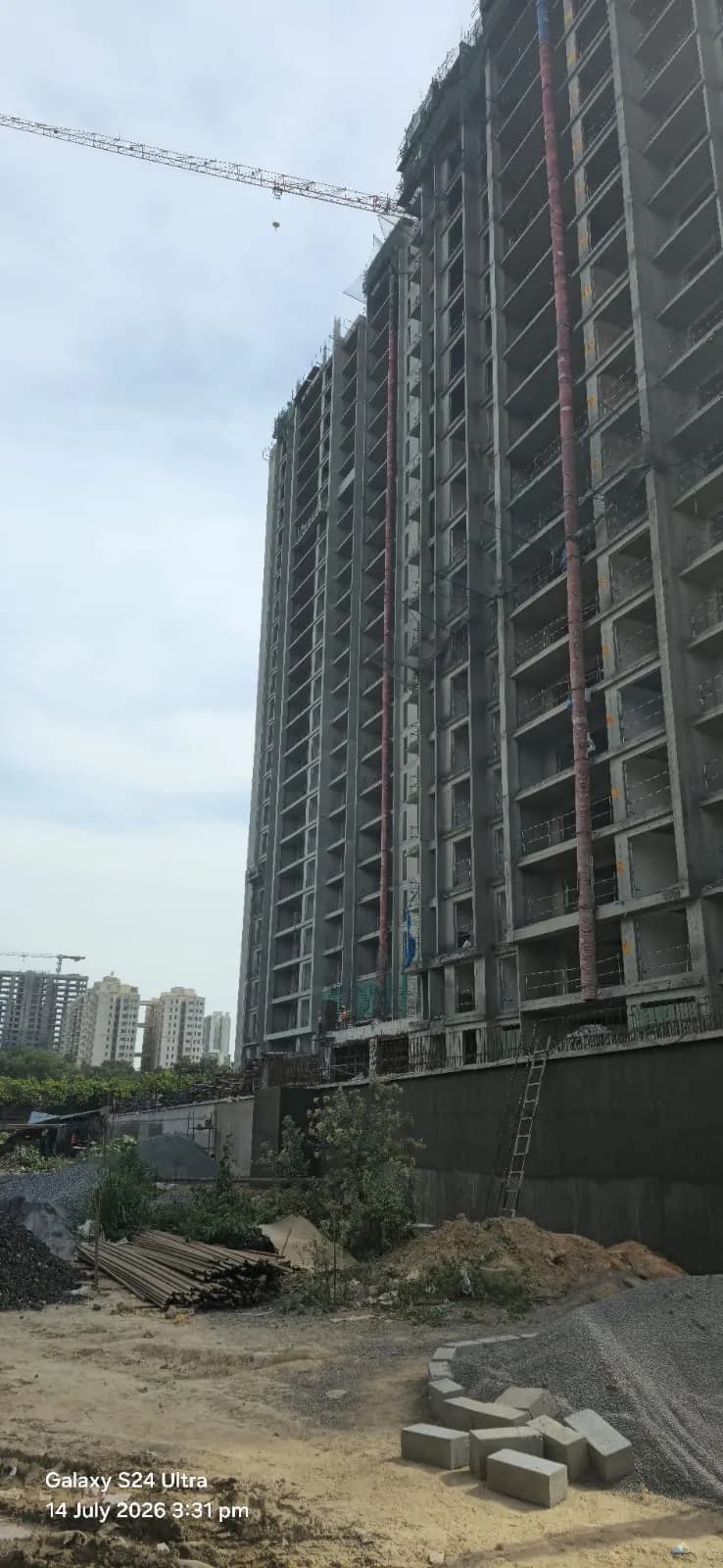

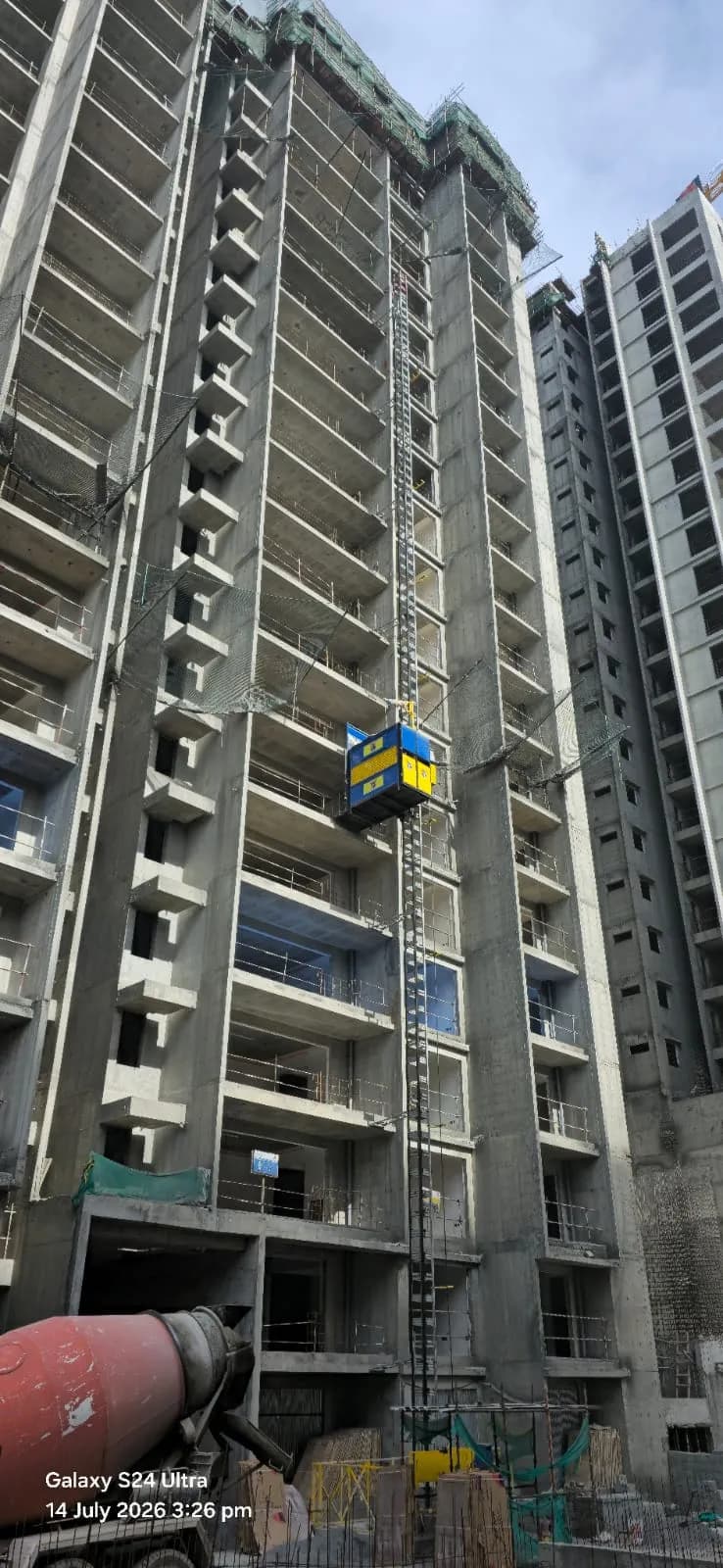

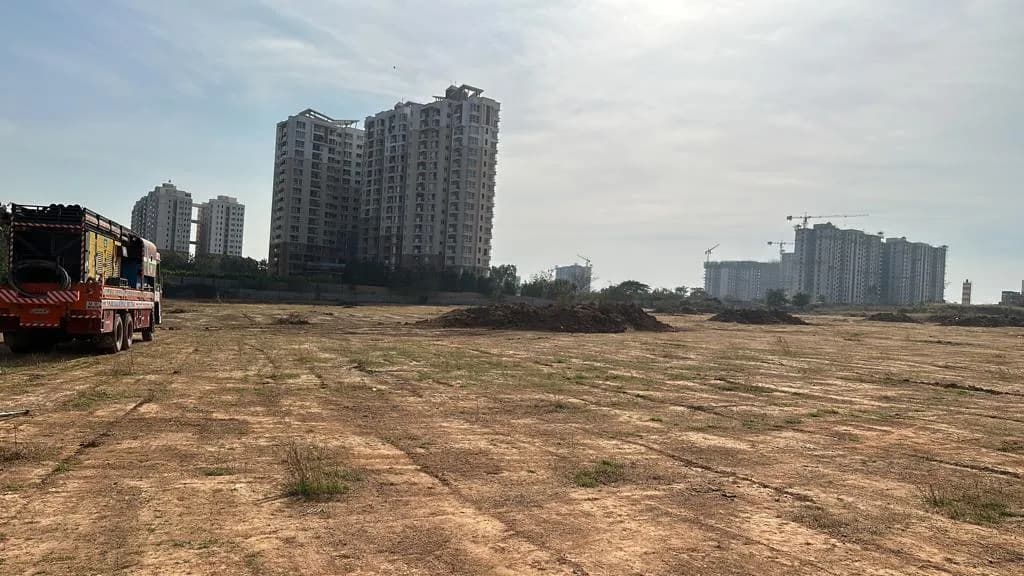

East Park Residences possession date and construction status

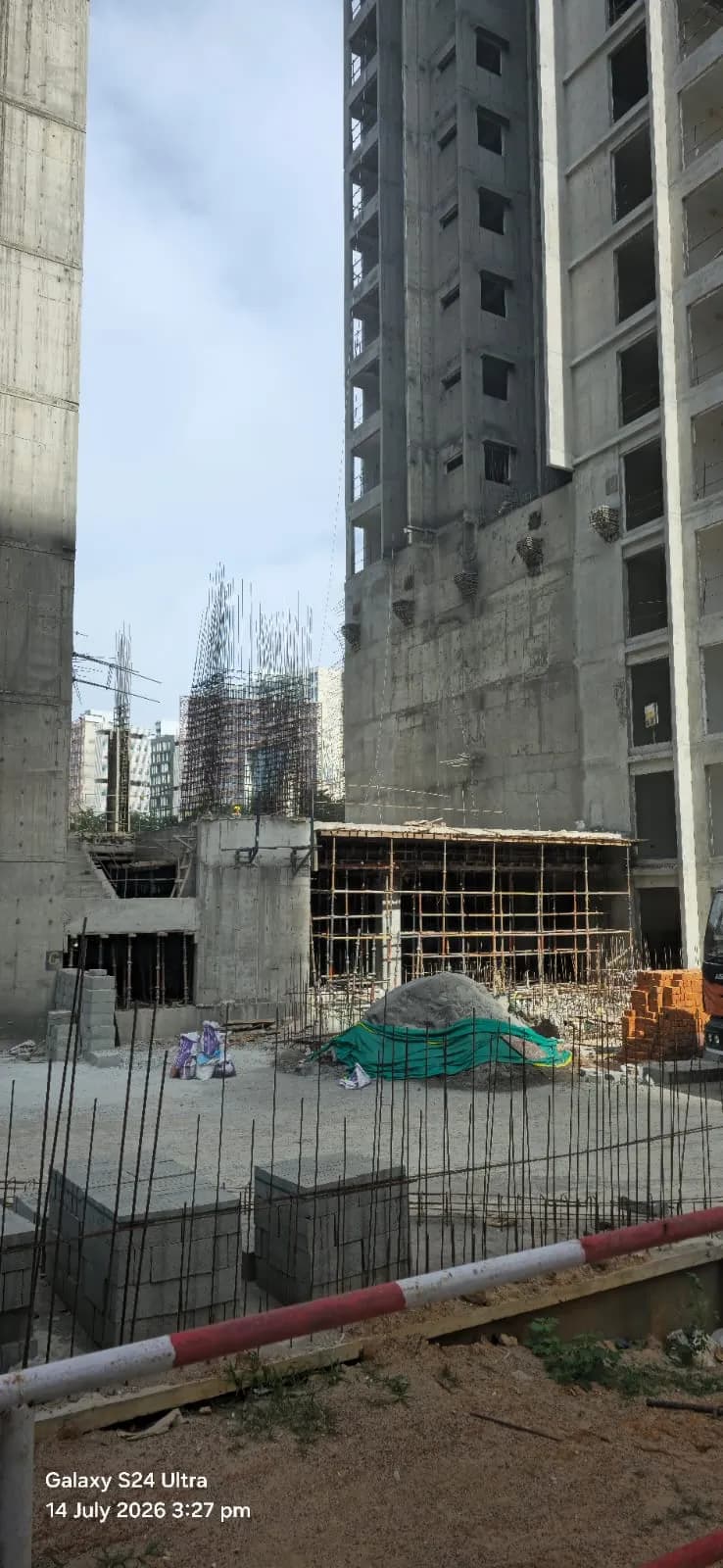

Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-15.
By tower (Q2 2026-27)
Units sold and unsold, from RERA (Q2 2026-27)
| Type | Homes | Booked | Available |
|---|---|---|---|
| 2.5 BHK | 83 | 51 | 32 |
| 3.5 BHK | 182 | 125 | 57 |
| 4 BHK | 142 | 109 | 33 |
| EWS | 60 | 39 | 21 |
| 3 BHK | 193 | 137 | 56 |
As reported by the promoter in the quarterly update to RERA, not verified by us.
Timeline
- 1 Jan 2024Project start date given to RERA
- 28 Feb 2024Registered with Karnataka RERA
- 31 Mar 2028Completion date given at registration
Construction pace from RERA quarterly filings
At the average pace so far, construction would reach 100% around Nov 2027 — about 5 months before the completion date on RERA (31 Mar 2028).
At the pace between the 4 quarterly filings we have (49% → 71% in 9 months), it would be around Sep 2027 — about 6 months before the RERA date.
- Filed on RERA
- Average pace since start
- Pace between filings (and 0% assumed at the start date)
- RERA completion date
Quarterly filings
| Quarter | Filed on | Built | Homes booked |
|---|---|---|---|
| Q2 2026-27to 30 Sep 2026 | 15 Oct 2026 | 71% | 461 of 660 |
| Q1 2026-27to 30 Jun 2026 | 15 Jul 2026 | 67% | 452 of 660 |
| Q4 2025-26to 31 Mar 2026 | 15 Apr 2026 | 63% | 437 of 660 |
| Q3 2025-26to 31 Dec 2025 | 15 Jan 2026 | 49% | 438 of 660 |
How we calculate
Average pace = % built ÷ months since the start date in the RERA record. Here: 71% ÷ 33 months (1 Jan 2024 to 30 Sep 2026) = 2.2% a month.
Estimated finish = latest filing date + (100 − % built) ÷ pace = 30 Sep 2026 + 29 ÷ 2.2 = 13.5 months → Nov 2027. This is an estimate, not a date from the builder or RERA.
Pace between filings = (71% − 49%) ÷ 9 months = 2.5% a month.
A straight line is a simplification: the builder reports one overall %, which mixes excavation, structure and finishing, and work rarely moves at a constant speed. The % values are the promoter’s own figures filed with RERA, not checked by us. Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-15.
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
Approvals and documents checklist
12 rows: approvals. Scroll inside the table to see them all.
| Approval | Authority | Source |
|---|---|---|
| Building plan | BDA - Bangalore Development Authority · No. 44/2023-24 · dated 2024-01-05 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Land conversion | Deputy Commissioner, Bangalore · No. 418/07-08 · dated 2023-02-15 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Commencement Certificate | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Electricity Permission Letter | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Water Permission Letter | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Layout Plan | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Building/Plotting Plan | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Conversion Certificate under section 95 of the KLR Act 1964 | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| ESCOM/Electricity | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KWSSB/Water | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Fire Force Department | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| SEIAA | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
Documents uploaded to RERA
- Building or layout plan · Approved drawings from the planning authorityFiled on RERA ✓ — BDA - Bangalore Development Authority · No. 44/2023-24 · dated 5 Jan 2024
- Commencement certificate · Permission to start buildingFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Environment clearance · SEIAA KarnatakaFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Fire NOC · Karnataka Fire and Emergency ServicesFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Pollution board consent · KSPCBNot on RERA yet
- Water and sewerage · BWSSBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Electricity · BESCOMFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Height clearance · Airports Authority of IndiaNot on RERA yet
- Occupancy certificate (OC) · Issued only when the building is finishedNot on RERA yet — expected at completion
From the documents the promoter uploaded to Karnataka RERA, collected 21 Oct 2026. “Filed” means a document is on RERA — we have not checked its contents or validity. Not every approval applies to every project (for example, smaller projects may not need an environment clearance). The project page on RERA lists each upload.
East Park Residences RERA complaints and orders
2 complaints as on Source (rera.karnataka.gov.in) (opens in a new tab)
| Complaint ref | Filed | Subject | Status | Source |
|---|---|---|---|---|
| 00084/2026 | 5 Feb 2026 | False display/advertisement of brands and technical specifications of construction and fittings to solicit sale | Disposed | Source (rera.karnataka.gov.in) (opens in a new tab) |
| 01156/2024 | 13 Nov 2024 | Selling apartment with wrong information | Disposed | Source (rera.karnataka.gov.in) (opens in a new tab) |
Court and consumer cases
We list case numbers, courts and outcomes only — never names of private individuals.
About Ramsons Trendsquares Realty LLP
- Promoter type
- Partnership Firm
- Projects on this site
- 1
- RERA complaints against promoter
- 2
- Company number (CIN)
- ABZ-0288
From Karnataka RERA, as collected so far (21 Oct 2026). Complaints are those RERA lists against this promoter across all its projects.
Ramsons Trendsquares Realty LLP’s RERA recordRamsons Trendsquares Realty LLP delivery record
- 1Projects in Bengaluru on RERA1 approved registration under Ramsons Trendsquares Realty LLP in Bengaluru Urban and Rural. Source (rera.karnataka.gov.in) (opens in a new tab)
- 497Homes registeredAs stated in each registrations.
- 2RERA complaints0 open, 2 disposed. as on Source (rera.karnataka.gov.in) (opens in a new tab)
- 4Complaints per 1,000 homes2 complaints ÷ 497 homes in its 1 registration on Karnataka RERA in Bengaluru.
What the complaints are about
2 complaint subjects as written on RERA, as on . Each subject is sorted into one group by keywords (first match wins: delay, refund, registration, quality, litigation, association); one complaint often raises several issues. Source (rera.karnataka.gov.in) (opens in a new tab)
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
What’s changed since Jan 2024
- 15 Oct 2026Quarterly update filed for Q2 2026-27: 71% built, 461 of 660 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 15 Jul 2026Quarterly update filed for Q1 2026-27: 67% built, 452 of 660 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 15 Apr 2026Quarterly update filed for Q4 2025-26: 63% built, 437 of 660 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 5 Feb 2026Complaint 00084/2026 filed with RERA: “False display/advertisement of brands and technical specifications of construction and fittings to solicit sale” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 15 Jan 2026Quarterly update filed for Q3 2025-26: 49% built, 438 of 660 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 13 Nov 2024Complaint 01156/2024 filed with RERA: “Selling apartment with wrong information” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 28 Feb 2024Registered with Karnataka RERA (PRM/KA/RERA/1251/310/PR/280224/006657); completion date 31 Mar 2028 Source (rera.karnataka.gov.in) (opens in a new tab)
- 5 Jan 2024Building plan approved by BDA - Bangalore Development Authority (No. 44/2023-24) Source (rera.karnataka.gov.in) (opens in a new tab)
- 1 Jan 2024Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
Newest first. No extension of the completion date is recorded on RERA. When the RERA crawl sees a new filing, complaint or extension, it is added here with its date.
Home loan EMI calculator
- Monthly EMI
- —
- Down payment
- —
- Loan amount
- —
- Total interest
- —
A calculation only, from the numbers you enter — not a loan offer.
All-in cost: GST, registration and other charges
The calculator loads when you scroll to it.
Assumptions
- Base price: the builder’s price is not published in a form we could collect — enter it from the cost sheet.
- GST 5% on the base price and charges — the usual rate for an under-construction home that is not “affordable housing” (1%).
- Stamp duty about 5.6% and registration 2% — the Karnataka rule (registration was raised from 1% to 2% on 31 Aug 2025). Calculated on the agreement value.
- Car parking, other charges and the maintenance deposit are not in the public record we collect; enter them from the builder’s cost sheet.
- Loan on the agreement value (banks usually lend up to 75–90%); EMI is the standard reducing-balance formula. Example rate only — use your bank’s quote.
East Park Residences FAQs
What is the completion date for East Park Residences?
According to the RERA record, the completion date is 31 March 2028.
How many homes are in East Park Residences?
The project has 497 homes in total.
What home types are available in East Park Residences?
The project offers EWS (45 homes), 2.5 BHK (65 homes), 3 BHK (165 homes), 3.5 BHK (139 homes), and 4 BHK (83 homes).
What is the carpet area range for homes in East Park Residences?
Carpet areas range from 282 sq ft for EWS units to 1,602 sq ft for 4 BHK units, depending on the home type.
What is the construction progress of East Park Residences?
As of Q2 2026-27 (quarter ended 30 September 2026), the project is 71% complete.
How many homes are booked in East Park Residences?
As of Q2 2026-27, 461 homes are booked and 660 homes are in the booking table.
Where is East Park Residences located?
The project is located in Bengaluru South taluk, Bengaluru Urban district, PIN code 560035.
What is the RERA registration number for East Park Residences?
The RERA registration number is PRM/KA/RERA/1251/310/PR/280224/006657, registered on 28 February 2024.
How many RERA complaints have been filed against East Park Residences?
There are 2 RERA complaints on this project.
What is the builder's complaint history?
The builder, Ramsons Trendsquares Realty LLP, has 2 RERA complaints across all their projects on record.
Written by AI from the RERA record above on 21 Oct 2026. Answers use only that record; check them against the source before you decide.
Questions about East Park Residences
No questions published yet. Ask the first one: you get an instant answer from this page’s public record, and our team follows up on anything the record does not show.
Bought a home from Ramsons Trendsquares Realty LLP? Review the builder.
Reviews of Ramsons Trendsquares Realty LLP by verified buyers
No verified reviews of Ramsons Trendsquares Realty LLP yet. If you bought a home from them, your review helps other buyers.
How reviews work: only buyers and owners can review; we confirm each purchase by phone before publishing, publish positive and negative reviews alike, never accept payment for reviews, and the builder may reply.
Similar projects within 5 km
| Project | Distance | Homes | Possession (RERA) | Built | Complaints | Price |
|---|---|---|---|---|---|---|
| Sobha AltairSobha Limited | 0.5 km | 207 | May 2031 | 8% | 0 | from ₹3.6 Cr |
| Land Capital PrimeroLandcapital Estates Pvt Ltd | 0.7 km | 65 | Sep 2021extended | — | 0 | Not collected |
| Sobha Royal PavilionSobha Limited | 0.7 km | 2,568 | Jun 2026extended | — | 12 | from ₹1.18 Crabout ₹10,700/sq ft carpet |
| Bandu Eco CrestSnark Developers | 0.8 km | 110 | Dec 2030 | 15% | 0 | Not collected |
| Suvastu Kings Square Phase IIAakrish Infrastructure Pvt Ltd | 0.8 km | 48 | Dec 2029 | — | 1 | Not collected |
| Arvind SylvaArvind SmartSpaces Limited | 0.9 km | 374 | Aug 2031 | 0% | 0 | from ₹2.2 Cr |
Projects of the same kind within 5 km in a straight line of this project’s RERA map point, nearest first. % built is the promoter’s latest quarterly figure on RERA (shown for single-registration projects); prices are from the builder’s own website where we found one.
Sources and last checked dates
Collected on 21 Oct 2026 by AI research agents reading public pages. Facts are written in our own words. Not found yet: price; court cases; landmarks; specifications; news.
How to check on RERA: On rera.karnataka.gov.in/viewAllProjects, type the registration number in 'Registration No', press Search, then click the 'View Project Details' icon. Complaints open from the 'Complaints / Litigation' icon in the same row. Registration number: PRM/KA/RERA/1251/310/PR/280224/006657.
- RERA record last checked: 21 Oct 2026
- Last change in the record (registration, quarterly filing or complaint): 21 Oct 2026
How this page is made: software builds it from public records (Karnataka RERA filings, OpenStreetMap, the builder’s own website). AI is used only to read filings into fields and to write the plain-English summary and FAQ answers, which are checked against the record. Facts are checked automatically against the RERA filing. Methodology · How we earn · Report an error
More new projects in Sarjapur Road
Doddakanelli, Sarjapur RoadReady to moveRERA registeredBuyers’ group openLand Capital Primero
by Landcapital Estates
Price: Price on requestGet brochure & price →
- 2 BHK, 2.5 BHK, 3 BHK
- 721 – 13,089 sq ft
- Sep 2021 (extended)
65 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Land Capital Primero
Doddakannelli, Sarjapur RoadUnder constructionRERA registeredBuyers’ group openSatori Residence By Genurise
by Max Global
Price: Price on requestGet brochure & price →
- 2 BHK, 2.5 BHK, 3 BHK, 3.5 BHK, +1 more
- 728 – 1,925 sq ft
- Jun 2030
161 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Satori Residence By Genurise
Bhoganahalli, Sarjapur RoadUnder constructionRERA registeredBuyers’ group openGalaxy Tower
by Ashish Kumar
Price: Price on requestGet brochure & price →
- 3 BHK
- 1,046 – 1,098 sq ft
- Jun 2028
24 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Galaxy Tower
