Godrej Ananda Phase 2
2 & 3 BHK apartments by Godrej Properties Limited · Bagalur, Bengaluru
Bagalur, BengaluruOpen on Google Maps (opens in a new tab)
- Under construction
- RERA registered
- residential
by Godrej Properties Limited · registered with RERA by Universal Metro Properties LLP
Price: Price on request

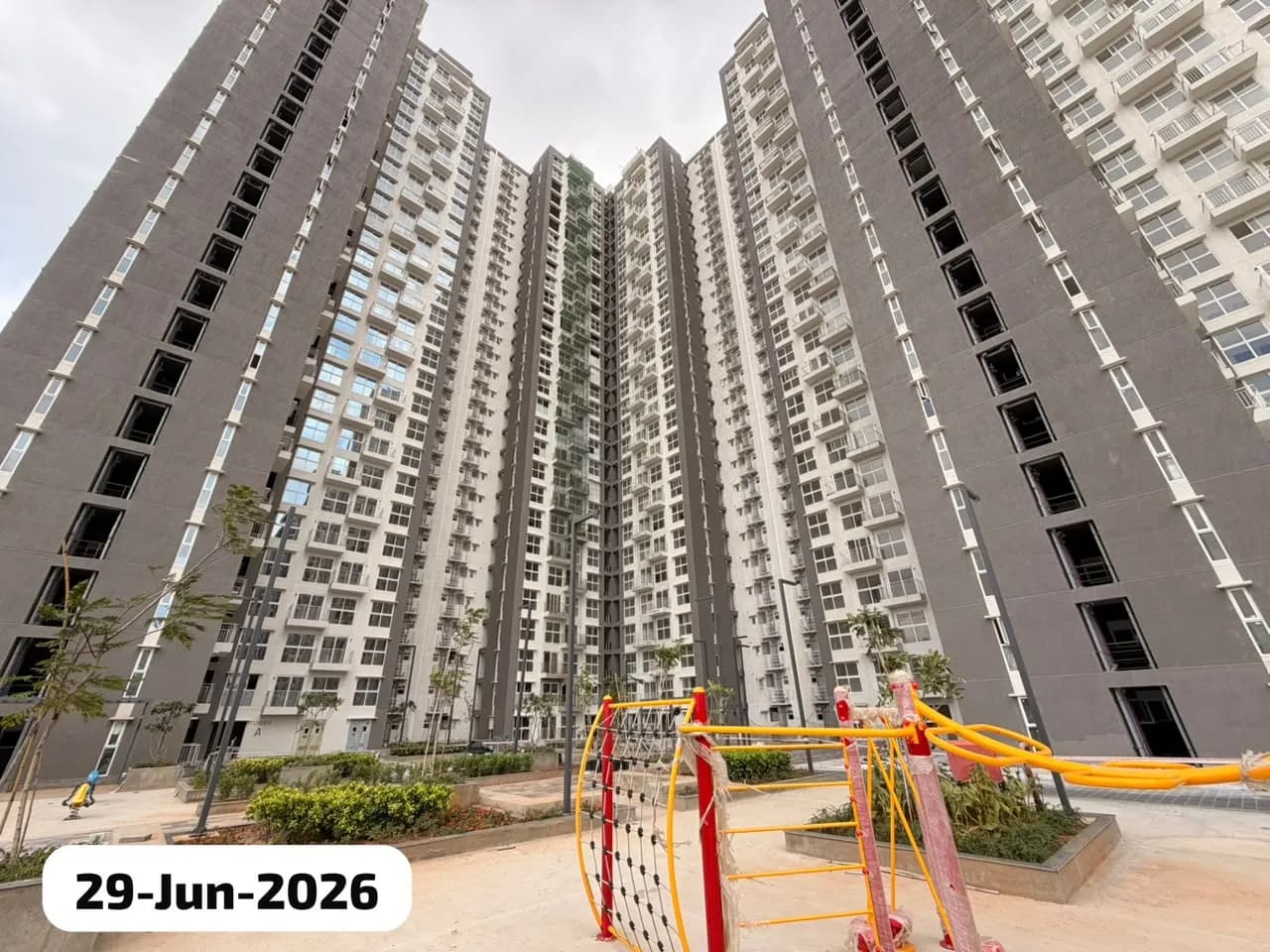

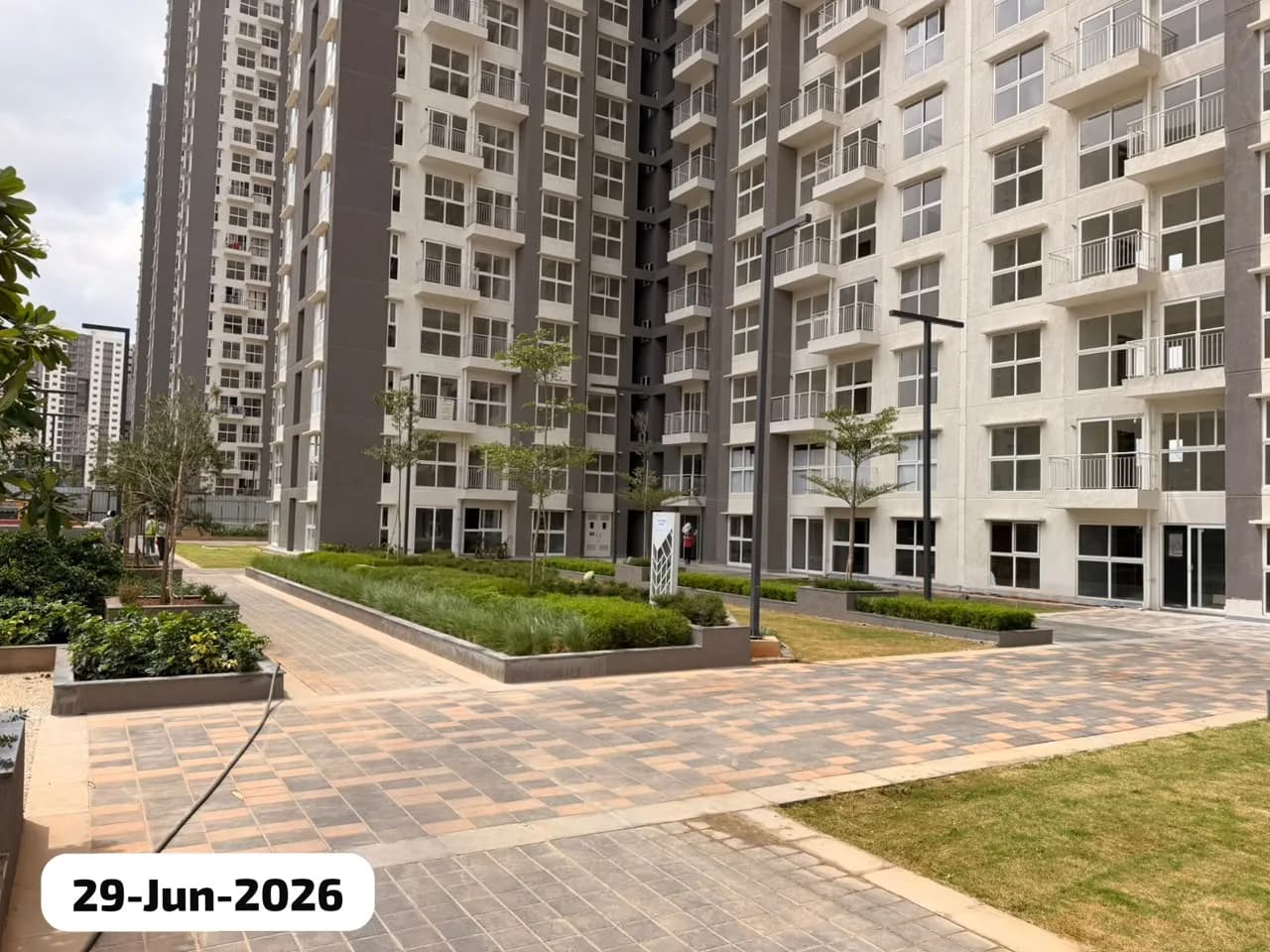

Site photo filed with Karnataka RERA Karnataka RERA filing · Source ↗ (opens in a new tab)
Godrej Ananda Phase 2 at a glance
- Possession (RERA)Jun 2027Karnataka RERA
- Construction99% built · on pace for Oct 2026RERA filing to 30 Sep 2026; estimate from average pace
- Homes booked1,028 of 1,037 (99%)RERA update · as on 30 Sep 2026
- RERA complaints (project)None listedKarnataka RERA · as on 22 Oct 2026
- Approvals filed7 of 9 on RERAKarnataka RERA uploads · 22 Oct 2026
- Nearest metroKIAL Terminals · 15.89 km (under construction)Open now: Whitefield (Kadugodi), 20.51 km · straight line · OpenStreetMap, 5 Oct 2026
- Airport driveapprox. 68 min at peak16.86 km straight line · estimate
Project summary
Godrej Ananda Phase 2 is a residential project by Godrej Properties Limited in Bagalur, Bengaluru with 1,037 homes, registered with Karnataka RERA. The completion date on RERA is 21 Jun 2027.
Facts collected on 22 Oct 2026 from public records — each linked to its source. Free for buyers. If you book through us, the builder pays us a commission.
Godrej Ananda Phase 2 buyers’ group: join to ask for a group price
No one has joined yet. Be one of the first 10 buyers in this group — the founding members.
Join free. When enough buyers have joined, our agent partner asks Godrej Properties Limited for a group price — for example a lower price, an easier payment plan or waived charges. Nothing is promised: you see what the builder offers and book directly with the builder if you want to. Free for buyers. If you book through us, the builder pays us a commission.
- Gathering buyers
- Talking to the builder
- Group offer
- Group site visit
- Booking
0 buyers have joined · 0 committed
Committed buyers have confirmed their budget, home type and timeline with us on a call; builders negotiate with them. Joining is free and never obliges you to buy.
Join the Godrej Ananda Phase 2 buyers’ groupHow group buying works
See it for yourself
Visit the site with our team, or get a call to clear your questions. Free, no obligation.
Key facts: home types, towers, land and possession
- Home types
- Studio, 2 BHK, 3 BHK
- Carpet area
- 231 – 703 sq ft
- Towers
- 4
- Floors
- 28
- Total homes
- 1,037
- Land
- 4.03 acres
- Possession (RERA)
- Jun 2027
- Built (RERA update)
- 99%
Godrej Ananda Phase 2 RERA number and registration details
- RERA number
- PRM/KA/RERA/1251/309/PR/280922/005282
- Registered on
- 28 Sep 2022
- Promised completion
- 21 Jun 2027
- Extended to
- No extension recorded
- RERA status
- New launch
- Homes booked
- 1,028 of 1,037 as on
- Price
- Not found in public records yet: price
- Project type
- Residential
Towers and blocks (RERA filing)
| Tower | Floors | Basements | Homes |
|---|---|---|---|
| TOWER 1 | 28 | 3 | 202 |
| Tower 2 | 28 | 3 | 288 |
| Tower 3 | 28 | 3 | 288 |
| Tower 4 | 28 | 3 | 259 |
A dash (—) means the filing did not state that value.
Summary in plain English
Godrej Ananda Phase 2 is a residential project by Universal Metro Properties LLP in Bagalur, Bengaluru North with 1,037 homes across 4 towers. The project is registered on Karnataka RERA and scheduled for completion on 21 June 2027.
Written by AI from the RERA record above on 22 Oct 2026. Every number in it was checked against that record; if anything differs, the record wins.
Open space, home loans, escrow and other details
- Open space
- 83.1% of land
- Water and power
- Water source filed with RERA: BWSSB
- Home loans: approved banks
- Not found in public records yet: bank approvals
- Payment plans
- Not found in public records yet: payment plans
- Maintenance
- Not found in public records yet: maintenance
- Car parking
- Not found in public records yet: car parking charge
- Escrow bank (RERA)
- Axis Bank, Majestic Branch
- Building plan (RERA)
- KIADB - Karnataka Industrial Areas Development Board · No. IADB/DO & EE-3/Plot No.R-10/Hardware Sector / 2022-23 · dated 24 May 2022
- Project cost declared to RERA
- ₹342 Cr
Open area as a share of the land, from the areas filed with RERA (includes driveways and landscaped areas).
Amenities
- Electricity
- CCTV Surveillance
- Club House
- Community Hall
- Outdoor Sports facility
- Indoor Sports facility
- Swimming Pool
- Gym
- Parks
- Power Backup
- Water and Sanitation
Amenities and internal works as filed by the promoter with Karnataka RERA; we have not visited the site.
Godrej Ananda Phase 2 location and address
- Address
- Plot No. R-10 of (Hardware Housing Sector) Hi-Tech, Defence & Aerospace Park, Bengaluru, bearing Survey No. 176 (Block No. 4,5,6,7,8,9,10,11,12 & 13) , 177 (Block No. 15,16,17,18,19,20 & 23) and 484 of Bagalur Village, Jala Hobli, Banaglore North Taluk, Bengaluru Urban District. , Bengaluru North , Bengaluru Urban, Karnataka - 562149
- Village (RERA)
- Bagalur
- Locality
- BagalurAlso known as Bagaluru, Aerospace Park
- PIN code
- 562149
- City
- Bengaluru
- State
- Karnataka
- Coordinates
- 13.15528, 77.85295
Distances to landmarks
Not found in public records yet: landmarksAbout Bagalur
Not found in public records yet: locality factsCommute times to tech parks and the airport
| To | Straight line | Peak-hour drive (estimate) |
|---|---|---|
| Kempegowda International AirportMap point on OpenStreetMap (opens in a new tab) | 16.86 km | approx. 68 min |
| ITPL, Whitefield (main gate)Map point on OpenStreetMap (opens in a new tab) | 22.43 km | approx. 91 min |
| Manyata Tech ParkMap point on OpenStreetMap (opens in a new tab) | 27.91 km | approx. 113 min |
| Outer Ring Road tech corridor (RMZ Ecospace, Bellandur)Map point on OpenStreetMap (opens in a new tab) | 31.77 km | approx. 129 min |
| KSR Bengaluru City railway station (Majestic)Map point on OpenStreetMap (opens in a new tab) | 36.47 km | approx. 148 min |
| Electronic City Phase 1Map point on OpenStreetMap (opens in a new tab) | 39.62 km | approx. 160 min |
How we calculate
Straight line: from the project’s map point on RERA to the destination’s point on OpenStreetMap.
Peak-hour drive is a rough estimate, not a route: straight line × 1.35 for the road network, at 20 km/h. Real times vary a lot with the route and the hour.
Sources:Source (openstreetmap.org) (opens in a new tab)How we calculate this
Nearest metro station and railway
- KIAL Terminals (ಕೆಐಎಬಿ ವಿಮಾನ ನಿಲ್ದಾಣ ಟರ್ಮಿನಲ್ಸ್)Blue Line metro, under construction15.89 km
- Airport City (ವಿಮಾನ ನಿಲ್ದಾಣ ನಗರ)Blue Line metro, under construction18.6 km
- Whitefield (Kadugodi) (ವೈಟ್ಫೀಲ್ಡ್ (ಕಾಡುಗೋಡಿ))Open now — nearest operating metro station20.51 km
- Devanahalli (ದೇವನಹಳ್ಳಿ)Nearest railway station18.98 km
Straight-line distances from the RERA map point to the station points mapped on OpenStreetMap; status (open or under construction) as tagged there. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Satellite time-lapse of the site
Satellite photos load when you scroll to them.
Photos from Esri World Imagery Wayback, centred on the project’s map point; dates are the capture dates in Esri’s metadata. Loaded from Esri when you scroll here.
Sources:Source (livingatlas.arcgis.com) (opens in a new tab)
Godrej Ananda Phase 2 floor plans, brochure and elevations
Documents the builder uploaded to Karnataka RERA, shown as filed. Tap a page to see it full size; the full PDF opens on the RERA website.
Brochure18 pages

BrochureFull PDF on RERA

Approved layout plan

Approved Layout PlanFull PDF on RERA
| Home type | Carpet area | Homes |
|---|---|---|
| 2 BHK | 231 – 595 sq ft | 701 |
| 2 BHK type 01a | 536 sq ft | 209 |
| 2 BHK type 01b | 536 sq ft | 196 |
| 2 BHK type 02a | 530 sq ft | 60 |
| 2 BHK type 02b | 530 sq ft | 56 |
| 2 BHK type 03a | 582 sq ft | 75 |
| 2 BHK type 03b | 580 sq ft | 70 |
| 2 BHK type 03c | 581 sq ft | 15 |
| 2 BHK type 03d | 580 sq ft | 14 |
| 2 BHK type 04 | 594 sq ft | 6 |
| 3 BHK | 702 – 703 sq ft | 168 |
| 3 BHK type 01a | 702 sq ft | 84 |
| 3 BHK type 01b | 703 sq ft | 84 |
| Studio | 231 – 530 sq ft | 168 |
Home types, counts and carpet areas as filed with Karnataka RERA (carpet area, not super built-up).
We have not collected floor-plan drawings; the builder’s sales team can share them.
Godrej Ananda Phase 2 possession date and construction status
Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-15.
By tower (Q2 2026-27)
Units sold and unsold, from RERA (Q2 2026-27)
| Type | Homes | Booked | Available |
|---|---|---|---|
| 2 BHK | 701 | 692 | 9 |
| STUDIO | 168 | 168 | 0 |
| 3 BHK | 168 | 168 | 0 |
As reported by the promoter in the quarterly update to RERA, not verified by us.
Timeline
- 22 Jun 2022Project start date given to RERA
- 28 Sep 2022Registered with Karnataka RERA
- 21 Jun 2027Completion date given at registration
Construction pace from RERA quarterly filings
At the average pace so far, construction would reach 100% around Oct 2026 — about 8 months before the completion date on RERA (21 Jun 2027).
At the pace between the 4 quarterly filings we have (91% → 99% in 9 months), it would be around Nov 2026 — about 8 months before the RERA date.
- Filed on RERA
- Average pace since start
- Pace between filings (and 0% assumed at the start date)
- RERA completion date
Quarterly filings
| Quarter | Filed on | Built | Homes booked |
|---|---|---|---|
| Q2 2026-27to 30 Sep 2026 | 15 Oct 2026 | 99% | 1,028 of 1,037 |
| Q1 2026-27to 30 Jun 2026 | 13 Jul 2026 | 97% | 1,028 of 1,037 |
| Q4 2025-26to 31 Mar 2026 | 14 Apr 2026 | 95% | 1,027 of 1,037 |
| Q3 2025-26to 31 Dec 2025 | 14 Jan 2026 | 91% | 1,028 of 1,037 |
How we calculate
Average pace = % built ÷ months since the start date in the RERA record. Here: 99% ÷ 51.3 months (22 Jun 2022 to 30 Sep 2026) = 1.9% a month.
Estimated finish = latest filing date + (100 − % built) ÷ pace = 30 Sep 2026 + 1 ÷ 1.9 = 0.5 months → Oct 2026. This is an estimate, not a date from the builder or RERA.
Pace between filings = (99% − 91%) ÷ 9 months = 0.9% a month.
A straight line is a simplification: the builder reports one overall %, which mixes excavation, structure and finishing, and work rarely moves at a constant speed. The % values are the promoter’s own figures filed with RERA, not checked by us. Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-15.
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
Approvals and documents checklist
11 rows: approvals. Scroll inside the table to see them all.
| Approval | Authority | Source |
|---|---|---|
| Building plan | KIADB - Karnataka Industrial Areas Development Board · No. IADB/DO & EE-3/Plot No.R-10/Hardware Sector / 2022-23 · dated 2022-05-24 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Electricity Permission Letter | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Water Permission Letter | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Layout Plan | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Building/Plotting Plan | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| ESCOM/Electricity | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KWSSB/Water | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Fire Force Department | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Airport Authority of India | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KSPCB | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| SEIAA | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
Documents uploaded to RERA
- Building or layout plan · Approved drawings from the planning authorityFiled on RERA ✓ — KIADB - Karnataka Industrial Areas Development Board · No. IADB/DO & EE-3/Plot No.R-10/Hardware Sector / 2022-23 · dated 24 May 2022
- Commencement certificate · Permission to start buildingNot on RERA yet
- Environment clearance · SEIAA KarnatakaFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Fire NOC · Karnataka Fire and Emergency ServicesFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Pollution board consent · KSPCBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Water and sewerage · BWSSBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Electricity · BESCOMFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Height clearance · Airports Authority of IndiaFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Occupancy certificate (OC) · Issued only when the building is finishedNot on RERA yet — expected at completion
From the documents the promoter uploaded to Karnataka RERA, collected 22 Oct 2026. “Filed” means a document is on RERA — we have not checked its contents or validity. Not every approval applies to every project (for example, smaller projects may not need an environment clearance). The project page on RERA lists each upload.
Godrej Ananda Phase 2 RERA complaints
No complaints listed on Karnataka RERA for this registration as on Source (rera.karnataka.gov.in) (opens in a new tab)
Court and consumer cases
We list case numbers, courts and outcomes only — never names of private individuals.
About Godrej Properties Limited
- Promoter type
- Other ( limited liability Partnership )
- Projects on this site
- 20
- RERA complaints against promoter
- 65
- Company number (CIN)
- Not found in public records yet: CIN
From Karnataka RERA, as collected so far (22 Oct 2026). Complaints are those RERA lists against this promoter across all its projects.
Godrej Properties Limited’s RERA recordGodrej Properties Limited delivery record
- 20Projects in Bengaluru on RERA26 approved registrations under Godrej Properties Limited in Bengaluru Urban and Rural. Source (rera.karnataka.gov.in) (opens in a new tab)
- 21,984Homes and plots registeredAs stated in each registrations.
- 65RERA complaints33 open, 32 disposed. as on Source (rera.karnataka.gov.in) (opens in a new tab)
- 3Complaints per 1,000 homes and plots65 complaints ÷ 21,984 homes and plots in its 26 registrations on Karnataka RERA in Bengaluru.
What the complaints are about
65 complaint subjects as written on RERA, as on . Each subject is sorted into one group by keywords (first match wins: delay, refund, registration, quality, litigation, association); one complaint often raises several issues. Source (rera.karnataka.gov.in) (opens in a new tab)
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
What’s changed since May 2022
- 15 Oct 2026Quarterly update filed for Q2 2026-27: 99% built, 1,028 of 1,037 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 13 Jul 2026Quarterly update filed for Q1 2026-27: 97% built, 1,028 of 1,037 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 14 Apr 2026Quarterly update filed for Q4 2025-26: 95% built, 1,027 of 1,037 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 14 Jan 2026Quarterly update filed for Q3 2025-26: 91% built, 1,028 of 1,037 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 28 Sep 2022Registered with Karnataka RERA (PRM/KA/RERA/1251/309/PR/280922/005282); completion date 21 Jun 2027 Source (rera.karnataka.gov.in) (opens in a new tab)
- 22 Jun 2022Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
- 24 May 2022Building plan approved by KIADB - Karnataka Industrial Areas Development Board (No. IADB/DO & EE-3/Plot No.R-10/Hardware Sector / 2022-23) Source (rera.karnataka.gov.in) (opens in a new tab)
Newest first. No extension of the completion date is recorded on RERA. When the RERA crawl sees a new filing, complaint or extension, it is added here with its date.
Home loan EMI calculator
- Monthly EMI
- —
- Down payment
- —
- Loan amount
- —
- Total interest
- —
A calculation only, from the numbers you enter — not a loan offer.
All-in cost: GST, registration and other charges
The calculator loads when you scroll to it.
Assumptions
- Base price: the builder’s price is not published in a form we could collect — enter it from the cost sheet.
- GST 5% on the base price and charges — the usual rate for an under-construction home that is not “affordable housing” (1%).
- Stamp duty about 5.6% and registration 2% — the Karnataka rule (registration was raised from 1% to 2% on 31 Aug 2025). Calculated on the agreement value.
- Car parking, other charges and the maintenance deposit are not in the public record we collect; enter them from the builder’s cost sheet.
- Loan on the agreement value (banks usually lend up to 75–90%); EMI is the standard reducing-balance formula. Example rate only — use your bank’s quote.
Godrej Ananda Phase 2 FAQs
What is the completion date for Godrej Ananda Phase 2?
The project is scheduled for completion on 21 June 2027 according to the RERA record.
How many homes are in Godrej Ananda Phase 2?
The project has 1,037 homes across 4 towers with a maximum of 28 floors.
What home types are available in Godrej Ananda Phase 2?
The project offers studios, 2 BHK and 3 BHK homes. Carpet areas range from 231 sq ft for studios to 703 sq ft for 3 BHK homes.
What is the RERA registration number for Godrej Ananda Phase 2?
The RERA registration number is PRM/KA/RERA/1251/309/PR/280922/005282, registered on 28 September 2022.
Where is Godrej Ananda Phase 2 located?
The project is located in Bagalur, Bengaluru North taluk, Bengaluru Urban district, PIN code 562149.
What is the construction progress of Godrej Ananda Phase 2?
As of Q2 2026-27 ending 30 September 2026, the project is 99 percent complete.
How many homes are booked in Godrej Ananda Phase 2?
As of Q2 2026-27, 1,028 homes have been booked out of 1,037 total homes.
Are there any RERA complaints against Godrej Ananda Phase 2?
There are no complaints filed against this project on the RERA record.
What is the builder's history with other projects?
Universal Metro Properties LLP has 3 projects on record in Bengaluru with 3 complaints filed against the builder across all projects.
What is the land area of Godrej Ananda Phase 2?
The land area is 16,314 sq meters according to the RERA registration.
Written by AI from the RERA record above on 22 Oct 2026. Answers use only that record; check them against the source before you decide.
Questions about Godrej Ananda Phase 2
No questions published yet. Ask the first one: you get an instant answer from this page’s public record, and our team follows up on anything the record does not show.
Bought a home from Godrej Properties Limited? Review the builder.
Reviews of Godrej Properties Limited by verified buyers
No verified reviews of Godrej Properties Limited yet. If you bought a home from them, your review helps other buyers.
How reviews work: only buyers and owners can review; we confirm each purchase by phone before publishing, publish positive and negative reviews alike, never accept payment for reviews, and the builder may reply.
Sources and last checked dates
Collected on 22 Oct 2026 by AI research agents reading public pages. Facts are written in our own words. Not found yet: price; court cases; landmarks; specifications; news.
How to check on RERA: On rera.karnataka.gov.in/viewAllProjects, type the registration number in 'Registration No', press Search, then click the 'View Project Details' icon. Complaints open from the 'Complaints / Litigation' icon in the same row. Registration number: PRM/KA/RERA/1251/309/PR/280922/005282.
- RERA record last checked: 22 Oct 2026
- Last change in the record (registration, quarterly filing or complaint): 22 Oct 2026
How this page is made: software builds it from public records (Karnataka RERA filings, OpenStreetMap, the builder’s own website). AI is used only to read filings into fields and to write the plain-English summary and FAQ answers, which are checked against the record. Facts are checked automatically against the RERA filing. Methodology · How we earn · Report an error
More new projects in Bagalur
Bagaluru, BagalurUnder constructionRERA registeredBuyers’ group openEmerald & Luminaire Block at Brigade El Dorado
by Brigade Enterprises
Price: Price on requestGet brochure & price →
- 1 BHK, 2 BHK, 3 BHK
- 388 – 997 sq ft
- Dec 2026
1,236 homes · 2 RERA complaints
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Emerald & Luminaire Block at Brigade El Dorado
Bagluru, BagalurUnder constructionRERA registeredBuyers’ group openAurum at Brigade El Dorado
by Brigade Enterprises
Price: Price on requestGet brochure & price →
- 1 BHK, 2 BHK, 3 BHK
- 388 – 997 sq ft
- Dec 2027
635 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Aurum at Brigade El Dorado
Bagluru, BagalurUnder constructionRERA registeredBuyers’ group openCobalt at Brigade El Dorado
by Brigade Enterprises
Price: Price on requestGet brochure & price →
- 1 BHK
- 323 sq ft
- Jun 2029
948 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Cobalt at Brigade El Dorado
