Cobalt at Brigade El Dorado

1 BHK apartments by Brigade Enterprises Ltd · Bagluru, Bagalur, Bengaluru

Bagluru, Bagalur, BengaluruOpen on Google Maps (opens in a new tab)

  • Under construction
  • RERA registered
  • residential

by Brigade Enterprises Ltd · registered with RERA by Brigade Tetrarch Private Limited

Price: Price on request

Get brochure, floor plans & price

Brochure, floor plans and price list for Cobalt at Brigade El Dorado

Builders share their brochure, floor plans and price list only on request. Tell us how to reach you and we’ll get them and send them to you, free.

Free for buyers. If you book through us, the builder pays us a commission. How we earn

Project summary

Cobalt at Brigade El Dorado is a residential project by Brigade Enterprises Ltd in Bagluru, Bengaluru with 948 homes, registered with Karnataka RERA. The completion date on RERA is 30 Jun 2029.

Facts collected on 21 Oct 2026 from public records — each linked to its source. Free for buyers. If you book through us, the builder pays us a commission.

Cobalt at Brigade El Dorado buyers’ group: join to ask for a group price

No one has joined yet. Be one of the first 10 buyers in this group — the founding members.

Join free. When enough buyers have joined, our agent partner asks Brigade Enterprises Ltd for a group price — for example a lower price, an easier payment plan or waived charges. Nothing is promised: you see what the builder offers and book directly with the builder if you want to. Free for buyers. If you book through us, the builder pays us a commission.

  1. Gathering buyers
  2. Talking to the builder
  3. Group offer
  4. Group site visit
  5. Booking

0 buyers have joined · 0 committed

Committed buyers have confirmed their budget, home type and timeline with us on a call; builders negotiate with them. Joining is free and never obliges you to buy.

Join the Cobalt at Brigade El Dorado buyers’ groupHow group buying works

See it for yourself

Visit the site with our team, or get a call to clear your questions. Free, no obligation.

Key facts: home types, towers, land and possession

Updated on 21 Oct 2026
Home types
1 BHK
Carpet area
323 sq ft
Towers
1
Floors
22
Total homes
948
Land
3.36 acres
Possession (RERA)
Jun 2029
Built (RERA update)
70%

Cobalt at Brigade El Dorado RERA number and registration details

RERA number
PRM/KA/RERA/1251/309/PR/160524/006878
Registered on
16 May 2024
Promised completion
30 Jun 2029
Extended to
No extension recorded
RERA status
New launch
Homes booked
946 of 948 as on
Price
Not found in public records yet: price
Project type
Residential

Towers and blocks (RERA filing)

TowerFloorsBasementsHomes
Cobalt at Brigade El Dorado222948

A dash (—) means the filing did not state that value.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Summary in plain English

Cobalt at Brigade El Dorado is a residential project by Brigade Tetrarch Private Limited in Bagluru, Bengaluru North. The project has 948 homes in 1 tower with 22 floors, all 1 BHK units. The completion date on RERA is 30 June 2029.

Written by AI from the RERA record above on 21 Oct 2026. Every number in it was checked against that record; if anything differs, the record wins.

Open space, home loans, escrow and other details

Open space
70% of land
Water and power
Water source filed with RERA: Others
Home loans: approved banks
Not found in public records yet: bank approvals
Payment plans
Not found in public records yet: payment plans
Maintenance
Not found in public records yet: maintenance
Car parking
Not found in public records yet: car parking charge
Escrow bank (RERA)
Axis Bank, Malleshwaram
Building plan (RERA)
KIADB - Karnataka Industrial Areas Development Board · No. DO3-KIADB-00051/23-24/REV · dated 12 Jan 2024
Project cost declared to RERA
₹215 Cr

Open area as a share of the land, from the areas filed with RERA (includes driveways and landscaped areas).

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Amenities

  • Electricity
  • Community Hall

Amenities and internal works as filed by the promoter with Karnataka RERA; we have not visited the site.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Cobalt at Brigade El Dorado location and address

Address
Plot No. R5 & R-8, Sy No: 177 (P) of Bagluru Village and Sy No. 69(P), 70(P) and 72(P) in Huvinayakanahalli Vilage, (Hardware Sector) Hitech, Defence , Industrial Area, Jala Hobli, Bengaluru North Taluk, Yelahanka , Bangalore Rural District , Bengaluru North , Bengaluru Urban, Karnataka - 562149
Village (RERA)
Bagluru
Locality
BagalurAlso known as Bagaluru, Aerospace Park
PIN code
562149
City
Bengaluru
State
Karnataka
Coordinates
13.14430, 77.68444

Distances to landmarks

Not found in public records yet: landmarks

About Bagalur

Not found in public records yet: locality facts

Commute times to tech parks and the airport

As on 5 Oct 2026
ToStraight linePeak-hour drive (estimate)
Kempegowda International AirportMap point on OpenStreetMap (opens in a new tab)6.64 kmapprox. 27 min
Manyata Tech ParkMap point on OpenStreetMap (opens in a new tab)12.78 kmapprox. 52 min
ITPL, Whitefield (main gate)Map point on OpenStreetMap (opens in a new tab)18.35 kmapprox. 74 min
KSR Bengaluru City railway station (Majestic)Map point on OpenStreetMap (opens in a new tab)22.27 kmapprox. 90 min
Outer Ring Road tech corridor (RMZ Ecospace, Bellandur)Map point on OpenStreetMap (opens in a new tab)24.53 kmapprox. 99 min
Electronic City Phase 1Map point on OpenStreetMap (opens in a new tab)32.83 kmapprox. 133 min
How we calculate

Straight line: from the project’s map point on RERA to the destination’s point on OpenStreetMap.

Peak-hour drive is a rough estimate, not a route: straight line × 1.35 for the road network, at 20 km/h. Real times vary a lot with the route and the hour.

Sources:Source (openstreetmap.org) (opens in a new tab)How we calculate this

Schools and hospitals nearby

As on 5 Oct 2026

Within 2 km

  • 7Schools and colleges6 schools, 1 colleges, 0 kindergartens
  • 2Hospitals and clinics1 hospitals, 1 clinics

Nearest schools and colleges

  • Jawahar Navodaya Vidyalaya · 1.29 km
  • Government High School · 1.39 km
  • Vidyan Earth School · 1.51 km

Nearest hospitals and clinics

  • Vikrant Hospital · 1.28 km
  • SLV Poly Clinic · 1.46 km

Places as mapped on OpenStreetMap (amenity=school, college, kindergarten, university; hospital, clinic), counted within 2 km in a straight line of the RERA map point. Volunteers map these, so some places may be missing or closed. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.

Sources:Source (openstreetmap.org) (opens in a new tab)

Nearest metro station and railway

As on 5 Oct 2026
  • Airport City (ವಿಮಾನ ನಿಲ್ದಾಣ ನಗರ)Blue Line metro, under construction6.02 km
  • Doddajala (ದೊಡ್ಡಜಾಲ)Blue Line metro, under construction6.53 km
  • KIAL Terminals (ಕೆಐಎಬಿ ವಿಮಾನ ನಿಲ್ದಾಣ ಟರ್ಮಿನಲ್ಸ್)Blue Line metro, under construction6.74 km
  • Krishnarajapura (ಕೃಷ್ಣರಾಜಪುರ (ಕೆ.ಆರ್.ಪುರ))Open now — nearest operating metro station16.07 km
  • Doddajala Nearest railway station6.21 km

Straight-line distances from the RERA map point to the station points mapped on OpenStreetMap; status (open or under construction) as tagged there. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.

Sources:Source (openstreetmap.org) (opens in a new tab)

Lake and lake-buffer check

As on 5 Oct 2026

The nearest mapped lake is Gummanahalli Lake, 519 m from the project’s RERA map point.

The site boundary is not published as a shape, so its nearest edge can be closer than this point. Whether any building sits inside a lake buffer can only be checked on the approved plan.

The buffer rule

Bengaluru’s lake buffer rule has changed over time: the National Green Tribunal ordered a 75 m buffer in May 2016; the Supreme Court set that order aside on 5 March 2019, leaving the 30 m buffer of the Revised Master Plan 2015. Check the current rule and the approved plan before relying on either number.

Shortest distance from the RERA map point to the mapped water edge (OpenStreetMap water polygons tagged lake or reservoir, or named lake/kere/tank). Mapped shorelines can differ from the revenue-record boundary of a lake. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.

Sources:Source (openstreetmap.org) (opens in a new tab)Source (livelaw.in) (opens in a new tab)Source (citizenmatters.in) (opens in a new tab)How we calculate this

Satellite time-lapse of the site

Satellite photos load when you scroll to them.

Photos from Esri World Imagery Wayback, centred on the project’s map point; dates are the capture dates in Esri’s metadata. Loaded from Esri when you scroll here.

Sources:Source (livingatlas.arcgis.com) (opens in a new tab)

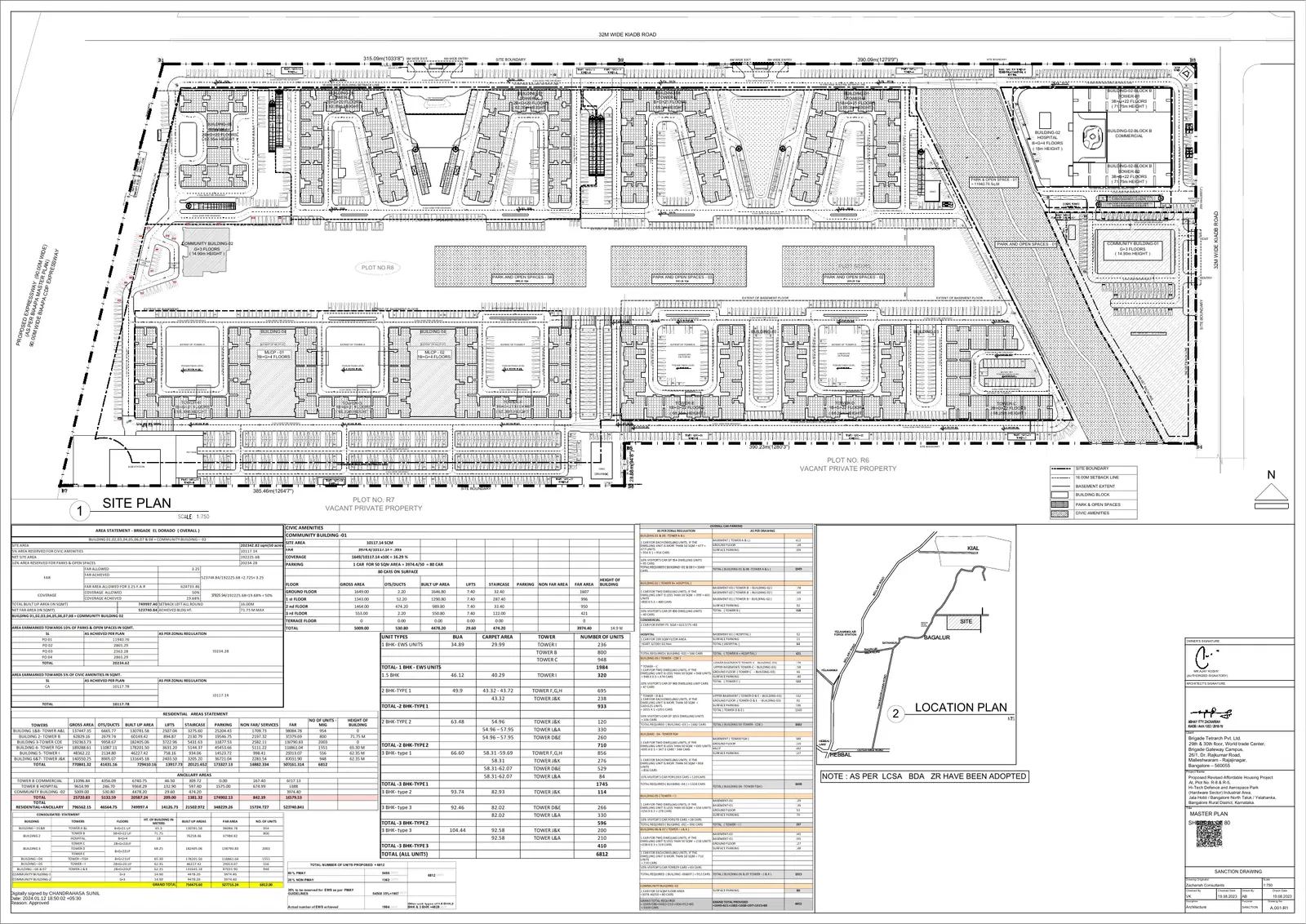

Cobalt at Brigade El Dorado floor plans, brochure and elevations

Documents the builder uploaded to Karnataka RERA, shown as filed. Tap a page to see it full size; the full PDF opens on the RERA website.

Brochure3 pages

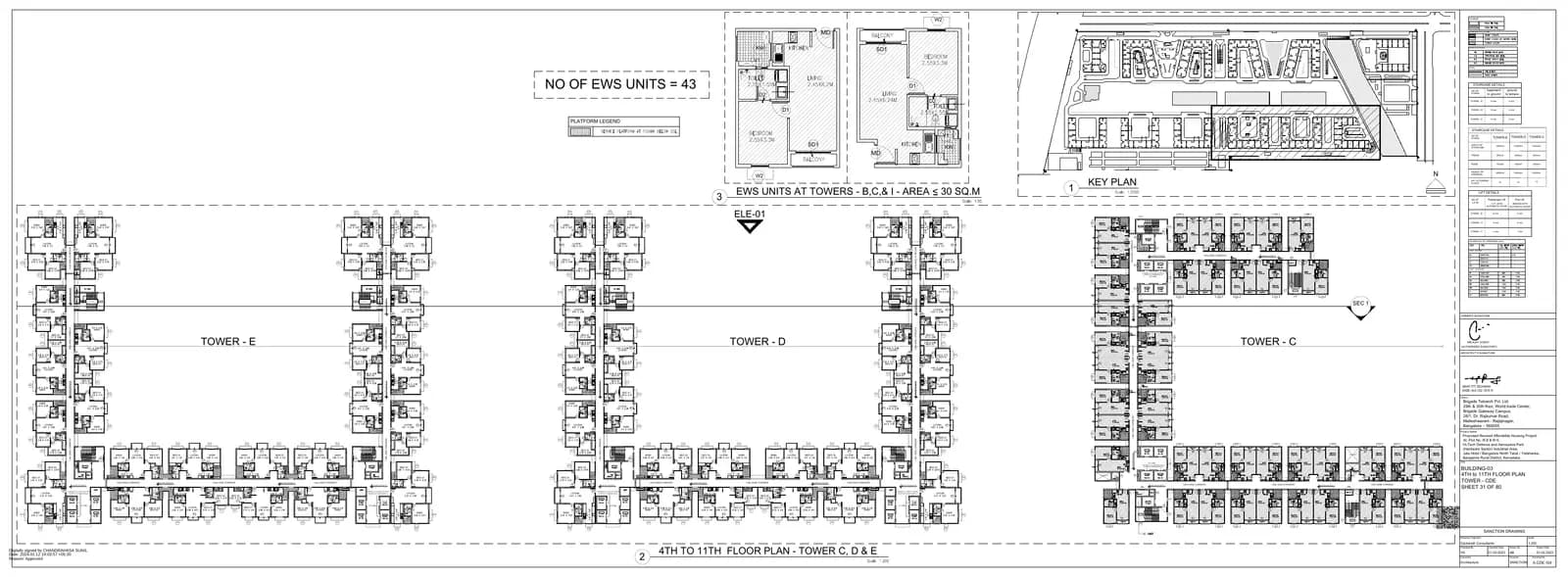

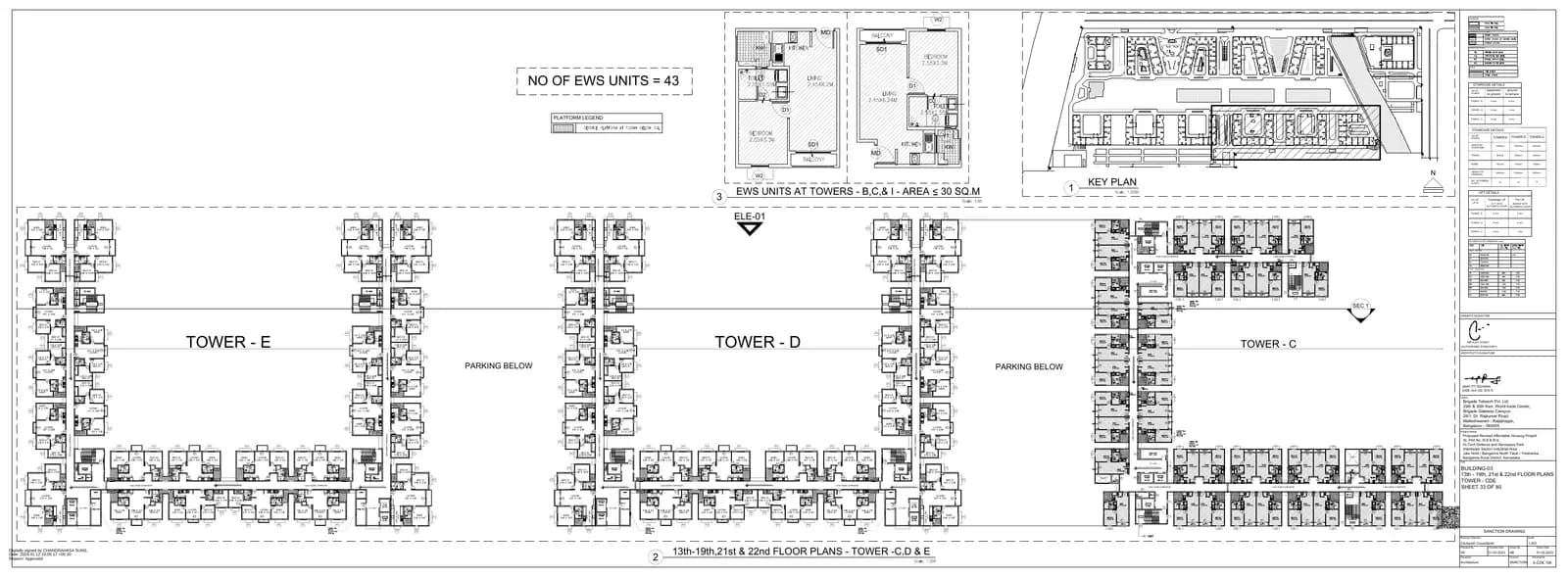

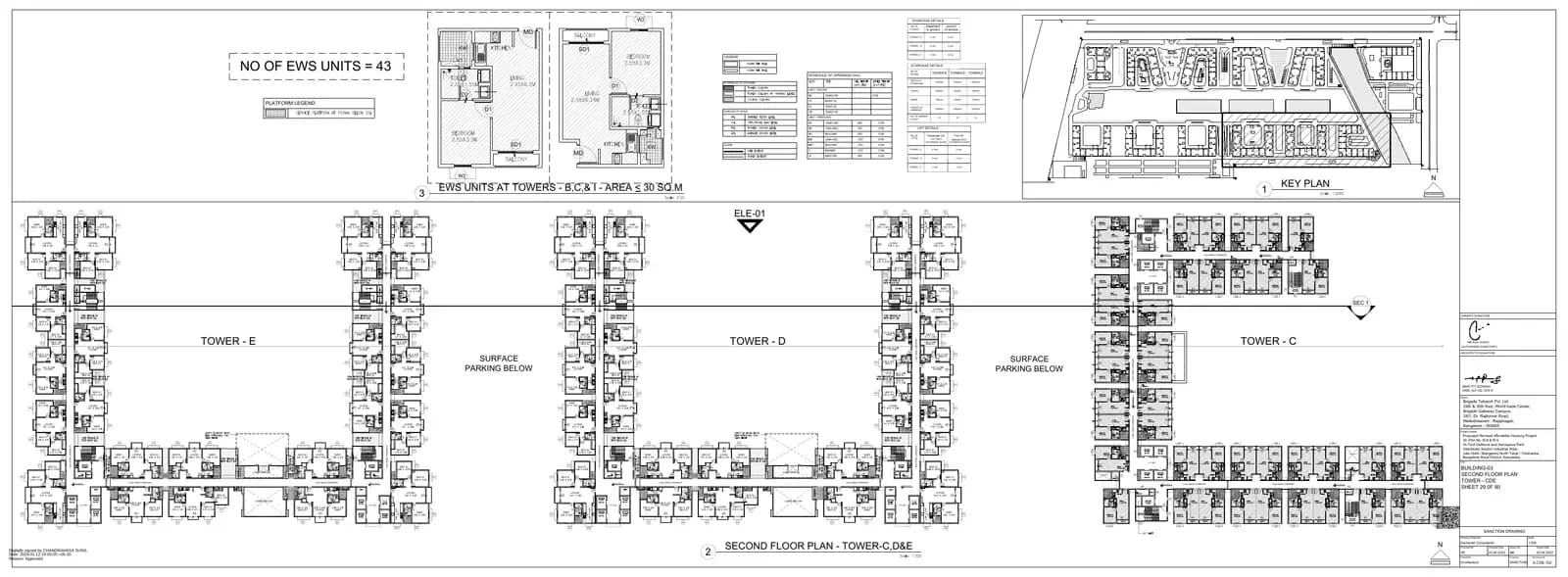

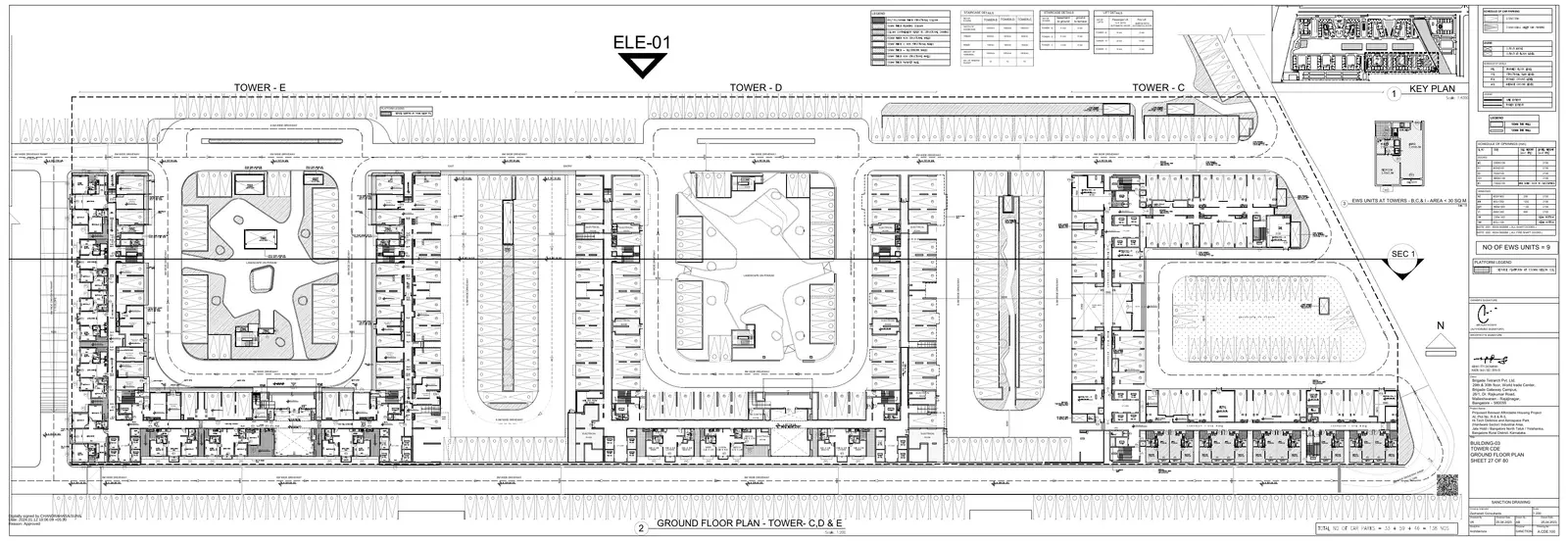

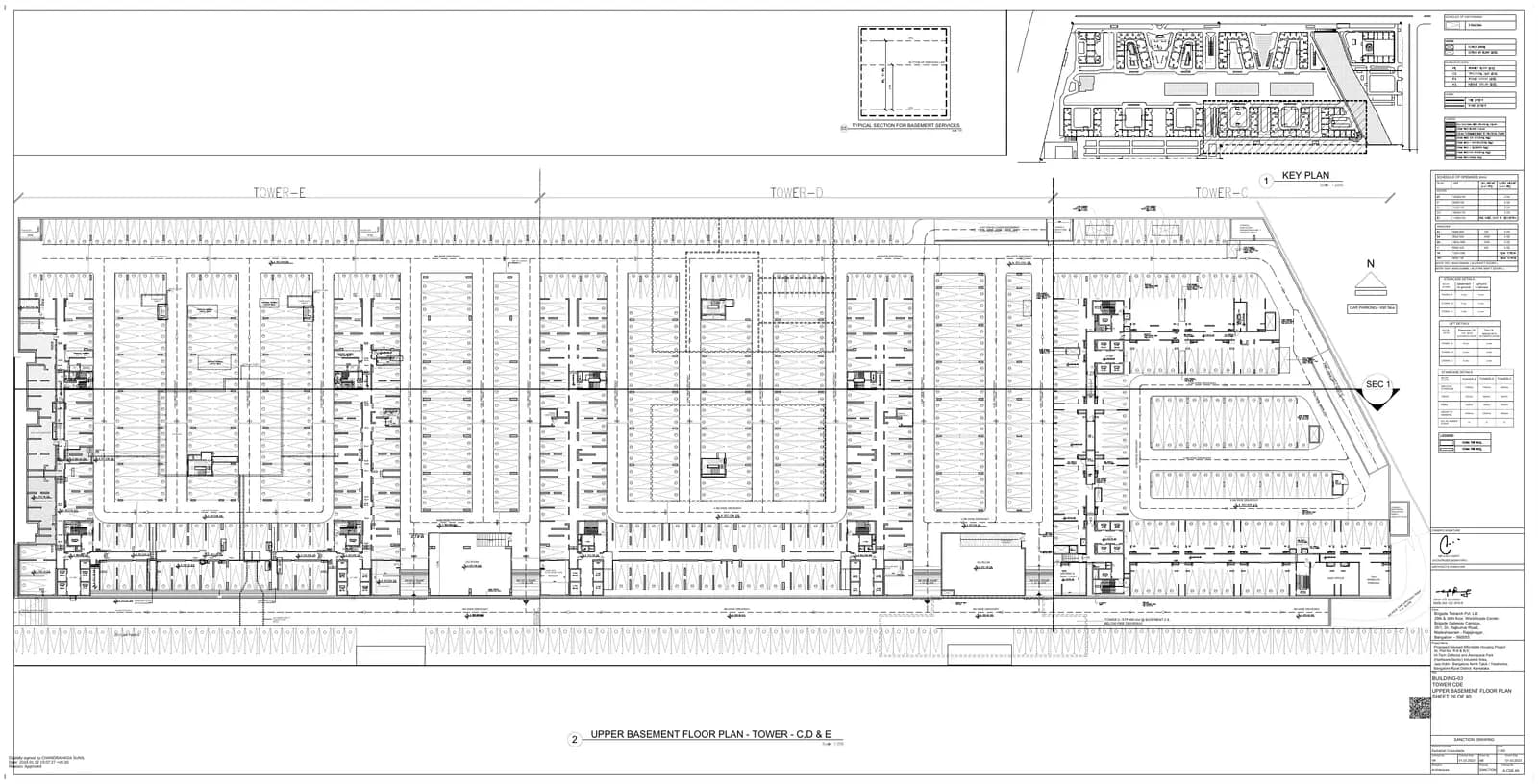

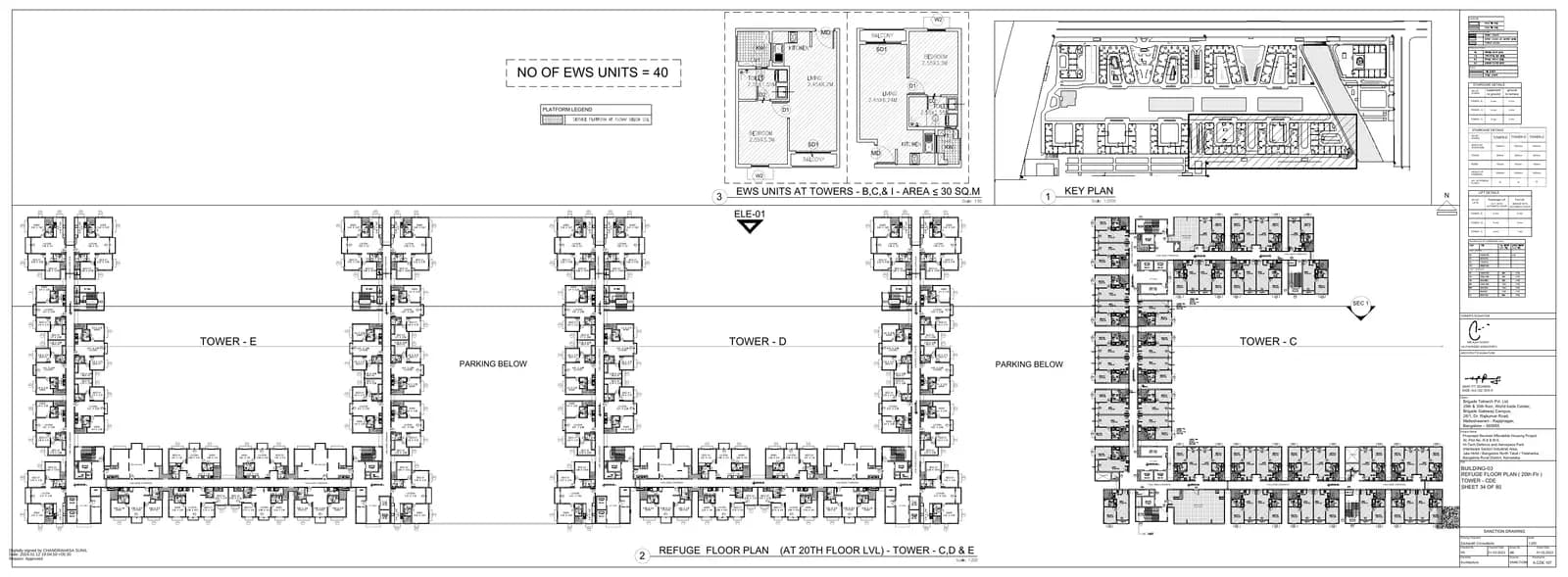

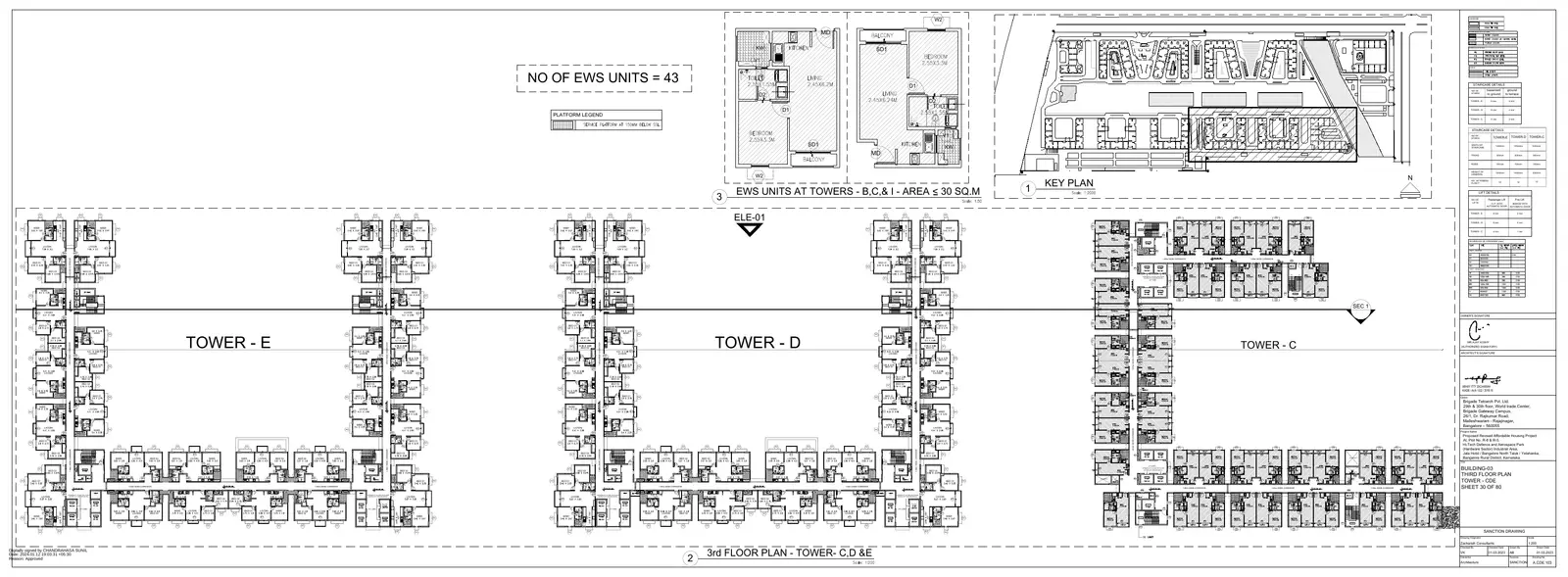

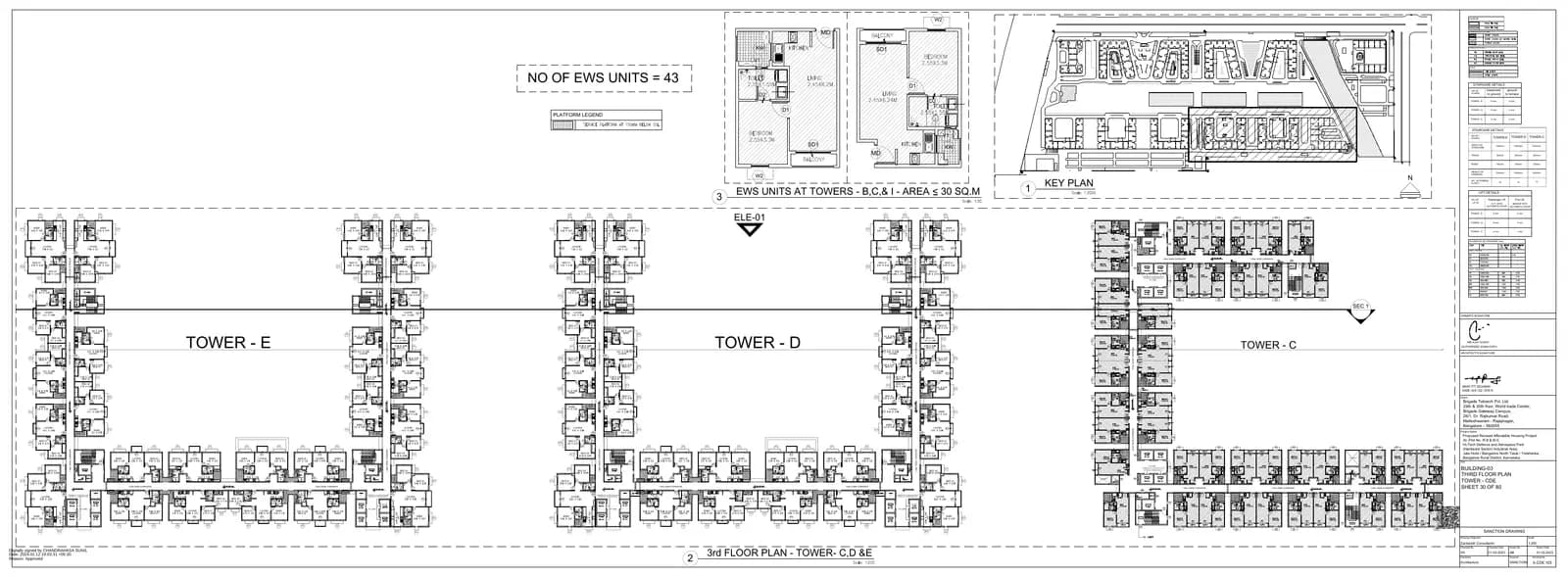

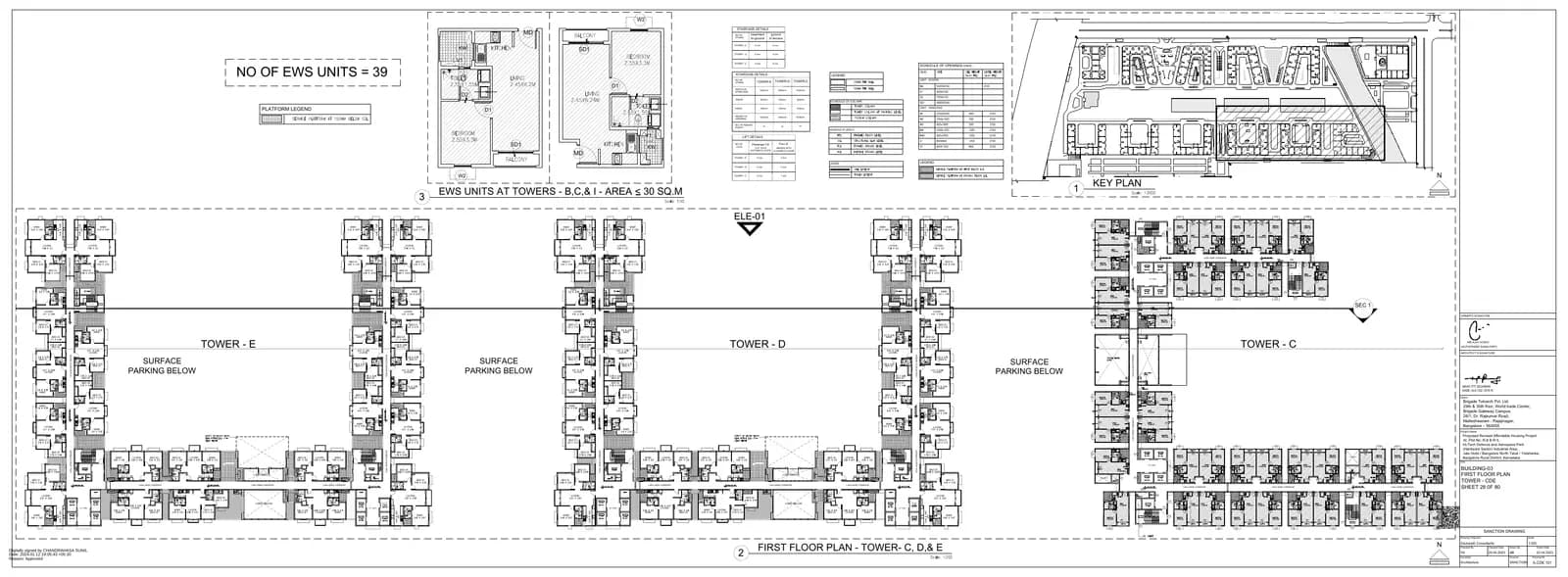

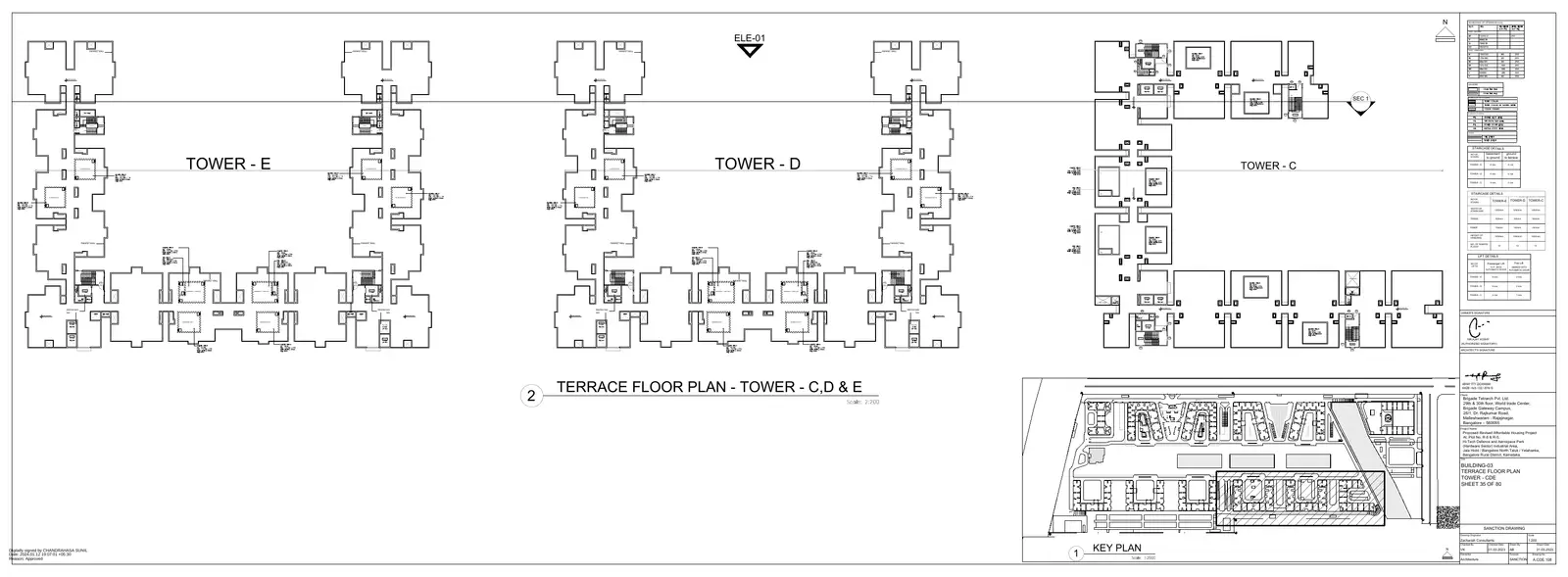

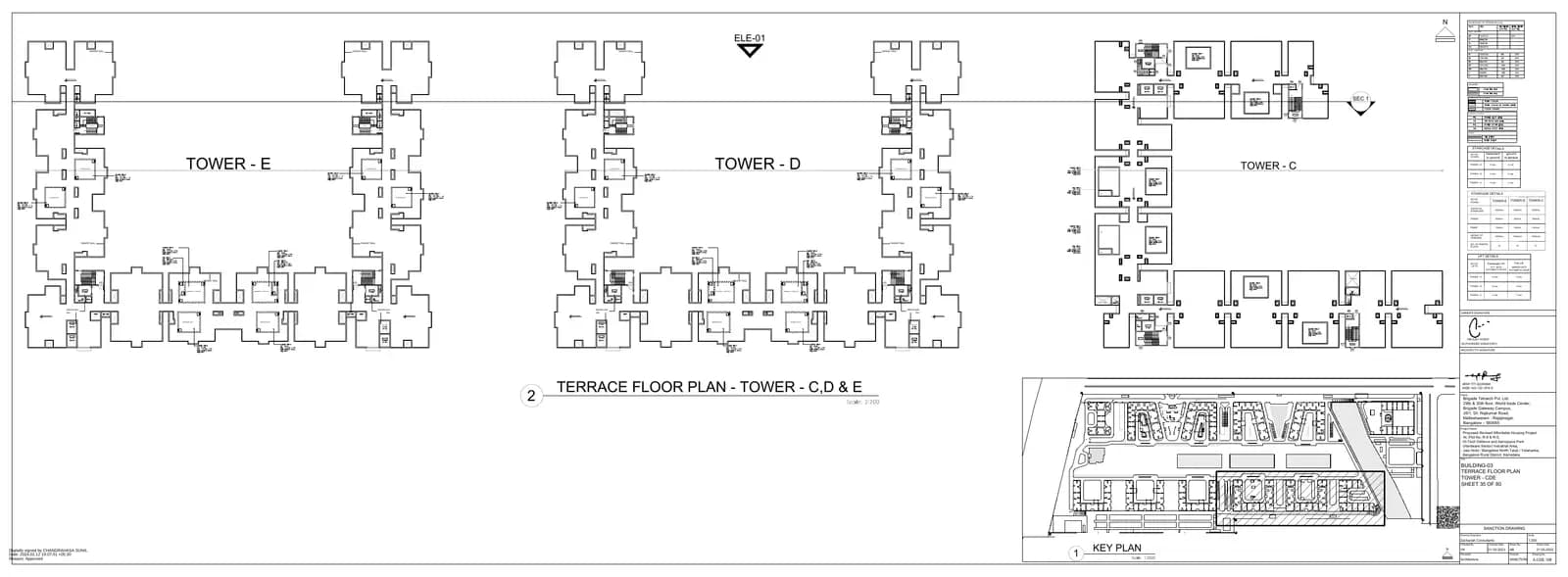

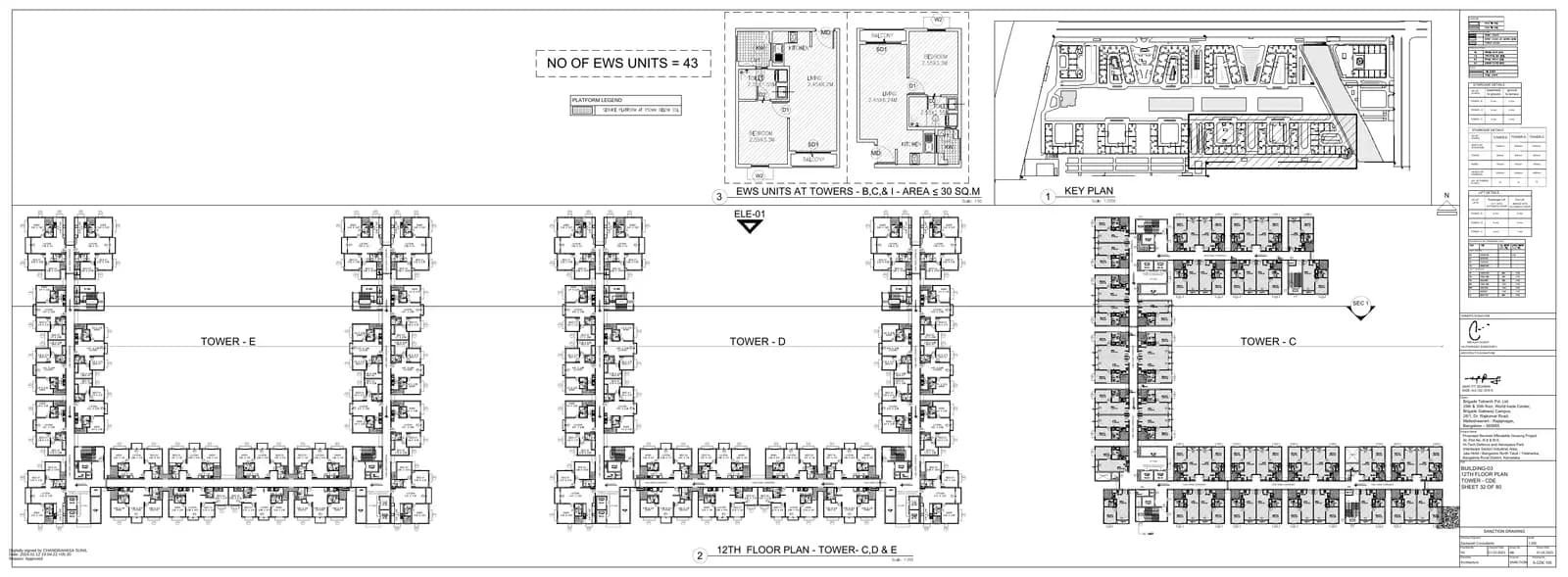

Floor plans11 files

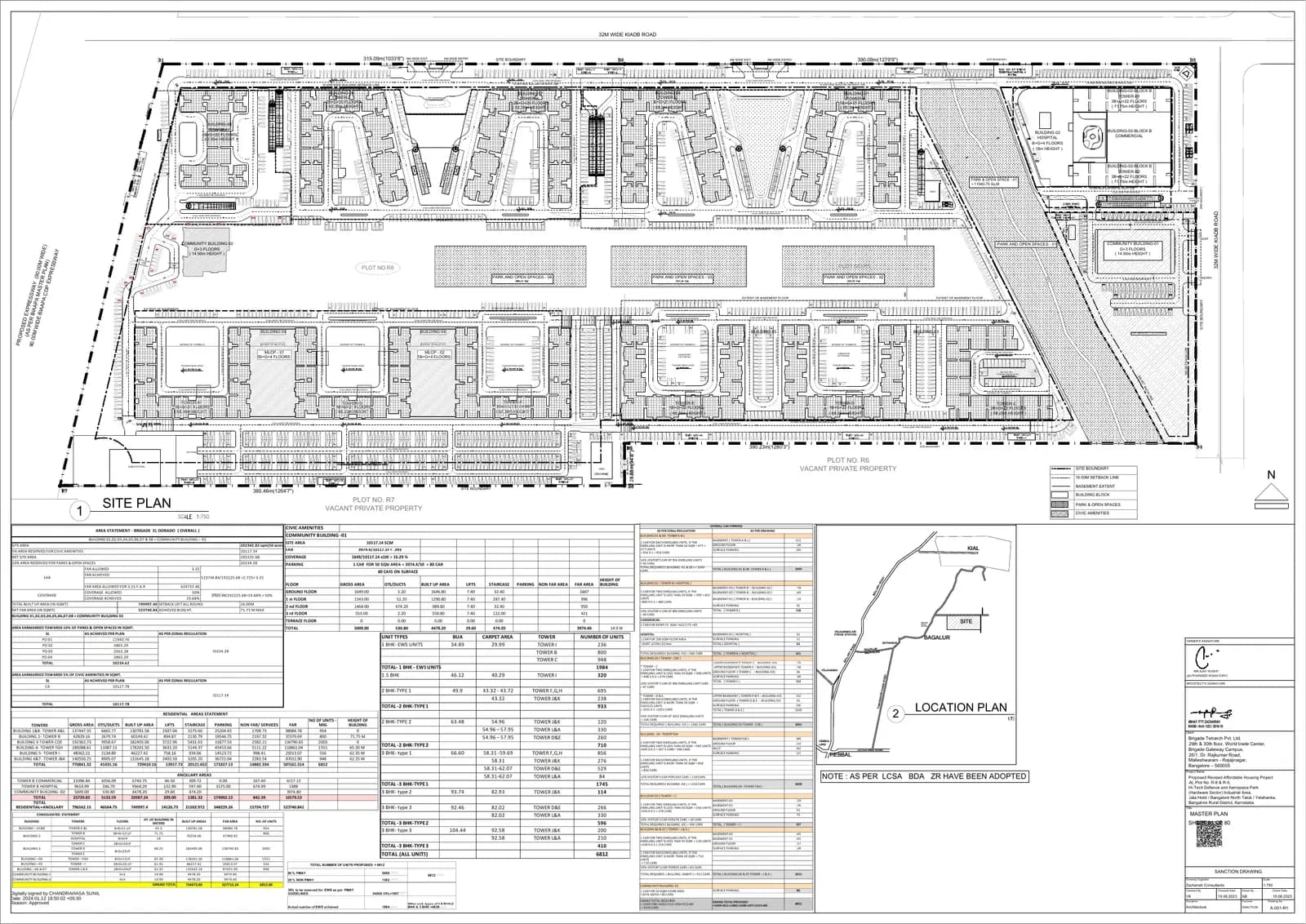

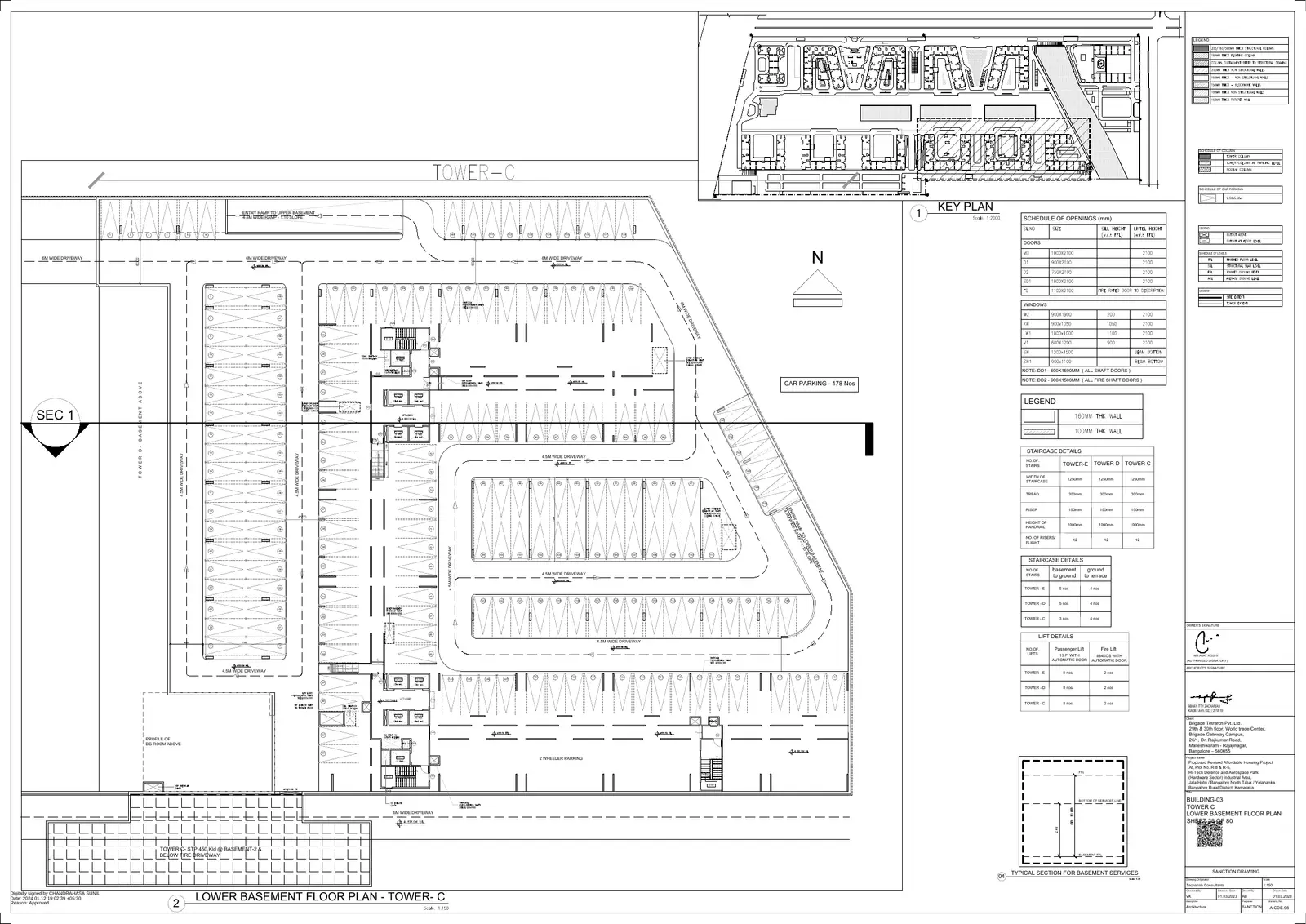

Approved layout plan2 files

Home typeCarpet areaHomes

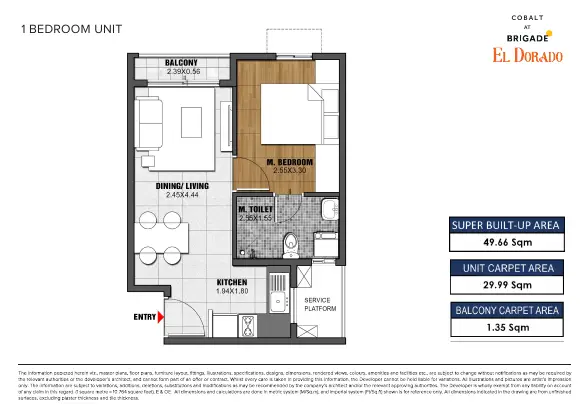

1 bedroom + 1 toilet323 sq ft948
1 BHK323 sq ft948

Home types, counts and carpet areas as filed with Karnataka RERA (carpet area, not super built-up).

We have not collected floor-plan drawings; the builder’s sales team can share them.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

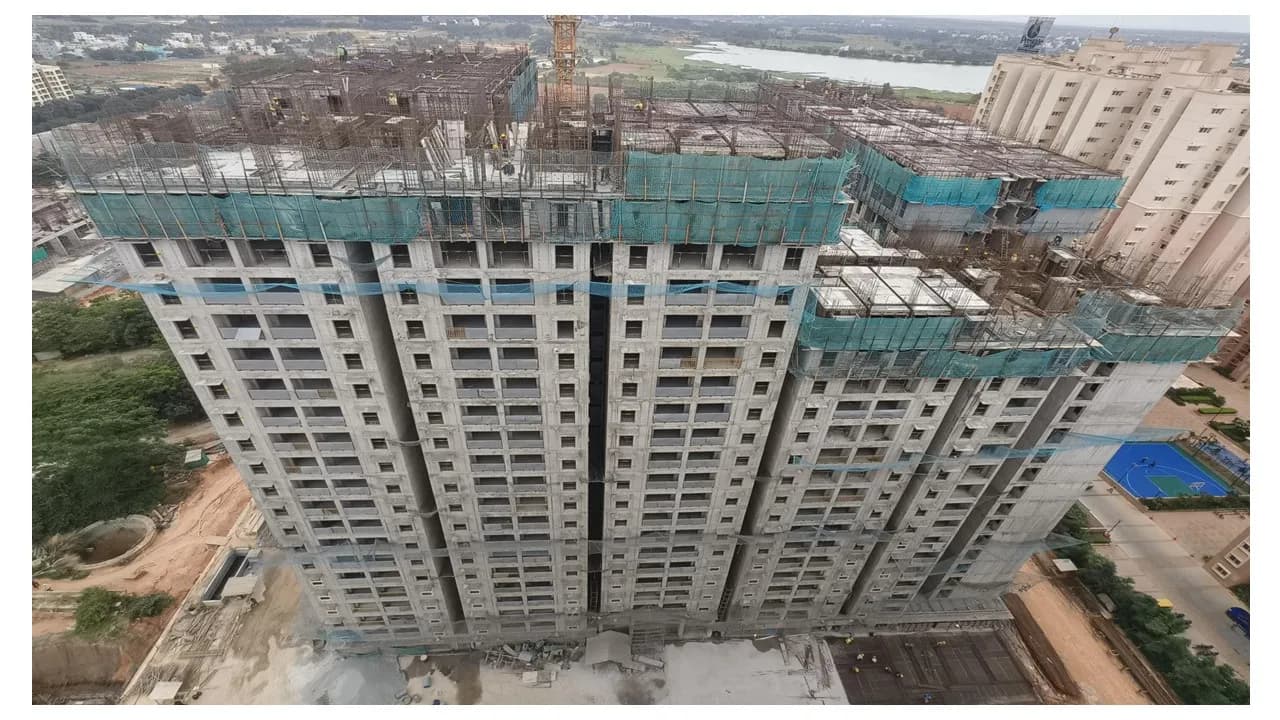

Cobalt at Brigade El Dorado possession date and construction status

  • Whole project (promoter’s RERA update)70%

    as on · 946 of 948 homes booked

Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-15.

Units sold and unsold, from RERA (Q2 2026-27)

TypeHomesBookedAvailable
1 BHK9489462

As reported by the promoter in the quarterly update to RERA, not verified by us.

Timeline

  1. 16 May 2024Registered with Karnataka RERA
  2. 24 May 2024Project start date given to RERA
  3. 30 Jun 2029Completion date given at registration

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Construction pace from RERA quarterly filings

As on 15 Oct 2026

At the average pace so far, construction would reach 100% around Oct 2027 — about 21 months before the completion date on RERA (30 Jun 2029).

At the pace between the 4 quarterly filings we have (46% → 70% in 9 months), it would be around Sep 2027 — about 22 months before the RERA date.

0%25%50%75%100%20252026202720282029RERA date46%52%61%70%
  • Filed on RERA
  • Average pace since start
  • Pace between filings (and 0% assumed at the start date)
  • RERA completion date

Quarterly filings

QuarterFiled onBuiltHomes booked
Q2 2026-27to 30 Sep 202615 Oct 202670%946 of 948
Q1 2026-27to 30 Jun 202615 Jul 202661%948 of 948
Q4 2025-26to 31 Mar 202615 Apr 202652%948 of 948
Q3 2025-26to 31 Dec 202514 Jan 202646%948 of 948
How we calculate

Average pace = % built ÷ months since the start date in the RERA record. Here: 70% ÷ 28.2 months (24 May 2024 to 30 Sep 2026) = 2.5% a month.

Estimated finish = latest filing date + (100 − % built) ÷ pace = 30 Sep 2026 + 30 ÷ 2.5 = 12.1 months → Oct 2027. This is an estimate, not a date from the builder or RERA.

Pace between filings = (70% − 46%) ÷ 9 months = 2.7% a month.

A straight line is a simplification: the builder reports one overall %, which mixes excavation, structure and finishing, and work rarely moves at a constant speed. The % values are the promoter’s own figures filed with RERA, not checked by us. Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-15.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this

Approvals and documents checklist

14 rows: approvals. Scroll inside the table to see them all.

ApprovalAuthoritySource
Building planKIADB - Karnataka Industrial Areas Development Board · No. DO3-KIADB-00051/23-24/REV · dated 2024-01-12Source (rera.karnataka.gov.in) (opens in a new tab)
Land conversionCommissioner for Industrial Development and Director Industries and Commerce & Member Secretary, SHLCC · No. KUM/JD-3/24-SHLCC/2010-11 · dated 2011-02-19Source (rera.karnataka.gov.in) (opens in a new tab)
Commencement Certificatescan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Electricity Permission Letterscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Approved Layout Planscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Approved Building/Plotting Planscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Approved Section Of Building/Infrastructure Plan of Plottingscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Change of Land Usescan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Conversion Certificate under section 95 of the KLR Act 1964scan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
ESCOM/Electricityscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Fire Force Departmentscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Airport Authority of Indiascan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
KSPCBscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
SEIAAscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)

Documents uploaded to RERA

As on 21 Oct 2026
  • Building or layout plan · Approved drawings from the planning authorityFiled on RERA ✓ — KIADB - Karnataka Industrial Areas Development Board · No. DO3-KIADB-00051/23-24/REV · dated 12 Jan 2024
  • Commencement certificate · Permission to start buildingFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Environment clearance · SEIAA KarnatakaFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Fire NOC · Karnataka Fire and Emergency ServicesFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Pollution board consent · KSPCBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Water and sewerage · BWSSBNot on RERA yet
  • Electricity · BESCOMFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Height clearance · Airports Authority of IndiaFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Occupancy certificate (OC) · Issued only when the building is finishedNot on RERA yet — expected at completion

From the documents the promoter uploaded to Karnataka RERA, collected 21 Oct 2026. “Filed” means a document is on RERA — we have not checked its contents or validity. Not every approval applies to every project (for example, smaller projects may not need an environment clearance). The project page on RERA lists each upload.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Cobalt at Brigade El Dorado RERA complaints

No complaints listed on Karnataka RERA for this registration as on Source (rera.karnataka.gov.in) (opens in a new tab)

Court and consumer cases

Not found in public records yet: court cases

We list case numbers, courts and outcomes only — never names of private individuals.

About Brigade Enterprises Ltd

Promoter type
Company
Projects on this site
28
RERA complaints against promoter
44
Company number (CIN)
U92412KA1995PTC018247

From Karnataka RERA, as collected so far (21 Oct 2026). Complaints are those RERA lists against this promoter across all its projects.

Brigade Enterprises Ltd’s RERA record

Brigade Enterprises Ltd delivery record

As on 22 Oct 2026
  • 28Projects in Bengaluru on RERA32 approved registrations under Brigade Enterprises Ltd in Bengaluru Urban and Rural. Source (rera.karnataka.gov.in) (opens in a new tab)
  • 15,990Homes and plots registeredAs stated in 31 of the 32 registrations.
  • 44RERA complaints5 open, 39 disposed. as on Source (rera.karnataka.gov.in) (opens in a new tab)
  • 2.8Complaints per 1,000 homes and plots44 complaints ÷ 15,990 homes and plots in its 32 registrations on Karnataka RERA in Bengaluru.
  • 5Completion filed on RERARegistrations where the promoter applied to RERA for completion; 2 with an occupancy certificate on RERA.
  • 0 of 5Filed by the date given at registrationMedian gap 9.4 months (on-time ones count as 0). The completion application can come after handover, so this is an upper bound on lateness.

What the complaints are about

  • Delay in possession or delay interest18
  • Refund of booking or other money10
  • Construction quality, size or inspection4
  • Registration, sale deed or agreement3
  • Owners' association, amenities or documents2
  • Litigation or title disclosure2
  • Other5

44 complaint subjects as written on RERA, as on . Each subject is sorted into one group by keywords (first match wins: delay, refund, registration, quality, litigation, association); one complaint often raises several issues. Source (rera.karnataka.gov.in) (opens in a new tab)

Completion filed on RERA

ProjectDate at registrationCompletion filedGap
Brigade Northridge NeoOC on RERA31 Mar 2022extended to 30 Sep 202220 May 202650 months after
Brigade BricklaneOC on RERA31 Dec 2021extended to 31 Mar 202316 May 202653 months after
Brigade Oasis - Phase 130 Jun 2025extended to 30 Jun 202613 Apr 20269 months after
Brigade Oasis - Phase 230 Jun 2025extended to 30 Jun 202613 Apr 20269 months after
Brigade Oasis - Phase 330 Jun 2025extended to 30 Jun 202613 Apr 20269 months after

Measured against the completion date given at registration; many projects had RERA extensions (including the COVID-period extension), shown under the date.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this

What’s changed since Jan 2024

As on 21 Oct 2026
  1. 15 Oct 2026Quarterly update filed for Q2 2026-27: 70% built, 946 of 948 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  2. 15 Jul 2026Quarterly update filed for Q1 2026-27: 61% built, 948 of 948 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  3. 15 Apr 2026Quarterly update filed for Q4 2025-26: 52% built, 948 of 948 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  4. 14 Jan 2026Quarterly update filed for Q3 2025-26: 46% built, 948 of 948 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  5. 24 May 2024Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
  6. 16 May 2024Registered with Karnataka RERA (PRM/KA/RERA/1251/309/PR/160524/006878); completion date 30 Jun 2029 Source (rera.karnataka.gov.in) (opens in a new tab)
  7. 12 Jan 2024Building plan approved by KIADB - Karnataka Industrial Areas Development Board (No. DO3-KIADB-00051/23-24/REV) Source (rera.karnataka.gov.in) (opens in a new tab)

Newest first. No extension of the completion date is recorded on RERA. When the RERA crawl sees a new filing, complaint or extension, it is added here with its date.

Home loan EMI calculator

No listed price found — enter one to try.

Example only — use your bank’s quote.

Monthly EMI
—
Down payment
—
Loan amount
—
Total interest
—

A calculation only, from the numbers you enter — not a loan offer.

All-in cost: GST, registration and other charges

The calculator loads when you scroll to it.

Assumptions
  • Base price: the builder’s price is not published in a form we could collect — enter it from the cost sheet.
  • GST 5% on the base price and charges — the usual rate for an under-construction home that is not “affordable housing” (1%).
  • Stamp duty about 5.6% and registration 2% — the Karnataka rule (registration was raised from 1% to 2% on 31 Aug 2025). Calculated on the agreement value.
  • Car parking, other charges and the maintenance deposit are not in the public record we collect; enter them from the builder’s cost sheet.
  • Loan on the agreement value (banks usually lend up to 75–90%); EMI is the standard reducing-balance formula. Example rate only — use your bank’s quote.

How we calculate this

Cobalt at Brigade El Dorado FAQs

What is the carpet area of homes in Cobalt at Brigade El Dorado?

All homes are 1 BHK with a carpet area of 323 sq ft.

How many homes are in Cobalt at Brigade El Dorado?

The project has 948 homes.

What is the RERA registration number for Cobalt at Brigade El Dorado?

The RERA registration number is PRM/KA/RERA/1251/309/PR/160524/006878.

When is Cobalt at Brigade El Dorado expected to be completed?

The completion date on RERA is 30 June 2029.

What is the construction progress of Cobalt at Brigade El Dorado?

As of Q2 2026-27, the project is 70% complete.

How many homes have been booked in Cobalt at Brigade El Dorado?

As of Q2 2026-27, 946 homes have been booked out of 948.

Are there any RERA complaints on Cobalt at Brigade El Dorado?

There are no RERA complaints on this project.

Where is Cobalt at Brigade El Dorado located?

The project is in Bagluru, Bengaluru North, PIN code 562149.

How many other projects does Brigade Tetrarch Private Limited have on the RERA record?

Brigade Tetrarch Private Limited has 10 projects in our Bengaluru records.

How many RERA complaints are there against Brigade Tetrarch Private Limited across all projects?

There are 9 RERA complaints against the builder across all projects.

Written by AI from the RERA record above on 21 Oct 2026. Answers use only that record; check them against the source before you decide.

Questions about Cobalt at Brigade El Dorado

No questions published yet. Ask the first one: you get an instant answer from this page’s public record, and our team follows up on anything the record does not show.

Bought a home from Brigade Enterprises Ltd? Review the builder.

Reviews of Brigade Enterprises Ltd by verified buyers

No verified reviews of Brigade Enterprises Ltd yet. If you bought a home from them, your review helps other buyers.

How reviews work: only buyers and owners can review; we confirm each purchase by phone before publishing, publish positive and negative reviews alike, never accept payment for reviews, and the builder may reply.

Similar projects within 5 km

ProjectDistanceHomesPossession (RERA)BuiltComplaintsPrice
Aurum at Brigade El DoradoBrigade Enterprises Ltd0 km635Dec 202786%0Not collected
Emerald & Luminaire Block at Brigade El DoradoBrigade Enterprises Ltd0 km1,236Dec 2026100%2Not collected
Assetz Sora & Saki Phase 3Vedant Homes0.5 km304Apr 202937%0Not collected
Assetz Sora & SakiNetra Software Technologies Private Limited0.6 km992Jul 2029—0Not collected
Dhruvija GopuraDhruvija Gopura0.6 km250Mar 20325%0Not collected
LivingTree by Kalyani DevelopersKalyani Tech Park Private Limited0.8 km2,736Sep 202945%4Not collected

Projects of the same kind within 5 km in a straight line of this project’s RERA map point, nearest first. % built is the promoter’s latest quarterly figure on RERA (shown for single-registration projects); prices are from the builder’s own website where we found one.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Sources and last checked dates

  1. Karnataka RERA — project register (search by the registration number) (opens in a new tab)

Collected on 21 Oct 2026 by AI research agents reading public pages. Facts are written in our own words. Not found yet: price; court cases; landmarks; specifications; news.

How to check on RERA: On rera.karnataka.gov.in/viewAllProjects, type the registration number in 'Registration No', press Search, then click the 'View Project Details' icon. Complaints open from the 'Complaints / Litigation' icon in the same row. Registration number: PRM/KA/RERA/1251/309/PR/160524/006878.

  • RERA record last checked: 21 Oct 2026
  • Last change in the record (registration, quarterly filing or complaint): 21 Oct 2026

How this page is made: software builds it from public records (Karnataka RERA filings, OpenStreetMap, the builder’s own website). AI is used only to read filings into fields and to write the plain-English summary and FAQ answers, which are checked against the record. Facts are checked automatically against the RERA filing. Methodology · How we earn · Report an error

More new projects in Bagalur
