Manidvipa

30×40, 30×50 +6 more plots by D R Developers · Mavallipura, Yelahanka, Bengaluru

Mavallipura, Yelahanka, BengaluruOpen on Google Maps (opens in a new tab)

  • Under construction
  • RERA registered
  • plotted

by D R Developers

Price: Price on request

Get brochure, layout plan & price

Brochure, layout plan and price list for Manidvipa

Developers share their brochure, layout plan and price list only on request. Tell us how to reach you and we’ll get them and send them to you, free.

Free for buyers. If you book through us, the developer pays us a commission. How we earn

Project summary

Manidvipa is a plotted development by D R Developers in Mavallipura, Bengaluru with 295 plots, registered with Karnataka RERA. The completion date on RERA is 31 Mar 2027.

Facts collected on 16 Oct 2026 from public records — each linked to its source. Free for buyers. If you book through us, the developer pays us a commission.

Manidvipa buyers’ group: join to ask for a group price

No one has joined yet. Be one of the first 10 buyers in this group — the founding members.

Join free. When enough buyers have joined, our agent partner asks D R Developers for a group price — for example a lower price, an easier payment plan or waived charges. Nothing is promised: you see what the developer offers and book directly with the developer if you want to. Free for buyers. If you book through us, the developer pays us a commission.

  1. Gathering buyers
  2. Talking to the developer
  3. Group offer
  4. Group site visit
  5. Booking

0 buyers have joined · 0 committed

Committed buyers have confirmed their budget, plot size and timeline with us on a call; developers negotiate with them. Joining is free and never obliges you to buy.

Join the Manidvipa buyers’ groupHow group buying works

See it for yourself

Visit the site with our team, or get a call to clear your questions. Free, no obligation.

Key facts: plot sizes, approval, land and completion

Updated on 16 Oct 2026
Plot sizes (feet)
30×40, 30×50, 30×58, 40×46 +4 more
Plot area
801 – 34,855 sq ft
Total plots
295
Layout approved by
BDA
Land
Not found in public records yet: land area
Land conversion orders
10
Completion (RERA)
Mar 2027
Development (RERA update)
85%

Plot sizes (RERA filing)

11 rows: plot sizes. Scroll inside the table to see them all.

Size (feet)AreaPlots
30×401,200 sq ft127
30×501,500 sq ft43
30×581,740 sq ft3
40×461,840 sq ft2
40×502,000 sq ft20
46×502,300 sq ft1
40×602,400 sq ft16
40×823,280 sq ft1
Odd-sized (irregular)varies57
Commercial—1
EWS—23

Sizes as filed with RERA, converted from metres to feet (9.14 m = 30 ft, 12.19 m = 40 ft). Ask the developer which plots are still unsold.

Approving authority as filed: BDA - Bangalore Development Authority.

Land conversion orders (RERA filing)

Survey no.Converted forOrderBy
50/1ResidentialNo. 630102, 12 Apr 2024DC Office, Bangalore
53/1ResidentialNo. 661456, 29 May 2024DC Office, Bangalore
53/3ResidentialNo. 661454, 29 May 2025DC Office, Bangalore
53/4ResidentialNo. 661448, 29 May 2024DC Office, Bangalore
55/1ResidentialNo. 630070, 12 Apr 2024DC Office, Bangalore
56/1ResidentialNo. 630153, 12 Apr 2024DC Office, Bangalore
56/2ResidentialNo. 630081, 12 Apr 2024DC Office, Bangalore
58ResidentialNo. 630140, 12 Apr 2024DC Office, Bangalore
59/2ResidentialNo. 645457, 12 Apr 2024DC Office, Bangalore
59/1ResidentialNo. 645459, 12 Apr 2024DC Office, Bangalore

RERA does not cover each plot’s khata. Ask the developer for the khata and title documents and have a lawyer check them before paying an advance.

Manidvipa RERA number and registration details

RERA number
PRM/KA/RERA/1251/472/PR/160126/008408
Registered on
16 Jan 2026
Promised completion
31 Mar 2027
Extended to
No extension recorded
RERA status
Under construction
Plots booked
Not found in public records yet: plots booked
Price
Not found in public records yet: price
Project type
Plotted

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Summary in plain English

Manidvipa is a plotted layout by D R Developers in Mavallipura, Yelahanka, with 295 plots approved by BDA. The layout is 85% developed as of 30 June 2026, with completion scheduled for 31 March 2027.

Written by AI from the RERA record above on 17 Oct 2026. Every number in it was checked against that record; if anything differs, the record wins.

Open space, loans, escrow and other details

Open space
Not found in public records yet: open space
Water and power
Water source filed with RERA: Local Authority
Plot loans: approved banks
Not found in public records yet: bank approvals
Payment plans
Not found in public records yet: payment plans
Maintenance
Not found in public records yet: maintenance
Car parking
Not found in public records yet: car parking charge
Escrow bank (RERA)
HDFC, Mathikere Branch
Building plan (RERA)
BDA - Bangalore Development Authority · No. BDA/TPM/PRL-57/23-24/3577/2024-25 · dated 29 Mar 2025
Project cost declared to RERA
₹56.73 Cr

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Amenities

Not found in public records yet: amenities

Manidvipa location and address

Address
Sy no 50/1, 53/1, 53/3, 53/4, 55/1P, 56/1, 56/2, 58, 59/1, 59/2 OF MAVALLIPURA VILLAGE , HESARAGATTA HOBLI , Yelahanka , Bengaluru Urban, Karnataka - 560089
Village (RERA)
Mavallipura
Locality
Yelahanka
PIN code
560089
City
Bengaluru
State
Karnataka
Coordinates
13.12154, 77.52594

Distances to landmarks

Not found in public records yet: landmarks

About Yelahanka

Not found in public records yet: locality facts

Commute times to tech parks and the airport

As on 5 Oct 2026
ToStraight linePeak-hour drive (estimate)
Manyata Tech ParkMap point on OpenStreetMap (opens in a new tab)13.04 kmapprox. 53 min
KSR Bengaluru City railway station (Majestic)Map point on OpenStreetMap (opens in a new tab)16.63 kmapprox. 67 min
Kempegowda International AirportMap point on OpenStreetMap (opens in a new tab)21.24 kmapprox. 86 min
ITPL, Whitefield (main gate)Map point on OpenStreetMap (opens in a new tab)27.35 kmapprox. 111 min
Outer Ring Road tech corridor (RMZ Ecospace, Bellandur)Map point on OpenStreetMap (opens in a new tab)27.69 kmapprox. 112 min
Electronic City Phase 1Map point on OpenStreetMap (opens in a new tab)33.77 kmapprox. 137 min
How we calculate

Straight line: from the project’s map point on RERA to the destination’s point on OpenStreetMap.

Peak-hour drive is a rough estimate, not a route: straight line × 1.35 for the road network, at 20 km/h. Real times vary a lot with the route and the hour.

Sources:Source (openstreetmap.org) (opens in a new tab)How we calculate this

Schools and hospitals nearby

As on 5 Oct 2026

Within 2 km

  • 8Schools and colleges7 schools, 1 colleges, 0 kindergartens
  • 0Hospitals and clinics0 hospitals, 0 clinics

Nearest schools and colleges

  • St. Philomena's School · 0.82 km
  • Gopalan National School · 1.07 km
  • Jnana Ganga Public School · 1.41 km

Places as mapped on OpenStreetMap (amenity=school, college, kindergarten, university; hospital, clinic), counted within 2 km in a straight line of the RERA map point. Volunteers map these, so some places may be missing or closed. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.

Sources:Source (openstreetmap.org) (opens in a new tab)

Nearest metro station and railway

As on 5 Oct 2026
  • Yelahanka (ಯಲಹಂಕ)Blue Line metro, under construction8.34 km
  • Manjunathanagara (ಮಂಜುನಾಥನಗರ)Open now — nearest operating metro station8.65 km
  • Soladevanahalli (ಸೋಲದೇವನಹಳ್ಳಿ)Nearest railway station5.15 km

Straight-line distances from the RERA map point to the station points mapped on OpenStreetMap; status (open or under construction) as tagged there. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.

Sources:Source (openstreetmap.org) (opens in a new tab)

Lake and lake-buffer check

As on 5 Oct 2026

The nearest mapped lake is Byalakere Lake, 600 m from the project’s RERA map point.

The site boundary is not published as a shape, so its nearest edge can be closer than this point. Whether any building sits inside a lake buffer can only be checked on the approved plan.

The buffer rule

Bengaluru’s lake buffer rule has changed over time: the National Green Tribunal ordered a 75 m buffer in May 2016; the Supreme Court set that order aside on 5 March 2019, leaving the 30 m buffer of the Revised Master Plan 2015. Check the current rule and the approved plan before relying on either number.

Shortest distance from the RERA map point to the mapped water edge (OpenStreetMap water polygons tagged lake or reservoir, or named lake/kere/tank). Mapped shorelines can differ from the revenue-record boundary of a lake. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.

Sources:Source (openstreetmap.org) (opens in a new tab)Source (livelaw.in) (opens in a new tab)Source (citizenmatters.in) (opens in a new tab)How we calculate this

Satellite time-lapse of the site

Satellite photos load when you scroll to them.

Photos from Esri World Imagery Wayback, centred on the project’s map point; dates are the capture dates in Esri’s metadata. Loaded from Esri when you scroll here.

Sources:Source (livingatlas.arcgis.com) (opens in a new tab)

Manidvipa layout plan and plot types as filed

Documents the developer uploaded to Karnataka RERA, shown as filed. Tap a page to see it full size; the full PDF opens on the RERA website.

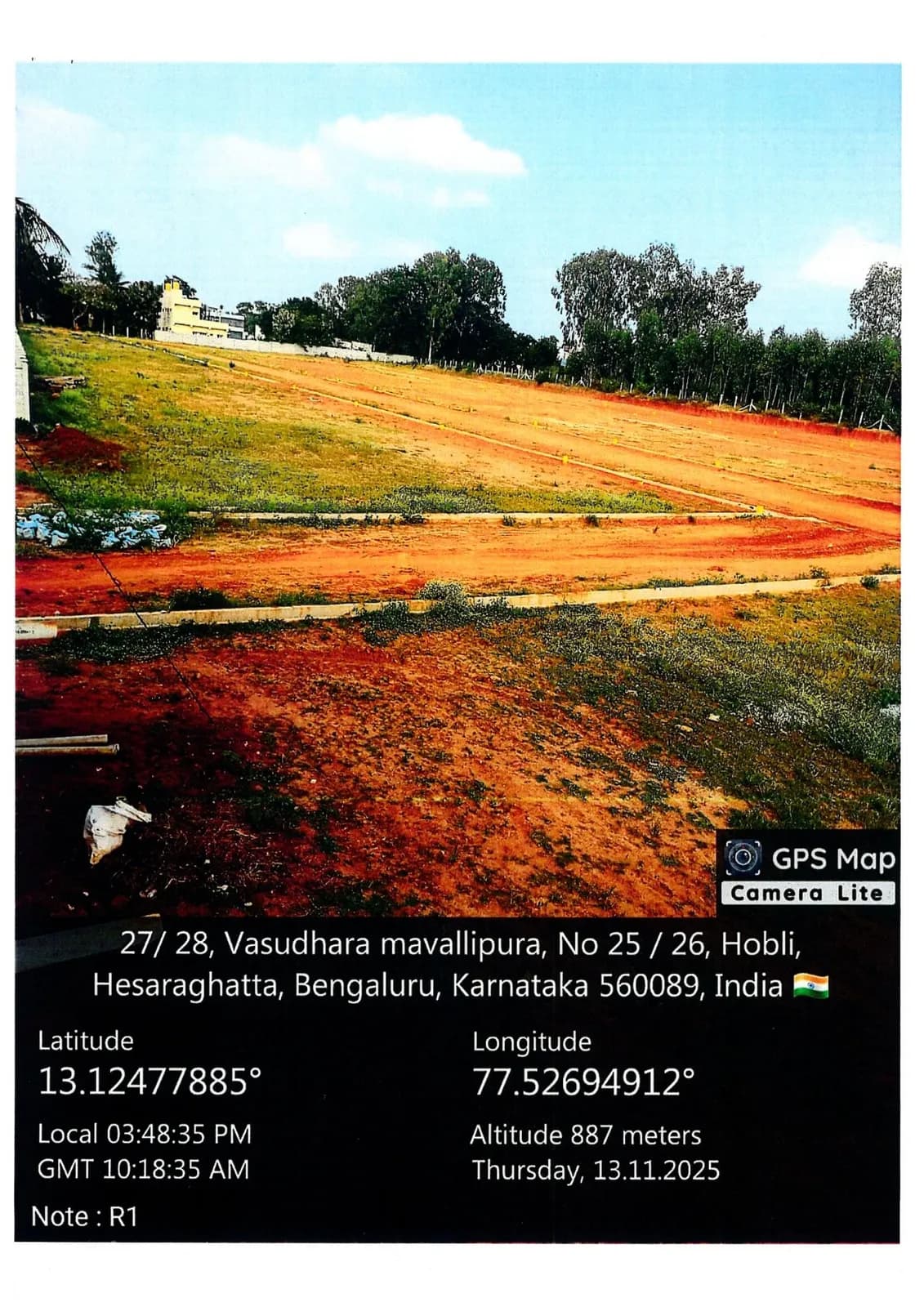

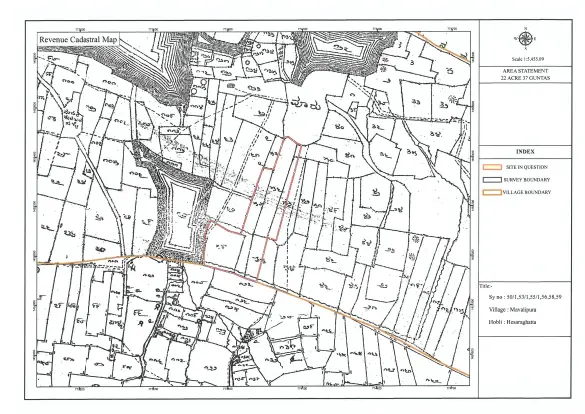

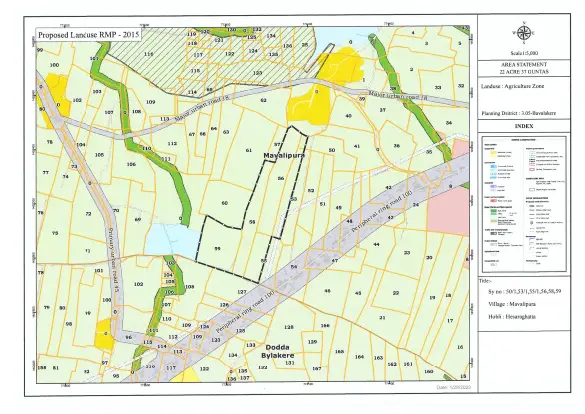

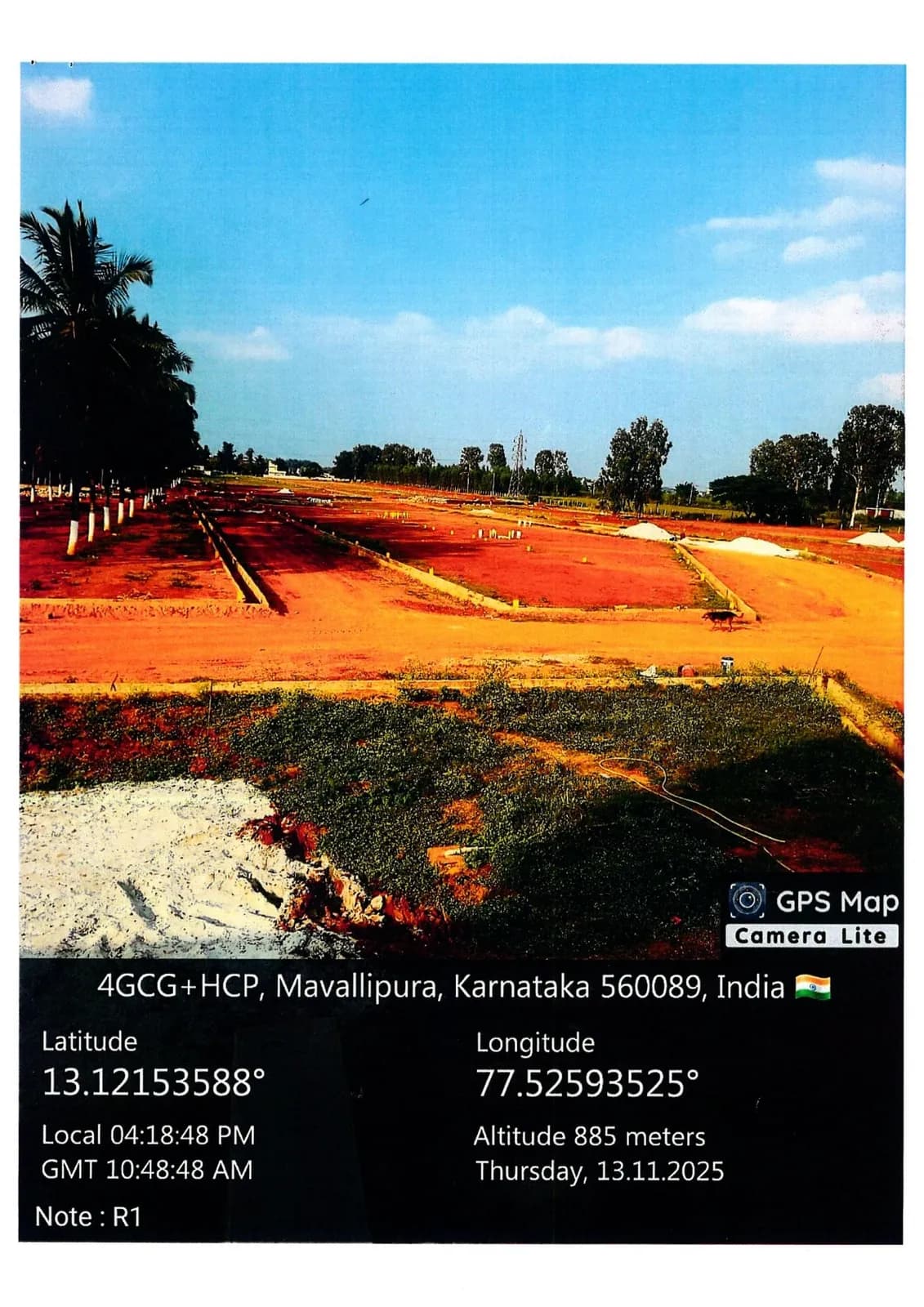

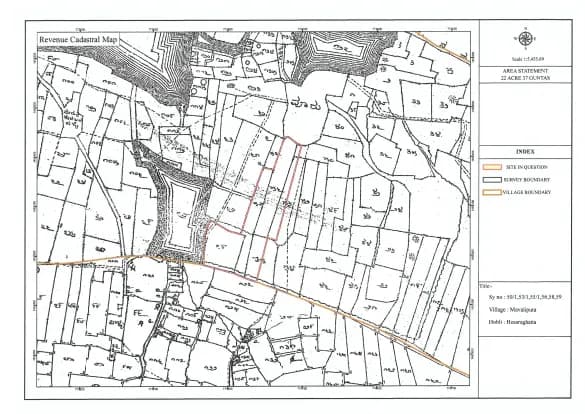

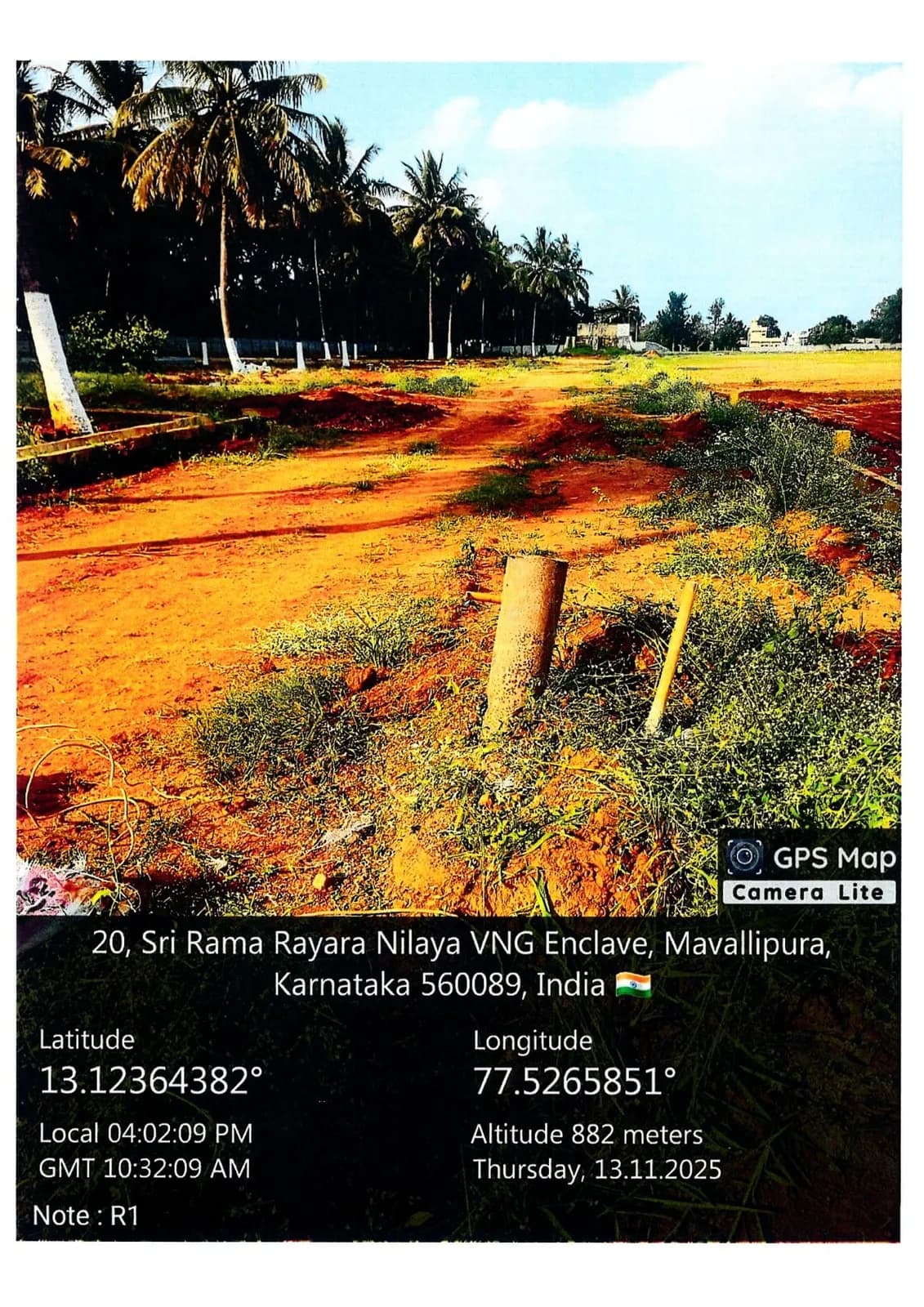

Approved layout plan3 files

Layout plan and brochure not published? The developer shares them only on request. We’ll get the brochure, layout plan and current price list for you, free.

Get brochure, layout plan & price

Brochure, layout plan and price list for Manidvipa

Developers share their brochure, layout plan and price list only on request. Tell us how to reach you and we’ll get them and send them to you, free.

Free for buyers. If you book through us, the developer pays us a commission. How we earn

Plot type (as filed)AreaPlots
Plot 9.14 m × 12.19 m—127
Plot 9.14 m × 15.24 m—43
Plot 9.14 m × 17.67 m—3
Plot 12.19 m × 14.11 m—2
Plot 12.19 m × 15.24 m—20
Plot 12.19 m × 18.28 m—16
Plot 12.19 m × 25.10 m—1
Plot 15.24 m × 14.11 m—1
Commercial site—1
Ews sites—23
High rise site—1
Odd-shaped plots—57

Plot types and counts as filed with Karnataka RERA.

We have not collected the layout plan drawing; the developer’s sales team can share it.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Manidvipa completion date and development status

  • Whole project (promoter’s RERA update)85%

    as on

Promoter’s quarterly update to RERA for Q1 2026-27, submitted 2026-07-15.

Timeline

  1. 1 Apr 2025Project start date given to RERA
  2. 16 Jan 2026Registered with Karnataka RERA
  3. 31 Mar 2027Completion date given at registration

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Construction pace from RERA quarterly filings

As on 15 Jul 2026

At the average pace so far, construction would reach 100% around Sep 2026 — about 6 months before the completion date on RERA (31 Mar 2027).

At the pace between the 2 quarterly filings we have (72% → 85% in 3 months), it would be around Oct 2026 — about 6 months before the RERA date.

0%25%50%75%100%20262027RERA date72%85%
  • Filed on RERA
  • Average pace since start
  • Pace between filings (and 0% assumed at the start date)
  • RERA completion date

Quarterly filings

QuarterFiled onDevelopedPlots booked
Q1 2026-27to 30 Jun 202615 Jul 202685%—
Q4 2025-26to 31 Mar 202615 Apr 202672%—
How we calculate

Average pace = % built ÷ months since the start date in the RERA record. Here: 85% ÷ 14.9 months (1 Apr 2025 to 30 Jun 2026) = 5.7% a month.

Estimated finish = latest filing date + (100 − % built) ÷ pace = 30 Jun 2026 + 15 ÷ 5.7 = 2.6 months → Sep 2026. This is an estimate, not a date from the builder or RERA.

Pace between filings = (85% − 72%) ÷ 3 months = 4.3% a month.

A straight line is a simplification: the builder reports one overall %, which mixes excavation, structure and finishing, and work rarely moves at a constant speed. The % values are the promoter’s own figures filed with RERA, not checked by us. Promoter’s quarterly update to RERA for Q1 2026-27, submitted 2026-07-15.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this

Approvals and documents checklist

ApprovalAuthoritySource
Layout planBDA - Bangalore Development Authority · No. BDA/TPM/PRL-57/23-24/3577/2024-25 · dated 2025-03-29Source (rera.karnataka.gov.in) (opens in a new tab)
Land conversion (10 orders)DC Office, Bangalore · No. 630102 and 9 more · dated 2025-05-29Source (rera.karnataka.gov.in) (opens in a new tab)
Approved Layout Plan/Demarcation Planscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
NOC from ESCOMsscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
NOC for Waterscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
KSPCB (If Applicable)scan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)

Documents uploaded to RERA

As on 16 Oct 2026
  • Building or layout plan · Approved drawings from the planning authorityFiled on RERA ✓ — BDA - Bangalore Development Authority · No. BDA/TPM/PRL-57/23-24/3577/2024-25 · dated 29 Mar 2025
  • Commencement certificate · Permission to start buildingNot on RERA yet
  • Environment clearance · SEIAA KarnatakaNot on RERA yet
  • Fire NOC · Karnataka Fire and Emergency ServicesNot on RERA yet
  • Pollution board consent · KSPCBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Water and sewerage · BWSSBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Electricity · BESCOMFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Height clearance · Airports Authority of IndiaNot on RERA yet
  • Occupancy certificate (OC) · Issued only when the building is finishedNot on RERA yet — expected at completion

From the documents the promoter uploaded to Karnataka RERA, collected 16 Oct 2026. “Filed” means a document is on RERA — we have not checked its contents or validity. Not every approval applies to every project (for example, smaller projects may not need an environment clearance). The project page on RERA lists each upload.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Manidvipa RERA complaints

No complaints listed on Karnataka RERA for this registration as on Source (rera.karnataka.gov.in) (opens in a new tab)

Court and consumer cases

Not found in public records yet: court cases

We list case numbers, courts and outcomes only — never names of private individuals.

About D R Developers

Promoter type
Partnership Firm
Projects on this site
1
RERA complaints against promoter
0
Company number (CIN)
Not found in public records yet: CIN

From Karnataka RERA, as collected so far (16 Oct 2026). Complaints are those RERA lists against this promoter across all its projects.

D R Developers’s RERA record

D R Developers delivery record

As on 16 Oct 2026

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this

What’s changed since Mar 2025

As on 16 Oct 2026
  1. 15 Jul 2026Quarterly update filed for Q1 2026-27: 85% built Source (rera.karnataka.gov.in) (opens in a new tab)
  2. 15 Apr 2026Quarterly update filed for Q4 2025-26: 72% built Source (rera.karnataka.gov.in) (opens in a new tab)
  3. 16 Jan 2026Registered with Karnataka RERA (PRM/KA/RERA/1251/472/PR/160126/008408); completion date 31 Mar 2027 Source (rera.karnataka.gov.in) (opens in a new tab)
  4. 1 Apr 2025Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
  5. 29 Mar 2025Building plan approved by BDA - Bangalore Development Authority (No. BDA/TPM/PRL-57/23-24/3577/2024-25) Source (rera.karnataka.gov.in) (opens in a new tab)

Newest first. No extension of the completion date is recorded on RERA. When the RERA crawl sees a new filing, complaint or extension, it is added here with its date.

Plot loan EMI calculator

No listed price found — enter one to try.

Example only — use your bank’s quote.

Monthly EMI
—
Down payment
—
Loan amount
—
Total interest
—

A calculation only, from the numbers you enter — not a loan offer.

Manidvipa FAQs

What plot sizes are available in Manidvipa?

Plots range from 30×40 ft (1,200 sq ft) to 40×82 ft (3,280 sq ft). The most common size is 30×40 ft with 127 plots. There are also 57 odd-sized plots and 23 EWS plots not listed individually.

How many plots does Manidvipa have?

Manidvipa has 295 plots in total, including 1 commercial plot.

Which authority approved the Manidvipa layout?

The layout was approved by BDA (Bangalore Development Authority).

How many land conversion orders are there for Manidvipa?

10 land conversion orders have been issued for the project.

What is the RERA registration number for Manidvipa?

The RERA registration number is PRM/KA/RERA/1251/472/PR/160126/008408, registered on 16 January 2026.

When will Manidvipa be completed?

Manidvipa is scheduled for completion on 31 March 2027.

How much of Manidvipa is developed?

As of 30 June 2026, the layout is 85% developed in terms of roads, drains and utilities.

Are there any RERA complaints against Manidvipa or D R Developers?

There are no RERA complaints on this project and no complaints against the developer on any project.

Where is Manidvipa located?

Manidvipa is in Mavallipura, Yelahanka taluk, Bengaluru Urban district, PIN 560089.

Written by AI from the RERA record above on 17 Oct 2026. Answers use only that record; check them against the source before you decide.

Questions about Manidvipa

No questions published yet. Ask the first one: you get an instant answer from this page’s public record, and our team follows up on anything the record does not show.

Bought a plot from D R Developers? Review the developer.

Reviews of D R Developers by verified buyers

No verified reviews of D R Developers yet. If you bought a plot from them, your review helps other buyers.

How reviews work: only buyers and owners can review; we confirm each purchase by phone before publishing, publish positive and negative reviews alike, never accept payment for reviews, and the developer may reply.

Similar projects within 5 km

ProjectDistancePlotsCompletion (RERA)DevelopedComplaintsPrice
Fresh as a DaisyHNG Developers0.6 km118Dec 202891%0Not collected
Earthis AkashEarthis Akash Reality LLP1.4 km159Dec 2025—0Not collected
KGF Ozone NestAfnan Construction1.8 km328Jan 202860%0Not collected

Projects of the same kind within 5 km in a straight line of this project’s RERA map point, nearest first. % built is the promoter’s latest quarterly figure on RERA (shown for single-registration projects); prices are from the developer’s own website where we found one.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Sources and last checked dates

  1. Karnataka RERA — project register (search by the registration number) (opens in a new tab)

Collected on 16 Oct 2026 by AI research agents reading public pages. Facts are written in our own words. Not found yet: price; court cases; landmarks; specifications; news.

How to check on RERA: On rera.karnataka.gov.in/viewAllProjects, type the registration number in 'Registration No', press Search, then click the 'View Project Details' icon. Complaints open from the 'Complaints / Litigation' icon in the same row. Registration number: PRM/KA/RERA/1251/472/PR/160126/008408.

  • RERA record last checked: 16 Oct 2026
  • Last change in the record (registration, quarterly filing or complaint): 15 Jul 2026

How this page is made: software builds it from public records (Karnataka RERA filings, OpenStreetMap, the developer’s own website). AI is used only to read filings into fields and to write the plain-English summary and FAQ answers, which are checked against the record. Facts are checked automatically against the RERA filing. Methodology · How we earn · Report an error
