Mythri Sity
1, 2, 3 & 4 BHK apartments by Mythri Builders · Kodathi–Carmelaram, Bengaluru
Kodathi–Carmelaram, BengaluruOpen on Google Maps (opens in a new tab)
- Under construction
- RERA registered
- residential
Price: Price on request

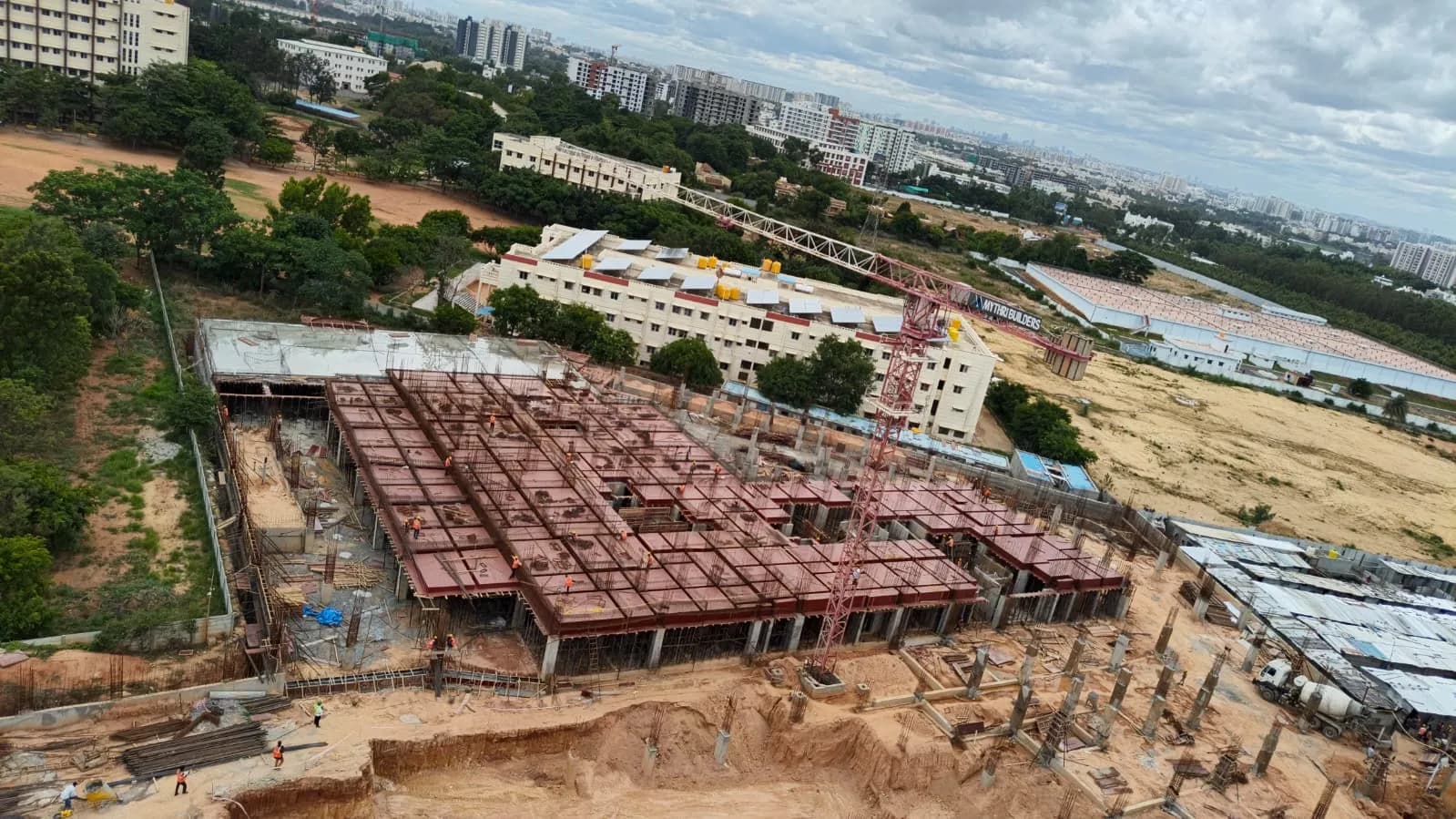

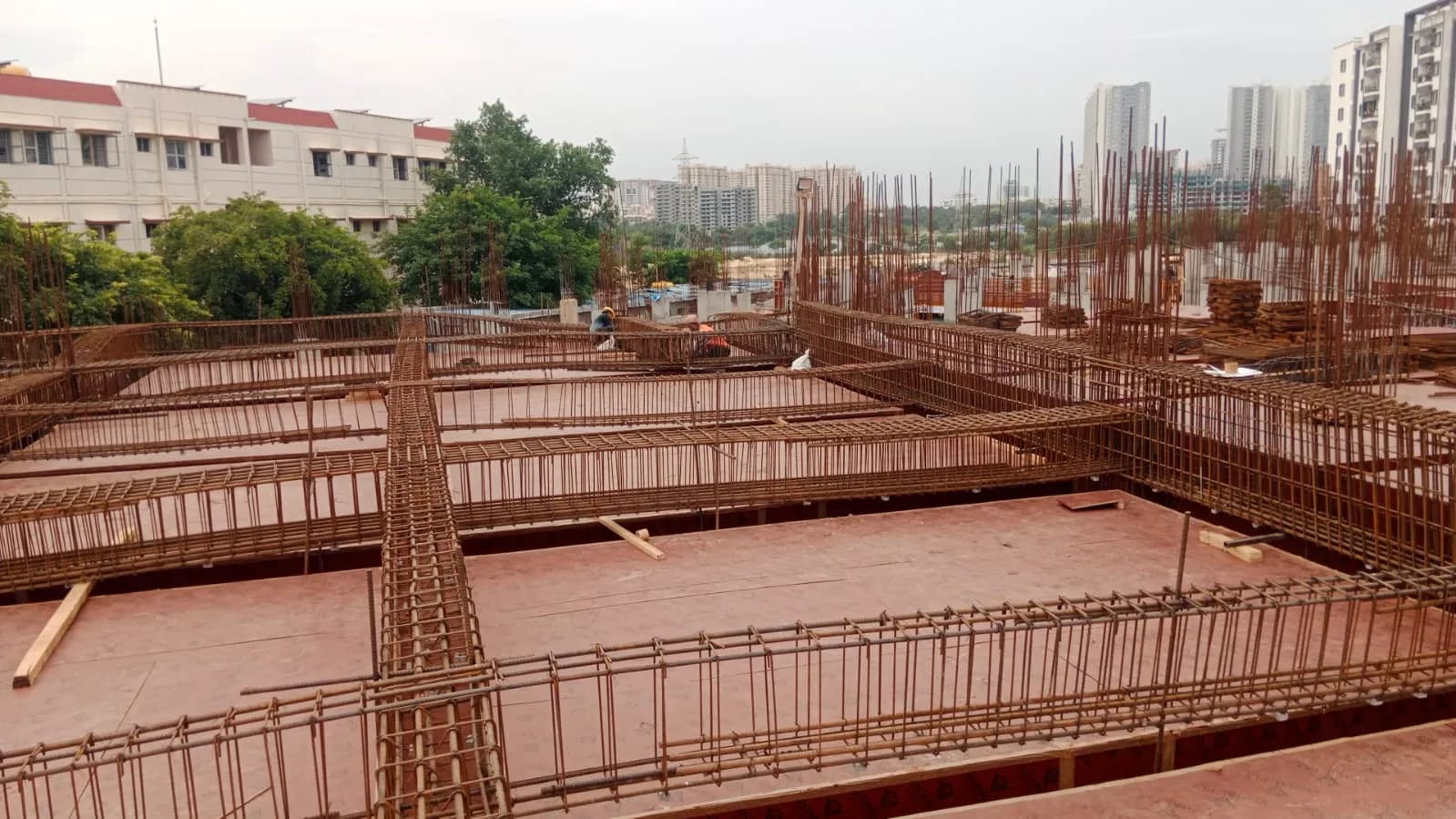

Site photo filed with Karnataka RERA Karnataka RERA filing · Source ↗ (opens in a new tab)
Mythri Sity at a glance
- Possession (RERA)Aug 2029Karnataka RERA
- Construction30% built · on pace for Jan 2030 5 mo after RERA dateRERA filing to 30 Sep 2026; estimate from average pace
- Homes booked321 of 468 (69%)RERA update · as on 30 Sep 2026
- RERA complaints (project)None listedKarnataka RERA · as on 20 Oct 2026
- Approvals filed8 of 9 on RERAKarnataka RERA uploads · 20 Oct 2026
- Nearest metroElectronic City · 5.23 kmstraight line · OpenStreetMap, 5 Oct 2026
- Airport driveapprox. 142 min at peak35.06 km straight line · estimate
- Nearest lakeHadosiddapura Lake · 444 mFrom the RERA map point · OpenStreetMap, 5 Oct 2026
Project summary
Mythri Sity is a residential project by Mythri Builders in Kodathi, Bengaluru with 468 homes, registered with Karnataka RERA. The completion date on RERA is 1 Aug 2029.
Facts collected on 20 Oct 2026 from public records — each linked to its source. Free for buyers. If you book through us, the builder pays us a commission.
Mythri Sity buyers’ group: join to ask for a group price
No one has joined yet. Be one of the first 10 buyers in this group — the founding members.
Join free. When enough buyers have joined, our agent partner asks Mythri Builders for a group price — for example a lower price, an easier payment plan or waived charges. Nothing is promised: you see what the builder offers and book directly with the builder if you want to. Free for buyers. If you book through us, the builder pays us a commission.
- Gathering buyers
- Talking to the builder
- Group offer
- Group site visit
- Booking
0 buyers have joined · 0 committed
Committed buyers have confirmed their budget, home type and timeline with us on a call; builders negotiate with them. Joining is free and never obliges you to buy.
Join the Mythri Sity buyers’ groupHow group buying works
See it for yourself
Visit the site with our team, or get a call to clear your questions. Free, no obligation.
Key facts: home types, towers, land and possession
- Home types
- Studio, 1 BHK, 2 BHK, 3 BHK, +1 more
- Carpet area
- 106 – 1,594 sq ft
- Towers
- 2
- Floors
- 18
- Total homes
- 468
- Land
- 5 acres
- Possession (RERA)
- Aug 2029
- Built (RERA update)
- 30%
Mythri Sity RERA number and registration details
- RERA number
- PRM/KA/RERA/1251/446/PR/300525/007802
- Registered on
- 30 May 2025
- Promised completion
- 1 Aug 2029
- Extended to
- No extension recorded
- RERA status
- Under construction
- Homes booked
- 321 of 468 as on
- Price
- Not found in public records yet: price
- Project type
- Residential
Towers and blocks (RERA filing)
| Tower | Floors | Basements | Homes |
|---|---|---|---|
| Mythri Sity_Tower-1 | 18 | 1 | 226 |
| Mythri Sity_Tower-2 | 18 | 1 | 242 |
A dash (—) means the filing did not state that value.
Summary in plain English
Mythri Sity is a residential project by Mythri Builders in Kodathi, Bengaluru East with 468 homes across 2 towers. The project is 30% complete as of 30 September 2026, with completion expected on 1 August 2029.
Written by AI from the RERA record above on 20 Oct 2026. Every number in it was checked against that record; if anything differs, the record wins.
Open space, home loans, escrow and other details
- Open space
- 79.5% of land
- Water and power
- Water source filed with RERA: Local Authority
- Home loans: approved banks
- Not found in public records yet: bank approvals
- Payment plans
- Not found in public records yet: payment plans
- Maintenance
- Not found in public records yet: maintenance
- Car parking
- Not found in public records yet: car parking charge
- Escrow bank (RERA)
- ICICI Bank, Bellandur
- Building plan (RERA)
- BDA - Bangalore Development Authority · No. BDA/Plan Sanction/EM/EO-01/TA-2/East/05/2025-06 · dated 3 May 2025
- Project cost declared to RERA
- ₹296 Cr
Open area as a share of the land, from the areas filed with RERA (includes driveways and landscaped areas).
Amenities
- Electricity
- CCTV Surveillance
- Club House
- Community Hall
- Outdoor Sports facility
- Indoor Sports facility
- Swimming Pool
- Gym
- Parks
- Power Backup
- Water and Sanitation
Amenities and internal works as filed by the promoter with Karnataka RERA; we have not visited the site.
Mythri Sity location and address
- Address
- Survey No. 67/2 Kodathi Village, Varthur Hobli , Bangalore East Taluk , Bengaluru East , Bengaluru Urban, Karnataka - 560087
- Village (RERA)
- Kodathi
- Locality
- Kodathi–CarmelaramAlso known as Kodathi, Carmelaram
- PIN code
- 560087
- City
- Bengaluru
- State
- Karnataka
- Coordinates
- 12.88544, 77.70161
Distances to landmarks
Not found in public records yet: landmarksAbout Kodathi–Carmelaram
Not found in public records yet: locality factsCommute times to tech parks and the airport
| To | Straight line | Peak-hour drive (estimate) |
|---|---|---|
| Outer Ring Road tech corridor (RMZ Ecospace, Bellandur)Map point on OpenStreetMap (opens in a new tab) | 4.79 km | approx. 19 min |
| Electronic City Phase 1Map point on OpenStreetMap (opens in a new tab) | 5.62 km | approx. 23 min |
| ITPL, Whitefield (main gate)Map point on OpenStreetMap (opens in a new tab) | 12.02 km | approx. 49 min |
| KSR Bengaluru City railway station (Majestic)Map point on OpenStreetMap (opens in a new tab) | 17.64 km | approx. 71 min |
| Manyata Tech ParkMap point on OpenStreetMap (opens in a new tab) | 20.14 km | approx. 82 min |
| Kempegowda International AirportMap point on OpenStreetMap (opens in a new tab) | 35.06 km | approx. 142 min |
How we calculate
Straight line: from the project’s map point on RERA to the destination’s point on OpenStreetMap.
Peak-hour drive is a rough estimate, not a route: straight line × 1.35 for the road network, at 20 km/h. Real times vary a lot with the route and the hour.
Sources:Source (openstreetmap.org) (opens in a new tab)How we calculate this
Schools and hospitals nearby
Within 2 km
- 13Schools and colleges9 schools, 3 colleges, 1 kindergartens
- 2Hospitals and clinics1 hospitals, 1 clinics
Nearest schools and colleges
- Bangalore Technological Institute · 0.2 km
- Vidya Shri College · 0.22 km
- Prakriya Green Wisdom School · 0.45 km
Nearest hospitals and clinics
- Kodathi Primary Health Centre · 1.39 km
- Punarjani Ayurvedic Multispeciality Hospital · 1.42 km
Places as mapped on OpenStreetMap (amenity=school, college, kindergarten, university; hospital, clinic), counted within 2 km in a straight line of the RERA map point. Volunteers map these, so some places may be missing or closed. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Nearest metro station and railway
- Electronic City (ಎಲೆಕ್ಟ್ರಾನಿಕ್ ಸಿಟಿ)Open now — nearest operating metro station5.23 km
- Carmelaram (ಕರ್ಮೇಲರಮ್)Nearest railway station2.48 km
Straight-line distances from the RERA map point to the station points mapped on OpenStreetMap; status (open or under construction) as tagged there. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Lake and lake-buffer check
The nearest mapped lake is Hadosiddapura Lake, 444 m from the project’s RERA map point.
The site boundary is not published as a shape, so its nearest edge can be closer than this point. Whether any building sits inside a lake buffer can only be checked on the approved plan.
- Hadosiddapura Lake on OpenStreetMap (opens in a new tab) (ಹಾಡೋಸಿದ್ದಾಪುರ ಕೆರೆ)444 m
- Gattahalli Lake on OpenStreetMap (opens in a new tab) (ಗಟ್ಟಹಳ್ಳಿ ಕೆರೆ)1,122 m
- Halanayakanahalli Lake on OpenStreetMap (opens in a new tab) (ಹಳನಾಯಕನಹಳ್ಳಿ ಸರೋವರ)1,397 m
The buffer rule
Bengaluru’s lake buffer rule has changed over time: the National Green Tribunal ordered a 75 m buffer in May 2016; the Supreme Court set that order aside on 5 March 2019, leaving the 30 m buffer of the Revised Master Plan 2015. Check the current rule and the approved plan before relying on either number.
- LiveLaw: SC sets aside NGT order enlarging buffer zones (2019) (livelaw.in) (opens in a new tab)
- Citizen Matters: Shrinking lake buffers (citizenmatters.in) (opens in a new tab)
Shortest distance from the RERA map point to the mapped water edge (OpenStreetMap water polygons tagged lake or reservoir, or named lake/kere/tank). Mapped shorelines can differ from the revenue-record boundary of a lake. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Sources:Source (openstreetmap.org) (opens in a new tab)Source (livelaw.in) (opens in a new tab)Source (citizenmatters.in) (opens in a new tab)How we calculate this
Satellite time-lapse of the site
Satellite photos load when you scroll to them.
Photos from Esri World Imagery Wayback, centred on the project’s map point; dates are the capture dates in Esri’s metadata. Loaded from Esri when you scroll here.
Sources:Source (livingatlas.arcgis.com) (opens in a new tab)
Mythri Sity floor plans, brochure and elevations
Documents the builder uploaded to Karnataka RERA, shown as filed. Tap a page to see it full size; the full PDF opens on the RERA website.

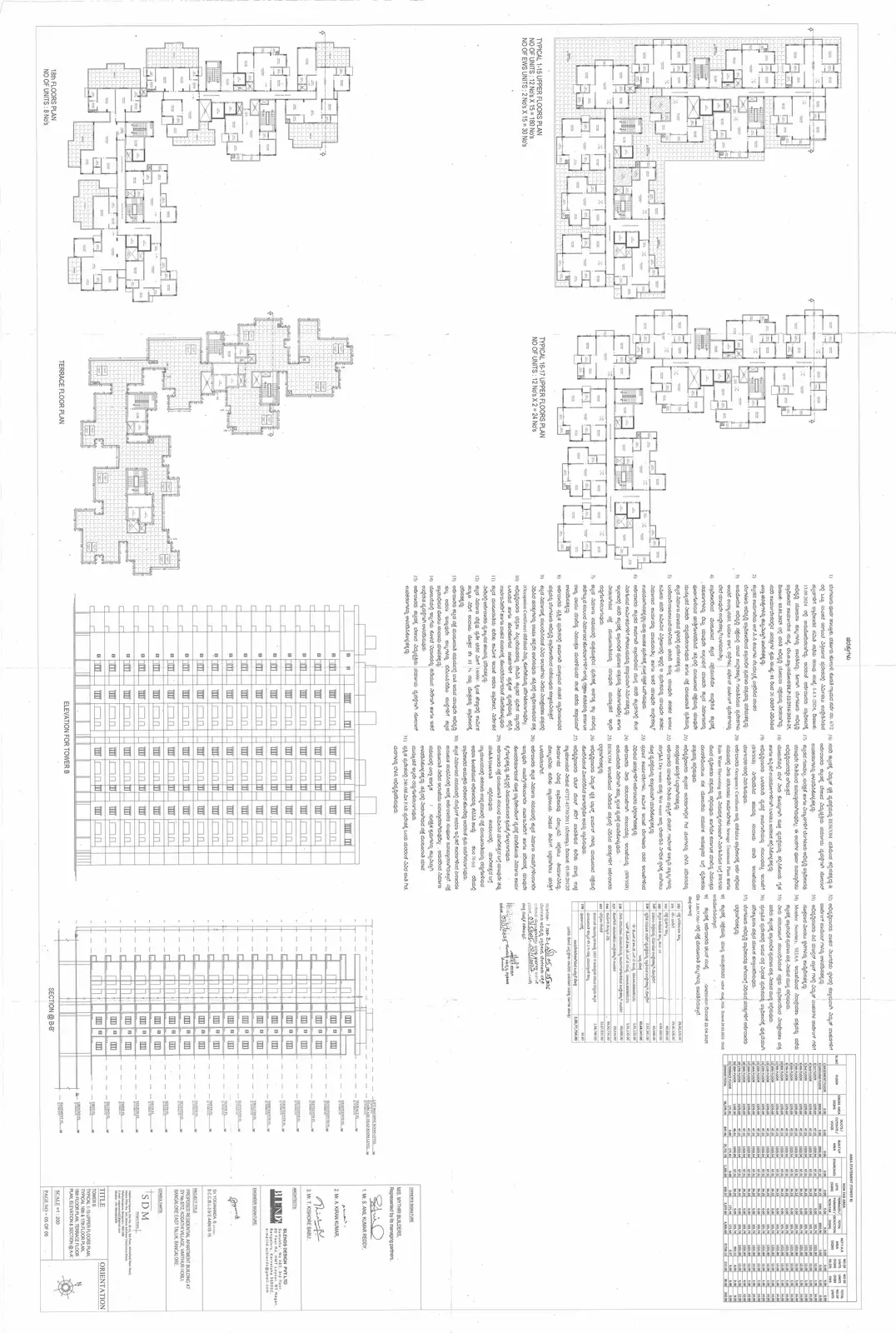

Floor plans11 files

Bangalore Urban Arts CommissionFull PDF on RERA
01 OF 05 Mythri Sity Floor Plans_compressed.pdfFull PDF on RERA
01 OF 05 Mythri Sity Floor Plans_compressed.pdfFull PDF on RERA

02 OF 05 Mythri Sity Floor Plans_compressed.pdfFull PDF on RERA
02 OF 05 Mythri Sity Floor Plans_compressed.pdfFull PDF on RERA

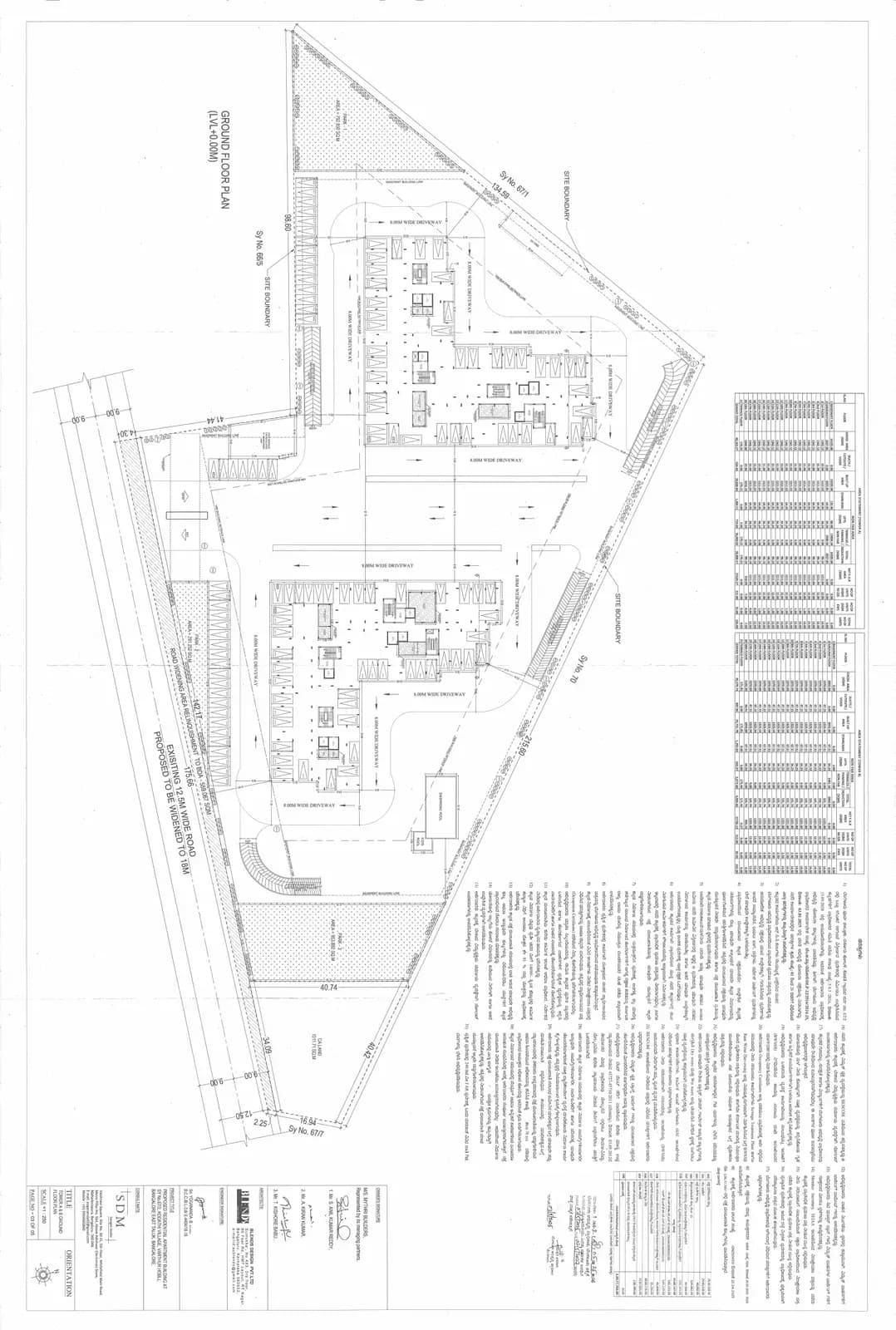

03 OF 05 Mythri Sity Floor Plans_compressed.pdfFull PDF on RERA
03 OF 05 Mythri Sity Floor Plans_compressed.pdfFull PDF on RERA

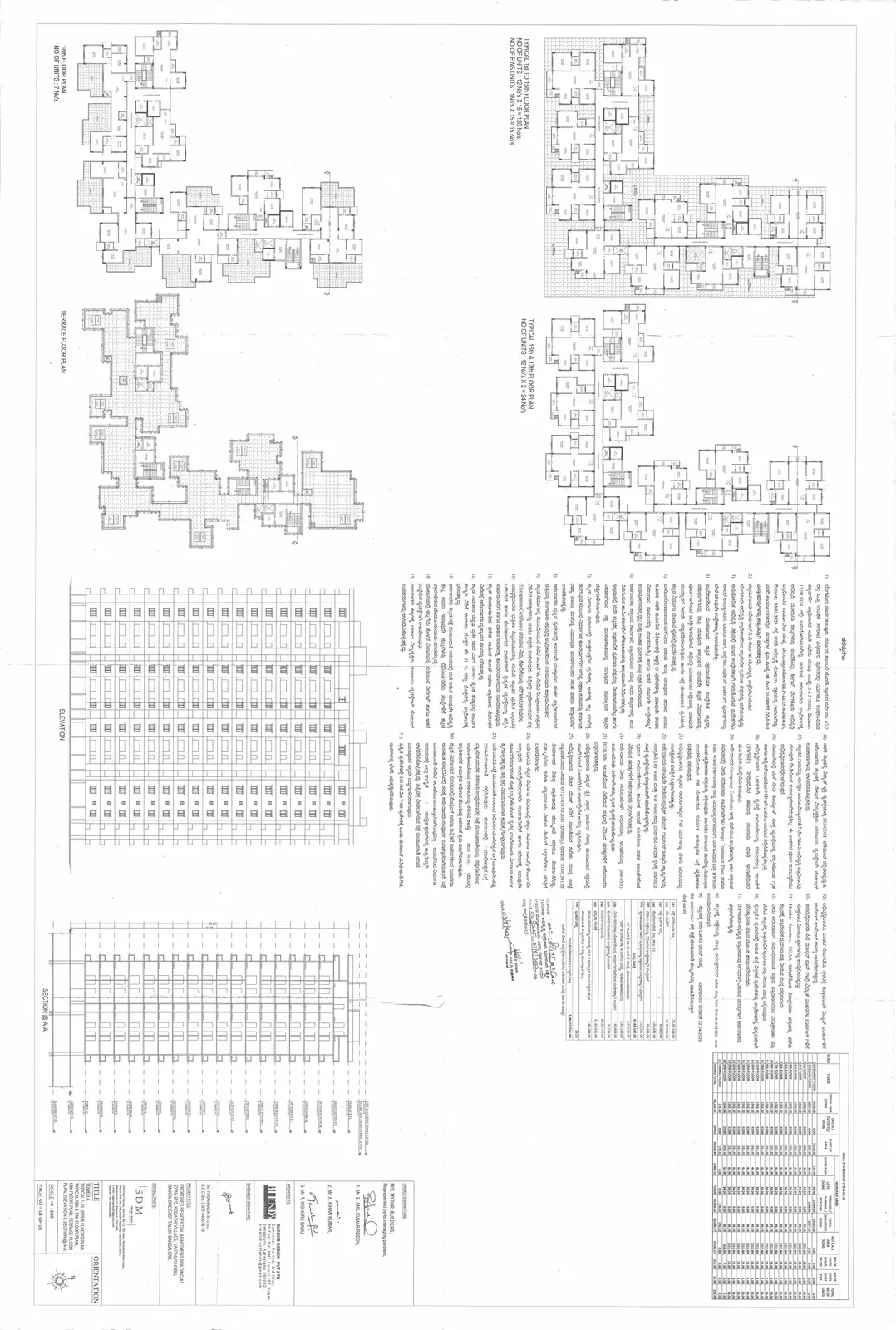

04 OF 05 Mythri Sity Floor Plans_compressed.pdfFull PDF on RERA
04 OF 05 Mythri Sity Floor Plans_compressed.pdfFull PDF on RERA
05 OF 05 Mythri Sity Floor Plans_compressed.pdfFull PDF on RERA
05 OF 05 Mythri Sity Floor Plans_compressed.pdfFull PDF on RERA

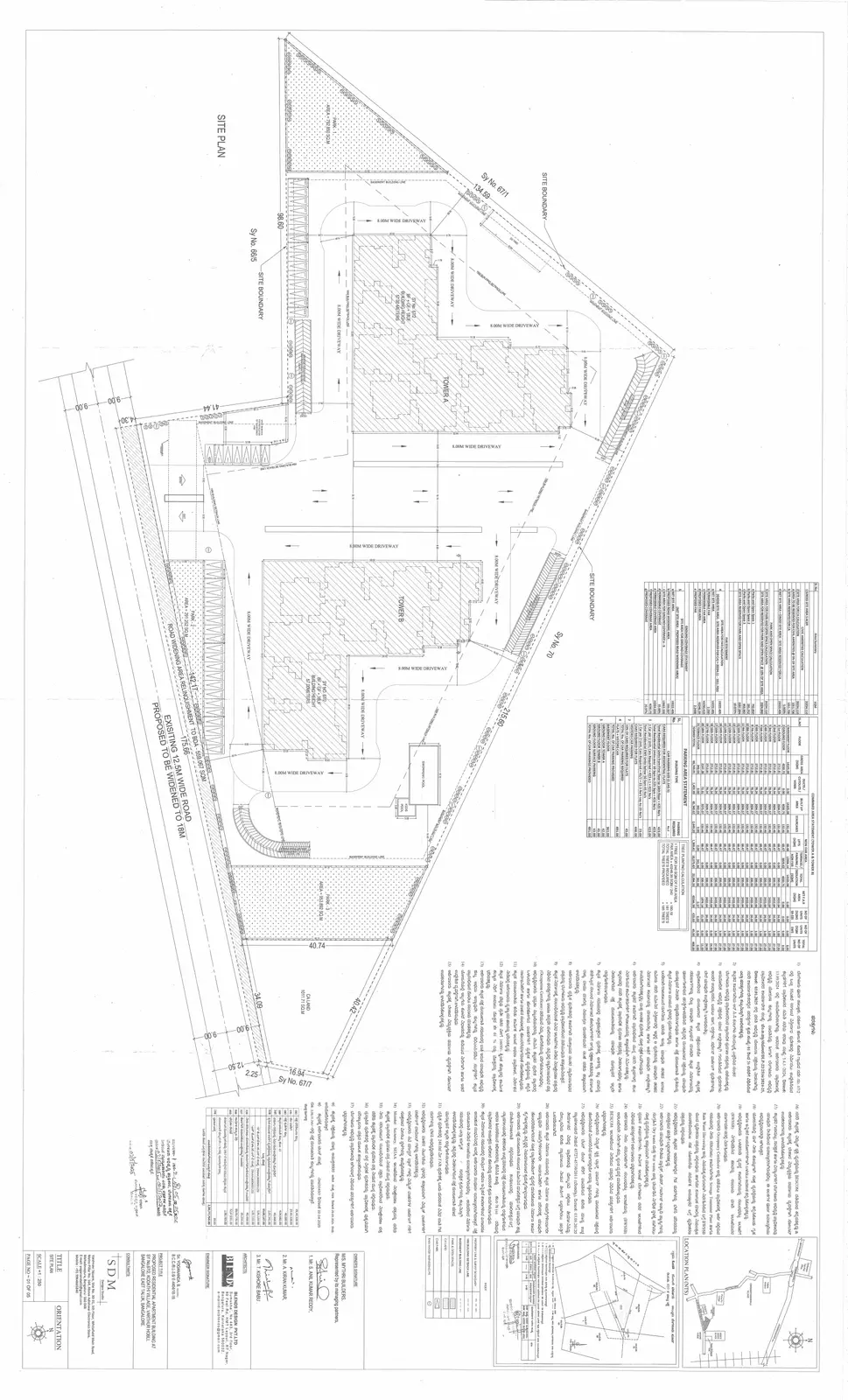

Approved building plan5 pages

Approved Building PlanFull PDF on RERA
| Home type | Carpet area | Homes |
|---|---|---|
| 1 BHK | 502 – 515 sq ft | 45 |
| 2 BHK | 693 – 754 sq ft | 166 |
| 3 BHK | 106 – 1,478 sq ft | 211 |
| 4 BHK | 1,594 sq ft | 1 |
| Ews | 176 – 181 sq ft | 45 |
| Studio | 177 sq ft | 45 |
Home types, counts and carpet areas as filed with Karnataka RERA (carpet area, not super built-up).
We have not collected floor-plan drawings; the builder’s sales team can share them.
Mythri Sity possession date and construction status
Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-14.
By tower (Q2 2026-27)
Units sold and unsold, from RERA (Q2 2026-27)
| Type | Homes | Booked | Available |
|---|---|---|---|
| 1 BHK | 45 | 27 | 18 |
| 2 BHK | 166 | 124 | 42 |
| 3 BHK | 211 | 143 | 68 |
| 4 BHK | 1 | 0 | 1 |
| EWS | 45 | 27 | 18 |
As reported by the promoter in the quarterly update to RERA, not verified by us.
Timeline
- 3 May 2025Project start date given to RERA
- 30 May 2025Registered with Karnataka RERA
- 1 Aug 2029Completion date given at registration
Construction pace from RERA quarterly filings
At the average pace so far, construction would reach 100% around Jan 2030 — about 5 months after the completion date on RERA (1 Aug 2029).
At the pace between the 4 quarterly filings we have (15% → 30% in 9 months), it would be around Mar 2030 — about 8 months after the RERA date.
- Filed on RERA
- Average pace since start
- Pace between filings (and 0% assumed at the start date)
- RERA completion date
Quarterly filings
| Quarter | Filed on | Built | Homes booked |
|---|---|---|---|
| Q2 2026-27to 30 Sep 2026 | 14 Oct 2026 | 30% | 321 of 468 |
| Q1 2026-27to 30 Jun 2026 | 13 Jul 2026 | 26% | 254 of 468 |
| Q4 2025-26to 31 Mar 2026 | 14 Apr 2026 | 22% | 300 of 468 |
| Q3 2025-26to 31 Dec 2025 | 26 Jan 2026 | 15% | 251 of 468 |
How we calculate
Average pace = % built ÷ months since the start date in the RERA record. Here: 30% ÷ 16.9 months (3 May 2025 to 30 Sep 2026) = 1.8% a month.
Estimated finish = latest filing date + (100 − % built) ÷ pace = 30 Sep 2026 + 70 ÷ 1.8 = 39.5 months → Jan 2030. This is an estimate, not a date from the builder or RERA.
Pace between filings = (30% − 15%) ÷ 9 months = 1.7% a month.
A straight line is a simplification: the builder reports one overall %, which mixes excavation, structure and finishing, and work rarely moves at a constant speed. The % values are the promoter’s own figures filed with RERA, not checked by us. Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-14.
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
Approvals and documents checklist
11 rows: approvals. Scroll inside the table to see them all.
| Approval | Authority | Source |
|---|---|---|
| Building plan | BDA - Bangalore Development Authority · No. BDA/Plan Sanction/EM/EO-01/TA-2/East/05/2025-06 · dated 2025-05-03 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Land conversion | District Commissioner Bangalore Urban · No. 628202 · dated 2024-03-13 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Commencement Certificate | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Building Plan | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| ESCOM/Electricity | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KWSSB/Water | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KSPCB | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| SEIAA | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Fire Force Department | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Airport Authority of India | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| NOC in case of building proposals abutting to neighbouring properties | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
Documents uploaded to RERA
- Building or layout plan · Approved drawings from the planning authorityFiled on RERA ✓ — BDA - Bangalore Development Authority · No. BDA/Plan Sanction/EM/EO-01/TA-2/East/05/2025-06 · dated 3 May 2025
- Commencement certificate · Permission to start buildingFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Environment clearance · SEIAA KarnatakaFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Fire NOC · Karnataka Fire and Emergency ServicesFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Pollution board consent · KSPCBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Water and sewerage · BWSSBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Electricity · BESCOMFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Height clearance · Airports Authority of IndiaFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Occupancy certificate (OC) · Issued only when the building is finishedNot on RERA yet — expected at completion
From the documents the promoter uploaded to Karnataka RERA, collected 20 Oct 2026. “Filed” means a document is on RERA — we have not checked its contents or validity. Not every approval applies to every project (for example, smaller projects may not need an environment clearance). The project page on RERA lists each upload.
Mythri Sity RERA complaints
No complaints listed on Karnataka RERA for this registration as on Source (rera.karnataka.gov.in) (opens in a new tab)
Court and consumer cases
We list case numbers, courts and outcomes only — never names of private individuals.
About Mythri Builders
- Promoter type
- Partnership Firm
- Projects on this site
- 5
- RERA complaints against promoter
- 0
- Company number (CIN)
- Not found in public records yet: CIN
From Karnataka RERA, as collected so far (20 Oct 2026). Complaints are those RERA lists against this promoter across all its projects.
Mythri Builders’s RERA recordMythri Builders delivery record
- 5Projects in Bengaluru on RERA5 approved registrations under Mythri Builders in Bengaluru Urban and Rural. Source (rera.karnataka.gov.in) (opens in a new tab)
- 1,100Homes registeredAs stated in each registrations.
- 0RERA complaintsas on Source (rera.karnataka.gov.in) (opens in a new tab)
- 0Complaints per 1,000 homes0 complaints ÷ 1,100 homes in its 5 registrations on Karnataka RERA in Bengaluru.
- 1Completion filed on RERARegistrations where the promoter applied to RERA for completion; 1 with an occupancy certificate on RERA.
- 1 of 1Filed by the date given at registrationMedian gap 0 months (on-time ones count as 0). The completion application can come after handover, so this is an upper bound on lateness.
Completion filed on RERA
| Project | Date at registration | Completion filed | Gap |
|---|---|---|---|
| Mythri SignatureOC on RERA | 30 Jun 2026 | 5 Feb 2026 | By the date |
Measured against the completion date given at registration; many projects had RERA extensions (including the COVID-period extension), shown under the date.
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
What’s changed since May 2025
- 14 Oct 2026Quarterly update filed for Q2 2026-27: 30% built, 321 of 468 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 13 Jul 2026Quarterly update filed for Q1 2026-27: 26% built, 254 of 468 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 14 Apr 2026Quarterly update filed for Q4 2025-26: 22% built, 300 of 468 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 26 Jan 2026Quarterly update filed for Q3 2025-26: 15% built, 251 of 468 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 30 May 2025Registered with Karnataka RERA (PRM/KA/RERA/1251/446/PR/300525/007802); completion date 1 Aug 2029 Source (rera.karnataka.gov.in) (opens in a new tab)
- 3 May 2025Building plan approved by BDA - Bangalore Development Authority (No. BDA/Plan Sanction/EM/EO-01/TA-2/East/05/2025-06) Source (rera.karnataka.gov.in) (opens in a new tab)
- 3 May 2025Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
Newest first. No extension of the completion date is recorded on RERA. When the RERA crawl sees a new filing, complaint or extension, it is added here with its date.
Home loan EMI calculator
- Monthly EMI
- —
- Down payment
- —
- Loan amount
- —
- Total interest
- —
A calculation only, from the numbers you enter — not a loan offer.
All-in cost: GST, registration and other charges
The calculator loads when you scroll to it.
Assumptions
- Base price: the builder’s price is not published in a form we could collect — enter it from the cost sheet.
- GST 5% on the base price and charges — the usual rate for an under-construction home that is not “affordable housing” (1%).
- Stamp duty about 5.6% and registration 2% — the Karnataka rule (registration was raised from 1% to 2% on 31 Aug 2025). Calculated on the agreement value.
- Car parking, other charges and the maintenance deposit are not in the public record we collect; enter them from the builder’s cost sheet.
- Loan on the agreement value (banks usually lend up to 75–90%); EMI is the standard reducing-balance formula. Example rate only — use your bank’s quote.
Mythri Sity FAQs
What is Mythri Sity?
Mythri Sity is a residential project developed by Mythri Builders in Kodathi, Bengaluru East, with 468 homes across 2 towers of up to 18 floors.
When will Mythri Sity be completed?
The project completion date on RERA is 1 August 2029.
What home types are available in Mythri Sity?
The project has EWS (176-181 sq ft carpet area), Studio (177 sq ft), 1 BHK (502-515 sq ft), 2 BHK (693-754 sq ft), 3 BHK (106-1,478 sq ft), and 4 BHK (1,594 sq ft).
How many homes are in Mythri Sity?
The project has 468 homes: 45 EWS units, 45 Studios, 45 one-bedroom homes, 166 two-bedroom homes, 211 three-bedroom homes, and 1 four-bedroom home.
What is the RERA registration number for Mythri Sity?
The RERA registration number is PRM/KA/RERA/1251/446/PR/300525/007802, registered on 30 May 2025.
What is the construction progress of Mythri Sity?

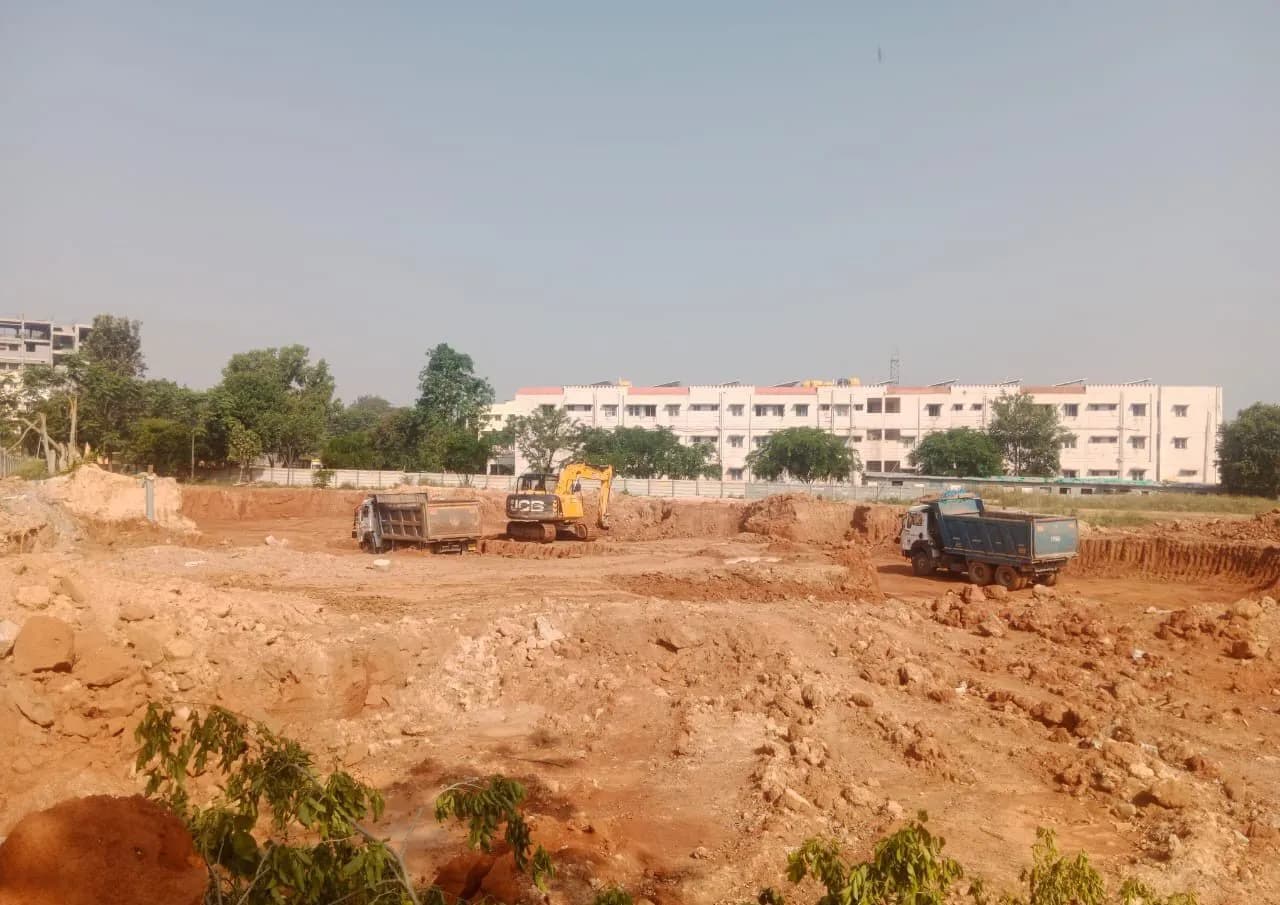

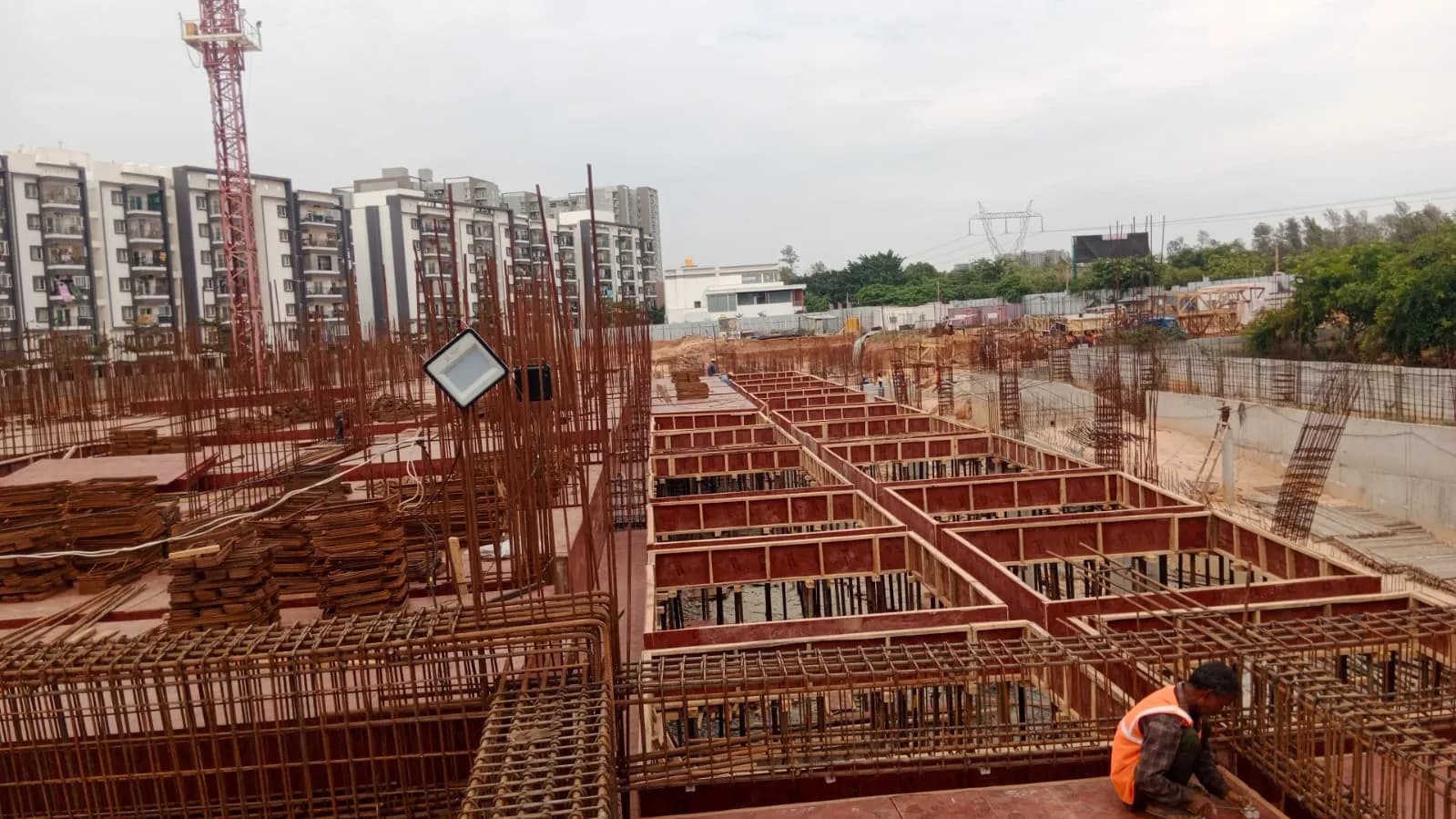

As of 30 September 2026, the project is 30% complete with 321 homes booked out of 468.
Where is Mythri Sity located?
Mythri Sity is in Kodathi, Bengaluru East taluk, Bengaluru Urban district, PIN code 560087.
Are there any RERA complaints against Mythri Sity?
There are no RERA complaints on this project and no complaints against Mythri Builders across its 7 projects on record.
Who is the escrow bank for Mythri Sity?
ICICI Bank is the escrow bank for the project.
How many projects does Mythri Builders have on RERA?
Mythri Builders has 7 projects in the Bengaluru RERA records.
Written by AI from the RERA record above on 20 Oct 2026. Answers use only that record; check them against the source before you decide.
Questions about Mythri Sity
No questions published yet. Ask the first one: you get an instant answer from this page’s public record, and our team follows up on anything the record does not show.
Bought a home from Mythri Builders? Review the builder.
Reviews of Mythri Builders by verified buyers
No verified reviews of Mythri Builders yet. If you bought a home from them, your review helps other buyers.
How reviews work: only buyers and owners can review; we confirm each purchase by phone before publishing, publish positive and negative reviews alike, never accept payment for reviews, and the builder may reply.
Similar projects within 5 km
| Project | Distance | Homes | Possession (RERA) | Built | Complaints | Price |
|---|---|---|---|---|---|---|
| Mythri StreetMythri Builders | 0.2 km | 219 | Dec 2029 | 26% | 0 | Not collected |
| Birla EvaraVardhita Properties Private Limited | 0.2 km | 1,594 | Dec 2031 | 12% | 0 | Not collected |
| 63 Degree EastAPG Intelli Homes Private Limited | 0.3 km | 2,475 | Dec 2026extended | — | 3 | Not collected |
| Mana Dale South -1Mana Projects Pvt Ltd | 0.6 km | 257 | Nov 2029 | 47% | 2 | Not collected |
| Godrej Lakeside OrchardGodrej Properties Limited | 0.6 km | 698 | Sep 2030 | 35% | 2 | from ₹2.37 Cr |
| Poorvi EnchantingPoorvi Infinite Private Limited | 0.7 km | 99 | Nov 2025extended | 100% | 0 | Not collected |
Projects of the same kind within 5 km in a straight line of this project’s RERA map point, nearest first. % built is the promoter’s latest quarterly figure on RERA (shown for single-registration projects); prices are from the builder’s own website where we found one.
Sources and last checked dates
Collected on 20 Oct 2026 by AI research agents reading public pages. Facts are written in our own words. Not found yet: price; court cases; landmarks; specifications; news.
How to check on RERA: On rera.karnataka.gov.in/viewAllProjects, type the registration number in 'Registration No', press Search, then click the 'View Project Details' icon. Complaints open from the 'Complaints / Litigation' icon in the same row. Registration number: PRM/KA/RERA/1251/446/PR/300525/007802.
- RERA record last checked: 20 Oct 2026
- Last change in the record (registration, quarterly filing or complaint): 20 Oct 2026
How this page is made: software builds it from public records (Karnataka RERA filings, OpenStreetMap, the builder’s own website). AI is used only to read filings into fields and to write the plain-English summary and FAQ answers, which are checked against the record. Facts are checked automatically against the RERA filing. Methodology · How we earn · Report an error
More new projects in Kodathi–Carmelaram
Kodathi–CarmelaramUnder constructionRERA registeredBuyers’ group openMythri Street
by Mythri Builders
Price: Price on requestGet brochure & price →
- 2 BHK, 3 BHK
- 766 – 1,097 sq ft
- Dec 2029
219 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Mythri Street
Kodathi–CarmelaramUnder constructionRERA registeredBuyers’ group openBirla Evara
by Vardhita Properties
Price: Price on requestGet brochure & price →
- 1 BHK, 2 BHK, 3 BHK, 4 BHK
- 410 – 1,631 sq ft
- Dec 2031
1,594 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Birla Evara
Kodathi–CarmelaramUnder constructionRERA registeredBuyers’ group open63 Degree East
by APG Intelli Homes
Price: Price on requestGet brochure & price →
- Studio, 1 BHK, 2 BHK, 3 BHK, +1 more
- 97 – 3,369 sq ft
- Dec 2026 (extended)
5 phases on RERA · 2,475 homes · 3 RERA complaints
Be one of the first 10 buyers in this groupFounding members — it’s free
