Sattva Aeropolis Phase 2

1 & 3 BHK apartments by Sattva Resi Private Limited · Udayagiri, Bellary Road (Airport Road), Bengaluru

Udayagiri, Bellary Road (Airport Road), BengaluruOpen on Google Maps (opens in a new tab)

  • Under construction
  • RERA registered
  • residential

by Sattva Resi Private Limited · registered with RERA by Trinayani Realtors Private Limited

Price: Price on request

Get brochure, floor plans & price

Brochure, floor plans and price list for Sattva Aeropolis Phase 2

Builders share their brochure, floor plans and price list only on request. Tell us how to reach you and we’ll get them and send them to you, free.

Free for buyers. If you book through us, the builder pays us a commission. How we earn

Project summary

Sattva Aeropolis Phase 2 is a residential project by Sattva Resi Private Limited in Udayagiri, Bengaluru with 554 homes, registered with Karnataka RERA. The completion date on RERA is 16 Oct 2028.

Facts collected on 19 Oct 2026 from public records — each linked to its source. Free for buyers. If you book through us, the builder pays us a commission.

Sattva Aeropolis Phase 2 buyers’ group: join to ask for a group price

No one has joined yet. Be one of the first 10 buyers in this group — the founding members.

Join free. When enough buyers have joined, our agent partner asks Sattva Resi Private Limited for a group price — for example a lower price, an easier payment plan or waived charges. Nothing is promised: you see what the builder offers and book directly with the builder if you want to. Free for buyers. If you book through us, the builder pays us a commission.

  1. Gathering buyers
  2. Talking to the builder
  3. Group offer
  4. Group site visit
  5. Booking

0 buyers have joined · 0 committed

Committed buyers have confirmed their budget, home type and timeline with us on a call; builders negotiate with them. Joining is free and never obliges you to buy.

Join the Sattva Aeropolis Phase 2 buyers’ groupHow group buying works

See it for yourself

Visit the site with our team, or get a call to clear your questions. Free, no obligation.

Key facts: home types, towers, land and possession

Updated on 19 Oct 2026
Home types
1 BHK, 3 BHK
Carpet area
176 – 644 sq ft
Towers
3
Floors
11
Total homes
554
Land
2.35 acres
Possession (RERA)
Oct 2028
Built (RERA update)
39%

Sattva Aeropolis Phase 2 RERA number and registration details

RERA number
PRM/KA/RERA/1250/303/PR/250925/008119
Registered on
25 Sep 2025
Promised completion
16 Oct 2028
Extended to
No extension recorded
RERA status
New launch
Homes booked
325 of 554 as on
Price
Not found in public records yet: price
Project type
Residential

Towers and blocks (RERA filing)

TowerFloorsBasementsHomes
Block A- Wing 1111154
Block A Wing 2111220
Block E101180

A dash (—) means the filing did not state that value.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Summary in plain English

Sattva Aeropolis Phase 2 is a residential project by Trinayani Realtors Private Limited in Udayagiri, Devanahalli, with 554 homes across 3 towers. The project is registered with Karnataka RERA and has a completion date of 16 October 2028.

Written by AI from the RERA record above on 19 Oct 2026. Every number in it was checked against that record; if anything differs, the record wins.

Open space, home loans, escrow and other details

Open space
73% of land
Water and power
Water source filed with RERA: Others
Home loans: approved banks
Not found in public records yet: bank approvals
Payment plans
Not found in public records yet: payment plans
Maintenance
Not found in public records yet: maintenance
Car parking
Not found in public records yet: car parking charge
Escrow bank (RERA)
ICICI Bank, Commissariat Road
Building plan (RERA)
BIAPPA - Bangalore Airport Area Planning Authority · No. BIAAPA/TP/CC/289/2025-26 · dated 2 Sep 2025
Project cost declared to RERA
₹122 Cr

Open area as a share of the land, from the areas filed with RERA (includes driveways and landscaped areas).

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Amenities

  • Electricity
  • CCTV Surveillance
  • Outdoor Sports facility
  • Indoor Sports facility
  • Gym
  • Parks
  • Power Backup
  • Piped Gas
  • Water and Sanitation

Amenities and internal works as filed by the promoter with Karnataka RERA; we have not visited the site.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Sattva Aeropolis Phase 2 location and address

Address
Sy. Nos. 39/2,41/1,43,44 and 75/1 at Udayagiri Village, , Kasaba Hobli, Devanhalli Taluk, National Highway No.7 , Devanahalli , Bengaluru Rural, Karnataka - 562157
Village (RERA)
Udayagiri
Locality
Bellary Road (Airport Road)Also known as Airport Road, International Airport Road, Bellary Road, NH 44
PIN code
562157
City
Bengaluru
State
Karnataka
Coordinates
13.21075, 77.67299

Distances to landmarks

Not found in public records yet: landmarks

About Bellary Road (Airport Road)

Not found in public records yet: locality facts

Commute times to tech parks and the airport

As on 5 Oct 2026
ToStraight linePeak-hour drive (estimate)
Kempegowda International AirportMap point on OpenStreetMap (opens in a new tab)3.58 kmapprox. 14 min
Manyata Tech ParkMap point on OpenStreetMap (opens in a new tab)18.97 kmapprox. 77 min
ITPL, Whitefield (main gate)Map point on OpenStreetMap (opens in a new tab)25.78 kmapprox. 104 min
KSR Bengaluru City railway station (Majestic)Map point on OpenStreetMap (opens in a new tab)28.18 kmapprox. 114 min
Outer Ring Road tech corridor (RMZ Ecospace, Bellandur)Map point on OpenStreetMap (opens in a new tab)31.93 kmapprox. 129 min
Electronic City Phase 1Map point on OpenStreetMap (opens in a new tab)40.16 kmapprox. 163 min
How we calculate

Straight line: from the project’s map point on RERA to the destination’s point on OpenStreetMap.

Peak-hour drive is a rough estimate, not a route: straight line × 1.35 for the road network, at 20 km/h. Real times vary a lot with the route and the hour.

Sources:Source (openstreetmap.org) (opens in a new tab)How we calculate this

Schools and hospitals nearby

As on 5 Oct 2026

Within 2 km

  • 2Schools and colleges2 schools, 0 colleges, 0 kindergartens
  • 0Hospitals and clinics0 hospitals, 0 clinics

Nearest schools and colleges

  • NAFL North Urbana · 1.36 km

Places as mapped on OpenStreetMap (amenity=school, college, kindergarten, university; hospital, clinic), counted within 2 km in a straight line of the RERA map point. Volunteers map these, so some places may be missing or closed. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.

Sources:Source (openstreetmap.org) (opens in a new tab)

Nearest metro station and railway

As on 5 Oct 2026
  • Airport City (ವಿಮಾನ ನಿಲ್ದಾಣ ನಗರ)Blue Line metro, under construction2.05 km
  • Doddajala (ದೊಡ್ಡಜಾಲ)Blue Line metro, under construction3.95 km
  • KIAL Terminals (ಕೆಐಎಬಿ ವಿಮಾನ ನಿಲ್ದಾಣ ಟರ್ಮಿನಲ್ಸ್)Blue Line metro, under construction4.54 km
  • Krishnarajapura (ಕೃಷ್ಣರಾಜಪುರ (ಕೆ.ಆರ್.ಪುರ))Open now — nearest operating metro station23.45 km
  • Kempegowda International Airport Halt (ಕೆಂಪೇಗೌಡ ಅಂತರರಾಷ್ಟ್ರೀಯ ವಿಮಾನ-ನಿಲದಾಣ ಹಾಲ್ಟ)Nearest railway station0.34 km

Straight-line distances from the RERA map point to the station points mapped on OpenStreetMap; status (open or under construction) as tagged there. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.

Sources:Source (openstreetmap.org) (opens in a new tab)

Lake and lake-buffer check

As on 5 Oct 2026

The nearest mapped lake is Doddasanne Tank, 1,380 m from the project’s RERA map point.

The site boundary is not published as a shape, so its nearest edge can be closer than this point. Whether any building sits inside a lake buffer can only be checked on the approved plan.

The buffer rule

Bengaluru’s lake buffer rule has changed over time: the National Green Tribunal ordered a 75 m buffer in May 2016; the Supreme Court set that order aside on 5 March 2019, leaving the 30 m buffer of the Revised Master Plan 2015. Check the current rule and the approved plan before relying on either number.

Shortest distance from the RERA map point to the mapped water edge (OpenStreetMap water polygons tagged lake or reservoir, or named lake/kere/tank). Mapped shorelines can differ from the revenue-record boundary of a lake. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.

Sources:Source (openstreetmap.org) (opens in a new tab)Source (livelaw.in) (opens in a new tab)Source (citizenmatters.in) (opens in a new tab)How we calculate this

Satellite time-lapse of the site

Satellite photos load when you scroll to them.

Photos from Esri World Imagery Wayback, centred on the project’s map point; dates are the capture dates in Esri’s metadata. Loaded from Esri when you scroll here.

Sources:Source (livingatlas.arcgis.com) (opens in a new tab)

Sattva Aeropolis Phase 2 floor plans, brochure and elevations

Documents the builder uploaded to Karnataka RERA, shown as filed. Tap a page to see it full size; the full PDF opens on the RERA website.

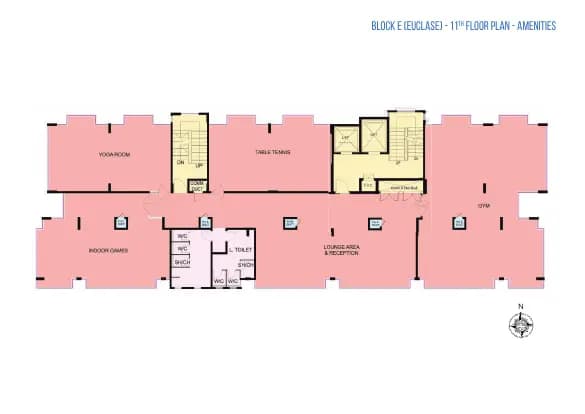

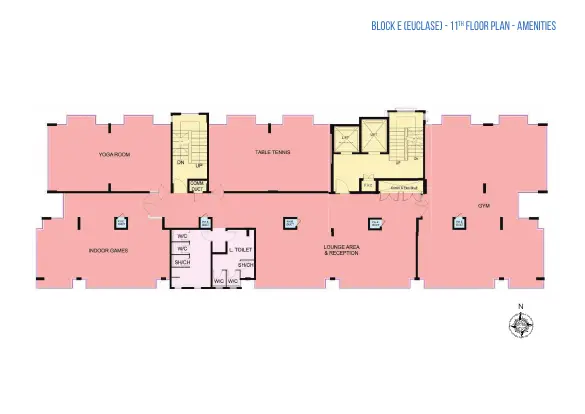

Brochure9 pages

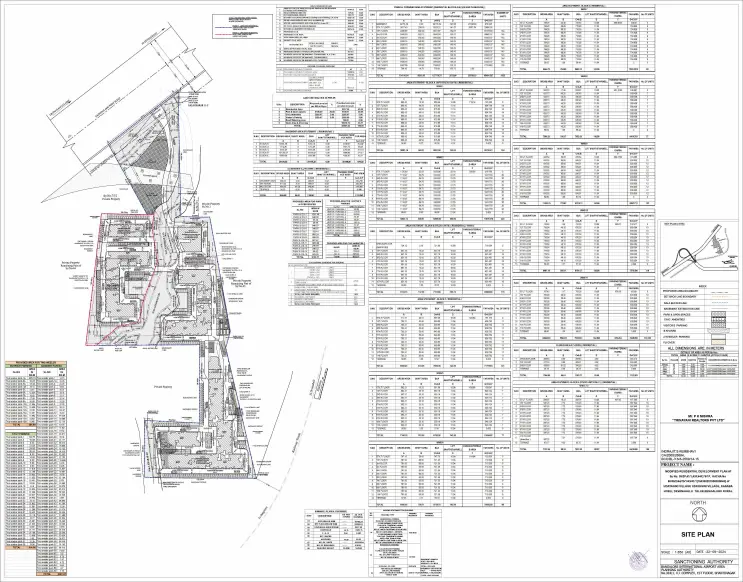

Approved building plan

Approved layout plan

Home typeCarpet areaHomes
1 BHK176 – 388 sq ft477
3 BHK644 sq ft77

Home types, counts and carpet areas as filed with Karnataka RERA (carpet area, not super built-up).

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Sattva Aeropolis Phase 2 possession date and construction status

  • Whole project (promoter’s RERA update)39%

    as on · 325 of 554 homes booked

Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-15.

By tower (Q2 2026-27)

  • Block A- Wing 164%
  • Block A Wing 270%
  • Block E35%

Units sold and unsold, from RERA (Q2 2026-27)

TypeHomesBookedAvailable
1 BHK477306171
3 BHK771958

As reported by the promoter in the quarterly update to RERA, not verified by us.

Timeline

  1. 25 Sep 2025Registered with Karnataka RERA
  2. 1 Oct 2025Project start date given to RERA
  3. 16 Oct 2028Completion date given at registration

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Construction pace from RERA quarterly filings

As on 15 Oct 2026

At the average pace so far, construction would reach 100% around Apr 2028 — about 6 months before the completion date on RERA (16 Oct 2028).

At the pace between the 4 quarterly filings we have (29% → 39% in 9 months), it would be around Apr 2031 — about 30 months after the RERA date.

0%25%50%75%100%202620272028202920302031RERA date29%31%33%39%
  • Filed on RERA
  • Average pace since start
  • Pace between filings (and 0% assumed at the start date)
  • RERA completion date

Quarterly filings

QuarterFiled onBuiltHomes booked
Q2 2026-27to 30 Sep 202615 Oct 202639%325 of 554
Q1 2026-27to 30 Jun 202615 Jul 202633%329 of 554
Q4 2025-26to 31 Mar 202615 Apr 202631%288 of 554
Q3 2025-26to 31 Dec 202514 Jan 202629%267 of 554
How we calculate

Average pace = % built ÷ months since the start date in the RERA record. Here: 39% ÷ 12 months (1 Oct 2025 to 30 Sep 2026) = 3.3% a month.

Estimated finish = latest filing date + (100 − % built) ÷ pace = 30 Sep 2026 + 61 ÷ 3.3 = 18.7 months → Apr 2028. This is an estimate, not a date from the builder or RERA.

Pace between filings = (39% − 29%) ÷ 9 months = 1.1% a month.

A straight line is a simplification: the builder reports one overall %, which mixes excavation, structure and finishing, and work rarely moves at a constant speed. The % values are the promoter’s own figures filed with RERA, not checked by us. Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-15.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this

Approvals and documents checklist

ApprovalAuthoritySource
Building planBIAPPA - Bangalore Airport Area Planning Authority · No. BIAAPA/TP/CC/289/2025-26 · dated 2025-09-02Source (rera.karnataka.gov.in) (opens in a new tab)
Land conversion (3 orders)Deputy commissioner Bangalore Rural District · No. ALN(DHT)SR67/2010-11 and 2 more · dated 2013-02-05Source (rera.karnataka.gov.in) (opens in a new tab)
Commencement Certificatescan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Approved Building Planscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
ESCOM/Electricityscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
KWSSB/Waterscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
KSPCBscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
SEIAAscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Fire Force Departmentscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Airport Authority of Indiascan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)

Documents uploaded to RERA

As on 19 Oct 2026
  • Building or layout plan · Approved drawings from the planning authorityFiled on RERA ✓ — BIAPPA - Bangalore Airport Area Planning Authority · No. BIAAPA/TP/CC/289/2025-26 · dated 2 Sep 2025
  • Commencement certificate · Permission to start buildingFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Environment clearance · SEIAA KarnatakaFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Fire NOC · Karnataka Fire and Emergency ServicesFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Pollution board consent · KSPCBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Water and sewerage · BWSSBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Electricity · BESCOMFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Height clearance · Airports Authority of IndiaFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Occupancy certificate (OC) · Issued only when the building is finishedNot on RERA yet — expected at completion

From the documents the promoter uploaded to Karnataka RERA, collected 19 Oct 2026. “Filed” means a document is on RERA — we have not checked its contents or validity. Not every approval applies to every project (for example, smaller projects may not need an environment clearance). The project page on RERA lists each upload.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Sattva Aeropolis Phase 2 RERA complaints

1 complaint as on Source (rera.karnataka.gov.in) (opens in a new tab)

Complaint refFiledSubjectStatusSource
01232/202614 Oct 2026Sattva Group Bangalore Grievance ComplaintScrutiny completedSource (rera.karnataka.gov.in) (opens in a new tab)

Court and consumer cases

Not found in public records yet: court cases

We list case numbers, courts and outcomes only — never names of private individuals.

About Sattva Resi Private Limited

Promoter type
Company
Projects on this site
19
RERA complaints against promoter
2
Company number (CIN)
U70101WB2006PTC108571

From Karnataka RERA, as collected so far (19 Oct 2026). Complaints are those RERA lists against this promoter across all its projects.

Sattva Resi Private Limited’s RERA record

Sattva Resi Private Limited delivery record

As on 21 Oct 2026

What the complaints are about

  • Refund of booking or other money2

2 complaint subjects as written on RERA, as on . Each subject is sorted into one group by keywords (first match wins: delay, refund, registration, quality, litigation, association); one complaint often raises several issues. Source (rera.karnataka.gov.in) (opens in a new tab)

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this

What’s changed since Sep 2025

As on 19 Oct 2026
  1. 15 Oct 2026Quarterly update filed for Q2 2026-27: 39% built, 325 of 554 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  2. 14 Oct 2026Complaint 01232/2026 filed with RERA: “Sattva Group Bangalore Grievance Complaint” — now scrutiny completed Source (rera.karnataka.gov.in) (opens in a new tab)
  3. 15 Jul 2026Quarterly update filed for Q1 2026-27: 33% built, 329 of 554 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  4. 15 Apr 2026Quarterly update filed for Q4 2025-26: 31% built, 288 of 554 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  5. 14 Jan 2026Quarterly update filed for Q3 2025-26: 29% built, 267 of 554 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  6. 1 Oct 2025Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
  7. 25 Sep 2025Registered with Karnataka RERA (PRM/KA/RERA/1250/303/PR/250925/008119); completion date 16 Oct 2028 Source (rera.karnataka.gov.in) (opens in a new tab)
  8. 2 Sep 2025Building plan approved by BIAPPA - Bangalore Airport Area Planning Authority (No. BIAAPA/TP/CC/289/2025-26) Source (rera.karnataka.gov.in) (opens in a new tab)

Newest first. No extension of the completion date is recorded on RERA. When the RERA crawl sees a new filing, complaint or extension, it is added here with its date.

Home loan EMI calculator

No listed price found — enter one to try.

Example only — use your bank’s quote.

Monthly EMI
—
Down payment
—
Loan amount
—
Total interest
—

A calculation only, from the numbers you enter — not a loan offer.

All-in cost: GST, registration and other charges

The calculator loads when you scroll to it.

Assumptions
  • Base price: the builder’s price is not published in a form we could collect — enter it from the cost sheet.
  • GST 5% on the base price and charges — the usual rate for an under-construction home that is not “affordable housing” (1%).
  • Stamp duty about 5.6% and registration 2% — the Karnataka rule (registration was raised from 1% to 2% on 31 Aug 2025). Calculated on the agreement value.
  • Car parking, other charges and the maintenance deposit are not in the public record we collect; enter them from the builder’s cost sheet.
  • Loan on the agreement value (banks usually lend up to 75–90%); EMI is the standard reducing-balance formula. Example rate only — use your bank’s quote.

How we calculate this

Sattva Aeropolis Phase 2 FAQs

What is Sattva Aeropolis Phase 2?

Sattva Aeropolis Phase 2 is a residential project by Trinayani Realtors Private Limited located in Udayagiri, Devanahalli, Bengaluru Rural district, PIN 562157.

How many homes are in Sattva Aeropolis Phase 2?

The project has 554 homes across 3 towers with a maximum of 11 floors.

What home types are available in Sattva Aeropolis Phase 2?

The project offers 1 BHK homes with carpet area from 176 to 388 sq ft (477 homes) and 3 BHK homes with carpet area of 644 sq ft (77 homes).

When will Sattva Aeropolis Phase 2 be completed?

The completion date on RERA is 16 October 2028.

What is the RERA registration number for Sattva Aeropolis Phase 2?

The RERA registration number is PRM/KA/RERA/1250/303/PR/250925/008119, registered on 25 September 2025.

How many homes have been booked in Sattva Aeropolis Phase 2?

As of Q2 2026-27 (ended 30 September 2026), 325 homes have been booked out of 554.

What is the construction progress of Sattva Aeropolis Phase 2?

As of Q2 2026-27 (ended 30 September 2026), the project is 39% complete.

Are there any RERA complaints on Sattva Aeropolis Phase 2?

There is 1 RERA complaint filed on this project registration.

Which bank handles the escrow account for Sattva Aeropolis Phase 2?

ICICI Bank is the escrow bank for this project.

What other projects does Trinayani Realtors Private Limited have?

According to the Karnataka RERA record, Trinayani Realtors Private Limited has 1 project on record, which is Sattva Aeropolis Phase 2.

Written by AI from the RERA record above on 19 Oct 2026. Answers use only that record; check them against the source before you decide.

Questions about Sattva Aeropolis Phase 2

No questions published yet. Ask the first one: you get an instant answer from this page’s public record, and our team follows up on anything the record does not show.

Bought a home from Sattva Resi Private Limited? Review the builder.

Reviews of Sattva Resi Private Limited by verified buyers

No verified reviews of Sattva Resi Private Limited yet. If you bought a home from them, your review helps other buyers.

How reviews work: only buyers and owners can review; we confirm each purchase by phone before publishing, publish positive and negative reviews alike, never accept payment for reviews, and the builder may reply.

Similar projects within 5 km

ProjectDistanceHomesPossession (RERA)BuiltComplaintsPrice
Aeropolis, a project of Sattva GroupTrinayani Realtor Private Limited0 km1,001Jul 202689%0Not collected
Impact Sanvi Aero GardensSanvi Constructions0.5 km316Dec 202847%0Not collected
Sattva Vasanta CoveSattva Resi Private Limited1.2 km200Dec 20309%0Not collected
Sattva Vasanta SkyeSattva Resi Private Limited1.5 km1,077May 203117%0Not collected
CosmosCorbital Builders1.6 km68Dec 2029—0Not collected
VarnamSmart Value Homes (Peenya Project) Private Limited2 km842Sep 2031—0from ₹2.05 Cr

Projects of the same kind within 5 km in a straight line of this project’s RERA map point, nearest first. % built is the promoter’s latest quarterly figure on RERA (shown for single-registration projects); prices are from the builder’s own website where we found one.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Sources and last checked dates

  1. Karnataka RERA — project register (search by the registration number) (opens in a new tab)

Collected on 19 Oct 2026 by AI research agents reading public pages. Facts are written in our own words. Not found yet: price; court cases; landmarks; specifications; news.

How to check on RERA: On rera.karnataka.gov.in/viewAllProjects, type the registration number in 'Registration No', press Search, then click the 'View Project Details' icon. Complaints open from the 'Complaints / Litigation' icon in the same row. Registration number: PRM/KA/RERA/1250/303/PR/250925/008119.

  • RERA record last checked: 19 Oct 2026
  • Last change in the record (registration, quarterly filing or complaint): 19 Oct 2026

How this page is made: software builds it from public records (Karnataka RERA filings, OpenStreetMap, the builder’s own website). AI is used only to read filings into fields and to write the plain-English summary and FAQ answers, which are checked against the record. Facts are checked automatically against the RERA filing. Methodology · How we earn · Report an error
