Under The Stars
23×45, 30×40 +2 more plots by SSD Housing Nellukunte · Nellukunte, Doddaballapur Road, Bengaluru
Nellukunte, Doddaballapur Road, BengaluruOpen on Google Maps (opens in a new tab)
- Under construction
- RERA registered
- plotted
Price: Price on request

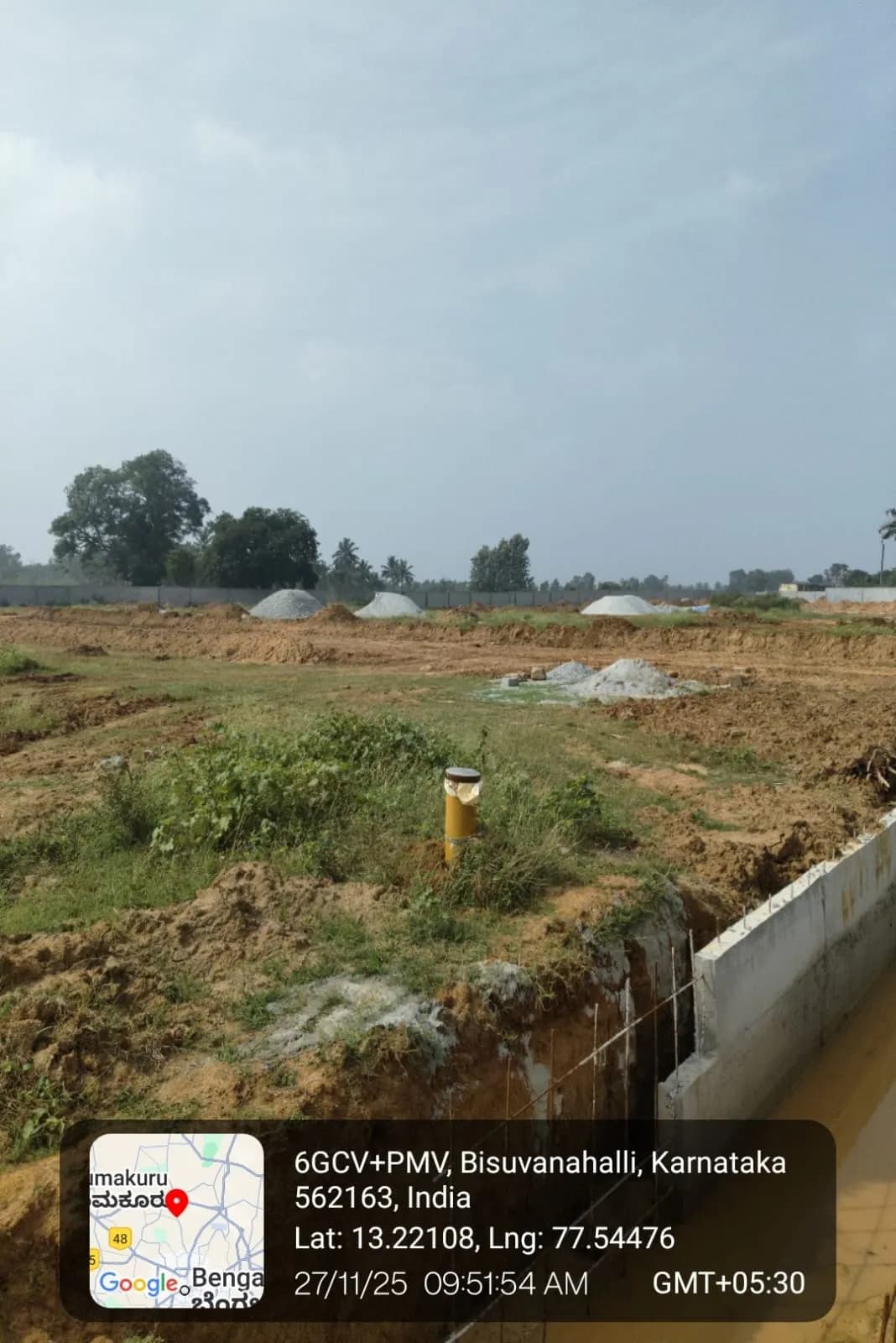

Site photo filed with Karnataka RERA Karnataka RERA filing · Source ↗ (opens in a new tab)
Under The Stars at a glance
- Completion (RERA)Oct 2030Karnataka RERA
- Construction30% built · on pace for Jan 2029RERA filing to 30 Sep 2026; estimate from average pace
- RERA complaints (project)None listedKarnataka RERA · as on 16 Oct 2026
- Approvals filed1 of 9 on RERAKarnataka RERA uploads · 16 Oct 2026
- Nearest metroDoddajala · 11.49 km (under construction)Open now: Chikkabidarakallu, 19.73 km · straight line · OpenStreetMap, 5 Oct 2026
- Airport driveapprox. 71 min at peak17.52 km straight line · estimate
- Nearest lakeUnnamed lake · 593 mFrom the RERA map point · OpenStreetMap, 5 Oct 2026
Project summary
Under The Stars is a plotted development by SSD Housing Nellukunte in Nellukunte, Bengaluru with 69 plots, registered with Karnataka RERA. The completion date on RERA is 9 Oct 2030.
Facts collected on 16 Oct 2026 from public records — each linked to its source. Free for buyers. If you book through us, the developer pays us a commission.
Under The Stars buyers’ group: join to ask for a group price
No one has joined yet. Be one of the first 10 buyers in this group — the founding members.
Join free. When enough buyers have joined, our agent partner asks SSD Housing Nellukunte for a group price — for example a lower price, an easier payment plan or waived charges. Nothing is promised: you see what the developer offers and book directly with the developer if you want to. Free for buyers. If you book through us, the developer pays us a commission.
- Gathering buyers
- Talking to the developer
- Group offer
- Group site visit
- Booking
0 buyers have joined · 0 committed
Committed buyers have confirmed their budget, plot size and timeline with us on a call; developers negotiate with them. Joining is free and never obliges you to buy.
Join the Under The Stars buyers’ groupHow group buying works
See it for yourself
Visit the site with our team, or get a call to clear your questions. Free, no obligation.
Key facts: plot sizes, approval, land and completion
- Plot sizes (feet)
- 23×45, 30×40, 30×45, 30×50
- Plot area
- 951 – 7,743 sq ft
- Total plots
- 69
- Layout approved by
- Doddaballapur Planning Authority
- Land
- Not found in public records yet: land area
- Land conversion orders
- 11
- Completion (RERA)
- Oct 2030
- Development (RERA update)
- 30%
Plot sizes (RERA filing)
| Size (feet) | Area | Plots |
|---|---|---|
| 23×45 | 1,035 sq ft | 3 |
| 30×40 | 1,200 sq ft | 4 |
| 30×45 | 1,350 sq ft | 12 |
| 30×50 | 1,500 sq ft | 12 |
| Odd-sized (irregular) | varies | 38 |
Sizes as filed with RERA, converted from metres to feet (9.14 m = 30 ft, 12.19 m = 40 ft). Ask the developer which plots are still unsold.
Land conversion orders (RERA filing)
11 rows: land conversion orders. Scroll inside the table to see them all.
| Survey no. | Converted for | Order | By |
|---|---|---|---|
| 45/1 | Residential | No. 578166, 23 Jan 2024 | DC |
| 45/2 | Residential | No. 578164, 23 Jan 2024 | DC |
| 45/3 | Residential | No. 578146, 21 Nov 2025 | DC |
| 48/1 | Residential | No. 751610, 16 Apr 2025 | DC |
| 48/2 | Residential | No. 265983, 22 Dec 2021 | DC |
| 48/3 | Residential | No. 755830, 20 Mar 2025 | DC |
| 48/4 | Residential | No. 578149, 23 Jan 2024 | DC |
| 48/5 | Residential | No. 759168, 19 May 2025 | DC |
| 48/6 | Residential | No. 578148, 23 Jan 2024 | DC |
| 48/7 | Residential | No. 578161, 23 Jan 2024 | DC |
| 50/1 | Residential | No. 578150, 23 Jan 2024 | DC |
RERA does not cover each plot’s khata. Ask the developer for the khata and title documents and have a lawyer check them before paying an advance.
Under The Stars RERA number and registration details
- RERA number
- PRM/KA/RERA/1251/472/PR/290126/008434
- Registered on
- 29 Jan 2026
- Promised completion
- 9 Oct 2030
- Extended to
- No extension recorded
- RERA status
- Under construction
- Plots booked
- Not found in public records yet: plots booked
- Price
- Not found in public records yet: price
- Project type
- Plotted
Summary in plain English
Under The Stars is a plotted layout in Nellukunte, Yelahanka taluk, Bengaluru Urban, developed by SSD Housing Nellukunte. The layout has 69 plots across four standard sizes and odd-sized plots, with completion targeted for 9 October 2030. As of Q2 2026-27, the layout development is 30% complete.
Written by AI from the RERA record above on 17 Oct 2026. Every number in it was checked against that record; if anything differs, the record wins.
Open space, loans, escrow and other details
- Open space
- Not found in public records yet: open space
- Water and power
- Water source filed with RERA: BoreWell
- Plot loans: approved banks
- Not found in public records yet: bank approvals
- Payment plans
- Not found in public records yet: payment plans
- Maintenance
- Not found in public records yet: maintenance
- Car parking
- Not found in public records yet: car parking charge
- Escrow bank (RERA)
- IDFC FIRST BANK, Residency Road Branch
- Building plan (RERA)
- Doddaballapur Planning Authority · No. DPA/TP/LAO/04/25-26 · dated 30 Aug 2025
- Project cost declared to RERA
- ₹8.4 Cr
Amenities
Under The Stars location and address
- Address
- Sy.No 45/1, 45/2, 45/3, 48/1, 48/2, 48/3, 48/4, 48/5, 48/6, 48/7, 50/1 of Nellukunte Village , Hesaraghatta Hobli , Yelahanka , Bengaluru Urban, Karnataka - 561203
- Village (RERA)
- Nellukunte
- Locality
- Doddaballapur RoadAlso known as Doddaballapura Road, Doddaballapur Main Road
- PIN code
- 561203
- City
- Bengaluru
- State
- Karnataka
- Coordinates
- 13.22119, 77.54397
Distances to landmarks
Not found in public records yet: landmarksAbout Doddaballapur Road
Not found in public records yet: locality factsCommute times to tech parks and the airport
| To | Straight line | Peak-hour drive (estimate) |
|---|---|---|
| Kempegowda International AirportMap point on OpenStreetMap (opens in a new tab) | 17.52 km | approx. 71 min |
| Manyata Tech ParkMap point on OpenStreetMap (opens in a new tab) | 20.92 km | approx. 85 min |
| KSR Bengaluru City railway station (Majestic)Map point on OpenStreetMap (opens in a new tab) | 27.16 km | approx. 110 min |
| ITPL, Whitefield (main gate)Map point on OpenStreetMap (opens in a new tab) | 33.39 km | approx. 135 min |
| Outer Ring Road tech corridor (RMZ Ecospace, Bellandur)Map point on OpenStreetMap (opens in a new tab) | 36.27 km | approx. 147 min |
| Electronic City Phase 1Map point on OpenStreetMap (opens in a new tab) | 43.34 km | approx. 176 min |
How we calculate
Straight line: from the project’s map point on RERA to the destination’s point on OpenStreetMap.
Peak-hour drive is a rough estimate, not a route: straight line × 1.35 for the road network, at 20 km/h. Real times vary a lot with the route and the hour.
Sources:Source (openstreetmap.org) (opens in a new tab)How we calculate this
Schools and hospitals nearby
Within 2 km
- 2Schools and colleges2 schools, 0 colleges, 0 kindergartens
- 0Hospitals and clinics0 hospitals, 0 clinics
Nearest schools and colleges
- MES Pharmacy College · 1.28 km
Places as mapped on OpenStreetMap (amenity=school, college, kindergarten, university; hospital, clinic), counted within 2 km in a straight line of the RERA map point. Volunteers map these, so some places may be missing or closed. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Nearest metro station and railway
- Doddajala (ದೊಡ್ಡಜಾಲ)Blue Line metro, under construction11.49 km
- Bagalur Cross (ಬಾಗಲೂರು ಕ್ರಾಸ್)Blue Line metro, under construction13.38 km
- Yelahanka (ಯಲಹಂಕ)Blue Line metro, under construction14.6 km
- Chikkabidarakallu (ಚಿಕ್ಕಬಿದರಕಲ್ಲು)Open now — nearest operating metro station19.73 km
- Rajanukunte Nearest railway station5.68 km
Straight-line distances from the RERA map point to the station points mapped on OpenStreetMap; status (open or under construction) as tagged there. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Lake and lake-buffer check
The nearest mapped lake is Unnamed lake (mapped on OpenStreetMap), 593 m from the project’s RERA map point.
The site boundary is not published as a shape, so its nearest edge can be closer than this point. Whether any building sits inside a lake buffer can only be checked on the approved plan.
- Unnamed lake (mapped on OpenStreetMap) on OpenStreetMap (opens in a new tab) 593 m
- Unnamed lake (mapped on OpenStreetMap) on OpenStreetMap (opens in a new tab) 1,095 m
- Unnamed lake (mapped on OpenStreetMap) on OpenStreetMap (opens in a new tab) 1,273 m
The buffer rule
Bengaluru’s lake buffer rule has changed over time: the National Green Tribunal ordered a 75 m buffer in May 2016; the Supreme Court set that order aside on 5 March 2019, leaving the 30 m buffer of the Revised Master Plan 2015. Check the current rule and the approved plan before relying on either number.
- LiveLaw: SC sets aside NGT order enlarging buffer zones (2019) (livelaw.in) (opens in a new tab)
- Citizen Matters: Shrinking lake buffers (citizenmatters.in) (opens in a new tab)
Shortest distance from the RERA map point to the mapped water edge (OpenStreetMap water polygons tagged lake or reservoir, or named lake/kere/tank). Mapped shorelines can differ from the revenue-record boundary of a lake. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Sources:Source (openstreetmap.org) (opens in a new tab)Source (livelaw.in) (opens in a new tab)Source (citizenmatters.in) (opens in a new tab)How we calculate this
Satellite time-lapse of the site
Satellite photos load when you scroll to them.
Photos from Esri World Imagery Wayback, centred on the project’s map point; dates are the capture dates in Esri’s metadata. Loaded from Esri when you scroll here.
Sources:Source (livingatlas.arcgis.com) (opens in a new tab)
Under The Stars layout plan and plot types as filed
Documents the developer uploaded to Karnataka RERA, shown as filed. Tap a page to see it full size; the full PDF opens on the RERA website.
Approved layout plan

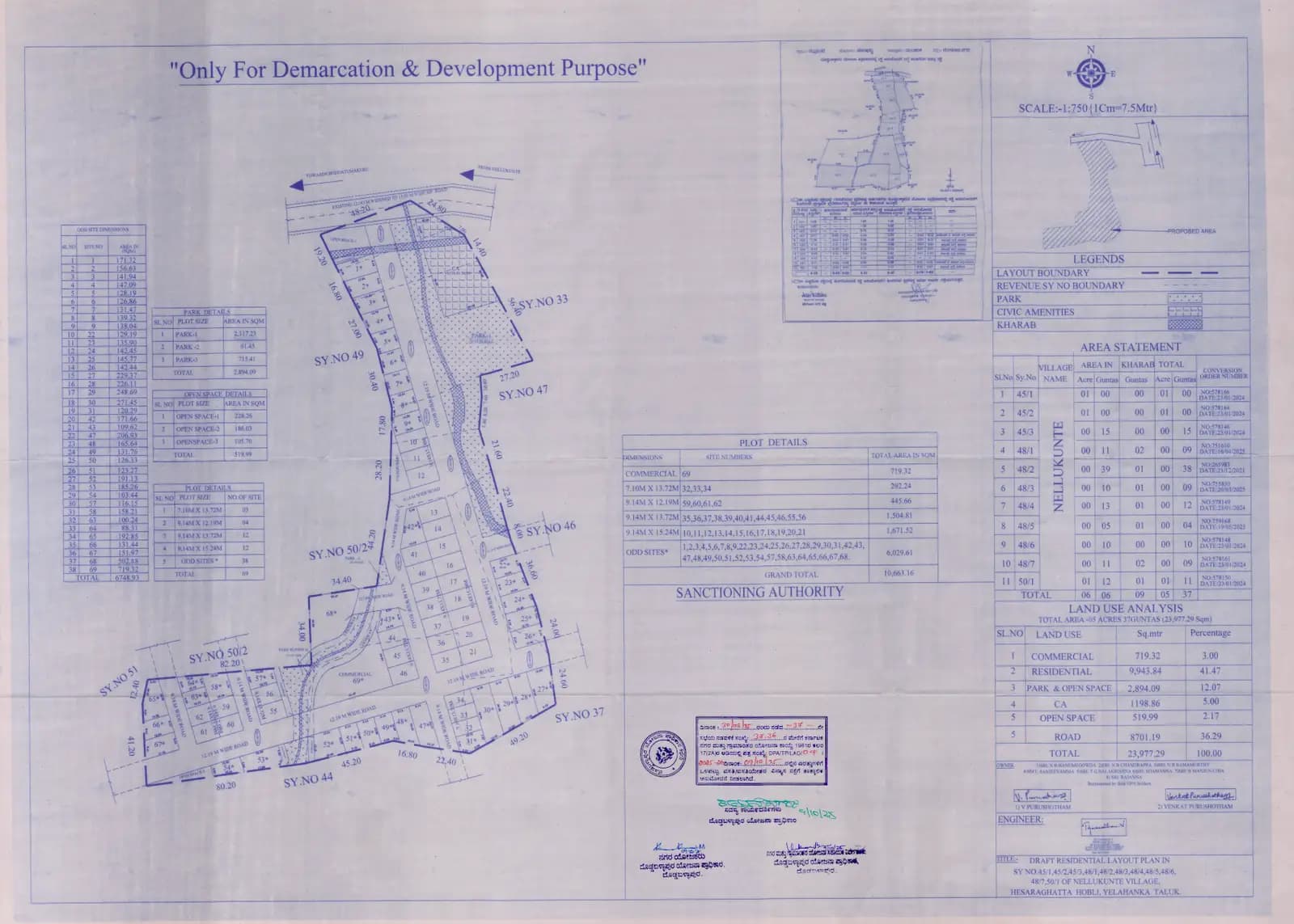

Approved Layout Plan/Demarcation PlanFull PDF on RERA
Layout plan and brochure not published? The developer shares them only on request. We’ll get the brochure, layout plan and current price list for you, free.
Get brochure, layout plan & price| Plot type (as filed) | Area | Plots |
|---|---|---|
| Plot 7.10 m × 13.72 m | — | 3 |
| Plot 9.14 m × 12.19 m | — | 4 |
| Plot 9.14 m × 13.72 m | — | 12 |
| Plot 9.14 m × 15.24 m | — | 12 |
| Odd-shaped plots | — | 38 |
Plot types and counts as filed with Karnataka RERA.
We have not collected the layout plan drawing; the developer’s sales team can share it.
Under The Stars completion date and development status

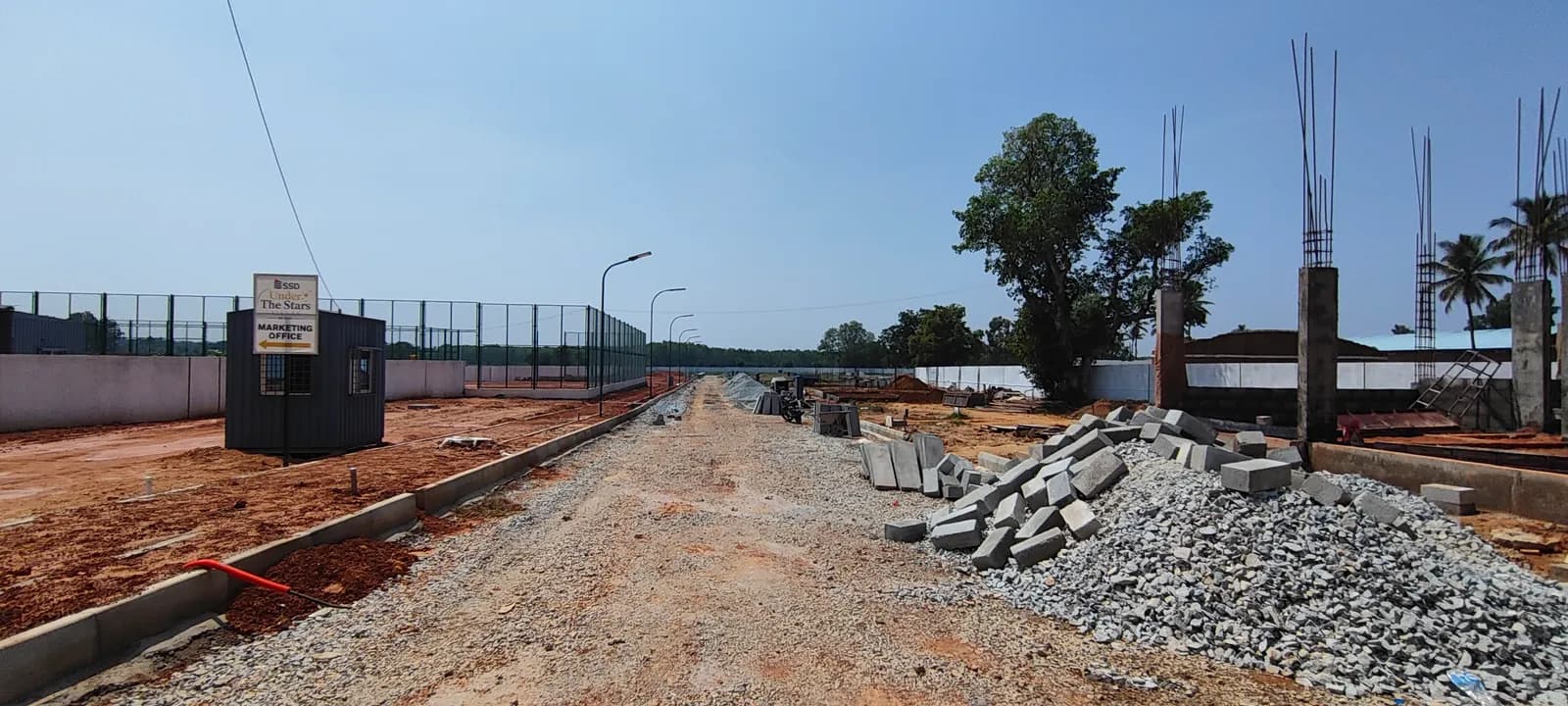

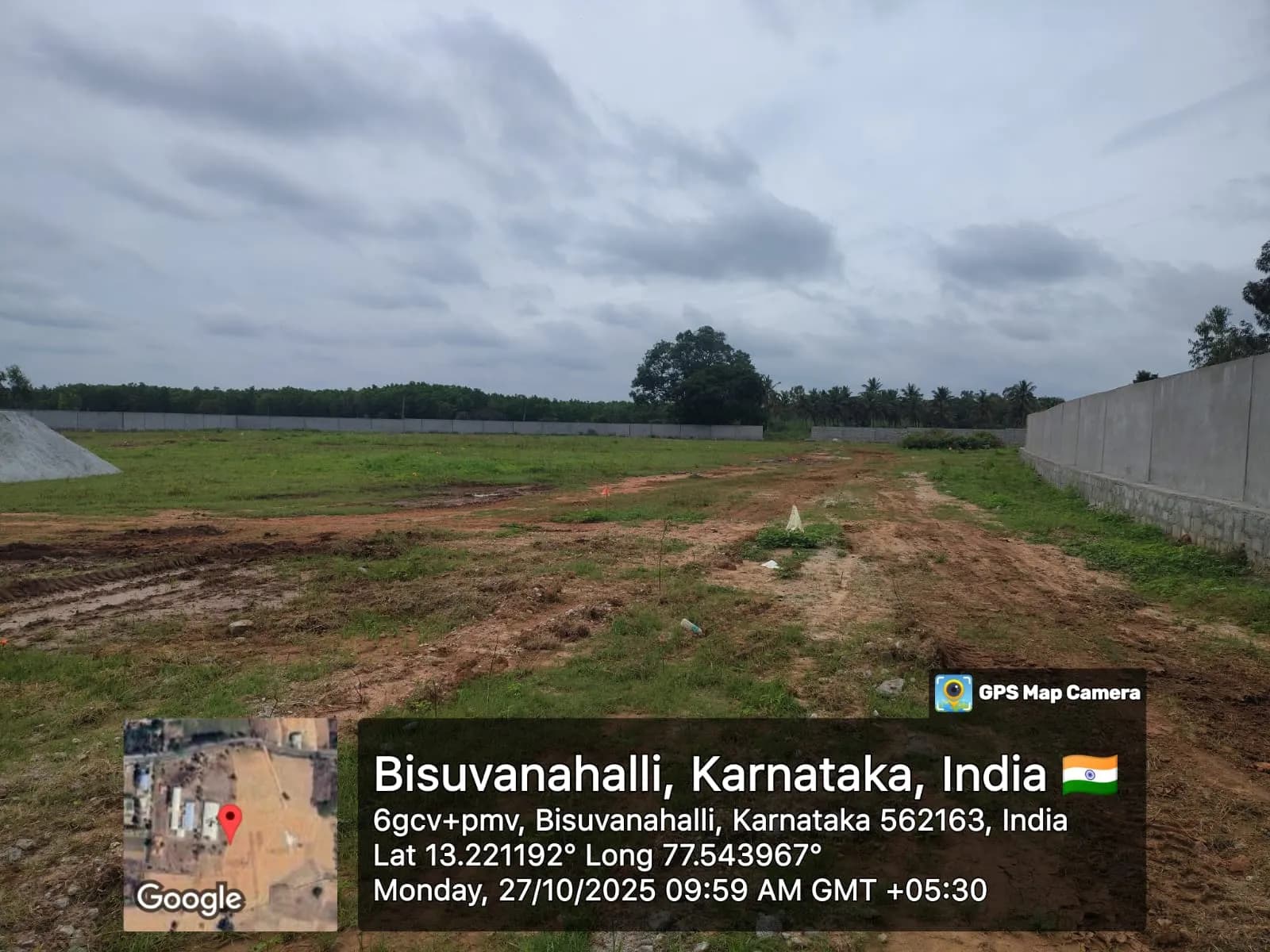

Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-10.
Timeline
- 9 Oct 2025Project start date given to RERA
- 29 Jan 2026Registered with Karnataka RERA
- 9 Oct 2030Completion date given at registration
Construction pace from RERA quarterly filings
At the average pace so far, construction would reach 100% around Jan 2029 — about 21 months before the completion date on RERA (9 Oct 2030).
At the pace between the 3 quarterly filings we have (5% → 30% in 6 months), it would be around Feb 2028 — about 31 months before the RERA date.
- Filed on RERA
- Average pace since start
- Pace between filings (and 0% assumed at the start date)
- RERA completion date
Quarterly filings
| Quarter | Filed on | Developed | Plots booked |
|---|---|---|---|
| Q2 2026-27to 30 Sep 2026 | 10 Oct 2026 | 30% | — |
| Q1 2026-27to 30 Jun 2026 | 14 Jul 2026 | 8% | — |
| Q4 2025-26to 31 Mar 2026 | 13 Apr 2026 | 5% | — |
How we calculate
Average pace = % built ÷ months since the start date in the RERA record. Here: 30% ÷ 11.7 months (9 Oct 2025 to 30 Sep 2026) = 2.6% a month.
Estimated finish = latest filing date + (100 − % built) ÷ pace = 30 Sep 2026 + 70 ÷ 2.6 = 27.3 months → Jan 2029. This is an estimate, not a date from the builder or RERA.
Pace between filings = (30% − 5%) ÷ 6 months = 4.2% a month.
A straight line is a simplification: the builder reports one overall %, which mixes excavation, structure and finishing, and work rarely moves at a constant speed. The % values are the promoter’s own figures filed with RERA, not checked by us. Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-10.
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
Approvals and documents checklist
| Approval | Authority | Source |
|---|---|---|
| Layout plan | Doddaballapur Planning Authority · No. DPA/TP/LAO/04/25-26 · dated 2025-08-30 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Land conversion (11 orders) | DC · No. 578166 and 10 more · dated 2025-11-21 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Layout Plan/Demarcation Plan | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
Documents uploaded to RERA
- Building or layout plan · Approved drawings from the planning authorityFiled on RERA ✓ — Doddaballapur Planning Authority · No. DPA/TP/LAO/04/25-26 · dated 30 Aug 2025
- Commencement certificate · Permission to start buildingNot on RERA yet
- Environment clearance · SEIAA KarnatakaNot on RERA yet
- Fire NOC · Karnataka Fire and Emergency ServicesNot on RERA yet
- Pollution board consent · KSPCBNot on RERA yet
- Water and sewerage · BWSSBNot on RERA yet
- Electricity · BESCOMNot on RERA yet
- Height clearance · Airports Authority of IndiaNot on RERA yet
- Occupancy certificate (OC) · Issued only when the building is finishedNot on RERA yet — expected at completion
From the documents the promoter uploaded to Karnataka RERA, collected 16 Oct 2026. “Filed” means a document is on RERA — we have not checked its contents or validity. Not every approval applies to every project (for example, smaller projects may not need an environment clearance). The project page on RERA lists each upload.
Under The Stars RERA complaints
No complaints listed on Karnataka RERA for this registration as on Source (rera.karnataka.gov.in) (opens in a new tab)
Court and consumer cases
We list case numbers, courts and outcomes only — never names of private individuals.
About SSD Housing Nellukunte
- Promoter type
- Partnership Firm
- Projects on this site
- 1
- RERA complaints against promoter
- 0
- Company number (CIN)
- Not found in public records yet: CIN
From Karnataka RERA, as collected so far (16 Oct 2026). Complaints are those RERA lists against this promoter across all its projects.
SSD Housing Nellukunte’s RERA recordSSD Housing Nellukunte delivery record
- 1Projects in Bengaluru on RERA1 approved registration under SSD Housing Nellukunte in Bengaluru Urban and Rural. Source (rera.karnataka.gov.in) (opens in a new tab)
- 69Plots registeredAs stated in each registrations.
- 0RERA complaintsas on Source (rera.karnataka.gov.in) (opens in a new tab)
- 0Complaints per 1,000 plots0 complaints ÷ 69 plots in its 1 registration on Karnataka RERA in Bengaluru.
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
What’s changed since Aug 2025
- 10 Oct 2026Quarterly update filed for Q2 2026-27: 30% built Source (rera.karnataka.gov.in) (opens in a new tab)
- 14 Jul 2026Quarterly update filed for Q1 2026-27: 8% built Source (rera.karnataka.gov.in) (opens in a new tab)
- 13 Apr 2026Quarterly update filed for Q4 2025-26: 5% built Source (rera.karnataka.gov.in) (opens in a new tab)
- 29 Jan 2026Registered with Karnataka RERA (PRM/KA/RERA/1251/472/PR/290126/008434); completion date 9 Oct 2030 Source (rera.karnataka.gov.in) (opens in a new tab)
- 9 Oct 2025Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
- 30 Aug 2025Building plan approved by Doddaballapur Planning Authority (No. DPA/TP/LAO/04/25-26) Source (rera.karnataka.gov.in) (opens in a new tab)
Newest first. No extension of the completion date is recorded on RERA. When the RERA crawl sees a new filing, complaint or extension, it is added here with its date.
Plot loan EMI calculator
- Monthly EMI
- —
- Down payment
- —
- Loan amount
- —
- Total interest
- —
A calculation only, from the numbers you enter — not a loan offer.
Under The Stars FAQs
What plot sizes are available in Under The Stars?
The layout has four standard plot sizes: 30×45 feet (1,350 sq ft), 30×50 feet (1,500 sq ft), 30×40 feet (1,200 sq ft), and 23×45 feet (1,035 sq ft). There are also 38 odd-sized plots; their dimensions are not in the RERA record.
How many plots are in Under The Stars?
The layout has a total of 69 plots.
What is the RERA registration number for Under The Stars?
The RERA registration number is PRM/KA/RERA/1251/472/PR/290126/008434.
When will Under The Stars be completed?
The completion date on RERA is 9 October 2030.
What is the current development progress of Under The Stars?
As of Q2 2026-27 (ending 30 September 2026), the layout development is 30% complete.
Who approved the layout for Under The Stars?
The layout was approved by Doddaballapur Planning Authority.
How many land conversion orders were issued for Under The Stars?
11 land conversion orders were issued for the project.
Are there any RERA complaints against Under The Stars or its developer?
No complaints have been filed against this project or the developer SSD Housing Nellukunte on RERA.
What is the location and PIN code of Under The Stars?
The project is located in Nellukunte, Yelahanka taluk, Bengaluru Urban district, with PIN code 561203.
Who is the developer of Under The Stars?
The developer is SSD Housing Nellukunte, a Partnership Firm.
Written by AI from the RERA record above on 17 Oct 2026. Answers use only that record; check them against the source before you decide.
Questions about Under The Stars
No questions published yet. Ask the first one: you get an instant answer from this page’s public record, and our team follows up on anything the record does not show.
Bought a plot from SSD Housing Nellukunte? Review the developer.
Reviews of SSD Housing Nellukunte by verified buyers
No verified reviews of SSD Housing Nellukunte yet. If you bought a plot from them, your review helps other buyers.
How reviews work: only buyers and owners can review; we confirm each purchase by phone before publishing, publish positive and negative reviews alike, never accept payment for reviews, and the developer may reply.
Similar projects within 5 km
| Project | Distance | Plots | Completion (RERA) | Developed | Complaints | Price |
|---|---|---|---|---|---|---|
| KNS BilloreBillore Ventures Private Limited | 1.1 km | 199 | May 2026 | — | 0 | Not collected |
| Under The SilvermoonSurya Sunshine Developers | 1.1 km | 44 | Sep 2030 | 15% | 0 | Not collected |
| J V Green ValleySrinivasulu G | 1.2 km | 115 | Dec 2028 | — | 0 | Not collected |
| KNS WilonaM/S KNS Real Vista LLP | 1.2 km | 23 | Oct 2025 | — | 0 | Not collected |
| Century EdenGeetanjali Effective Realty Solutions Private Limited | 1.5 km | 219 | Apr 2027 | — | 1 | Not collected |
| NORTHWINDS by GEOWN & NIVARAGEOWN CASPER ESTATES LLP & Nivara Group | 1.9 km | 126 | Dec 2028 | 100% | 0 | Not collected |
Projects of the same kind within 5 km in a straight line of this project’s RERA map point, nearest first. % built is the promoter’s latest quarterly figure on RERA (shown for single-registration projects); prices are from the developer’s own website where we found one.
Sources and last checked dates
Collected on 16 Oct 2026 by AI research agents reading public pages. Facts are written in our own words. Not found yet: price; court cases; landmarks; specifications; news.
How to check on RERA: On rera.karnataka.gov.in/viewAllProjects, type the registration number in 'Registration No', press Search, then click the 'View Project Details' icon. Complaints open from the 'Complaints / Litigation' icon in the same row. Registration number: PRM/KA/RERA/1251/472/PR/290126/008434.
- RERA record last checked: 16 Oct 2026
- Last change in the record (registration, quarterly filing or complaint): 16 Oct 2026
How this page is made: software builds it from public records (Karnataka RERA filings, OpenStreetMap, the developer’s own website). AI is used only to read filings into fields and to write the plain-English summary and FAQ answers, which are checked against the record. Facts are checked automatically against the RERA filing. Methodology · How we earn · Report an error
More new projects in Doddaballapur Road
Kadatanamale, Doddaballapur RoadUnder constructionRERA registeredBuyers’ group openKNS Billore
by Billore Ventures
Price: Price on requestGet brochure & price →
- 30×30, 30×35, 30×40 +1 more
- 7,942 – 28,213 sq ft plots
- Approved by BMRDA
- May 2026
RERA not updated since promised May 2026 · 199 plots
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for KNS Billore
Off Kadathanamale, Doddaballapur RoadUnder constructionRERA registeredBuyers’ group openUnder The Silvermoon
by Surya Sunshine
Price: Price on requestGet brochure & price →
- 27×42
- 1,150 – 2,640 sq ft plots
- Approved by Gadag-Betageri Urban Development Authority
- Sep 2030
44 plots
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Under The Silvermoon
Kakkehalli, Doddaballapur RoadUnder constructionRERA registeredBuyers’ group openJ V Green Valley
by Srinivasulu G
Price: Price on requestGet brochure & price →
- 30×40, 40×50, 40×60
- 904 – 2,935 sq ft plots
- Approved by Doddaballapur Planning Authority
- Dec 2028
115 plots
Be one of the first 10 buyers in this groupFounding members — it’s free
