DS Max Spoorthi Nest

2 & 3 BHK apartments by DS Max Properties Private Limited · Sarjapur–Attibele Road, Bengaluru

Sarjapur–Attibele Road, BengaluruOpen on Google Maps (opens in a new tab)

  • Under construction
  • RERA registered
  • residential

by DS-Max Properties

Price: Price on request

Get brochure, floor plans & price

Brochure, floor plans and price list for DS Max Spoorthi Nest

Builders share their brochure, floor plans and price list only on request. Tell us how to reach you and we’ll get them and send them to you, free.

Free for buyers. If you book through us, the builder pays us a commission. How we earn

Project summary

DS Max Spoorthi Nest is a residential project by DS Max Properties Private Limited in Bengaluru with 187 homes, registered with Karnataka RERA. The completion date on RERA is 31 Dec 2030.

Not in the RERA record we collected yet: locality. This page fills in as the record is collected.

Facts collected on 19 Oct 2026 from public records — each linked to its source. Free for buyers. If you book through us, the builder pays us a commission.

DS Max Spoorthi Nest buyers’ group: join to ask for a group price

No one has joined yet. Be one of the first 10 buyers in this group — the founding members.

Join free. When enough buyers have joined, our agent partner asks DS-Max Properties for a group price — for example a lower price, an easier payment plan or waived charges. Nothing is promised: you see what the builder offers and book directly with the builder if you want to. Free for buyers. If you book through us, the builder pays us a commission.

  1. Gathering buyers
  2. Talking to the builder
  3. Group offer
  4. Group site visit
  5. Booking

0 buyers have joined · 0 committed

Committed buyers have confirmed their budget, home type and timeline with us on a call; builders negotiate with them. Joining is free and never obliges you to buy.

Join the DS Max Spoorthi Nest buyers’ groupHow group buying works

See it for yourself

Visit the site with our team, or get a call to clear your questions. Free, no obligation.

Key facts: home types, towers, land and possession

Updated on 19 Oct 2026
Home types
2 BHK, 3 BHK
Carpet area
581 – 1,010 sq ft
Towers
1
Floors
4
Total homes
187
Land
1.8 acres
Possession (RERA)
Dec 2030
Built (RERA update)
15%

DS Max Spoorthi Nest RERA number and registration details

RERA number
PRM/KA/RERA/1251/308/PR/230126/008427
Registered on
23 Jan 2026
Promised completion
31 Dec 2030
Extended to
No extension recorded
RERA status
New launch
Homes booked
27 of 187 as on
Price
Not found in public records yet: price
Project type
Residential

Towers and blocks (RERA filing)

TowerFloorsBasementsHomes
Tower41187

A dash (—) means the filing did not state that value.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Summary in plain English

DS Max Spoorthi Nest is a residential project by DS Max Properties Private Limited in Anekal, Bengaluru Urban. The project has 187 homes across one 4-floor tower and is registered to complete on 31 December 2030.

Written by AI from the RERA record above on 19 Oct 2026. Every number in it was checked against that record; if anything differs, the record wins.

Open space, home loans, escrow and other details

Open space
66.6% of land
Water and power
Water source filed with RERA: BoreWell,Local Authority
Home loans: approved banks
Not found in public records yet: bank approvals
Payment plans
Not found in public records yet: payment plans
Maintenance
Not found in public records yet: maintenance
Car parking
Not found in public records yet: car parking charge
Escrow bank (RERA)
Indian Bank, Kalyan nagar
Building plan (RERA)
Satellite Town Ring Road Planning Authority · No. STRRPA/TP/CC/37/2022-23 · dated 11 Mar 2025
Project cost declared to RERA
₹38.13 Cr

Open area as a share of the land, from the areas filed with RERA (includes driveways and landscaped areas).

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Amenities

  • Electricity
  • Club House
  • Swimming Pool
  • Gym
  • Power Backup
  • Water and Sanitation

Amenities and internal works as filed by the promoter with Karnataka RERA; we have not visited the site.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

DS Max Spoorthi Nest location and address

Address
Khatha No 150200102701021969, Sy no 76/10, S Medihalli , Sarjapura Hobli , Anekal , Bengaluru Urban, Karnataka - 562107
Village (RERA)
Not found in public records yet: village
Locality
Sarjapur–Attibele RoadAlso known as Sarjapura Attibele Road, Attibele Sarjapur Road
PIN code
562107
City
Bengaluru
State
Karnataka
Coordinates
12.81709, 77.77522

Distances to landmarks

Not found in public records yet: landmarks

About Sarjapur–Attibele Road

Not found in public records yet: locality facts

Commute times to tech parks and the airport

As on 5 Oct 2026
ToStraight linePeak-hour drive (estimate)
Electronic City Phase 1Map point on OpenStreetMap (opens in a new tab)12.49 kmapprox. 51 min
Outer Ring Road tech corridor (RMZ Ecospace, Bellandur)Map point on OpenStreetMap (opens in a new tab)15.63 kmapprox. 63 min
ITPL, Whitefield (main gate)Map point on OpenStreetMap (opens in a new tab)19.39 kmapprox. 79 min
KSR Bengaluru City railway station (Majestic)Map point on OpenStreetMap (opens in a new tab)28.6 kmapprox. 116 min
Manyata Tech ParkMap point on OpenStreetMap (opens in a new tab)30.72 kmapprox. 124 min
Kempegowda International AirportMap point on OpenStreetMap (opens in a new tab)43.34 kmapprox. 176 min
How we calculate

Straight line: from the project’s map point on RERA to the destination’s point on OpenStreetMap.

Peak-hour drive is a rough estimate, not a route: straight line × 1.35 for the road network, at 20 km/h. Real times vary a lot with the route and the hour.

Sources:Source (openstreetmap.org) (opens in a new tab)How we calculate this

Schools and hospitals nearby

As on 5 Oct 2026

Within 2 km

  • 2Schools and colleges2 schools, 0 colleges, 0 kindergartens
  • 0Hospitals and clinics0 hospitals, 0 clinics

Nearest schools and colleges

  • Indus International School · 1.87 km

Places as mapped on OpenStreetMap (amenity=school, college, kindergarten, university; hospital, clinic), counted within 2 km in a straight line of the RERA map point. Volunteers map these, so some places may be missing or closed. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.

Sources:Source (openstreetmap.org) (opens in a new tab)

Nearest metro station and railway

As on 5 Oct 2026
  • Delta Electronics Bommasandra (ಡೆಲ್ಟಾ ಎಲೆಕ್ಟ್ರಾನಿಕ್ಸ್ ಬೊಮ್ಮಸಂದ್ರ)Open now — nearest operating metro station9.42 km
  • Heelalige (ಹೀಲಲಿಗೆ ರೈಲು ನಿಲ್ದಾಣ)Nearest railway station6.97 km

Straight-line distances from the RERA map point to the station points mapped on OpenStreetMap; status (open or under construction) as tagged there. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.

Sources:Source (openstreetmap.org) (opens in a new tab)

Lake and lake-buffer check

As on 5 Oct 2026

The nearest mapped lake is Unnamed lake (mapped on OpenStreetMap), 1,101 m from the project’s RERA map point.

The site boundary is not published as a shape, so its nearest edge can be closer than this point. Whether any building sits inside a lake buffer can only be checked on the approved plan.

The buffer rule

Bengaluru’s lake buffer rule has changed over time: the National Green Tribunal ordered a 75 m buffer in May 2016; the Supreme Court set that order aside on 5 March 2019, leaving the 30 m buffer of the Revised Master Plan 2015. Check the current rule and the approved plan before relying on either number.

Shortest distance from the RERA map point to the mapped water edge (OpenStreetMap water polygons tagged lake or reservoir, or named lake/kere/tank). Mapped shorelines can differ from the revenue-record boundary of a lake. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.

Sources:Source (openstreetmap.org) (opens in a new tab)Source (livelaw.in) (opens in a new tab)Source (citizenmatters.in) (opens in a new tab)How we calculate this

Satellite time-lapse of the site

Satellite photos load when you scroll to them.

Photos from Esri World Imagery Wayback, centred on the project’s map point; dates are the capture dates in Esri’s metadata. Loaded from Esri when you scroll here.

Sources:Source (livingatlas.arcgis.com) (opens in a new tab)

DS Max Spoorthi Nest floor plans, brochure and elevations

Documents the builder uploaded to Karnataka RERA, shown as filed. Tap a page to see it full size; the full PDF opens on the RERA website.

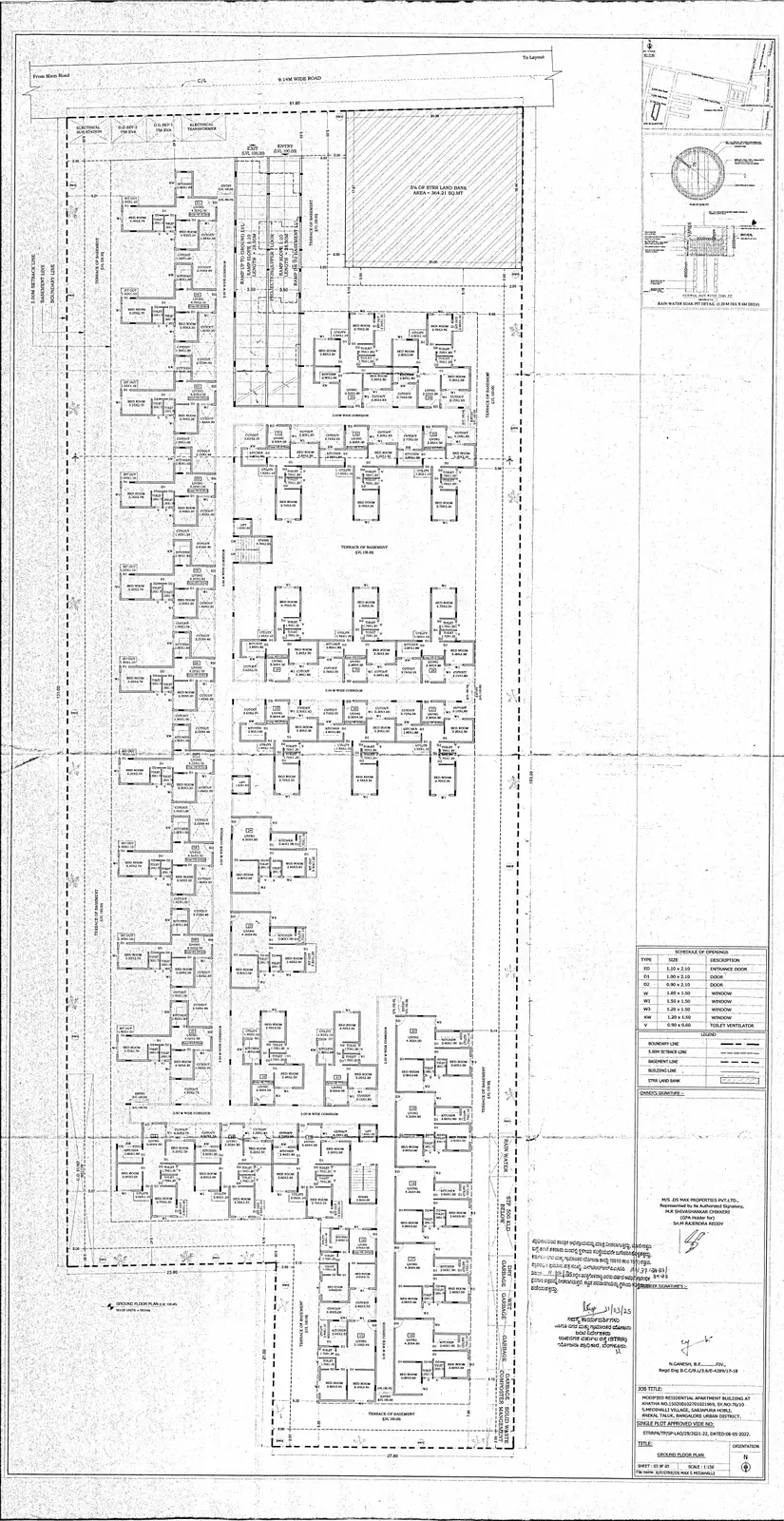

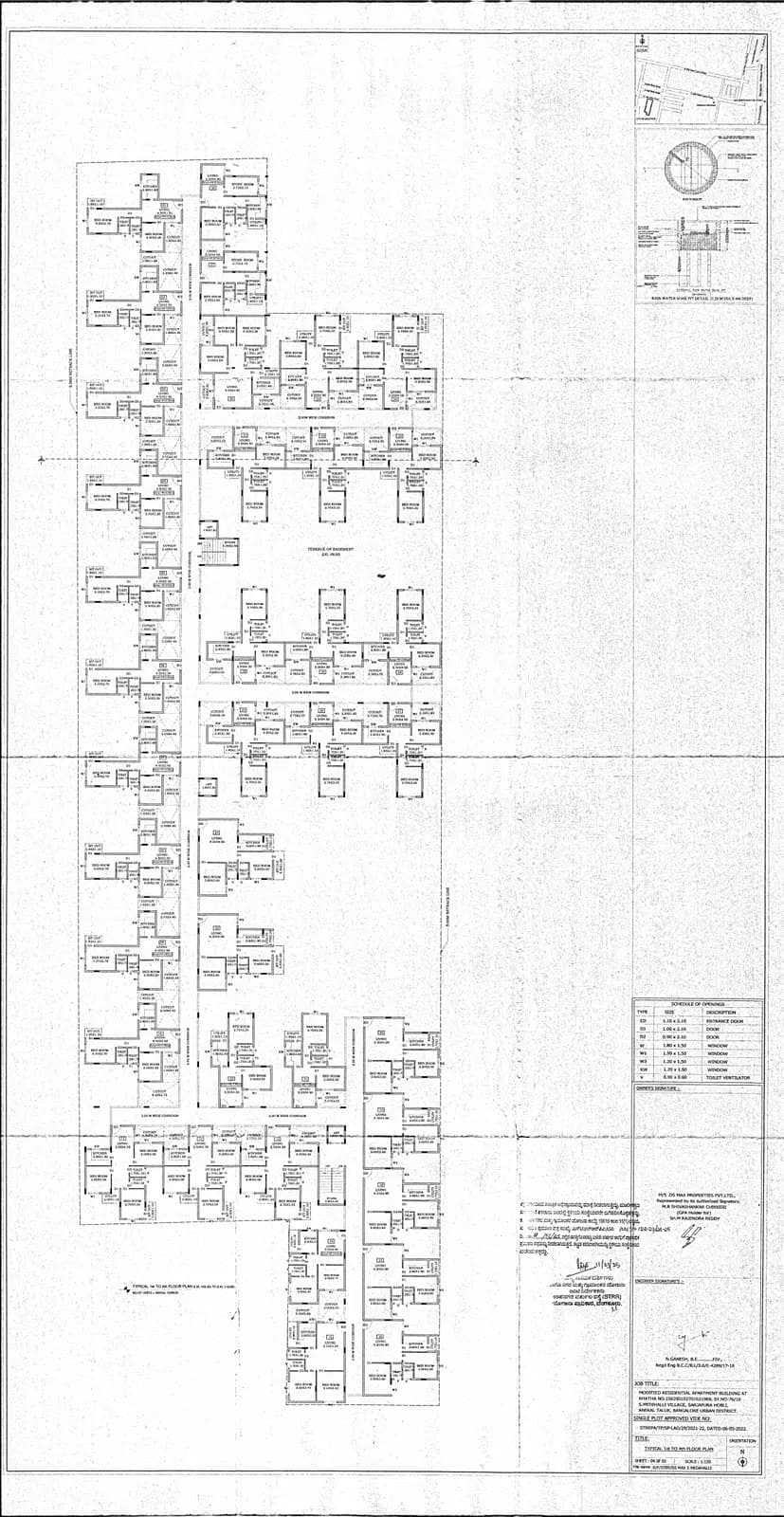

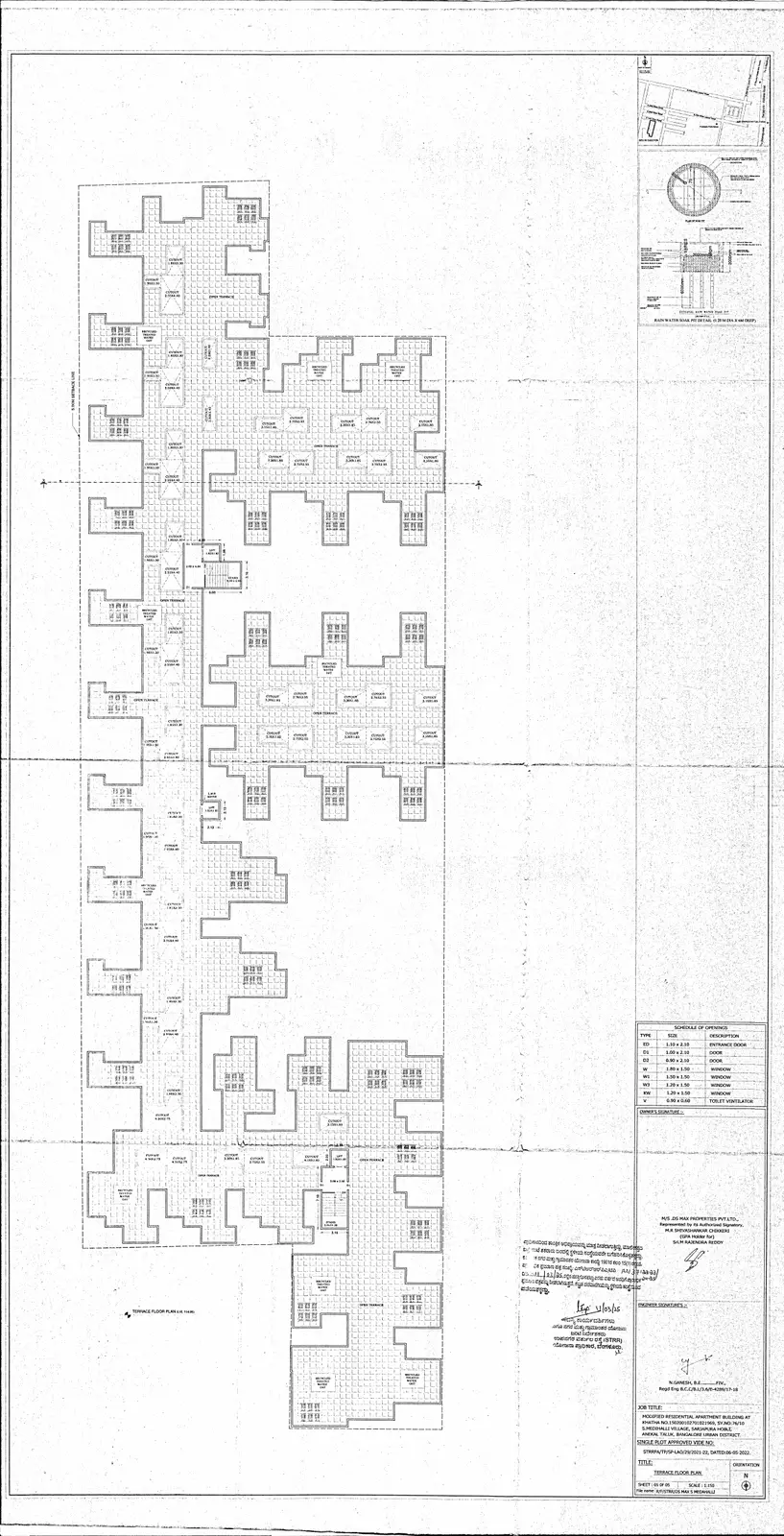

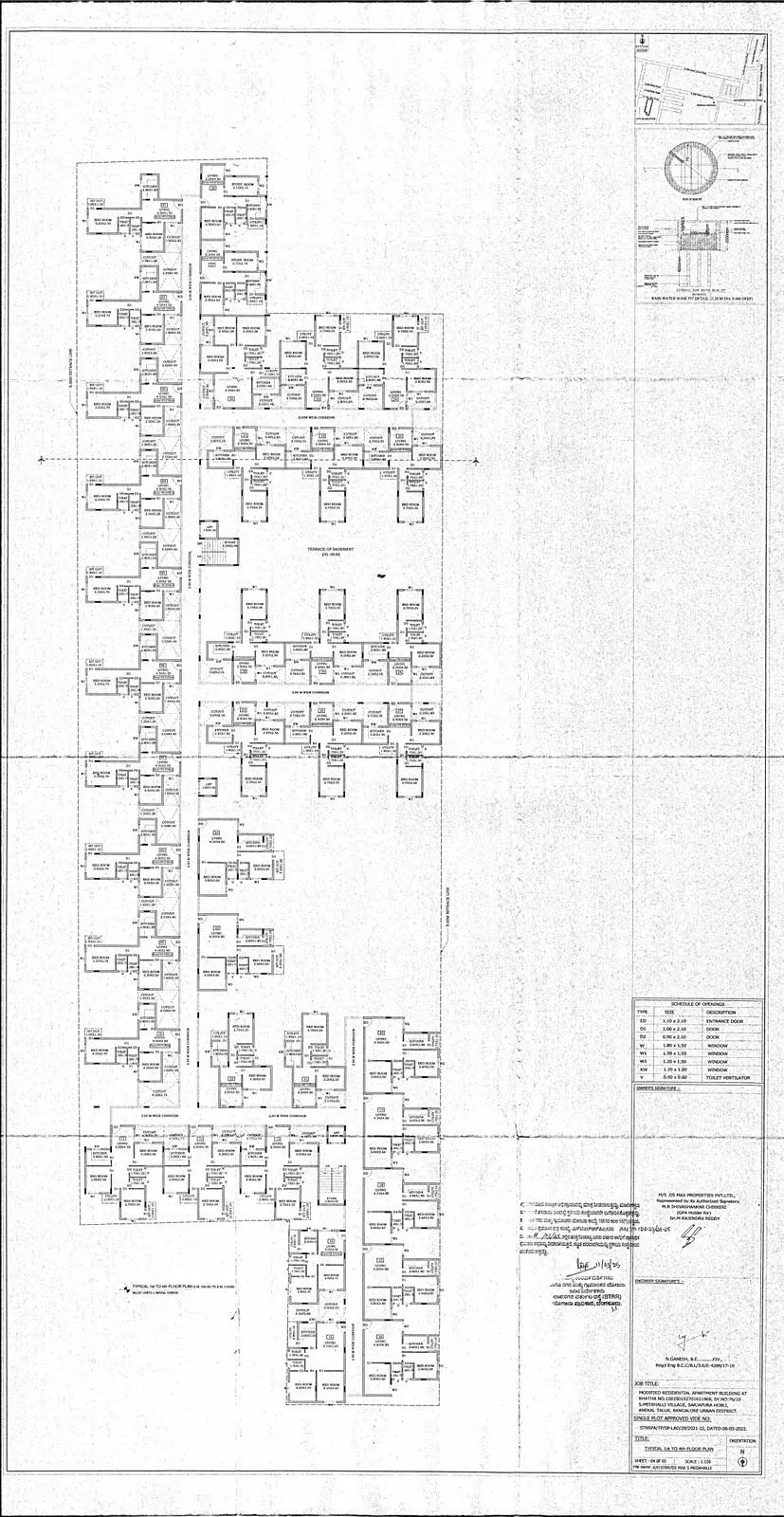

Floor plans3 files

Approved building plan2 files

Approved layout plan

Home typeCarpet areaHomes
2 BHK581 – 761 sq ft13
3 BHK783 – 1,010 sq ft174

Home types, counts and carpet areas as filed with Karnataka RERA (carpet area, not super built-up).

We have not collected floor-plan drawings; the builder’s sales team can share them.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

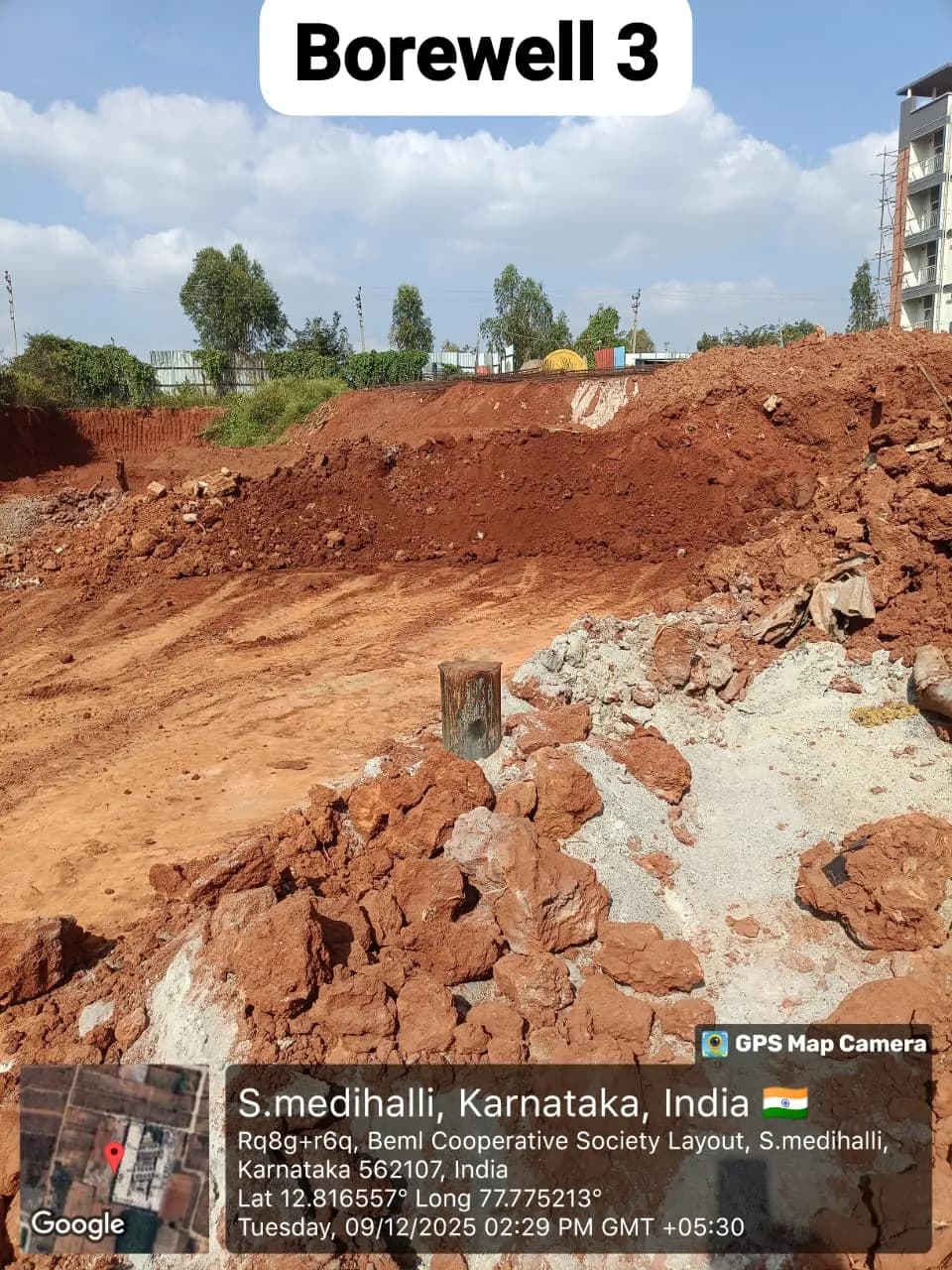

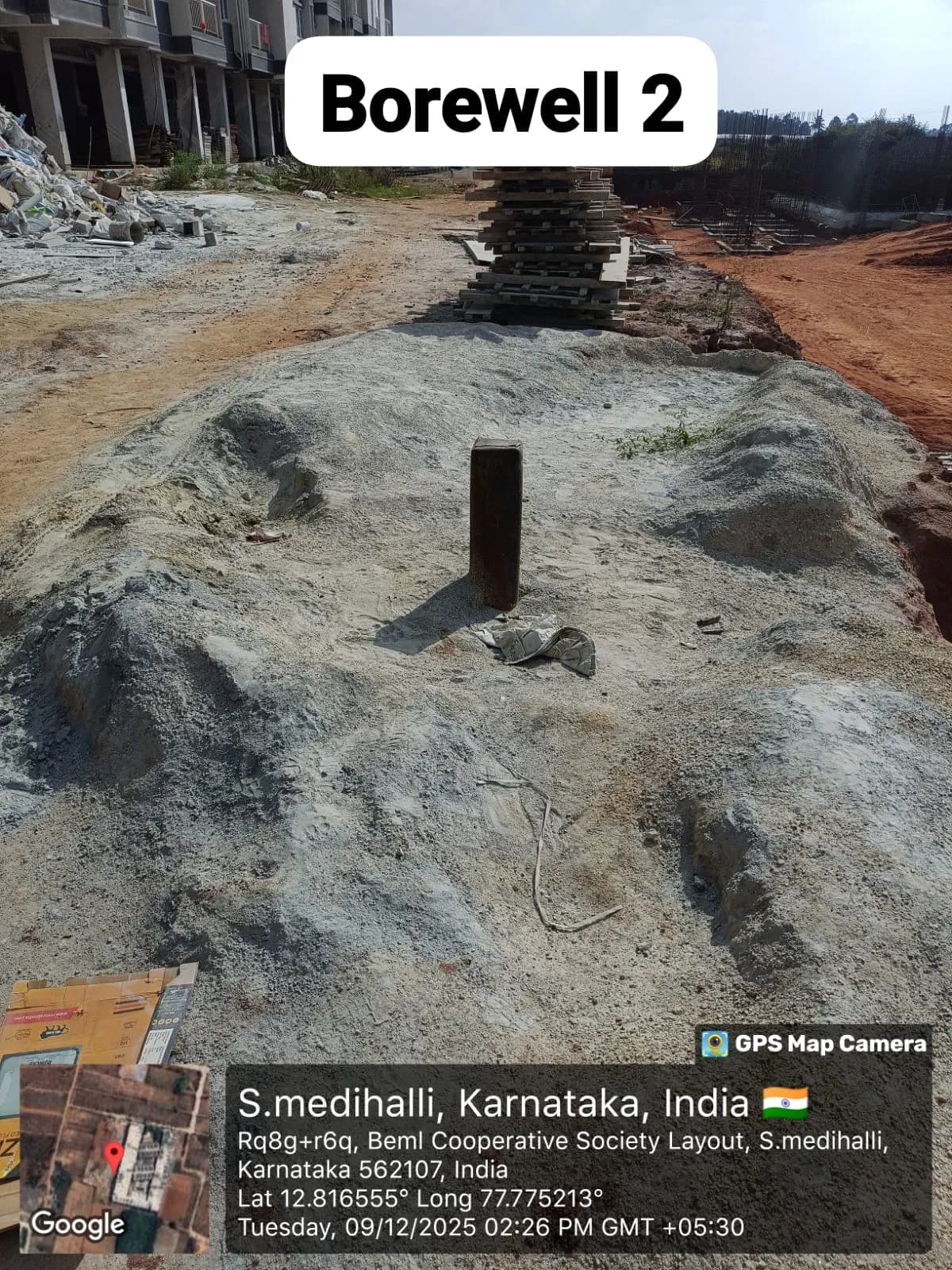

DS Max Spoorthi Nest possession date and construction status

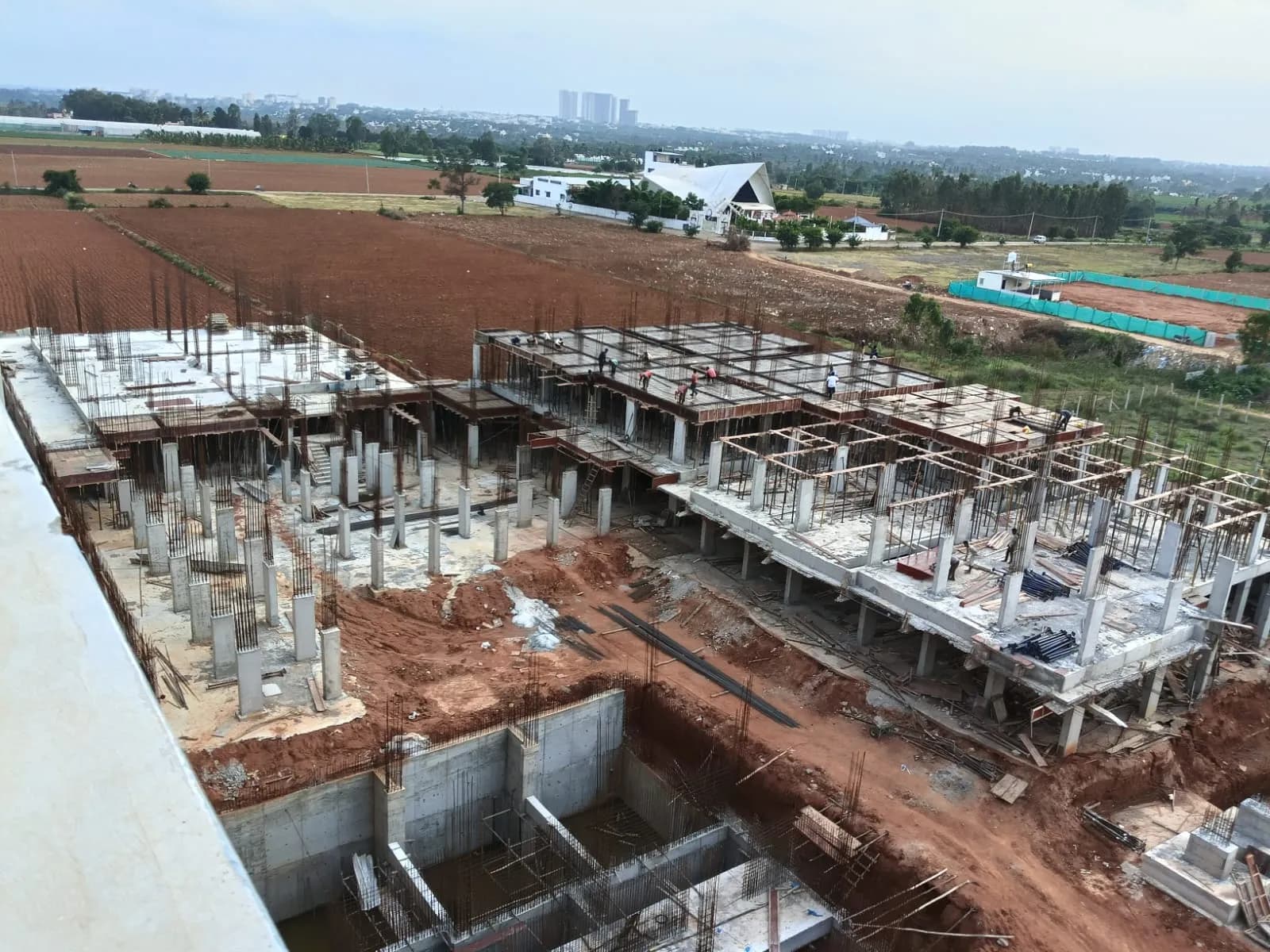

  • Whole project (promoter’s RERA update)15%

    as on · 27 of 187 homes booked

Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-14.

Units sold and unsold, from RERA (Q2 2026-27)

TypeHomesBookedAvailable
2 BHK1349
3 BHK17423151

As reported by the promoter in the quarterly update to RERA, not verified by us.

Timeline

  1. 1 Dec 2025Project start date given to RERA
  2. 23 Jan 2026Registered with Karnataka RERA
  3. 31 Dec 2030Completion date given at registration

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Construction pace from RERA quarterly filings

As on 14 Oct 2026

At the average pace so far, construction would reach 100% around Jun 2031 — about 5 months after the completion date on RERA (31 Dec 2030).

At the pace between the 3 quarterly filings we have (3% → 15% in 6 months), it would be around Apr 2030 — about 8 months before the RERA date.

0%25%50%75%100%202620272028202920302031RERA date3%4%15%
  • Filed on RERA
  • Average pace since start
  • Pace between filings (and 0% assumed at the start date)
  • RERA completion date

Quarterly filings

QuarterFiled onBuiltHomes booked
Q2 2026-27to 30 Sep 202614 Oct 202615%27 of 187
Q1 2026-27to 30 Jun 202614 Jul 20264%23 of 187
Q4 2025-26to 31 Mar 202613 Apr 20263%24 of 187
How we calculate

Average pace = % built ÷ months since the start date in the RERA record. Here: 15% ÷ 10 months (1 Dec 2025 to 30 Sep 2026) = 1.5% a month.

Estimated finish = latest filing date + (100 − % built) ÷ pace = 30 Sep 2026 + 85 ÷ 1.5 = 56.4 months → Jun 2031. This is an estimate, not a date from the builder or RERA.

Pace between filings = (15% − 3%) ÷ 6 months = 2% a month.

A straight line is a simplification: the builder reports one overall %, which mixes excavation, structure and finishing, and work rarely moves at a constant speed. The % values are the promoter’s own figures filed with RERA, not checked by us. Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-14.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this

Approvals and documents checklist

ApprovalAuthoritySource
Building planSatellite Town Ring Road Planning Authority · No. STRRPA/TP/CC/37/2022-23 · dated 2025-03-11Source (rera.karnataka.gov.in) (opens in a new tab)
Land conversionDC Office, Bangalore · No. 292615 · dated 2022-01-01Source (rera.karnataka.gov.in) (opens in a new tab)
Commencement Certificatescan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Approved Building Planscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
ESCOM/Electricityscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
KWSSB/Waterscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
KSPCBscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)

Documents uploaded to RERA

As on 19 Oct 2026

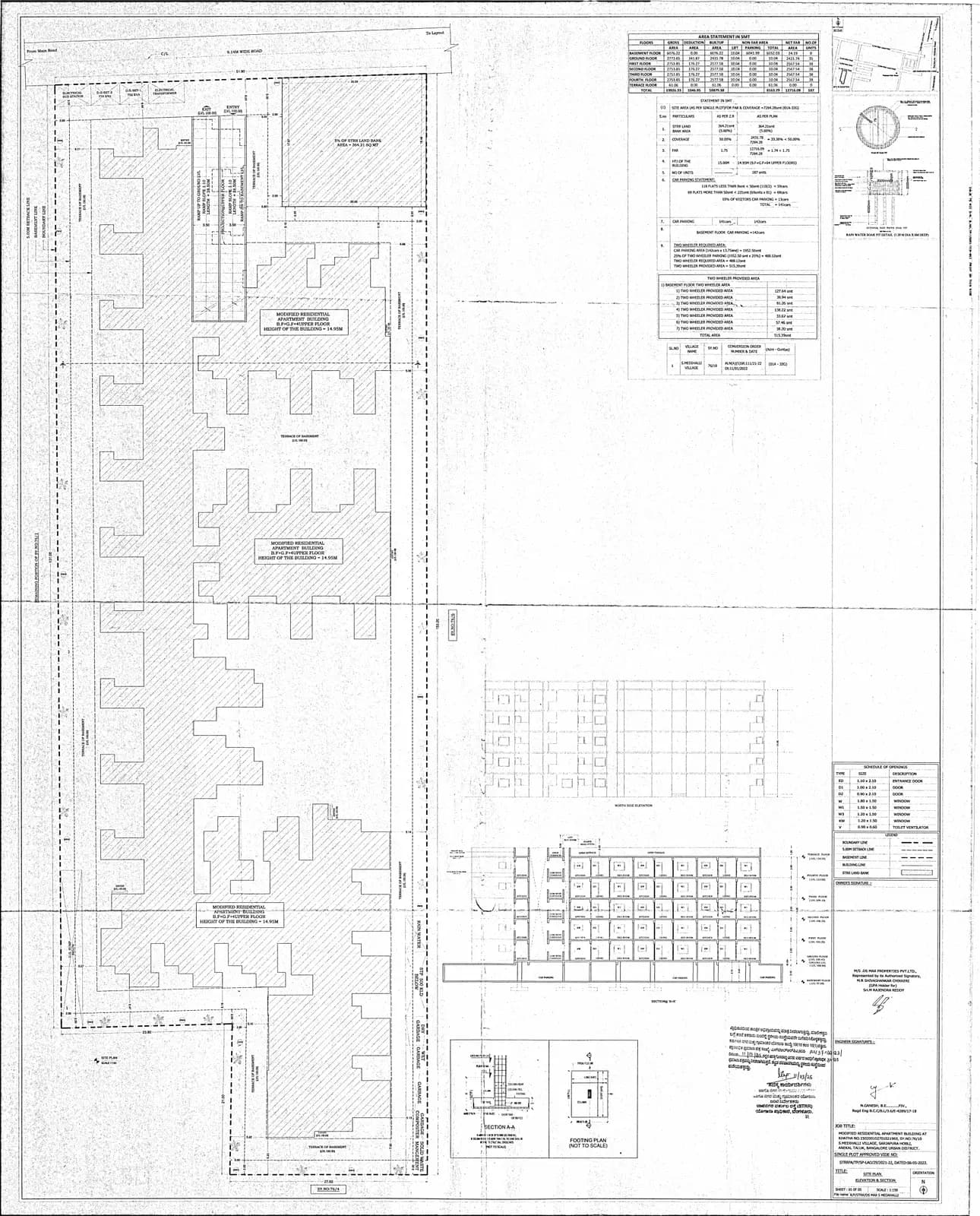

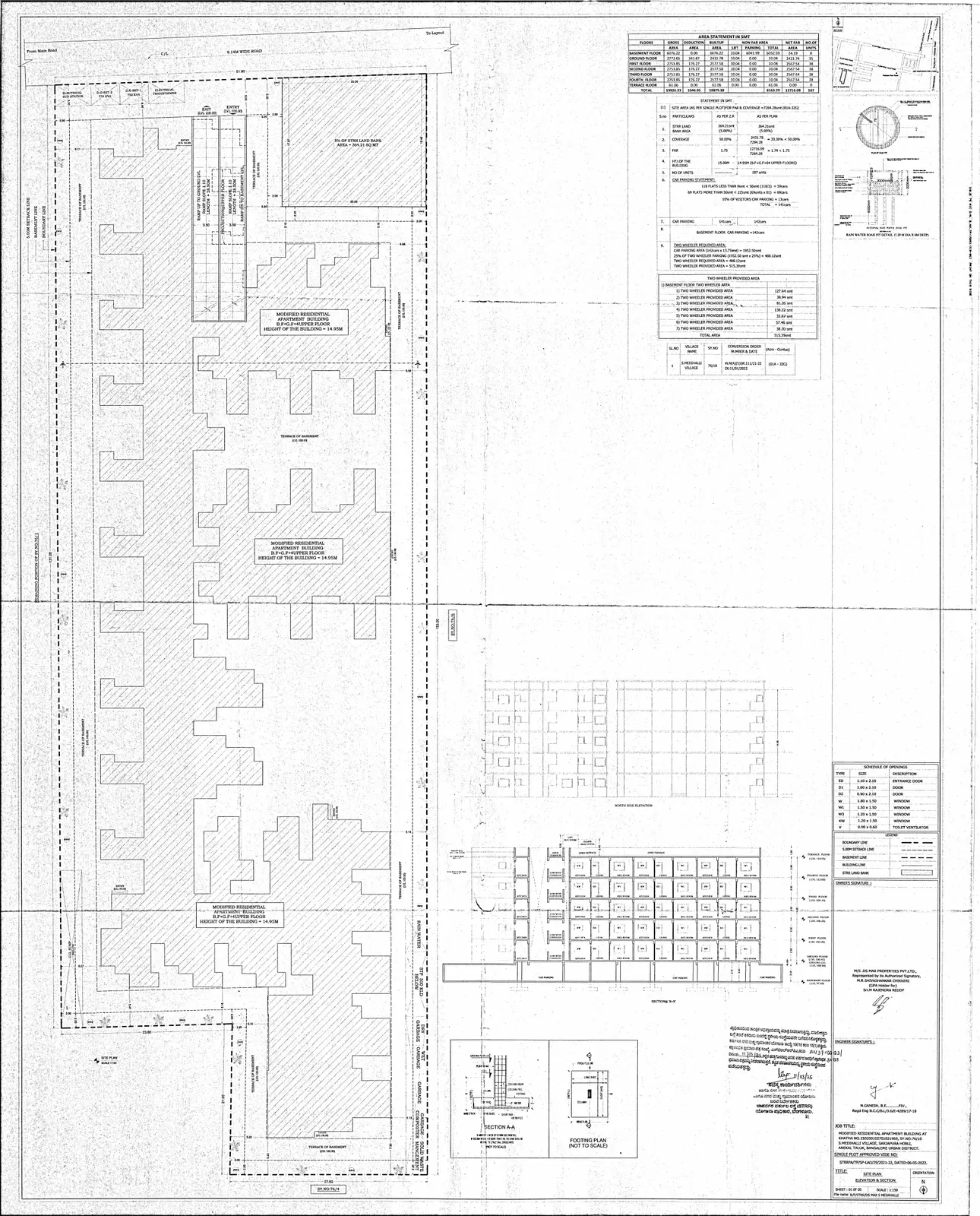

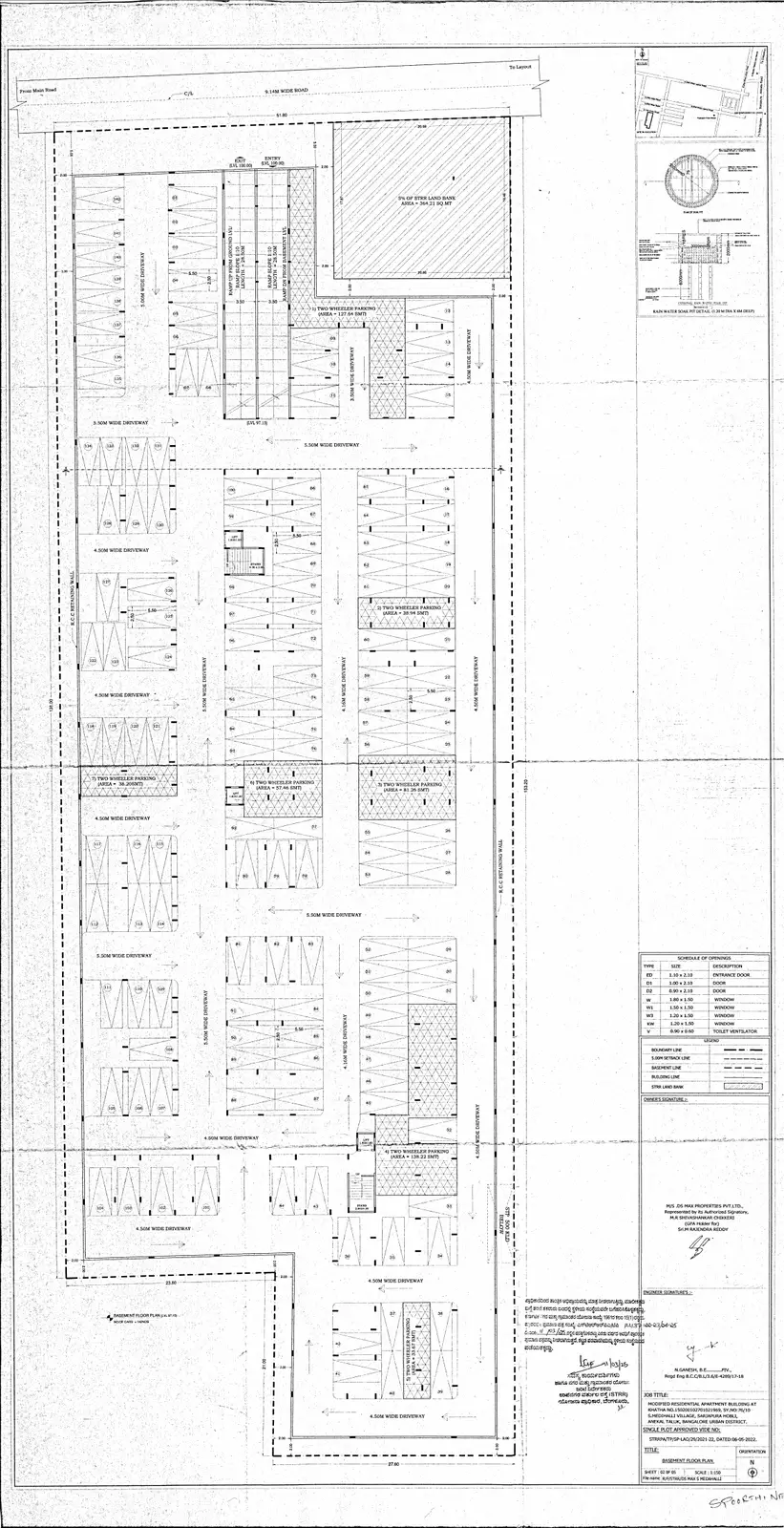

  • Building or layout plan · Approved drawings from the planning authorityFiled on RERA ✓ — Satellite Town Ring Road Planning Authority · No. STRRPA/TP/CC/37/2022-23 · dated 11 Mar 2025
  • Commencement certificate · Permission to start buildingFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Environment clearance · SEIAA KarnatakaNot on RERA yet
  • Fire NOC · Karnataka Fire and Emergency ServicesNot on RERA yet
  • Pollution board consent · KSPCBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Water and sewerage · BWSSBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Electricity · BESCOMFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Height clearance · Airports Authority of IndiaNot on RERA yet
  • Occupancy certificate (OC) · Issued only when the building is finishedNot on RERA yet — expected at completion

From the documents the promoter uploaded to Karnataka RERA, collected 19 Oct 2026. “Filed” means a document is on RERA — we have not checked its contents or validity. Not every approval applies to every project (for example, smaller projects may not need an environment clearance). The project page on RERA lists each upload.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

DS Max Spoorthi Nest RERA complaints

No complaints listed on Karnataka RERA for this registration as on Source (rera.karnataka.gov.in) (opens in a new tab)

Court and consumer cases

Not found in public records yet: court cases

We list case numbers, courts and outcomes only — never names of private individuals.

About DS-Max Properties

Founded
2007
Headquarters
Bengaluru
Bengaluru projects
44
Delivered on time
17 of 21
RERA complaints
19
Court cases listed
6

DS Max Properties Private Limited (CIN U70102KA2007PTC041508) has 44 projects registered with Karnataka RERA in the Bengaluru area. Of the 21 whose records show an occupancy certificate, 17 got it on or before the completion date promised at registration, 3 got it after that date but within a COVID-19 extension, and Sky Grand got it two days after its extended date; Sunworth, Sovereign and Sahara show no OC although their dates have passed. Karnataka RERA lists 19 complaints against the promoter (14 disposed), mostly about late handover, refunds and unregistered sale agreements, and the court cases found include a 2024 High Court order directing the builder to help form a flat owners' association at DS-Max Starnest.

DS-Max Properties’s full record

DS-Max Properties delivery record

As on 22 Oct 2026
  • 24Projects in Bengaluru on RERA24 approved registrations under DS Max Properties Private Limited in Bengaluru Urban and Rural. Source (rera.karnataka.gov.in) (opens in a new tab)
  • 10,303Homes registeredAs stated in each registrations.
  • 19RERA complaints5 open, 14 disposed. as on Source (rera.karnataka.gov.in) (opens in a new tab)
  • 1.8Complaints per 1,000 homes19 complaints ÷ 10,303 homes in its 24 registrations on Karnataka RERA in Bengaluru.
  • 9Completion filed on RERARegistrations where the promoter applied to RERA for completion; 9 with an occupancy certificate on RERA.
  • 3 of 9Filed by the date given at registrationMedian gap 10.1 months (on-time ones count as 0). The completion application can come after handover, so this is an upper bound on lateness.
  • 6Court cases listedFound in public court records; see the list on the builder’s page.

What the complaints are about

  • Delay in possession or delay interest6
  • Refund of booking or other money5
  • Construction quality, size or inspection2
  • Registration, sale deed or agreement2
  • Other4

19 complaint subjects as written on RERA, as on . Each subject is sorted into one group by keywords (first match wins: delay, refund, registration, quality, litigation, association); one complaint often raises several issues. Source (rera.karnataka.gov.in) (opens in a new tab)

Completion filed on RERA

ProjectDate at registrationCompletion filedGap
DS Max ShrestaOC on RERA31 Jul 202625 Sep 20262 months after
DS Max Sky ShubhamOC on RERA31 Mar 202711 May 2026By the date
DS Max SenateOC on RERA30 Jun 202611 May 2026By the date
DS Max Stavam NestOC on RERA30 Jun 202611 May 2026By the date
DS-Max Sky SupremeOC on RERA31 Dec 2023extended to 30 Sep 20242 Feb 202625 months after
DS Max Sonata NestOC on RERA30 Jun 20242 Feb 202619 months after
DS Max SasmaraOC on RERA31 Dec 20242 Feb 202613 months after
Sky GrandOC on RERA31 Mar 2023extended to 30 Dec 202431 Jan 202634 months after
DS Max StavamOC on RERA31 Mar 202531 Jan 202610 months after

Measured against the completion date given at registration; many projects had RERA extensions (including the COVID-period extension), shown under the date.

Handovers we checked by hand

21 rows: handovers. Scroll inside the table to see them all.

ProjectPromised (at registration)OCResultSource
DS MAX SHRESTA31 Jul 202627 May 2026On timeSource (rera.karnataka.gov.in) (opens in a new tab)
DS MAX SENATE30 Jun 202621 Jan 2025On timeSource (rera.karnataka.gov.in) (opens in a new tab)
SKY GRAND31 Mar 20231 Jan 202521 months lateSource (rera.karnataka.gov.in) (opens in a new tab)
DS MAX SKY SHUBHAM31 Mar 202716 Nov 2024On timeSource (rera.karnataka.gov.in) (opens in a new tab)
DS MAX SASMARA31 Dec 202429 Nov 2023On timeSource (rera.karnataka.gov.in) (opens in a new tab)
DS MAX STAVAM NEST30 Jun 202629 Nov 2023On timeSource (rera.karnataka.gov.in) (opens in a new tab)
DS-MAX SKY SUPREME31 Dec 202329 Nov 2023On timeSource (rera.karnataka.gov.in) (opens in a new tab)
SANGAM GRAND31 Mar 202331 May 20232 months lateSource (rera.karnataka.gov.in) (opens in a new tab)
DS MAX STAVAM31 Mar 202525 Apr 2023On timeSource (rera.karnataka.gov.in) (opens in a new tab)
DS MAX SKY CLASSIC31 Dec 20226 Jan 20231 months lateSource (rera.karnataka.gov.in) (opens in a new tab)
DS MAX SONATA NEST30 Jun 202420 Jul 2021On timeSource (rera.karnataka.gov.in) (opens in a new tab)
DS MAX SONATA31 Dec 20202 Jun 20215 months lateSource (rera.karnataka.gov.in) (opens in a new tab)
DS MAX SYNERGY31 Dec 20223 Apr 2021On timeSource (rera.karnataka.gov.in) (opens in a new tab)
Sankalp Manor30 Jun 202229 Oct 2020On timeSource (rera.karnataka.gov.in) (opens in a new tab)
DS MAX SATELLITE31 Dec 202024 Apr 2020On timeSource (rera.karnataka.gov.in) (opens in a new tab)
DS-MAX STAR LINE31 Dec 202020 Apr 2020On timeSource (rera.karnataka.gov.in) (opens in a new tab)
DS MAX SPLENDID31 Mar 201920 Dec 2018On timeSource (rera.karnataka.gov.in) (opens in a new tab)
DS MAX SAVERA30 Jun 201911 Jul 2018On timeSource (rera.karnataka.gov.in) (opens in a new tab)
DS MAX Silver Oak11 Dec 201828 May 2018On timeSource (rera.karnataka.gov.in) (opens in a new tab)
DS - Max Sparkle Nest14 Jun 201917 May 2018On timeSource (rera.karnataka.gov.in) (opens in a new tab)
DS Max Silverwood1 May 201921 Nov 2017On timeSource (rera.karnataka.gov.in) (opens in a new tab)

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)Source (indiankanoon.org) (opens in a new tab)Source (indiankanoon.org) (opens in a new tab)Source (indiankanoon.org) (opens in a new tab)Source (indiankanoon.org) (opens in a new tab)Source (indiankanoon.org) (opens in a new tab)Source (indiankanoon.org) (opens in a new tab)How we calculate this

What’s changed since Mar 2025

As on 19 Oct 2026
  1. 14 Oct 2026Quarterly update filed for Q2 2026-27: 15% built, 27 of 187 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  2. 14 Jul 2026Quarterly update filed for Q1 2026-27: 4% built, 23 of 187 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  3. 13 Apr 2026Quarterly update filed for Q4 2025-26: 3% built, 24 of 187 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  4. 23 Jan 2026Registered with Karnataka RERA (PRM/KA/RERA/1251/308/PR/230126/008427); completion date 31 Dec 2030 Source (rera.karnataka.gov.in) (opens in a new tab)
  5. 1 Dec 2025Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
  6. 11 Mar 2025Building plan approved by Satellite Town Ring Road Planning Authority (No. STRRPA/TP/CC/37/2022-23) Source (rera.karnataka.gov.in) (opens in a new tab)

Newest first. No extension of the completion date is recorded on RERA. When the RERA crawl sees a new filing, complaint or extension, it is added here with its date.

Home loan EMI calculator

No listed price found — enter one to try.

Example only — use your bank’s quote.

Monthly EMI
—
Down payment
—
Loan amount
—
Total interest
—

A calculation only, from the numbers you enter — not a loan offer.

All-in cost: GST, registration and other charges

The calculator loads when you scroll to it.

Assumptions
  • Base price: the builder’s price is not published in a form we could collect — enter it from the cost sheet.
  • GST 5% on the base price and charges — the usual rate for an under-construction home that is not “affordable housing” (1%).
  • Stamp duty about 5.6% and registration 2% — the Karnataka rule (registration was raised from 1% to 2% on 31 Aug 2025). Calculated on the agreement value.
  • Car parking, other charges and the maintenance deposit are not in the public record we collect; enter them from the builder’s cost sheet.
  • Loan on the agreement value (banks usually lend up to 75–90%); EMI is the standard reducing-balance formula. Example rate only — use your bank’s quote.

How we calculate this

DS Max Spoorthi Nest FAQs

What is DS Max Spoorthi Nest?

It is a residential project by DS Max Properties Private Limited with 187 homes in a single tower in Anekal, Bengaluru Urban.

How many homes does DS Max Spoorthi Nest have?

The project has 187 homes: 174 three-bedroom units and 13 two-bedroom units.

What are the carpet area sizes in DS Max Spoorthi Nest?

3 BHK homes range from 783 to 1,010 sq ft and 2 BHK homes range from 581 to 761 sq ft carpet area.

When will DS Max Spoorthi Nest be completed?

The completion date on RERA is 31 December 2030.

What is the RERA registration number for DS Max Spoorthi Nest?

The registration number is PRM/KA/RERA/1251/308/PR/230126/008427, registered on 23 January 2026.

Where is DS Max Spoorthi Nest located?

The project is in Anekal taluk, Bengaluru Urban district, PIN code 562107.

How many homes have been booked in DS Max Spoorthi Nest?

As of the quarter ended 30 September 2026, 27 homes have been booked out of 187.

What is the construction progress of DS Max Spoorthi Nest?

The project was 15% complete as of the quarter ended 30 September 2026.

Are there RERA complaints against DS Max Spoorthi Nest?

There are no RERA complaints filed against this project registration.

What is DS Max Properties Private Limited's track record?

DS Max Properties Private Limited has 44 projects in the Bengaluru RERA records and 19 RERA complaints across all their projects.

Written by AI from the RERA record above on 19 Oct 2026. Answers use only that record; check them against the source before you decide.

Questions about DS Max Spoorthi Nest

No questions published yet. Ask the first one: you get an instant answer from this page’s public record, and our team follows up on anything the record does not show.

Bought a home from DS-Max Properties? Review the builder.

Reviews of DS-Max Properties by verified buyers

No verified reviews of DS-Max Properties yet. If you bought a home from them, your review helps other buyers.

How reviews work: only buyers and owners can review; we confirm each purchase by phone before publishing, publish positive and negative reviews alike, never accept payment for reviews, and the builder may reply.

Similar projects within 5 km

ProjectDistanceHomesPossession (RERA)BuiltComplaintsPrice
DS Max SpoorthiDs Max Properties Private Limited0.1 km436Dec 2026100%0Not collected
JRC KansoM/s JRC Projects0.1 km122Mar 2031—0Not collected
Natura Atavi IICachet Projects LLP1.1 km96Dec 203096%0Not collected
JRC SanzioJRC Projects1.2 km39Dec 2027100%0Not collected
Aban DesireAban Developers Private Limited1.3 km140Dec 2028—6Not collected
Suyug'S The Shallot MarqueSuyug Ventures1.4 km54Mar 20285%0Not collected

Projects of the same kind within 5 km in a straight line of this project’s RERA map point, nearest first. % built is the promoter’s latest quarterly figure on RERA (shown for single-registration projects); prices are from the builder’s own website where we found one.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Sources and last checked dates

  1. Karnataka RERA — project register (search by the registration number) (opens in a new tab)

Collected on 19 Oct 2026 by AI research agents reading public pages. Facts are written in our own words. Not found yet: price; court cases; landmarks; specifications; news.

How to check on RERA: On rera.karnataka.gov.in/viewAllProjects, type the registration number in 'Registration No', press Search, then click the 'View Project Details' icon. Complaints open from the 'Complaints / Litigation' icon in the same row. Registration number: PRM/KA/RERA/1251/308/PR/230126/008427.

  • RERA record last checked: 19 Oct 2026
  • Last change in the record (registration, quarterly filing or complaint): 19 Oct 2026

How this page is made: software builds it from public records (Karnataka RERA filings, OpenStreetMap, the builder’s own website). AI is used only to read filings into fields and to write the plain-English summary and FAQ answers, which are checked against the record. Facts are checked automatically against the RERA filing. Methodology · How we earn · Report an error

More new projects in Sarjapur–Attibele Road
