Promont Phase II

Apartments by Smart Value Homes (Peenya Project) Private Limited · Hoskerehalli, Uttarahalli, Bengaluru

Hoskerehalli, Uttarahalli, BengaluruOpen on Google Maps (opens in a new tab)

  • Under construction
  • RERA registered
  • residential

by Smart Value Homes (Peenya Project) Private Limited · registered with RERA by Promont Hilltop Private Limited

Listed price: ₹4.11 Cr

as on · Source (tatahousing.com) (opens in a new tab)

Get today’s price list

Latest price for Promont Phase II

Builders change prices often and rarely publish them. Tell us how to reach you and we’ll send you the current price list.

Free for buyers. If you book through us, the builder pays us a commission. How we earn

Project summary

Promont Phase II is a residential project by Smart Value Homes (Peenya Project) Private Limited in Hoskerehalli, Bengaluru with 36 homes, registered with Karnataka RERA. The completion date on RERA is 31 Dec 2028.

Facts collected on 21 Oct 2026 from public records — each linked to its source. Free for buyers. If you book through us, the builder pays us a commission.

Promont Phase II buyers’ group: join to ask for a group price

No one has joined yet. Be one of the first 10 buyers in this group — the founding members.

Join free. When enough buyers have joined, our agent partner asks Smart Value Homes (Peenya Project) Private Limited for a group price — for example a lower price, an easier payment plan or waived charges. Nothing is promised: you see what the builder offers and book directly with the builder if you want to. Free for buyers. If you book through us, the builder pays us a commission.

  1. Gathering buyers
  2. Talking to the builder
  3. Group offer
  4. Group site visit
  5. Booking

0 buyers have joined · 0 committed

Committed buyers have confirmed their budget, home type and timeline with us on a call; builders negotiate with them. Joining is free and never obliges you to buy.

Join the Promont Phase II buyers’ groupHow group buying works

See it for yourself

Visit the site with our team, or get a call to clear your questions. Free, no obligation.

Key facts: home types, towers, land and possession

Updated on 21 Oct 2026
Home types
3 BHK, 4 BHK
Carpet area
1,488 – 1,989 sq ft
Towers
3
Floors
3
Total homes
36
Land
0.82 acres
Possession (RERA)
Dec 2028
Built (RERA update)
26%

Promont Phase II RERA number and registration details

RERA number
PRM/KA/RERA/1251/310/PR/300724/006953
Registered on
30 Jul 2024
Promised completion
31 Dec 2028
Extended to
No extension recorded
RERA status
New launch
Homes booked
26 of 36 as on
Price
₹4.11 Cr as on
Project type
Residential

From the builder’s own website; see the price list below for size basis.

Towers and blocks (RERA filing)

TowerFloorsBasementsHomes
Block 13112
Block 23112
Block 33112

A dash (—) means the filing did not state that value.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Promont Phase II price list

From the builder’s website, as on 8 Oct 2026
Home typeSizePrice₹ per sq ftSource
4 BHK—unknownFrom ₹4.11 Cronwards—Source (tatahousing.com) (opens in a new tab)

As published by the builder on the date shown — not an offer, and not checked with the builder. Check whether the size is carpet or super built-up area before comparing.

Sources:Source (tatahousing.com) (opens in a new tab)

Price history

As on 8 Oct 2026

One snapshot so far: the builder’s “onwards” prices seen on 8 Oct 2026. Each new check of the builder’s website adds a dated point here, so rises and offers show up with their dates.

0₹1 Cr₹2 Cr₹3 Cr₹4 Cr₹5 CrOct 26NovDecJan 27FebMarAprMayJunJulAugSepLater checks will appear here4 BHK ₹4.11 Cr
Seen onWherePrices
8 Oct 2026Builder’s website Source (tatahousing.com) (opens in a new tab)4 BHK from ₹4.11 Cr

Sources:Source (tatahousing.com) (opens in a new tab)

Summary in plain English

Promont Phase II is a residential project by Promont Hilltop Private Limited in Hoskerehalli, Bengaluru South, with 36 homes across 3 towers. The project has 4-bedroom and 3-bedroom apartments with carpet areas from 1,488 to 1,989 sq ft, registered with Karnataka RERA in July 2024. Completion is scheduled for 31 December 2028.

Written by AI from the RERA record above on 21 Oct 2026. Every number in it was checked against that record; if anything differs, the record wins.

Open space, home loans, escrow and other details

Open space
37% of land
Water and power
Water source filed with RERA: BWSSB
Home loans: approved banks
Not found in public records yet: bank approvals
Payment plans
Not found in public records yet: payment plans
Maintenance
Not found in public records yet: maintenance
Car parking
Not found in public records yet: car parking charge
Escrow bank (RERA)
ICICI Bank, Residency Road Branch, Bangalore

Building plan (RERA)
BBMP - Bruhat Bengaluru Mahanagara Palike · No. 73/10-11 · dated 11 Jun 2024
Project cost declared to RERA
₹65.07 Cr

Open area as a share of the land, from the areas filed with RERA (includes driveways and landscaped areas).

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Amenities

  • Electricity
  • CCTV Surveillance
  • Club House
  • Parks
  • Power Backup
  • Piped Gas
  • Water and Sanitation

Amenities and internal works as filed by the promoter with Karnataka RERA; we have not visited the site.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Promont Phase II location and address

Address
Sy No 168 (old Sy no 7) Ward No. 160, KHATA No. 824/7/168 Located at , Hoskerehalli Village, Uttarahalli Hobli , Bengaluru South , Bengaluru Urban, Karnataka - 560085
Village (RERA)
Hoskerehalli
Locality
Uttarahalli
PIN code
560085
City
Bengaluru
State
Karnataka
Coordinates
12.92104, 77.53689

Distances to landmarks

Not found in public records yet: landmarks

About Uttarahalli

Not found in public records yet: locality facts

Commute times to tech parks and the airport

As on 5 Oct 2026
ToStraight linePeak-hour drive (estimate)
KSR Bengaluru City railway station (Majestic)Map point on OpenStreetMap (opens in a new tab)7.27 kmapprox. 29 min
Outer Ring Road tech corridor (RMZ Ecospace, Bellandur)Map point on OpenStreetMap (opens in a new tab)15.65 kmapprox. 63 min
Electronic City Phase 1Map point on OpenStreetMap (opens in a new tab)15.99 kmapprox. 65 min
Manyata Tech ParkMap point on OpenStreetMap (opens in a new tab)16.75 kmapprox. 68 min
ITPL, Whitefield (main gate)Map point on OpenStreetMap (opens in a new tab)22.99 kmapprox. 93 min
Kempegowda International AirportMap point on OpenStreetMap (opens in a new tab)36.01 kmapprox. 146 min
How we calculate

Straight line: from the project’s map point on RERA to the destination’s point on OpenStreetMap.

Peak-hour drive is a rough estimate, not a route: straight line × 1.35 for the road network, at 20 km/h. Real times vary a lot with the route and the hour.

Sources:Source (openstreetmap.org) (opens in a new tab)How we calculate this

Schools and hospitals nearby

As on 5 Oct 2026

Within 2 km

  • 21Schools and colleges17 schools, 4 colleges, 0 kindergartens
  • 46Hospitals and clinics18 hospitals, 28 clinics

Nearest schools and colleges

  • Sharada Shri Public School · 0.99 km
  • Sri Chaitanya Techno School · 1.02 km
  • NCERT · 1.19 km

Nearest hospitals and clinics

  • Arogya Clinic · 0.52 km
  • Vaishanavi ENT Clinic · 0.62 km
  • Nargund Clinics · 0.63 km

Places as mapped on OpenStreetMap (amenity=school, college, kindergarten, university; hospital, clinic), counted within 2 km in a straight line of the RERA map point. Volunteers map these, so some places may be missing or closed. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.

Sources:Source (openstreetmap.org) (opens in a new tab)

Nearest metro station and railway

As on 5 Oct 2026
  • Rajarajeshwari Nagar (ರಾಜರಾಜೇಶ್ವರಿ ನಗರ)Open now — nearest operating metro station2.54 km
  • Nayandahalli (ನಾಯಂಡಹಳ್ಳಿ)Nearest railway station2.82 km

Straight-line distances from the RERA map point to the station points mapped on OpenStreetMap; status (open or under construction) as tagged there. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.

Sources:Source (openstreetmap.org) (opens in a new tab)

Lake and lake-buffer check

As on 5 Oct 2026

The nearest mapped lake is Hosakerahalli Lake, 463 m from the project’s RERA map point.

The site boundary is not published as a shape, so its nearest edge can be closer than this point. Whether any building sits inside a lake buffer can only be checked on the approved plan.

The buffer rule

Bengaluru’s lake buffer rule has changed over time: the National Green Tribunal ordered a 75 m buffer in May 2016; the Supreme Court set that order aside on 5 March 2019, leaving the 30 m buffer of the Revised Master Plan 2015. Check the current rule and the approved plan before relying on either number.

Shortest distance from the RERA map point to the mapped water edge (OpenStreetMap water polygons tagged lake or reservoir, or named lake/kere/tank). Mapped shorelines can differ from the revenue-record boundary of a lake. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.

Sources:Source (openstreetmap.org) (opens in a new tab)Source (livelaw.in) (opens in a new tab)Source (citizenmatters.in) (opens in a new tab)How we calculate this

Satellite time-lapse of the site

Satellite photos load when you scroll to them.

Photos from Esri World Imagery Wayback, centred on the project’s map point; dates are the capture dates in Esri’s metadata. Loaded from Esri when you scroll here.

Sources:Source (livingatlas.arcgis.com) (opens in a new tab)

Promont Phase II floor plans, brochure and elevations

Documents the builder uploaded to Karnataka RERA, shown as filed. Tap a page to see it full size; the full PDF opens on the RERA website.

Floor plans6 files

Elevations

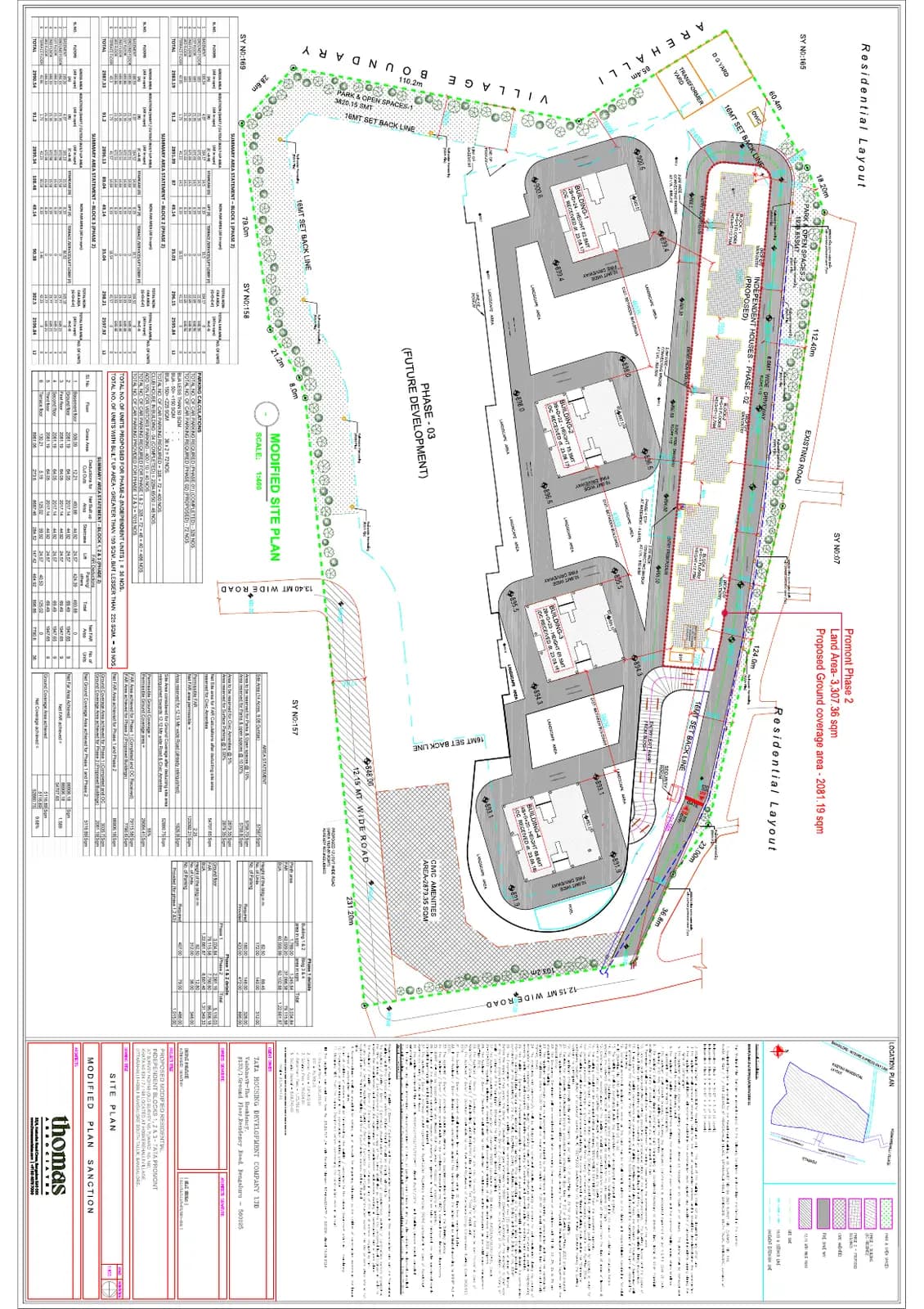

Approved layout plan3 files

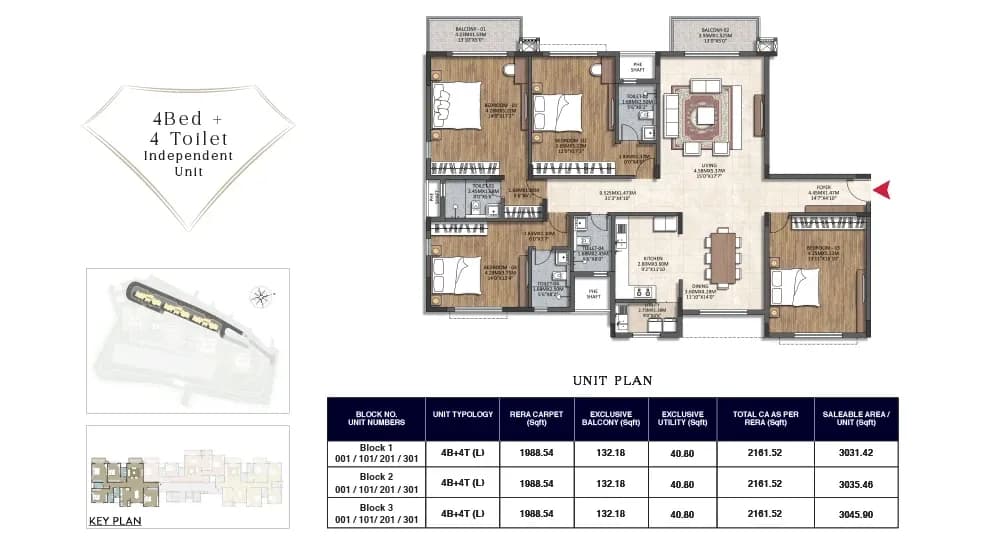

Home typeCarpet areaHomes
3b + 3t1,488 sq ft12
4b + 4t1,946 – 1,989 sq ft24

Home types, counts and carpet areas as filed with Karnataka RERA (carpet area, not super built-up).

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Promont Phase II possession date and construction status

  • Whole project (promoter’s RERA update)26%

    as on · 26 of 36 homes booked

Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-14.

By tower (Q2 2026-27)

  • Block 10%
  • Block 20%
  • Block 30%

Units sold and unsold, from RERA (Q2 2026-27)

TypeHomesBookedAvailable
3B + 3T12120
4B + 4T241410

As reported by the promoter in the quarterly update to RERA, not verified by us.

Timeline

  1. 30 Jul 2024Registered with Karnataka RERA
  2. 1 Aug 2024Project start date given to RERA
  3. 31 Dec 2028Completion date given at registration

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Construction pace from RERA quarterly filings

As on 14 Oct 2026

At the average pace so far, construction would reach 100% around Nov 2032 — about 47 months after the completion date on RERA (31 Dec 2028).

0%25%50%75%100%202520262027202820292030203120322033RERA date25%25%26%26%
  • Filed on RERA
  • Average pace since start
  • RERA completion date

Quarterly filings

QuarterFiled onBuiltHomes booked
Q2 2026-27to 30 Sep 202614 Oct 202626%26 of 36
Q1 2026-27to 30 Jun 202615 Jul 202626%26 of 36
Q4 2025-26to 31 Mar 202615 Apr 202625%26 of 36
Q3 2025-26to 31 Dec 202515 Jan 202625%36 of 36
How we calculate

Average pace = % built ÷ months since the start date in the RERA record. Here: 26% ÷ 26 months (1 Aug 2024 to 30 Sep 2026) = 1% a month.

Estimated finish = latest filing date + (100 − % built) ÷ pace = 30 Sep 2026 + 74 ÷ 1 = 73.9 months → Nov 2032. This is an estimate, not a date from the builder or RERA.

Pace between filings = (26% − 25%) ÷ 9 months = 0.1% a month.

A straight line is a simplification: the builder reports one overall %, which mixes excavation, structure and finishing, and work rarely moves at a constant speed. The % values are the promoter’s own figures filed with RERA, not checked by us. Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-14.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this

Approvals and documents checklist

16 rows: approvals. Scroll inside the table to see them all.

ApprovalAuthoritySource
Building planBBMP - Bruhat Bengaluru Mahanagara Palike · No. 73/10-11 · dated 2024-06-11Source (rera.karnataka.gov.in) (opens in a new tab)
Land conversionDC Office, Bangalore · No. 75/07-08 · dated 2009-01-27Source (rera.karnataka.gov.in) (opens in a new tab)
Commencement Certificatescan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Electricity Permission Letterscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Water Permission Letterscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Approved Layout Planscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Approved Building/Plotting Planscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Approved Section Of Building/Infrastructure Plan of Plottingscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Change of Land Usescan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
District Magistratescan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Conversion Certificate under section 95 of the KLR Act 1964scan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
ESCOM/Electricityscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
KWSSB/Waterscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
Fire Force Departmentscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
KSPCBscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)
SEIAAscan uploaded to RERASource (rera.karnataka.gov.in) (opens in a new tab)

Documents uploaded to RERA

As on 21 Oct 2026
  • Building or layout plan · Approved drawings from the planning authorityFiled on RERA ✓ — BBMP - Bruhat Bengaluru Mahanagara Palike · No. 73/10-11 · dated 11 Jun 2024
  • Commencement certificate · Permission to start buildingFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Environment clearance · SEIAA KarnatakaFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Fire NOC · Karnataka Fire and Emergency ServicesFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Pollution board consent · KSPCBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Water and sewerage · BWSSBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Electricity · BESCOMFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
  • Height clearance · Airports Authority of IndiaNot on RERA yet
  • Occupancy certificate (OC) · Issued only when the building is finishedNot on RERA yet — expected at completion

From the documents the promoter uploaded to Karnataka RERA, collected 21 Oct 2026. “Filed” means a document is on RERA — we have not checked its contents or validity. Not every approval applies to every project (for example, smaller projects may not need an environment clearance). The project page on RERA lists each upload.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Promont Phase II RERA complaints

No complaints listed on Karnataka RERA for this registration as on Source (rera.karnataka.gov.in) (opens in a new tab)

Court and consumer cases

Not found in public records yet: court cases

We list case numbers, courts and outcomes only — never names of private individuals.

About Smart Value Homes (Peenya Project) Private Limited

Promoter type
Company
Projects on this site
4
RERA complaints against promoter
3
Company number (CIN)
U45209MH2012PTC236134

From Karnataka RERA, as collected so far (21 Oct 2026). Complaints are those RERA lists against this promoter across all its projects.

Smart Value Homes (Peenya Project) Private Limited’s RERA record

Smart Value Homes (Peenya Project) Private Limited delivery record

As on 5 Oct 2026
  • 4Projects in Bengaluru on RERA9 approved registrations under Smart Value Homes (Peenya Project) Private Limited in Bengaluru Urban and Rural. Source (rera.karnataka.gov.in) (opens in a new tab)
  • 1,643Homes and plots registeredAs stated in each registrations.
  • 3RERA complaints0 open, 3 disposed. as on Source (rera.karnataka.gov.in) (opens in a new tab)
  • 1.8Complaints per 1,000 homes and plots3 complaints ÷ 1,643 homes and plots in its 9 registrations on Karnataka RERA in Bengaluru.
  • 1Completion filed on RERARegistrations where the promoter applied to RERA for completion; 0 with an occupancy certificate on RERA.
  • 0 of 1Filed by the date given at registrationMedian gap 1.9 months (on-time ones count as 0). The completion application can come after handover, so this is an upper bound on lateness.

What the complaints are about

  • Construction quality, size or inspection1
  • Refund of booking or other money1
  • Delay in possession or delay interest1

3 complaint subjects as written on RERA, as on . Each subject is sorted into one group by keywords (first match wins: delay, refund, registration, quality, litigation, association); one complaint often raises several issues. Source (rera.karnataka.gov.in) (opens in a new tab)

Completion filed on RERA

ProjectDate at registrationCompletion filedGap
Swaram Phase-131 Dec 2023extended to 3 Jan 202428 Feb 20242 months after

Measured against the completion date given at registration; many projects had RERA extensions (including the COVID-period extension), shown under the date.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this

What’s changed since Jun 2024

As on 21 Oct 2026
  1. 14 Oct 2026Quarterly update filed for Q2 2026-27: 26% built, 26 of 36 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  2. 8 Oct 2026Builder’s price list seen: 4 BHK from ₹4.11 Cr Source (tatahousing.com) (opens in a new tab)
  3. 15 Jul 2026Quarterly update filed for Q1 2026-27: 26% built, 26 of 36 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  4. 15 Apr 2026Quarterly update filed for Q4 2025-26: 25% built, 26 of 36 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  5. 15 Jan 2026Quarterly update filed for Q3 2025-26: 25% built, 36 of 36 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
  6. 1 Aug 2024Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
  7. 30 Jul 2024Registered with Karnataka RERA (PRM/KA/RERA/1251/310/PR/300724/006953); completion date 31 Dec 2028 Source (rera.karnataka.gov.in) (opens in a new tab)
  8. 11 Jun 2024Building plan approved by BBMP - Bruhat Bengaluru Mahanagara Palike (No. 73/10-11) Source (rera.karnataka.gov.in) (opens in a new tab)

Newest first. No extension of the completion date is recorded on RERA. When the RERA crawl sees a new filing, complaint or extension, it is added here with its date.

Home loan EMI calculator

Starts at the lowest listed price; change it to the home you want.

Example only — use your bank’s quote.

Monthly EMI
₹2,85,340
Down payment
₹82,20,000
Loan amount
₹3,28,80,000
Total interest
₹3,56,01,667

A calculation only, from the numbers you enter — not a loan offer.

All-in cost: GST, registration and other charges

The calculator loads when you scroll to it.

Assumptions
  • Base price: the builder’s price is not published in a form we could collect — enter it from the cost sheet.
  • GST 5% on the base price and charges — the usual rate for an under-construction home that is not “affordable housing” (1%).
  • Stamp duty about 5.6% and registration 2% — the Karnataka rule (registration was raised from 1% to 2% on 31 Aug 2025). Calculated on the agreement value.
  • Car parking, other charges and the maintenance deposit are not in the public record we collect; enter them from the builder’s cost sheet.
  • Loan on the agreement value (banks usually lend up to 75–90%); EMI is the standard reducing-balance formula. Example rate only — use your bank’s quote.

How we calculate this

Promont Phase II FAQs

What is Promont Phase II?

Promont Phase II is a residential project with 36 homes in 3 towers, located in Hoskerehalli, Bengaluru South.

When will Promont Phase II be completed?

The project completion date on RERA is 31 December 2028.

What home types are available in Promont Phase II?

The project has 4-bedroom + 4-toilet homes (24 units, 1,946 to 1,989 sq ft carpet area) and 3-bedroom + 3-toilet homes (12 units, 1,488 sq ft carpet area).

How many homes in Promont Phase II are booked?

As of Q2 2026-27, 26 homes are booked out of 36.

What is the construction progress of Promont Phase II?

As of Q2 2026-27 (30 September 2026), the project is 26% complete.

What is the RERA registration number for Promont Phase II?

The RERA registration number is PRM/KA/RERA/1251/310/PR/300724/006953, registered on 30 July 2024.

How many complaints are there against Promont Phase II?

There are no RERA complaints on this project.

Where is Promont Phase II located?

The project is in Hoskerehalli, Bengaluru South taluk, PIN code 560085.

How many towers does Promont Phase II have?

The project has 3 towers, each with a maximum of 3 floors.

What is the builder's track record?

Promont Hilltop Private Limited has no RERA complaints across all its projects in the Bengaluru records.

Written by AI from the RERA record above on 21 Oct 2026. Answers use only that record; check them against the source before you decide.

Questions about Promont Phase II

No questions published yet. Ask the first one: you get an instant answer from this page’s public record, and our team follows up on anything the record does not show.

Bought a home from Smart Value Homes (Peenya Project) Private Limited? Review the builder.

Reviews of Smart Value Homes (Peenya Project) Private Limited by verified buyers

No verified reviews of Smart Value Homes (Peenya Project) Private Limited yet. If you bought a home from them, your review helps other buyers.

How reviews work: only buyers and owners can review; we confirm each purchase by phone before publishing, publish positive and negative reviews alike, never accept payment for reviews, and the builder may reply.

Similar projects within 5 km

ProjectDistanceHomesPossession (RERA)BuiltComplaintsPrice
Mars The PlanetM/S Mars Builders0.1 km176Mar 2029100%0Not collected
Sobha Royal CrestSobha Limited0.6 km329Dec 202860%2from ₹2 Cr
Sobha Valley View - HeritageSobha Limited1.3 km624Feb 2019—19from ₹2 Cr
4 Square White Petals4 Square Realty1.5 km100Sep 2025—0Not collected
Brigade Nanda HeightsBrigade Enterprises Ltd1.9 km107Dec 2026100%0Not collected
Brigade Komarla HeightsBrigade Enterprises Ltd1.9 km318Dec 2026100%1Not collected

Projects of the same kind within 5 km in a straight line of this project’s RERA map point, nearest first. % built is the promoter’s latest quarterly figure on RERA (shown for single-registration projects); prices are from the builder’s own website where we found one.

Sources:Source (rera.karnataka.gov.in) (opens in a new tab)

Sources and last checked dates

  1. Karnataka RERA — project register (search by the registration number) (opens in a new tab)

Collected on 21 Oct 2026 by AI research agents reading public pages. Facts are written in our own words. Not found yet: price; court cases; landmarks; specifications; news.

How to check on RERA: On rera.karnataka.gov.in/viewAllProjects, type the registration number in 'Registration No', press Search, then click the 'View Project Details' icon. Complaints open from the 'Complaints / Litigation' icon in the same row. Registration number: PRM/KA/RERA/1251/310/PR/300724/006953.

  • RERA record last checked: 21 Oct 2026
  • Last change in the record (registration, quarterly filing or complaint): 21 Oct 2026
  • Builder price list seen: 8 Oct 2026

How this page is made: software builds it from public records (Karnataka RERA filings, OpenStreetMap, the builder’s own website). AI is used only to read filings into fields and to write the plain-English summary and FAQ answers, which are checked against the record. Facts are checked automatically against the RERA filing. Methodology · How we earn · Report an error
