Samhita Serene MTB
1, 2 & 3 BHK apartments by Samhita Estates LLP · Kithiganur, near KR Puram, Bengaluru
Kithiganur, near KR Puram, BengaluruOpen on Google Maps (opens in a new tab)
- Under construction
- RERA registered
- residential
Price: Price on request

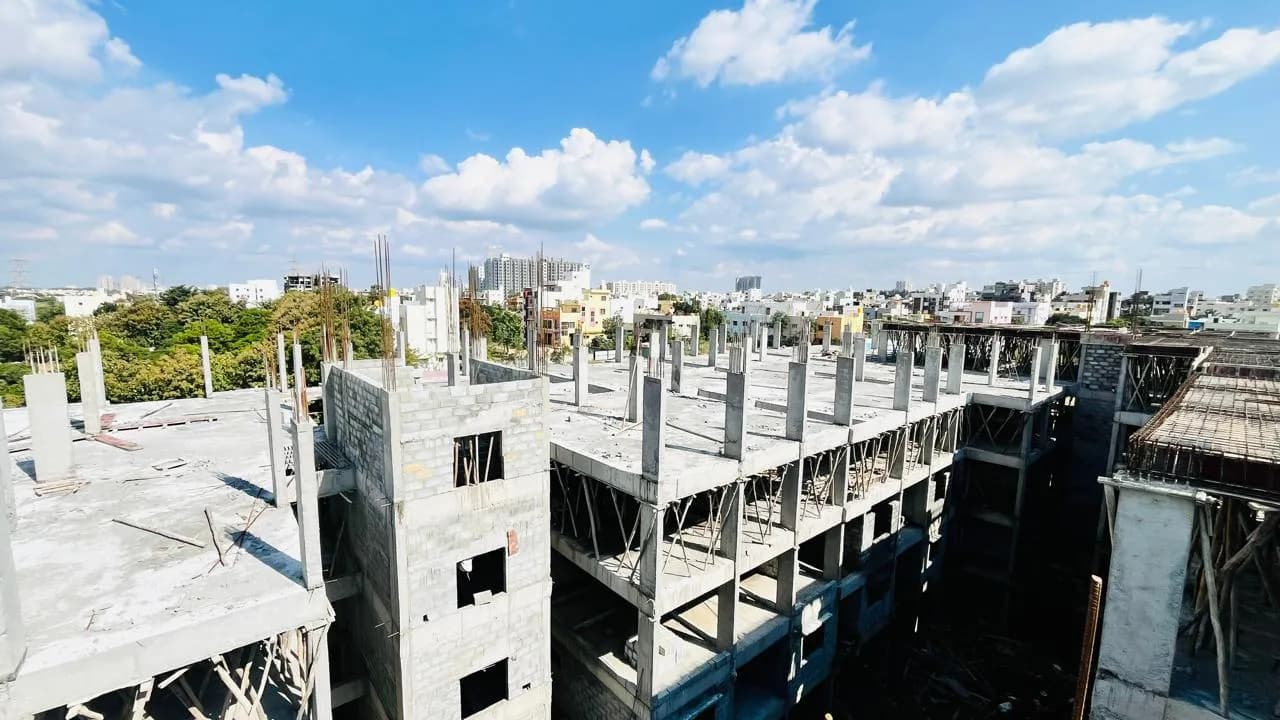

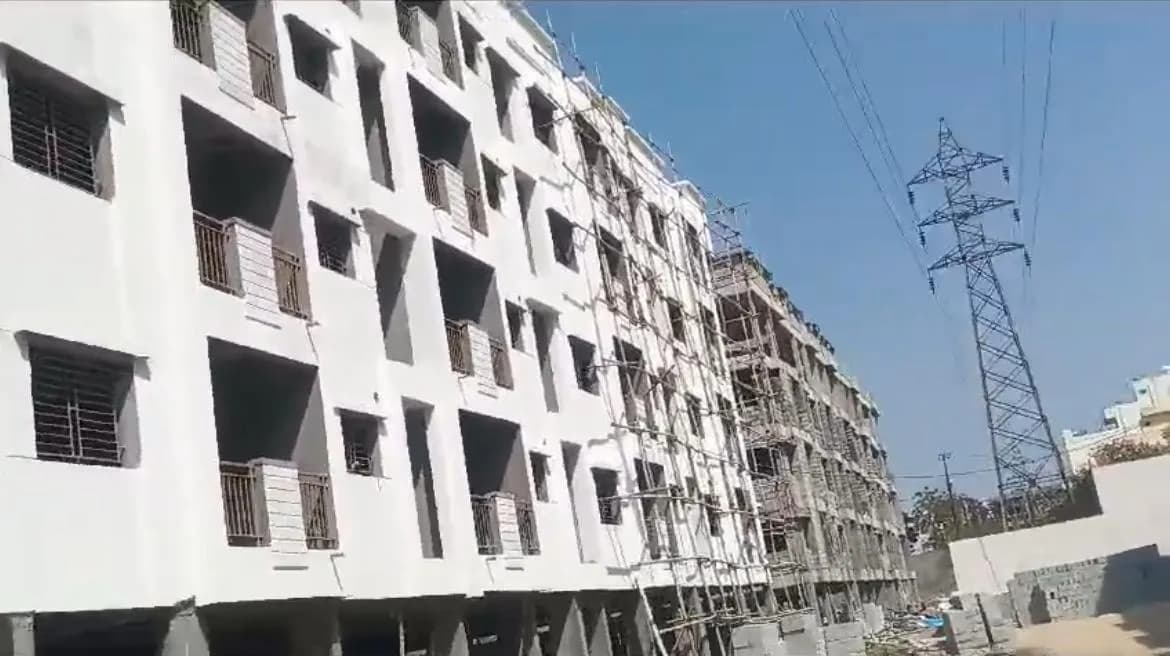

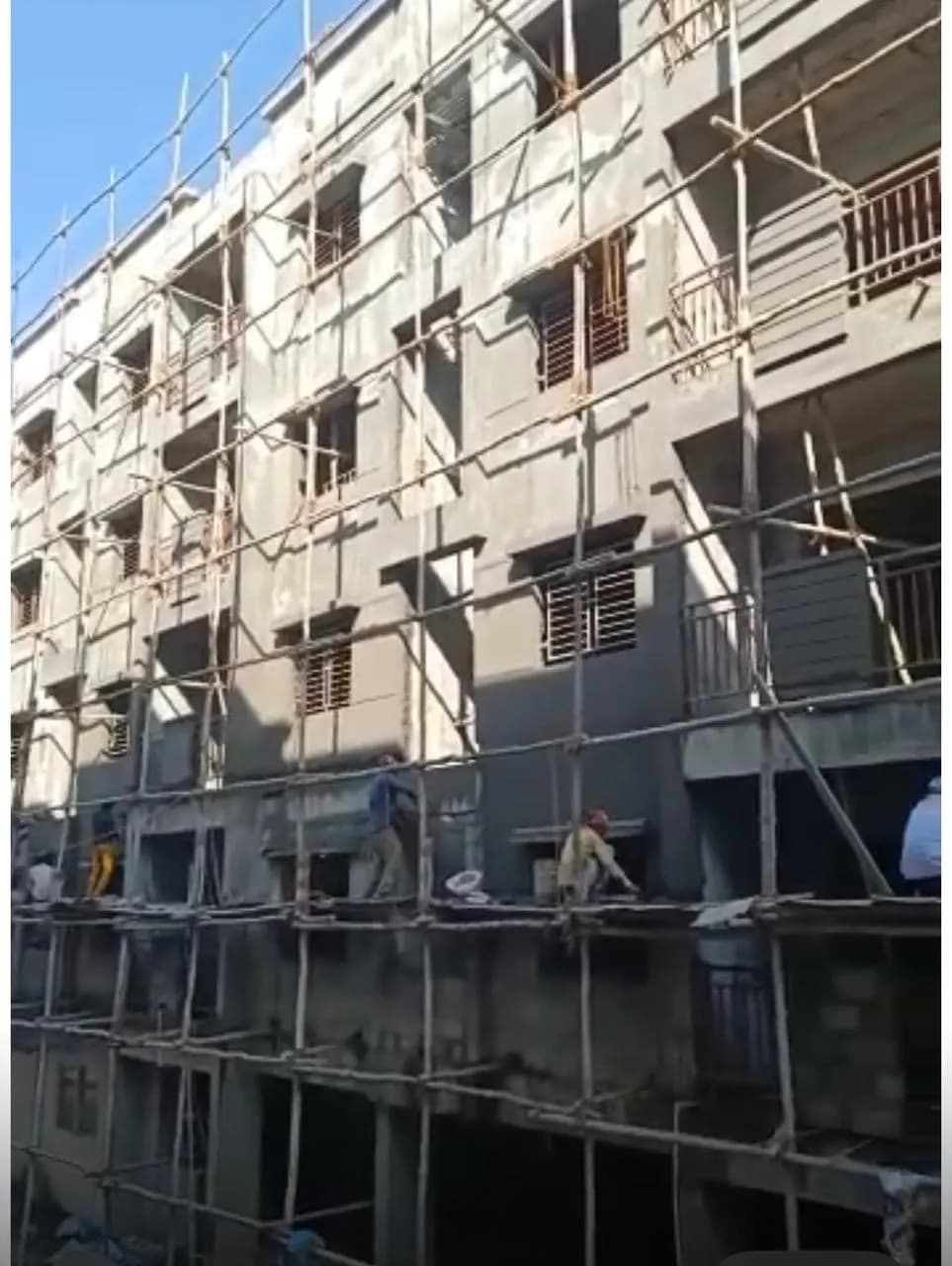

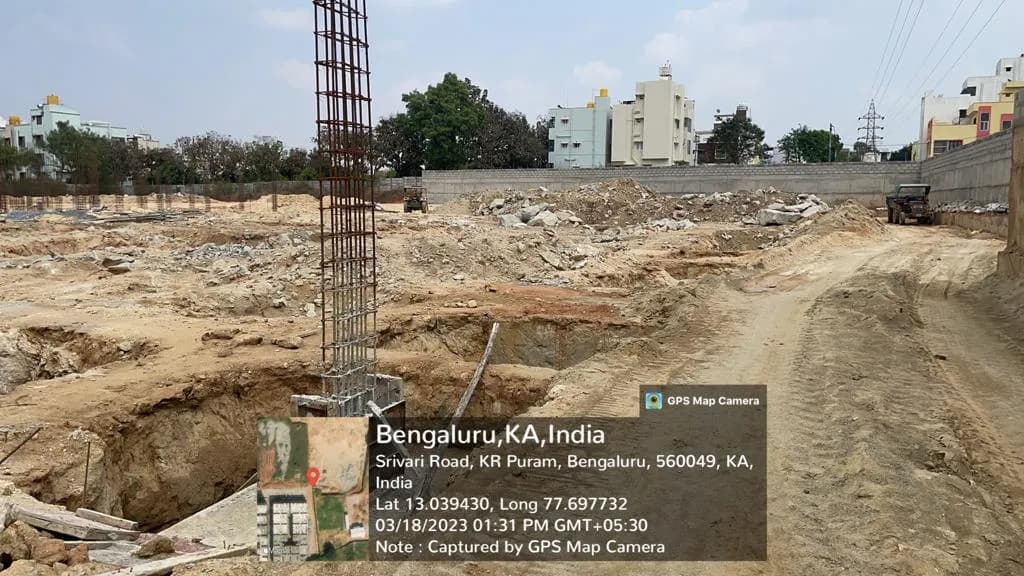

Site photo filed with Karnataka RERA Karnataka RERA filing · Source ↗ (opens in a new tab)
Samhita Serene MTB at a glance
- Possession (RERA)Dec 2026Karnataka RERA
- Construction88% built · on pace for Nov 2026RERA filing to 30 Jun 2026 (Phase II); estimate from average pace
- RERA complaints (project)2 complaintsKarnataka RERA · as on 22 Oct 2026
- Approvals filed5 of 9 on RERAKarnataka RERA uploads · 22 Oct 2026
- Nearest metroHoramavu · 4.78 km (under construction)Open now: Singayyanapalya, 4.83 km · straight line · OpenStreetMap, 5 Oct 2026
- Airport driveapprox. 73 min at peak17.92 km straight line · estimate
- Nearest lakeUnnamed lake · 673 mFrom the RERA map point · OpenStreetMap, 5 Oct 2026
Project summary
Samhita Serene MTB is a residential project by Samhita Estates LLP in Kithiganur, Bengaluru with 484 homes, registered with Karnataka RERA. The completion date on RERA is 31 Dec 2026. It is registered in 2 phases.
Facts collected on 22 Oct 2026 from public records — each linked to its source. Free for buyers. If you book through us, the builder pays us a commission.
Samhita Serene MTB buyers’ group: join to ask for a group price
No one has joined yet. Be one of the first 10 buyers in this group — the founding members.
Join free. When enough buyers have joined, our agent partner asks Samhita Estates LLP for a group price — for example a lower price, an easier payment plan or waived charges. Nothing is promised: you see what the builder offers and book directly with the builder if you want to. Free for buyers. If you book through us, the builder pays us a commission.
- Gathering buyers
- Talking to the builder
- Group offer
- Group site visit
- Booking
0 buyers have joined · 0 committed
Committed buyers have confirmed their budget, home type and timeline with us on a call; builders negotiate with them. Joining is free and never obliges you to buy.
Join the Samhita Serene MTB buyers’ groupHow group buying works
See it for yourself
Visit the site with our team, or get a call to clear your questions. Free, no obligation.
Key facts: home types, towers, land and possession
- Home types
- 1 BHK, 2 BHK, 3 BHK
- Carpet area
- 479 – 1,119 sq ft
- Towers
- 5
- Floors
- 4
- Total homes
- 484
- Land
- 6.5 acres
- Possession (RERA)
- Dec 2026
- Built (RERA update)
- Not found in public records yet: construction progress
Samhita Serene MTB RERA number and registration details
- RERA number
- PRM/KA/RERA/1251/446/PR/210810/004251
- Registered on
- 10 Aug 2021
- Promised completion
- 31 Dec 2026
- Extended to
- No extension recorded
- RERA status
- New launch
- Homes booked
- Not found in public records yet: homes booked
- Price
- Not found in public records yet: price
- Project type
- Residential
2 RERA registrations (one per phase) are shown together on this page; dates above are the latest across phases.
Phases and RERA numbers
| Phase | RERA number | Promised completion | Homes | Status | Source |
|---|---|---|---|---|---|
| Phase I | PRM/KA/RERA/1251/446/PR/210810/004251 | 31 Dec 2024 | 192 | Completed | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Phase II | PRM/KA/RERA/1251/446/PR/231123/006425 | 31 Dec 2026 | 292 | New launch | Source (rera.karnataka.gov.in) (opens in a new tab) |
Towers and blocks (RERA filing)
| Tower | Phase | Floors | Basements | Homes |
|---|---|---|---|---|
| BLOCK A | Phase I | 4 | 0 | 96 |
| BLOCK B | Phase I | 4 | 0 | 96 |
| BLOCK C | Phase II | 3 | 0 | 84 |
| BLOCK D | Phase II | 3 | 0 | 92 |
| BLOCK E | Phase II | 3 | 0 | 116 |
A dash (—) means the filing did not state that value.
Summary in plain English
Samhita Estates LLP is developing a residential project in Kithiganur, Bengaluru East (PIN 560016) with 484 homes across 2 phases. Phase I has 192 homes in 2 towers and is due for completion on 31 December 2024. Phase II has 292 homes in 3 towers and is due for completion on 31 December 2026.
Written by AI from the RERA record above on 5 Oct 2026. Every number in it was checked against that record; if anything differs, the record wins.
Open space, home loans, escrow and other details
- Open space
- Not found in public records yet: open space
- Water and power
- Water source filed with RERA: BoreWell,BWSSB
- Home loans: approved banks
- Not found in public records yet: bank approvals
- Payment plans
- Not found in public records yet: payment plans
- Maintenance
- Not found in public records yet: maintenance
- Car parking
- Not found in public records yet: car parking charge
- Escrow bank (RERA) · Phase I
- KOTAK MAHINDRA BANK, INDIRANAGAR
- Escrow bank (RERA) · Phase II
- FEDERAL BANK OF INDIA, Indiranagar Bengaluru
Amenities
- Electricity
- CCTV Surveillance
- Club House
- Community Hall
- Outdoor Sports facility
- Indoor Sports facility
- Swimming Pool
- Gym
- Parks
- Power Backup
- Water and Sanitation
Amenities and internal works as filed by the promoter with Karnataka RERA; we have not visited the site.
Samhita Serene MTB location and address
- Address
- SY NO.132/1, 132/2, 132/3 & 132/5 (132/4-OLD), KITHIGANUR VILLAGE, BIDARAHALLI HOBLI, BANGALORE
- Village (RERA)
- Kithiganur
- Locality
- Near KR PuramAlso known as Krishnarajapuram, K R Puram
- PIN code
- 560016
- City
- Bengaluru
- State
- Karnataka
- Coordinates
- 13.03973, 77.69721
Distances to landmarks
Not found in public records yet: landmarksAbout Kithiganur
Not found in public records yet: locality factsCommute times to tech parks and the airport
| To | Straight line | Peak-hour drive (estimate) |
|---|---|---|
| ITPL, Whitefield (main gate)Map point on OpenStreetMap (opens in a new tab) | 7.27 km | approx. 29 min |
| Manyata Tech ParkMap point on OpenStreetMap (opens in a new tab) | 8.43 km | approx. 34 min |
| Outer Ring Road tech corridor (RMZ Ecospace, Bellandur)Map point on OpenStreetMap (opens in a new tab) | 13.02 km | approx. 53 min |
| KSR Bengaluru City railway station (Majestic)Map point on OpenStreetMap (opens in a new tab) | 15.43 km | approx. 62 min |
| Kempegowda International AirportMap point on OpenStreetMap (opens in a new tab) | 17.92 km | approx. 73 min |
| Electronic City Phase 1Map point on OpenStreetMap (opens in a new tab) | 21.42 km | approx. 87 min |
How we calculate
Straight line: from the project’s map point on RERA to the destination’s point on OpenStreetMap.
Peak-hour drive is a rough estimate, not a route: straight line × 1.35 for the road network, at 20 km/h. Real times vary a lot with the route and the hour.
Sources:Source (openstreetmap.org) (opens in a new tab)How we calculate this
Schools and hospitals nearby
Within 2 km
- 24Schools and colleges19 schools, 5 colleges, 0 kindergartens
- 7Hospitals and clinics1 hospitals, 6 clinics
Nearest schools and colleges
- Diamond PU College · 0.47 km
- Birla Open Minds International School · 0.56 km
- Christ International School · 0.79 km
Nearest hospitals and clinics
- Sri Krishna Ayurvedic Clinic · 1.83 km
- GSR Dental & Health Care · 1.84 km
- Amma Poly Clinic · 1.85 km
Places as mapped on OpenStreetMap (amenity=school, college, kindergarten, university; hospital, clinic), counted within 2 km in a straight line of the RERA map point. Volunteers map these, so some places may be missing or closed. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Nearest metro station and railway
- Horamavu (ಹೊರಮಾವು)Blue Line metro, under construction4.78 km
- Singayyanapalya (ಸಿಂಗಯ್ಯನಪಾಳ್ಯ)Open now — nearest operating metro station4.83 km
- Channasandra (ಚನ್ನಸಂದ್ರ)Nearest railway station4.85 km
Straight-line distances from the RERA map point to the station points mapped on OpenStreetMap; status (open or under construction) as tagged there. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Lake and lake-buffer check
The nearest mapped lake is Unnamed lake (mapped on OpenStreetMap), 673 m from the project’s RERA map point.
The site boundary is not published as a shape, so its nearest edge can be closer than this point. Whether any building sits inside a lake buffer can only be checked on the approved plan.
- Unnamed lake (mapped on OpenStreetMap) on OpenStreetMap (opens in a new tab) 673 m
- Unnamed lake (mapped on OpenStreetMap) on OpenStreetMap (opens in a new tab) 779 m
- Ramapura Kere on OpenStreetMap (opens in a new tab) (ರಾಮಪುರ ಕೆರೆ)879 m
The buffer rule
Bengaluru’s lake buffer rule has changed over time: the National Green Tribunal ordered a 75 m buffer in May 2016; the Supreme Court set that order aside on 5 March 2019, leaving the 30 m buffer of the Revised Master Plan 2015. Check the current rule and the approved plan before relying on either number.
- LiveLaw: SC sets aside NGT order enlarging buffer zones (2019) (livelaw.in) (opens in a new tab)
- Citizen Matters: Shrinking lake buffers (citizenmatters.in) (opens in a new tab)
Shortest distance from the RERA map point to the mapped water edge (OpenStreetMap water polygons tagged lake or reservoir, or named lake/kere/tank). Mapped shorelines can differ from the revenue-record boundary of a lake. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Sources:Source (openstreetmap.org) (opens in a new tab)Source (livelaw.in) (opens in a new tab)Source (citizenmatters.in) (opens in a new tab)How we calculate this
Satellite time-lapse of the site
Satellite photos load when you scroll to them.
Photos from Esri World Imagery Wayback, centred on the project’s map point; dates are the capture dates in Esri’s metadata. Loaded from Esri when you scroll here.
Sources:Source (livingatlas.arcgis.com) (opens in a new tab)
Samhita Serene MTB floor plans, brochure and elevations
Documents the builder uploaded to Karnataka RERA, shown as filed. Tap a page to see it full size; the full PDF opens on the RERA website.
Floor plans2 files

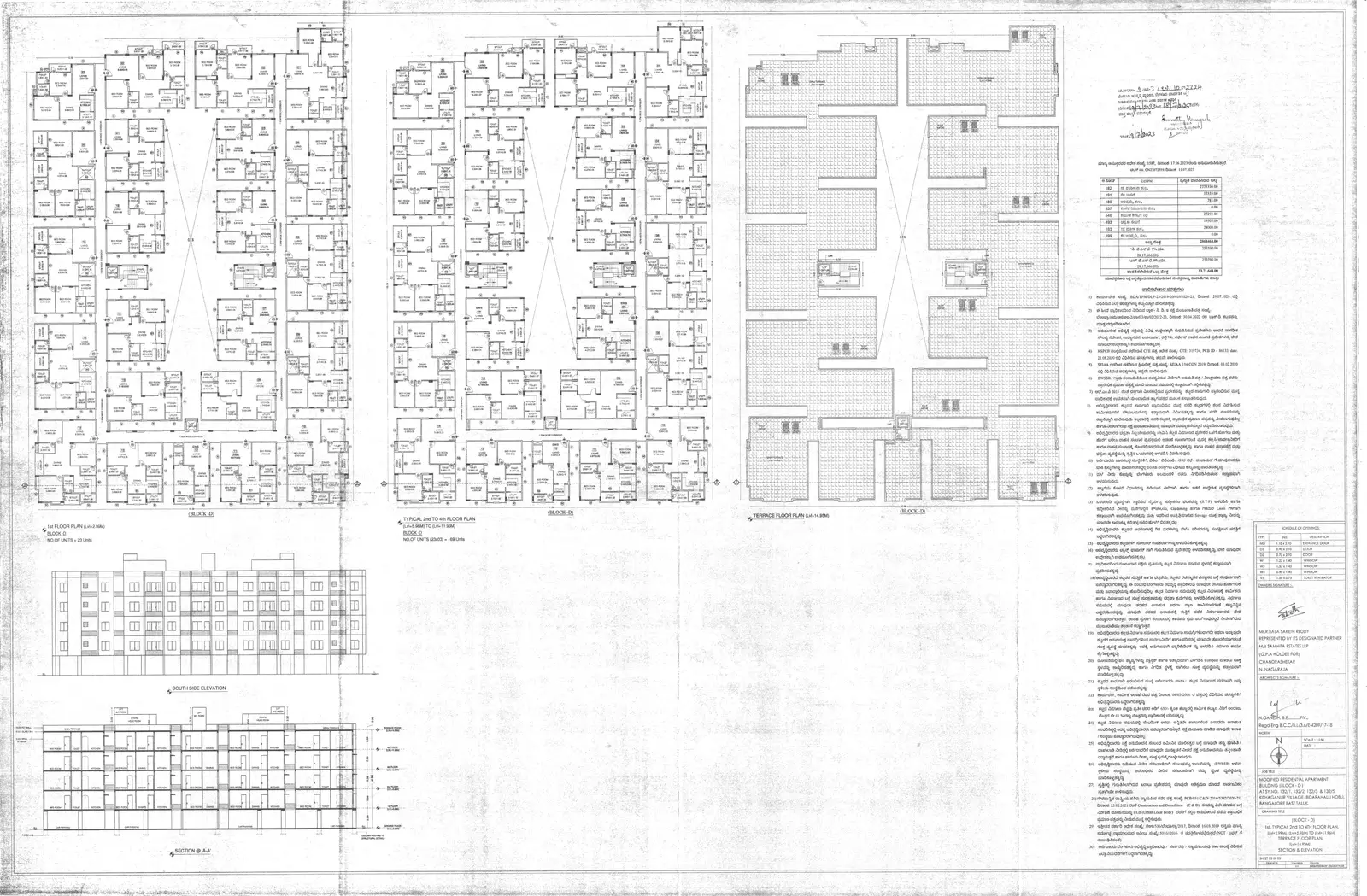

Phase II: 3 Revised Typical(1st, 2nd & 3rd) Floor Plan Block-D.pdfFull PDF on RERA

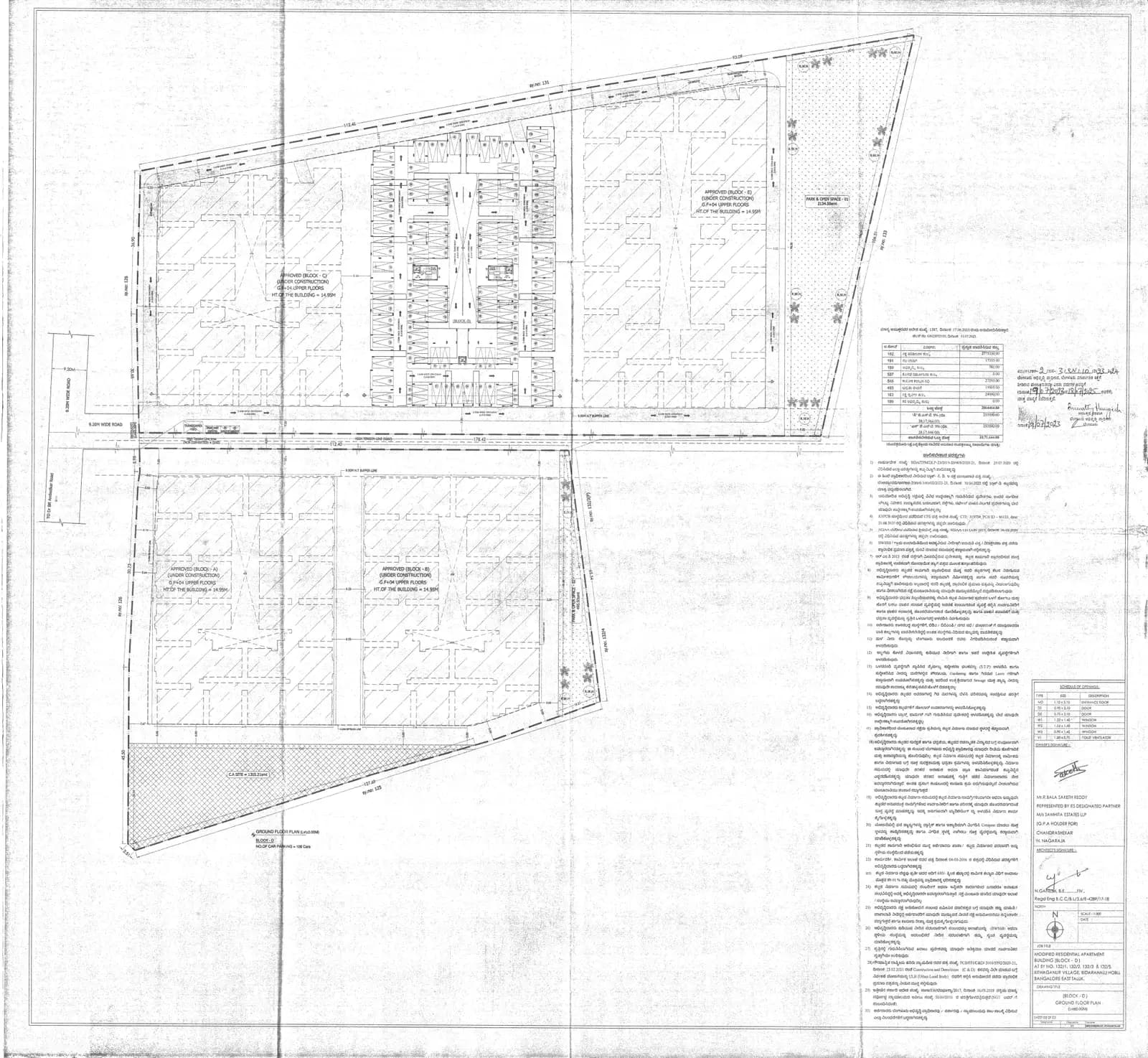

Phase II: 2 Revised Ground Floor Plan Block-D.pdfFull PDF on RERA
Approved layout plan2 files

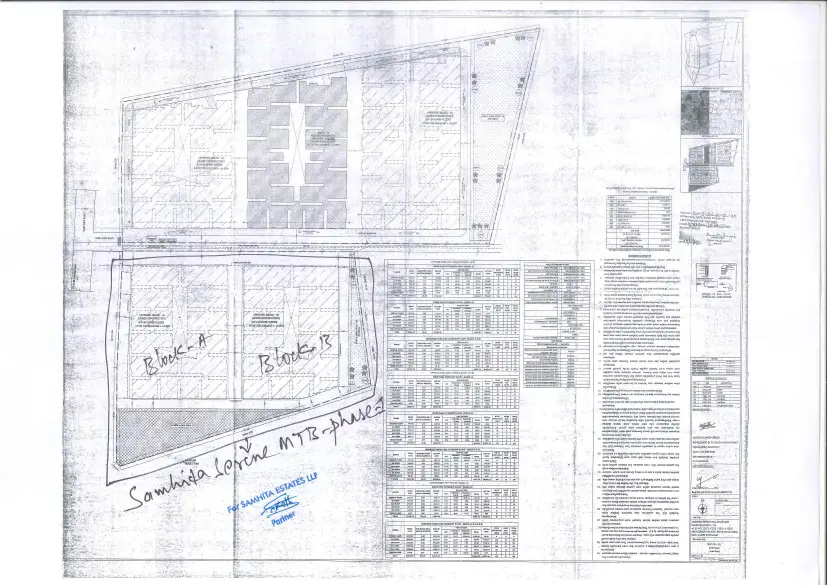

Phase II: Area Demarcation - Block A & B.pdfFull PDF on RERA
Phase II: STP Demarcation.pdfFull PDF on RERA
| Home type | Carpet area | Homes |
|---|---|---|
| 1 BHK | 479 – 524 sq ft | 32 |
| 2 BHK | 683 – 853 sq ft | 340 |
| 3 BHK | 979 – 1,119 sq ft | 112 |
Home types, counts and carpet areas as filed with Karnataka RERA (carpet area, not super built-up).
We have not collected floor-plan drawings; the builder’s sales team can share them.
Samhita Serene MTB possession date and construction status
Timeline
- 1 Mar 2021Phase I: Project start date given to RERA
- 10 Aug 2021Phase I: Registered with Karnataka RERA
- 1 Sep 2023Phase II: Project start date given to RERA
- 23 Nov 2023Phase II: Registered with Karnataka RERA
- 27 Dec 2024Phase I: Promoter applied to RERA for completion
- 31 Dec 2024Phase I: Completion date given at registration
- 31 Dec 2026Phase II: Completion date given at registration
Construction pace from RERA quarterly filings (Phase II)
At the average pace so far, construction would reach 100% around Nov 2026 — about 1 month before the completion date on RERA (31 Dec 2026).
At the pace between the 3 quarterly filings we have (75% → 88% in 6 months), it would be around Dec 2026 — about 1 month before the RERA date.
This project has 2 RERA registrations; the chart uses Phase II, the one with the most quarterly filings.
- Filed on RERA
- Average pace since start
- Pace between filings (and 0% assumed at the start date)
- RERA completion date
Quarterly filings
| Quarter | Filed on | Built | Homes booked |
|---|---|---|---|
| Q1 2026-27to 30 Jun 2026 | 14 Jul 2026 | 88% | 158 of 292 |
| Q4 2025-26to 31 Mar 2026 | 15 Apr 2026 | 78% | 158 of 292 |
| Q3 2025-26to 31 Dec 2025 | 19 Jan 2026 | 75% | — |
How we calculate
Average pace = % built ÷ months since the start date in the RERA record. Here: 88% ÷ 33.9 months (1 Sep 2023 to 30 Jun 2026) = 2.6% a month.
Estimated finish = latest filing date + (100 − % built) ÷ pace = 30 Jun 2026 + 12 ÷ 2.6 = 4.6 months → Nov 2026. This is an estimate, not a date from the builder or RERA.
Pace between filings = (88% − 75%) ÷ 5.9 months = 2.2% a month.
A straight line is a simplification: the builder reports one overall %, which mixes excavation, structure and finishing, and work rarely moves at a constant speed. The % values are the promoter’s own figures filed with RERA, not checked by us.
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
Approvals and documents checklist
15 rows: approvals. Scroll inside the table to see them all.
| Approval | Authority | Source |
|---|---|---|
| Building plan (Phase I) | BDA - Bangalore Development Authority | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Building plan (Phase II) | BDA - Bangalore Development Authority · No. NM/AS/AA/2/TS/3/w/10/2023-24 · dated 2023-07-19 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Land conversion (3 orders) (Phase II) | DC Bengaluru · No. ALN(EB)SR 37/11-12 and 2 more · dated 2011-08-08 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Commencement Certificate (Phase II) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Electricity Permission Letter (Phase II) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Water Permission Letter (Phase II) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Layout Plan (Phase II) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Building/Plotting Plan (Phase II) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Section Of Building/Infrastructure Plan of Plotting (Phase II) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Change of Land Use (Phase II) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| District Magistrate (Phase II) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Conversion Certificate under section 95 of the KLR Act 1964 (Phase II) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| ESCOM/Electricity (Phase II) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KWSSB/Water (Phase II) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KSPCB (Phase II) | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
Documents uploaded to RERA (Phase II)
- Building or layout plan · Approved drawings from the planning authorityFiled on RERA ✓ — BDA - Bangalore Development Authority · No. NM/AS/AA/2/TS/3/w/10/2023-24 · dated 19 Jul 2023
- Commencement certificate · Permission to start buildingFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Environment clearance · SEIAA KarnatakaNot on RERA yet
- Fire NOC · Karnataka Fire and Emergency ServicesNot on RERA yet
- Pollution board consent · KSPCBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Water and sewerage · BWSSBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Electricity · BESCOMFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Height clearance · Airports Authority of IndiaNot on RERA yet
- Occupancy certificate (OC) · Issued only when the building is finishedNot on RERA yet — expected at completion
From the documents the promoter uploaded to Karnataka RERA, collected 22 Oct 2026. “Filed” means a document is on RERA — we have not checked its contents or validity. Not every approval applies to every project (for example, smaller projects may not need an environment clearance). Each phase is registered separately; this list is for the phase named above. The project page on RERA lists each upload.
Samhita Serene MTB RERA complaints and orders
2 complaints as on Source (rera.karnataka.gov.in) (opens in a new tab)
| Complaint ref | Filed | Subject | Status | Source |
|---|---|---|---|---|
| 00670/2026 | 8 Jun 2026 | Long-Standing Concerns – B Block Residents | Disposed ao | Source (rera.karnataka.gov.in) (opens in a new tab) |
| 00665/2024 | 4 Jul 2024 | Project delay, delay payment Issue, | Disposed | Source (rera.karnataka.gov.in) (opens in a new tab) |
Court and consumer cases
We list case numbers, courts and outcomes only — never names of private individuals.
About Samhita Estates LLP
- Promoter type
- Partnership Firm
- Projects on this site
- 2
- RERA complaints against promoter
- 2
- Company number (CIN)
- Not found in public records yet: CIN
From Karnataka RERA, as collected so far (22 Oct 2026). Complaints are those RERA lists against this promoter across all its projects.
Samhita Estates LLP’s RERA recordSamhita Estates LLP delivery record
- 2Projects in Bengaluru on RERA3 approved registrations under Samhita Estates LLP in Bengaluru Urban and Rural. Source (rera.karnataka.gov.in) (opens in a new tab)
- 508Homes registeredAs stated in each registrations.
- 2RERA complaints0 open, 2 disposed. as on Source (rera.karnataka.gov.in) (opens in a new tab)
- 3.9Complaints per 1,000 homes2 complaints ÷ 508 homes in its 3 registrations on Karnataka RERA in Bengaluru.
- 1Completion filed on RERARegistrations where the promoter applied to RERA for completion; 1 with an occupancy certificate on RERA.
- 1 of 1Filed by the date given at registrationMedian gap 0 months (on-time ones count as 0). The completion application can come after handover, so this is an upper bound on lateness.
What the complaints are about
2 complaint subjects as written on RERA, as on . Each subject is sorted into one group by keywords (first match wins: delay, refund, registration, quality, litigation, association); one complaint often raises several issues. Source (rera.karnataka.gov.in) (opens in a new tab)
Completion filed on RERA
| Project | Date at registration | Completion filed | Gap |
|---|---|---|---|
| Samhita Serene MTB - Phase IOC on RERA | 31 Dec 2024 | 27 Dec 2024 | By the date |
Measured against the completion date given at registration; many projects had RERA extensions (including the COVID-period extension), shown under the date.
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
What’s changed since Mar 2021
- 14 Jul 2026Phase II: Quarterly update filed for Q1 2026-27: 88% built, 158 of 292 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 8 Jun 2026Complaint 00670/2026 filed with RERA: “Long-Standing Concerns – B Block Residents” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 15 Apr 2026Phase II: Quarterly update filed for Q4 2025-26: 78% built, 158 of 292 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 19 Jan 2026Phase II: Quarterly update filed for Q3 2025-26: 75% built Source (rera.karnataka.gov.in) (opens in a new tab)
- 27 Dec 2024Phase I: Promoter applied to RERA for completion (occupancy certificate on RERA) Source (rera.karnataka.gov.in) (opens in a new tab)
- 4 Jul 2024Complaint 00665/2024 filed with RERA: “Project delay, delay payment Issue,” — now disposed Source (rera.karnataka.gov.in) (opens in a new tab)
- 23 Nov 2023Phase II: Registered with Karnataka RERA (PRM/KA/RERA/1251/446/PR/231123/006425); completion date 31 Dec 2026 Source (rera.karnataka.gov.in) (opens in a new tab)
- 1 Sep 2023Phase II: Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
- 19 Jul 2023Phase II: Building plan approved by BDA - Bangalore Development Authority (No. NM/AS/AA/2/TS/3/w/10/2023-24) Source (rera.karnataka.gov.in) (opens in a new tab)
- 10 Aug 2021Phase I: Registered with Karnataka RERA (PRM/KA/RERA/1251/446/PR/210810/004251); completion date 31 Dec 2024 Source (rera.karnataka.gov.in) (opens in a new tab)
- 1 Mar 2021Phase I: Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
Newest first. No extension of the completion date is recorded on RERA. When the RERA crawl sees a new filing, complaint or extension, it is added here with its date.
Home loan EMI calculator
- Monthly EMI
- —
- Down payment
- —
- Loan amount
- —
- Total interest
- —
A calculation only, from the numbers you enter — not a loan offer.
All-in cost: GST, registration and other charges
The calculator loads when you scroll to it.
Assumptions
- Base price: the builder’s price is not published in a form we could collect — enter it from the cost sheet.
- GST 5% on the base price and charges — the usual rate for an under-construction home that is not “affordable housing” (1%).
- Stamp duty about 5.6% and registration 2% — the Karnataka rule (registration was raised from 1% to 2% on 31 Aug 2025). Calculated on the agreement value.
- Car parking, other charges and the maintenance deposit are not in the public record we collect; enter them from the builder’s cost sheet.
- Loan on the agreement value (banks usually lend up to 75–90%); EMI is the standard reducing-balance formula. Example rate only — use your bank’s quote.
Samhita Serene MTB FAQs
What is the project name and builder?
The project is Samhita Estates LLP, a partnership firm developing a residential project in Kithiganur, Bengaluru East.
How many homes are in the project?
The project has 484 homes total: 192 in Phase I and 292 in Phase II.
What home types and sizes are available?
Phase I offers 1 BHK (516-524 sq ft carpet area), 2 BHK (683-839 sq ft) and 3 BHK (1,042-1,099 sq ft). Phase II offers 1 BHK (479 sq ft), 2 BHK (710-853 sq ft) and 3 BHK (979-1,119 sq ft).
When will the project be completed?
Phase I completion date is 31 December 2024 and Phase II completion date is 31 December 2026.
What are the RERA registration numbers?
Phase I is registered as PRM/KA/RERA/1251/446/PR/210810/004251 (registered 10 August 2021) and Phase II as PRM/KA/RERA/1251/446/PR/231123/006425 (registered 23 November 2023).
What is the construction status of Phase II?
As of Q1 2026-27 (ended 30 June 2026), Phase II is 88% complete with 158 homes booked out of 292.
How many RERA complaints are on this project?
Phase I has 2 RERA complaints and Phase II has 0 RERA complaints.
How many RERA complaints are against the builder?
There are 2 RERA complaints against Samhita Estates LLP across all their projects.
How many other projects does the builder have on RERA record?
Samhita Estates LLP has 2 projects on record with Karnataka RERA in Bengaluru.
What is the project location and PIN code?
The project is located in Kithiganur, Bengaluru East taluk, Bengaluru Urban district, PIN code 560016.
Written by AI from the RERA record above on 5 Oct 2026. Answers use only that record; check them against the source before you decide.
Questions about Samhita Serene MTB
No questions published yet. Ask the first one: you get an instant answer from this page’s public record, and our team follows up on anything the record does not show.
Bought a home from Samhita Estates LLP? Review the builder.
Reviews of Samhita Estates LLP by verified buyers
No verified reviews of Samhita Estates LLP yet. If you bought a home from them, your review helps other buyers.
How reviews work: only buyers and owners can review; we confirm each purchase by phone before publishing, publish positive and negative reviews alike, never accept payment for reviews, and the builder may reply.
Similar projects within 5 km
| Project | Distance | Homes | Possession (RERA) | Built | Complaints | Price |
|---|---|---|---|---|---|---|
| DRK BellagioM/s DRK PROJECTS | 0.1 km | 76 | Jun 2028 | 8% | 0 | Not collected |
| Ekaa By SummitSummit Realty | 0.3 km | 59 | Dec 2026extended | 85% | 0 | Not collected |
| DS Max Sky ShubhamDS Max Properties Private Limited | 0.6 km | 713 | Mar 2027 | 100% | 3 | Not collected |
| Mythri Sankalp DKMMythri Builders | 0.8 km | 101 | Dec 2027 | 70% | 0 | Not collected |
| LVS ParadiseLVS Builders and Developers | 0.8 km | 84 | Dec 2025 | 100% | 0 | Not collected |
| Sri Vidhathri VasanthamSri Vidhathri Construction Private Limited | 1.1 km | 56 | Dec 2026 | 100% | 0 | Not collected |
Projects of the same kind within 5 km in a straight line of this project’s RERA map point, nearest first. % built is the promoter’s latest quarterly figure on RERA (shown for single-registration projects); prices are from the builder’s own website where we found one.
Sources and last checked dates
Collected on 22 Oct 2026 by AI research agents reading public pages. Facts are written in our own words. Not found yet: price; court cases; landmarks; specifications; news.
How to check on RERA: On rera.karnataka.gov.in/viewAllProjects, type the registration number in 'Registration No', press Search, then click the 'View Project Details' icon. Complaints open from the 'Complaints / Litigation' icon in the same row. Registration numbers: PRM/KA/RERA/1251/446/PR/210810/004251, PRM/KA/RERA/1251/446/PR/231123/006425.
- RERA record last checked: 22 Oct 2026
- Last change in the record (registration, quarterly filing or complaint): 14 Jul 2026
How this page is made: software builds it from public records (Karnataka RERA filings, OpenStreetMap, the builder’s own website). AI is used only to read filings into fields and to write the plain-English summary and FAQ answers, which are checked against the record. Facts are checked automatically against the RERA filing. Methodology · How we earn · Report an error
More new projects nearby
Kithaganur, near Old Madras RoadUnder constructionRERA registeredBuyers’ group openDRK Bellagio
by M/s DRK
Price: Price on requestGet brochure & price →
- Villa
- 1,882 – 2,289 sq ft
- Jun 2028
76 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for DRK Bellagio
Kithaganur, near Old Madras RoadUnder constructionRERA registeredBuyers’ group openEkaa By Summit
by Summit Realty
Price: Price on requestGet brochure & price →
- 2 BHK, 3 BHK
- 724 – 1,144 sq ft
- Dec 2026 (extended)
59 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Ekaa By Summit
Kithaganur, near Old Madras RoadReady to moveRERA registeredBuyers’ group openDS Max Sky Shubham
by DS Max Properties
Price: Price on requestGet brochure & price →
- 2 BHK, 3 BHK
- 635 – 950 sq ft
- Mar 2027
713 homes · 3 RERA complaints
