Cielo at Brigade Valencia
1, 2, 3 & 4 BHK apartments by Brigade Enterprises Ltd · Kithiganahalli Banahalli, Bommasandra, Bengaluru
Kithiganahalli Banahalli, Bommasandra, BengaluruOpen on Google Maps (opens in a new tab)
- Under construction
- RERA registered
- residential
Price: Price on request

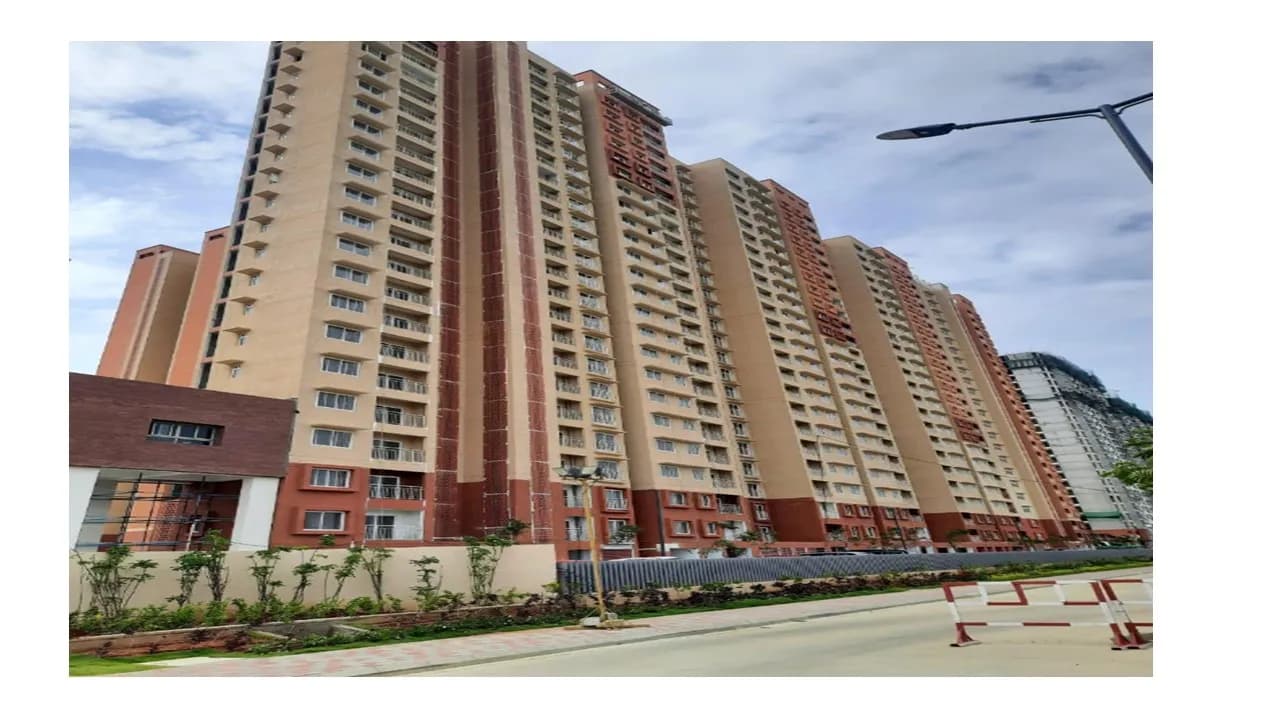

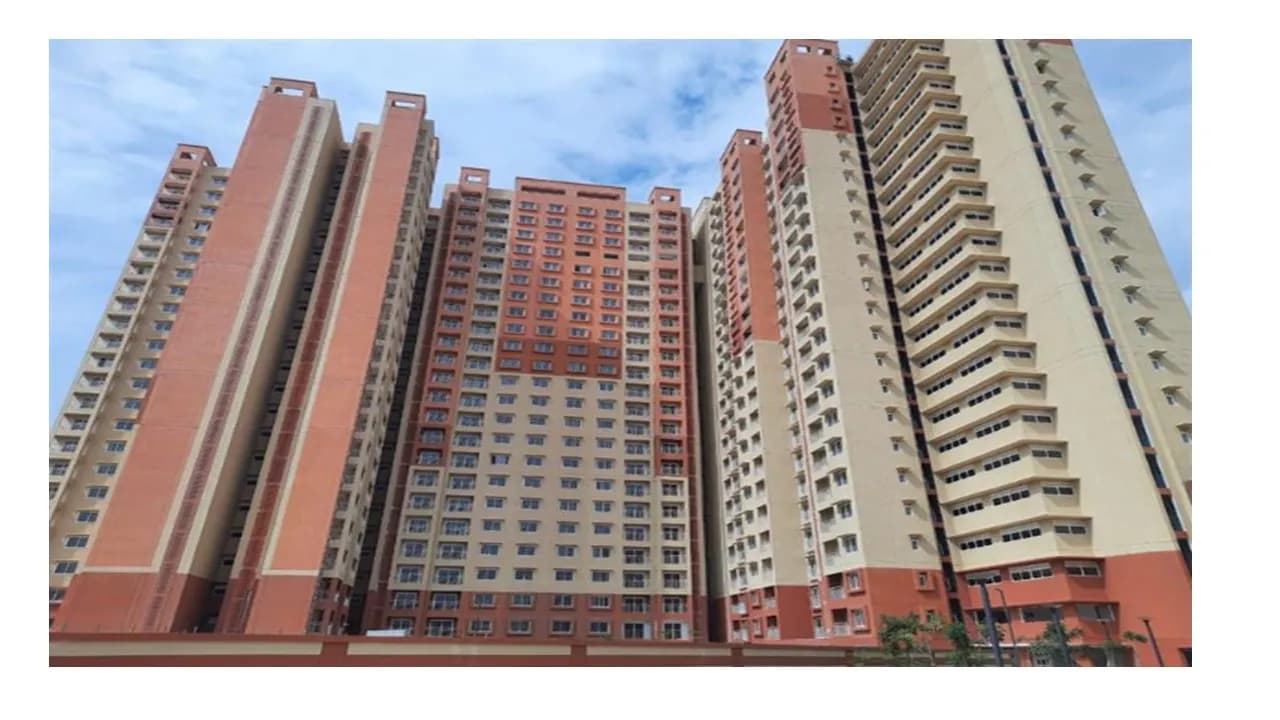

Site photo filed with Karnataka RERA Karnataka RERA filing · Source ↗ (opens in a new tab)
Cielo at Brigade Valencia at a glance
- Possession (RERA)Dec 2027Karnataka RERA
- Construction88% built · on pace for Mar 2027RERA filing to 30 Sep 2026; estimate from average pace
- Homes booked661 of 662 (100%)RERA update · as on 30 Sep 2026
- RERA complaints (project)None listedKarnataka RERA · as on 22 Oct 2026
- Builder on-time record4 of 10 on time Mostly lateCompleted projects: OC date vs promised date
- Approvals filed8 of 9 on RERAKarnataka RERA uploads · 22 Oct 2026
- Nearest metroDelta Electronics Bommasandra · 2.03 kmstraight line · OpenStreetMap, 5 Oct 2026
- Airport driveapprox. 178 min at peak44.02 km straight line · estimate
- Nearest lakeKitthiganahalli Bommasandra Lake · 1,000 mFrom the RERA map point · OpenStreetMap, 5 Oct 2026
Project summary
Cielo at Brigade Valencia is a residential project by Brigade Enterprises Ltd in Kithiganahalli Banahalli, Bengaluru with 662 homes, registered with Karnataka RERA. The completion date on RERA is 31 Dec 2027.
Facts collected on 22 Oct 2026 from public records — each linked to its source. Free for buyers. If you book through us, the builder pays us a commission.
Cielo at Brigade Valencia buyers’ group: join to ask for a group price
No one has joined yet. Be one of the first 10 buyers in this group — the founding members.
Join free. When enough buyers have joined, our agent partner asks Brigade Group for a group price — for example a lower price, an easier payment plan or waived charges. Nothing is promised: you see what the builder offers and book directly with the builder if you want to. Free for buyers. If you book through us, the builder pays us a commission.
- Gathering buyers
- Talking to the builder
- Group offer
- Group site visit
- Booking
0 buyers have joined · 0 committed
Committed buyers have confirmed their budget, home type and timeline with us on a call; builders negotiate with them. Joining is free and never obliges you to buy.
Join the Cielo at Brigade Valencia buyers’ groupHow group buying works
See it for yourself
Visit the site with our team, or get a call to clear your questions. Free, no obligation.
Key facts: home types, towers, land and possession
- Home types
- 1 BHK, 2 BHK, 3 BHK, 4 BHK
- Carpet area
- 342 – 1,402 sq ft
- Towers
- 1
- Floors
- 22
- Total homes
- 662
- Land
- 7.96 acres
- Possession (RERA)
- Dec 2027
- Built (RERA update)
- 88%
Cielo at Brigade Valencia RERA number and registration details
- RERA number
- PRM/KA/RERA/1251/308/PR/120123/005613
- Registered on
- 12 Jan 2023
- Promised completion
- 31 Dec 2027
- Extended to
- No extension recorded
- RERA status
- New launch
- Homes booked
- 661 of 662 as on
- Price
- Not found in public records yet: price
- Project type
- Residential
Towers and blocks (RERA filing)
| Tower | Floors | Basements | Homes |
|---|---|---|---|
| Cielo at Brigade Valencia | 22 | 2 | 662 |
A dash (—) means the filing did not state that value.
Summary in plain English
Cielo at Brigade Valencia is a residential project by Brigade Enterprises Ltd in Kithiganahalli Banahalli, Anekal. The project has 662 homes in 1 tower with 22 floors and is registered for completion on 31 December 2027.
Written by AI from the RERA record above on 22 Oct 2026. Every number in it was checked against that record; if anything differs, the record wins.
Open space, home loans, escrow and other details
- Open space
- 87.1% of land
- Water and power
- Water source filed with RERA: BoreWell,BWSSB,Local Authority,Others
- Home loans: approved banks
- Not found in public records yet: bank approvals
- Payment plans
- Not found in public records yet: payment plans
- Maintenance
- Not found in public records yet: maintenance
- Car parking
- Not found in public records yet: car parking charge
- Escrow bank (RERA)
- KOTAK MAHINDRA BANK, Lavelle Road Branch
- Building plan (RERA)
- Local Planing Authority · No. APA/CC/207/2022-23 · dated 6 Dec 2022
- Project cost declared to RERA
- ₹431 Cr
Open area as a share of the land, from the areas filed with RERA (includes driveways and landscaped areas).
Amenities
- Electricity
- Club House
- Swimming Pool
- Parks
Amenities and internal works as filed by the promoter with Karnataka RERA; we have not visited the site.
Cielo at Brigade Valencia location and address
- Address
- Sy No’s: 52, 53, 54/1A, 54/2, 84/2, 84/3, 85/1, 85/4 and 86 , Kithiganahalli and Banahalli Village, Attibele Hobli, Anekal Taluk , Anekal , Bengaluru Urban, Karnataka - 562106
- Village (RERA)
- Kithiganahalli Banahalli
- Locality
- Bommasandra
- PIN code
- 562106
- City
- Bengaluru
- State
- Karnataka
- Coordinates
- 12.80486, 77.69968
Distances to landmarks
Not found in public records yet: landmarksAbout Bommasandra
Not found in public records yet: locality factsCommute times to tech parks and the airport
| To | Straight line | Peak-hour drive (estimate) |
|---|---|---|
| Electronic City Phase 1Map point on OpenStreetMap (opens in a new tab) | 6.24 km | approx. 25 min |
| Outer Ring Road tech corridor (RMZ Ecospace, Bellandur)Map point on OpenStreetMap (opens in a new tab) | 13.37 km | approx. 54 min |
| ITPL, Whitefield (main gate)Map point on OpenStreetMap (opens in a new tab) | 20.74 km | approx. 84 min |
| KSR Bengaluru City railway station (Majestic)Map point on OpenStreetMap (opens in a new tab) | 23.88 km | approx. 97 min |
| Manyata Tech ParkMap point on OpenStreetMap (opens in a new tab) | 28.4 km | approx. 115 min |
| Kempegowda International AirportMap point on OpenStreetMap (opens in a new tab) | 44.02 km | approx. 178 min |
How we calculate
Straight line: from the project’s map point on RERA to the destination’s point on OpenStreetMap.
Peak-hour drive is a rough estimate, not a route: straight line × 1.35 for the road network, at 20 km/h. Real times vary a lot with the route and the hour.
Sources:Source (openstreetmap.org) (opens in a new tab)How we calculate this
Schools and hospitals nearby
Within 2 km
- 12Schools and colleges9 schools, 2 colleges, 1 kindergartens
- 16Hospitals and clinics9 hospitals, 7 clinics
Nearest schools and colleges
- BTL Institute of Technology · 0.88 km
- Bangalore College Of Engineering And Technology · 1.4 km
- Rising Kids Pre School · 1.42 km
Nearest hospitals and clinics
- E-City Allergy & Asthma Specialty Clinic · 0.1 km
- Global Speciality Hospital · 0.42 km
- Sri Balaji · 0.47 km
Places as mapped on OpenStreetMap (amenity=school, college, kindergarten, university; hospital, clinic), counted within 2 km in a straight line of the RERA map point. Volunteers map these, so some places may be missing or closed. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Nearest metro station and railway
- Delta Electronics Bommasandra (ಡೆಲ್ಟಾ ಎಲೆಕ್ಟ್ರಾನಿಕ್ಸ್ ಬೊಮ್ಮಸಂದ್ರ)Open now — nearest operating metro station2.03 km
- Heelalige (ಹೀಲಲಿಗೆ ರೈಲು ನಿಲ್ದಾಣ)Nearest railway station1.55 km
Straight-line distances from the RERA map point to the station points mapped on OpenStreetMap; status (open or under construction) as tagged there. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Lake and lake-buffer check
The nearest mapped lake is Kitthiganahalli Bommasandra Lake, 1,000 m from the project’s RERA map point.
The site boundary is not published as a shape, so its nearest edge can be closer than this point. Whether any building sits inside a lake buffer can only be checked on the approved plan.
- Kitthiganahalli Bommasandra Lake on OpenStreetMap (opens in a new tab) 1,000 m
- Heelalige Lake on OpenStreetMap (opens in a new tab) 1,270 m
- Andapura Lake on OpenStreetMap (opens in a new tab) 1,814 m
The buffer rule
Bengaluru’s lake buffer rule has changed over time: the National Green Tribunal ordered a 75 m buffer in May 2016; the Supreme Court set that order aside on 5 March 2019, leaving the 30 m buffer of the Revised Master Plan 2015. Check the current rule and the approved plan before relying on either number.
- LiveLaw: SC sets aside NGT order enlarging buffer zones (2019) (livelaw.in) (opens in a new tab)
- Citizen Matters: Shrinking lake buffers (citizenmatters.in) (opens in a new tab)
Shortest distance from the RERA map point to the mapped water edge (OpenStreetMap water polygons tagged lake or reservoir, or named lake/kere/tank). Mapped shorelines can differ from the revenue-record boundary of a lake. Places data © OpenStreetMap contributors, extract of 5 Oct 2026.
Sources:Source (openstreetmap.org) (opens in a new tab)Source (livelaw.in) (opens in a new tab)Source (citizenmatters.in) (opens in a new tab)How we calculate this
Satellite time-lapse of the site
Satellite photos load when you scroll to them.
Photos from Esri World Imagery Wayback, centred on the project’s map point; dates are the capture dates in Esri’s metadata. Loaded from Esri when you scroll here.
Sources:Source (livingatlas.arcgis.com) (opens in a new tab)
Cielo at Brigade Valencia floor plans, brochure and elevations
Documents the builder uploaded to Karnataka RERA, shown as filed. Tap a page to see it full size; the full PDF opens on the RERA website.

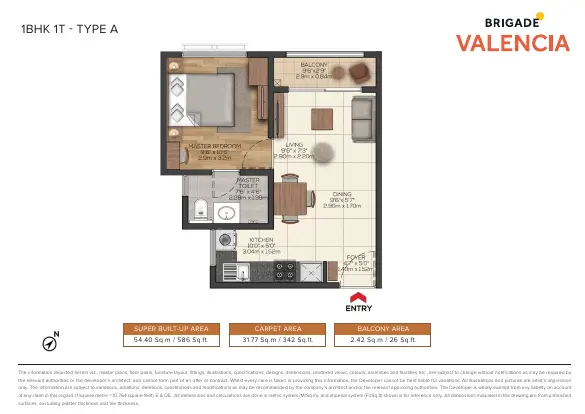

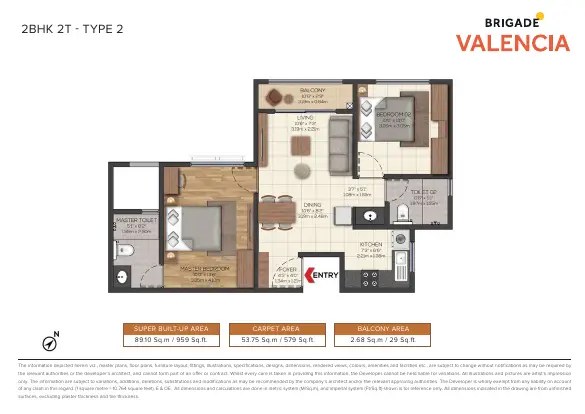

Brochure4 pages

BrochureFull PDF on RERA


Floor plans14 pages

Approved Layout PlanFull PDF on RERA
Approved layout plan

Existing Layout PlanFull PDF on RERA
| Home type | Carpet area | Homes |
|---|---|---|
| 1 bedroom + 1 toilet | 344 sq ft | 69 |
| 1 BHK | 342 sq ft | 69 |
| 2 bedroom + 2 toilet | 581 sq ft | 184 |
| 2 bedroom + 2 toilet + study | 678 – 743 sq ft | 160 |
| 2 BHK | 579 – 742 sq ft | 344 |
| 3 bedroom + 2 toilet | 883 sq ft | 180 |
| 3 bedroom + 3 toilet | 990 sq ft | 46 |
| 3 BHK | 880 – 993 sq ft | 226 |
| 4 bedroom + 3 toilet + maid's room + toilet | 1,399 sq ft | 23 |
| 4 BHK | 1,402 sq ft | 23 |
Home types, counts and carpet areas as filed with Karnataka RERA (carpet area, not super built-up).
We have not collected floor-plan drawings; the builder’s sales team can share them.
Cielo at Brigade Valencia possession date and construction status
Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-15.
Units sold and unsold, from RERA (Q2 2026-27)
| Type | Homes | Booked | Available |
|---|---|---|---|
| 1 BHK | 69 | 69 | 0 |
| 2 BHK | 344 | 343 | 1 |
| 3 BHK | 226 | 226 | 0 |
| 4 BHK | 23 | 23 | 0 |
As reported by the promoter in the quarterly update to RERA, not verified by us.
Timeline
- 12 Jan 2023Registered with Karnataka RERA
- 1 Feb 2023Project start date given to RERA
- 31 Dec 2027Completion date given at registration
Construction pace from RERA quarterly filings
At the average pace so far, construction would reach 100% around Mar 2027 — about 9 months before the completion date on RERA (31 Dec 2027).
At the pace between the 4 quarterly filings we have (86% → 88% in 9 months), it would be around Mar 2031 — about 39 months after the RERA date.
- Filed on RERA
- Average pace since start
- Pace between filings (and 0% assumed at the start date)
- RERA completion date
Quarterly filings
| Quarter | Filed on | Built | Homes booked |
|---|---|---|---|
| Q2 2026-27to 30 Sep 2026 | 15 Oct 2026 | 88% | 661 of 662 |
| Q1 2026-27to 30 Jun 2026 | 15 Jul 2026 | 88% | 662 of 662 |
| Q4 2025-26to 31 Mar 2026 | 15 Apr 2026 | 88% | 662 of 662 |
| Q3 2025-26to 31 Dec 2025 | 14 Jan 2026 | 86% | 662 of 662 |
How we calculate
Average pace = % built ÷ months since the start date in the RERA record. Here: 88% ÷ 43.9 months (1 Feb 2023 to 30 Sep 2026) = 2% a month.
Estimated finish = latest filing date + (100 − % built) ÷ pace = 30 Sep 2026 + 12 ÷ 2 = 6 months → Mar 2027. This is an estimate, not a date from the builder or RERA.
Pace between filings = (88% − 86%) ÷ 9 months = 0.2% a month.
A straight line is a simplification: the builder reports one overall %, which mixes excavation, structure and finishing, and work rarely moves at a constant speed. The % values are the promoter’s own figures filed with RERA, not checked by us. Promoter’s quarterly update to RERA for Q2 2026-27, submitted 2026-10-15.
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)How we calculate this
Approvals and documents checklist
16 rows: approvals. Scroll inside the table to see them all.
| Approval | Authority | Source |
|---|---|---|
| Building plan | Local Planing Authority · No. APA/CC/207/2022-23 · dated 2022-12-06 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Land conversion (8 orders) | Special Dy. Commissioner · No. ALN/A/SR/456/04-05 and 7 more · dated 2019-12-30 | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Commencement Certificate | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Electricity Permission Letter | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Water Permission Letter | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Layout Plan | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Building/Plotting Plan | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Approved Section Of Building/Infrastructure Plan of Plotting | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Change of Land Use | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Conversion Certificate under section 95 of the KLR Act 1964 | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| ESCOM/Electricity | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KWSSB/Water | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Fire Force Department | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Airport Authority of India | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| KSPCB | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
| SEIAA | scan uploaded to RERA | Source (rera.karnataka.gov.in) (opens in a new tab) |
Documents uploaded to RERA
- Building or layout plan · Approved drawings from the planning authorityFiled on RERA ✓ — Local Planing Authority · No. APA/CC/207/2022-23 · dated 6 Dec 2022
- Commencement certificate · Permission to start buildingFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Environment clearance · SEIAA KarnatakaFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Fire NOC · Karnataka Fire and Emergency ServicesFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Pollution board consent · KSPCBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Water and sewerage · BWSSBFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Electricity · BESCOMFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Height clearance · Airports Authority of IndiaFiled on RERA ✓ — scanned copy uploaded; number and date not read yet
- Occupancy certificate (OC) · Issued only when the building is finishedNot on RERA yet — expected at completion
From the documents the promoter uploaded to Karnataka RERA, collected 22 Oct 2026. “Filed” means a document is on RERA — we have not checked its contents or validity. Not every approval applies to every project (for example, smaller projects may not need an environment clearance). The project page on RERA lists each upload.
Cielo at Brigade Valencia RERA complaints
No complaints listed on Karnataka RERA for this registration as on Source (rera.karnataka.gov.in) (opens in a new tab)
Court and consumer cases
We list case numbers, courts and outcomes only — never names of private individuals.
About Brigade Group
- Founded
- 1986
- Headquarters
- Bengaluru
- Bengaluru projects
- 16
- Delivered on time
- 4 of 10
- RERA complaints
- 44
- Court cases listed
- 3
Brigade Enterprises Limited (CIN L85110KA1995PLC019126) is a listed Bengaluru developer, founded in 1986 and based at the World Trade Center in Malleswaram-Rajajinagar. Karnataka RERA records show its older Bengaluru projects receiving occupancy certificates between 2018 and 2024, some before the original RERA date and several months to about 19 months after it (within extended deadlines). As of 4 October 2026, RERA lists 44 complaints across Brigade Enterprises Ltd projects.
Brigade Group’s full recordBrigade Group delivery record
- 28Projects in Bengaluru on RERA32 approved registrations under Brigade Enterprises Limited in Bengaluru Urban and Rural. Source (rera.karnataka.gov.in) (opens in a new tab)
- 15,990Homes and plots registeredAs stated in 31 of the 32 registrations.
- 44RERA complaints5 open, 39 disposed. as on Source (rera.karnataka.gov.in) (opens in a new tab)
- 2.8Complaints per 1,000 homes and plots44 complaints ÷ 15,990 homes and plots in its 32 registrations on Karnataka RERA in Bengaluru.
- 5Completion filed on RERARegistrations where the promoter applied to RERA for completion; 2 with an occupancy certificate on RERA.
- 0 of 5Filed by the date given at registrationMedian gap 9.4 months (on-time ones count as 0). The completion application can come after handover, so this is an upper bound on lateness.
- 3Court cases listedFound in public court records; see the list on the builder’s page.
What the complaints are about
44 complaint subjects as written on RERA, as on . Each subject is sorted into one group by keywords (first match wins: delay, refund, registration, quality, litigation, association); one complaint often raises several issues. Source (rera.karnataka.gov.in) (opens in a new tab)
Completion filed on RERA
| Project | Date at registration | Completion filed | Gap |
|---|---|---|---|
| Brigade Northridge NeoOC on RERA | 31 Mar 2022extended to 30 Sep 2022 | 20 May 2026 | 50 months after |
| Brigade BricklaneOC on RERA | 31 Dec 2021extended to 31 Mar 2023 | 16 May 2026 | 53 months after |
| Brigade Oasis - Phase 1 | 30 Jun 2025extended to 30 Jun 2026 | 13 Apr 2026 | 9 months after |
| Brigade Oasis - Phase 2 | 30 Jun 2025extended to 30 Jun 2026 | 13 Apr 2026 | 9 months after |
| Brigade Oasis - Phase 3 | 30 Jun 2025extended to 30 Jun 2026 | 13 Apr 2026 | 9 months after |
Measured against the completion date given at registration; many projects had RERA extensions (including the COVID-period extension), shown under the date.
Handovers we checked by hand
| Project | Promised (at registration) | OC | Result | Source |
|---|---|---|---|---|
| Plumeria Phase 1 at Brigade Meadows | 31 Jul 2018 | 5 Jul 2018 | On time | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Brigade Lakefront - Crimson | 30 Jun 2019 | 28 Dec 2018 | On time | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Plumeria Lifestyle at Brigade Meadows | 30 Sep 2020 | 30 Mar 2020 | On time | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Brigade Woods | 31 Dec 2020 | 1 Feb 2022 | 13 months late | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Brigade Parkside North | 31 Mar 2021 | 15 Mar 2022 | 11 months late | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Brigade Parkside East | 31 Dec 2020 | 9 May 2022 | 16 months late | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Brigade Northridge Neo | 31 Mar 2022 | 13 May 2022 | 1 months late | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Brigade 7 Gardens | 31 Oct 2020 | 4 Jun 2022 | 19 months late | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Brigade Bricklane | 31 Dec 2021 | 10 Oct 2022 | 9 months late | Source (rera.karnataka.gov.in) (opens in a new tab) |
| Brigade Gem | 31 Aug 2024 | 22 Jul 2024 | On time | Source (rera.karnataka.gov.in) (opens in a new tab) |
Sources:Source (rera.karnataka.gov.in) (opens in a new tab)Source (indiankanoon.org) (opens in a new tab)Source (indiankanoon.org) (opens in a new tab)Source (livelaw.in) (opens in a new tab)How we calculate this
What’s changed since Dec 2022
- 15 Oct 2026Quarterly update filed for Q2 2026-27: 88% built, 661 of 662 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 15 Jul 2026Quarterly update filed for Q1 2026-27: 88% built, 662 of 662 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 15 Apr 2026Quarterly update filed for Q4 2025-26: 88% built, 662 of 662 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 14 Jan 2026Quarterly update filed for Q3 2025-26: 86% built, 662 of 662 homes booked Source (rera.karnataka.gov.in) (opens in a new tab)
- 1 Feb 2023Project start date in the RERA record Source (rera.karnataka.gov.in) (opens in a new tab)
- 12 Jan 2023Registered with Karnataka RERA (PRM/KA/RERA/1251/308/PR/120123/005613); completion date 31 Dec 2027 Source (rera.karnataka.gov.in) (opens in a new tab)
- 6 Dec 2022Building plan approved by Local Planing Authority (No. APA/CC/207/2022-23) Source (rera.karnataka.gov.in) (opens in a new tab)
Newest first. No extension of the completion date is recorded on RERA. When the RERA crawl sees a new filing, complaint or extension, it is added here with its date.
Home loan EMI calculator
- Monthly EMI
- —
- Down payment
- —
- Loan amount
- —
- Total interest
- —
A calculation only, from the numbers you enter — not a loan offer.
All-in cost: GST, registration and other charges
The calculator loads when you scroll to it.
Assumptions
- Base price: the builder’s price is not published in a form we could collect — enter it from the cost sheet.
- GST 5% on the base price and charges — the usual rate for an under-construction home that is not “affordable housing” (1%).
- Stamp duty about 5.6% and registration 2% — the Karnataka rule (registration was raised from 1% to 2% on 31 Aug 2025). Calculated on the agreement value.
- Car parking, other charges and the maintenance deposit are not in the public record we collect; enter them from the builder’s cost sheet.
- Loan on the agreement value (banks usually lend up to 75–90%); EMI is the standard reducing-balance formula. Example rate only — use your bank’s quote.
Cielo at Brigade Valencia FAQs
What is the completion date for Cielo at Brigade Valencia?
The project is registered for completion on 31 December 2027.
How many homes are in Cielo at Brigade Valencia?
The project has 662 homes.
What home types are available in Cielo at Brigade Valencia?
Home types range from 1 BHK (342 to 344 sq ft carpet area) to 4 BHK (1,399 to 1,402 sq ft carpet area), including 2 BHK, 3 BHK and studios with various configurations.
What is the carpet area range in Cielo at Brigade Valencia?
Carpet areas range from 342 sq ft for 1 BHK homes to 1,402 sq ft for 4 BHK homes.
What is the RERA registration number for Cielo at Brigade Valencia?
The RERA registration number is PRM/KA/RERA/1251/308/PR/120123/005613, registered on 12 January 2023.
Where is Cielo at Brigade Valencia located?
The project is located in Kithiganahalli Banahalli, Anekal taluk, Bengaluru Urban district, PIN code 562106.
How many complaints are there on Cielo at Brigade Valencia?
There are no complaints on this project registered with RERA.
What is the construction progress of Cielo at Brigade Valencia?
As of Q2 2026-27 (ended 30 September 2026), construction is 88% complete with 661 homes booked out of 662.
What is the escrow bank for Cielo at Brigade Valencia?
The escrow bank is Kotak Mahindra Bank.
How many projects does Brigade Enterprises Ltd have on RERA record in Bengaluru?
Brigade Enterprises Ltd has 38 projects in our Bengaluru RERA records with 44 complaints filed against the builder across all projects.
Written by AI from the RERA record above on 22 Oct 2026. Answers use only that record; check them against the source before you decide.
Questions about Cielo at Brigade Valencia
No questions published yet. Ask the first one: you get an instant answer from this page’s public record, and our team follows up on anything the record does not show.
Bought a home from Brigade Group? Review the builder.
Reviews of Brigade Group by verified buyers
No verified reviews of Brigade Group yet. If you bought a home from them, your review helps other buyers.
How reviews work: only buyers and owners can review; we confirm each purchase by phone before publishing, publish positive and negative reviews alike, never accept payment for reviews, and the builder may reply.
Similar projects within 5 km
| Project | Distance | Homes | Possession (RERA) | Built | Complaints | Price |
|---|---|---|---|---|---|---|
| OrleanGlobal Edifice Infra | 1.2 km | 91 | Dec 2027 | 98% | 0 | Not collected |
| Reviva By SsiSri Sai Infra | 1.3 km | 234 | Dec 2028 | 61% | 0 | Not collected |
| Abhee Serenity SpringsAbhee Ventures Private Limited | 1.5 km | 288 | Jun 2030 | 35% | 0 | Not collected |
| Meadows Phase-2 By Bhavisha HomesBhavisha Properties | 1.5 km | 88 | Dec 2025 | 100% | 0 | Not collected |
| Green ViewHoysala And Best Realty | 1.6 km | 73 | Mar 2026 | — | 0 | Not collected |
| Fortuners Infra ElixirFortuners Infra | 1.7 km | 60 | Sep 2026 | — | 0 | Not collected |
Projects of the same kind within 5 km in a straight line of this project’s RERA map point, nearest first. % built is the promoter’s latest quarterly figure on RERA (shown for single-registration projects); prices are from the builder’s own website where we found one.
Sources and last checked dates
Collected on 22 Oct 2026 by AI research agents reading public pages. Facts are written in our own words. Not found yet: price; court cases; landmarks; specifications; news.
How to check on RERA: On rera.karnataka.gov.in/viewAllProjects, type the registration number in 'Registration No', press Search, then click the 'View Project Details' icon. Complaints open from the 'Complaints / Litigation' icon in the same row. Registration number: PRM/KA/RERA/1251/308/PR/120123/005613.
- RERA record last checked: 22 Oct 2026
- Last change in the record (registration, quarterly filing or complaint): 22 Oct 2026
How this page is made: software builds it from public records (Karnataka RERA filings, OpenStreetMap, the builder’s own website). AI is used only to read filings into fields and to write the plain-English summary and FAQ answers, which are checked against the record. Facts are checked automatically against the RERA filing. Methodology · How we earn · Report an error
More new projects in Bommasandra
BommasandraUnder constructionRERA registeredBuyers’ group openShriram Sapphire
by Shriram Properties
Price: Price on requestGet brochure & price →
- 2 BHK, 3 BHK
- 635 – 857 sq ft
- Nov 2028
414 homes · 3 RERA complaints
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Shriram Sapphire
Andapura, BommasandraReady to moveRERA registeredBuyers’ group openMahendra Aarya
by Mahendra Homes
Price: Price on requestGet brochure & price →
- 2 BHK, 2.5 BHK, 3 BHK
- 704 – 1,025 sq ft
- Dec 2025
662 homes · 3 RERA complaints
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Mahendra Aarya
Andhapura, BommasandraUnder constructionRERA registeredBuyers’ group openMahendra Solterra Aarya Phase-2
by Mahendra Homes
Price: Price on requestGet brochure & price →
- 3 BHK
- 867 – 1,289 sq ft
- Dec 2030
522 homes
Be one of the first 10 buyers in this groupFounding members — it’s free
Join group for Mahendra Solterra Aarya Phase-2
